Time-Cost Analysis for Project Crashing: 4-Day Schedule Reduction Strategies

This document analyzes the strategies involved in crashing a project timeline by 4 days, focusing on the actions and impacts for various tasks labeled A through G. The evaluation includes a cost analysis of different crashing techniques, providing insights into the optimal actions to accelerate project delivery. It identifies the implications of issues such as resource allocation and the potential for setting back other elements of the project. This analysis is essential for project managers aiming to effectively manage timelines while controlling costs.

Télécharger la présentation

Time-Cost Analysis for Project Crashing: 4-Day Schedule Reduction Strategies

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

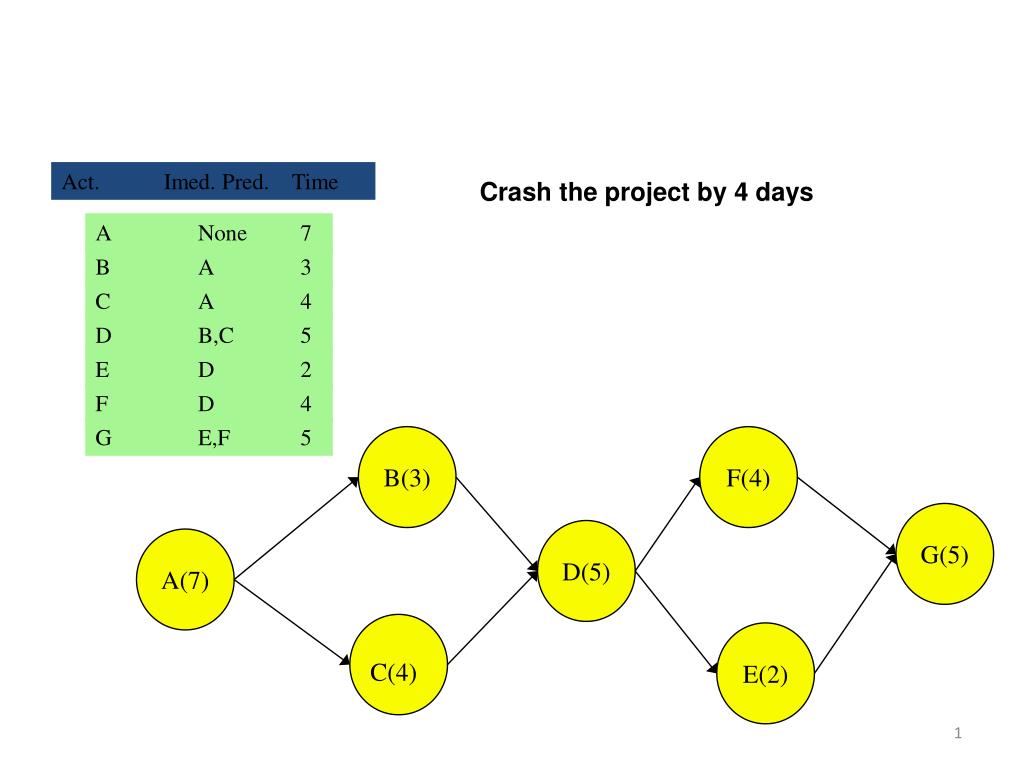

  1. C(4) Act. Imed. Pred. Time Crash the project by 4 days A None 7 B A 3 C A 4 D B,C 5 E D 2 F D 4 G E,F 5 B(3) F(4) G(5) D(5) A(7) E(2)

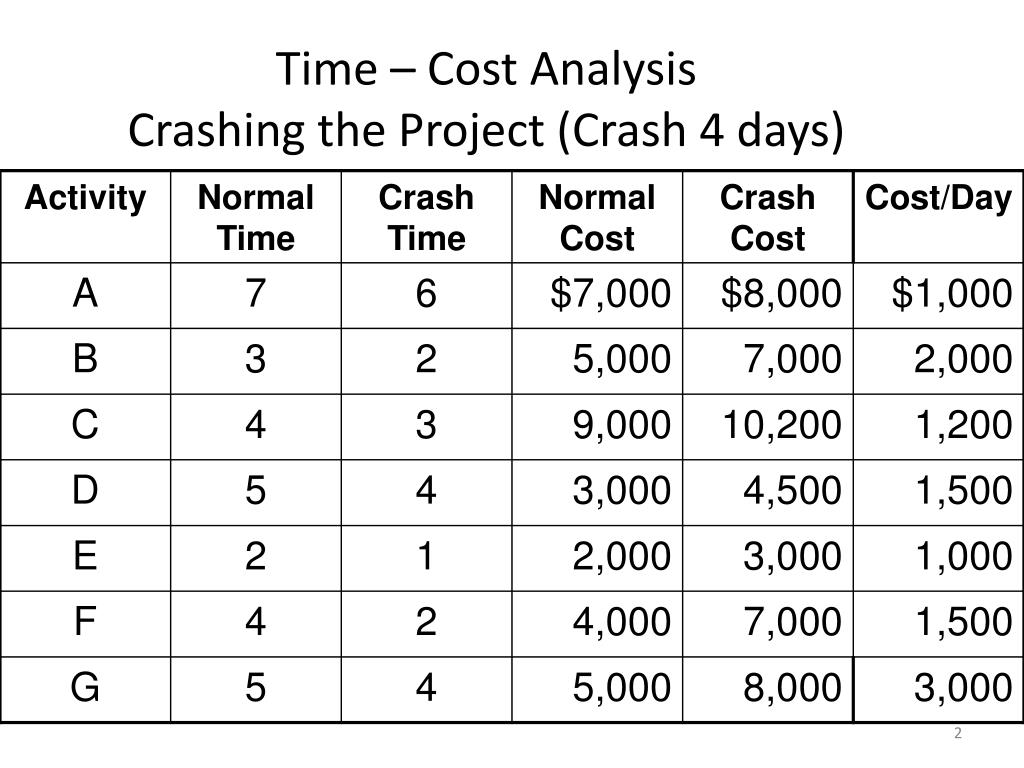

  2. Time – Cost AnalysisCrashing the Project (Crash 4 days)

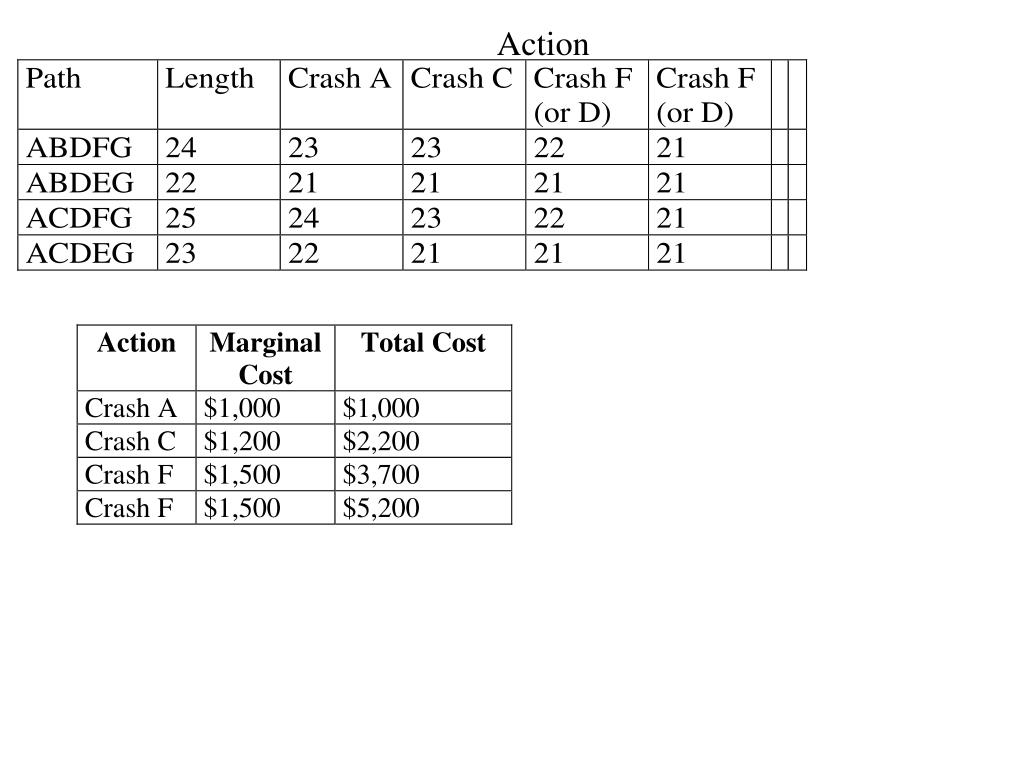

  3. Action
