TFN Status 8/2004

TFN Status 8/2004. Turn-up Targets TFN Optical layer scheduled for completion September 2004, Routing layer scheduled for completion by October, 2004. All universities and colleges will be on the TFN backbone during the fall term

hazel
Télécharger la présentation

TFN Status 8/2004

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. TFN Status 8/2004 • Turn-up Targets • TFN Optical layer scheduled for completion September 2004, Routing layer scheduled for completion by October, 2004. • All universities and colleges will be on the TFN backbone during the fall term • All 15 research universities and medical schools will have Gigabit connections by fall term to the TFN

  2. TFN Status 8/2004 • Turn-up Targets • All other Colleges and Universities connectivity will depend on the last mile option selected to the TFN • Lambda provisioned for SchoolNet, awaiting funding recent budget cuts have delayed implementation of SchoolNet’s configuration and equipment order (Sites will be turned up during the 2004-2005 school year)

  3. TFN Status 8/2004

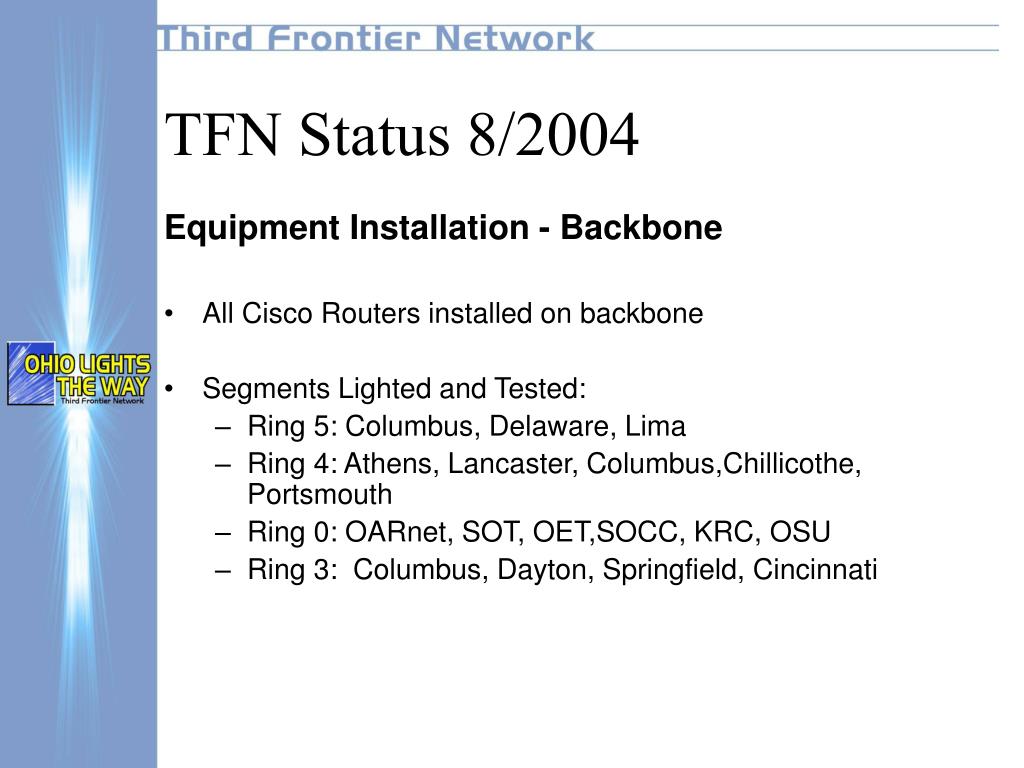

  4. TFN Status 8/2004 • Equipment Installation - Backbone • All Cisco Routers installed on backbone • Segments Lighted and Tested: • Ring 5: Columbus, Delaware, Lima • Ring 4: Athens, Lancaster, Columbus,Chillicothe, Portsmouth • Ring 0: OARnet, SOT, OET,SOCC, KRC, OSU • Ring 3: Columbus, Dayton, Springfield, Cincinnati

  5. TFN Status 8/2004 • Equipment Installation - Backbone • Segments Pending Optical Installation (continued) • Installation completion target date • Ring 2: Cleveland, Youngtown, Akron, Columbus week of 8/26/2004 • Ring Test and Acceptance • Ring 3 Target Date Week of 8/09/2004 • Ring 1 Target Date Week of 8/16/2004 • Ring 2 Target Date Week of 9/6/2004

  6. TFN Status 8/2004 • Equipment Installation - Conversion • Installation completed for 3750s • Terminal Servers install scheduled 8/9 - 8/31 • Edge Routers install scheduled 8/30 - 9/30 • Equipment Installation - School Support • Case Western Reserve University 6/22/2004 C • Cleveland State University 6/22/2004 C • American Fiber System 6/22/2004 C • Toledo Buckeye 6/23/2004 C • Miami University 7/26/2004 C

  7. TFN Status 8/2004 • Equipment Installation - School Support (continued) • Youngstown State University 7/12/2004 C • Youngstown Qwest 7/13/2004 C • Youngstown Wiltel 7/13/2004 C • Cinergy (Evandale) TBD • Cinergy (Cincinnati) 9/7/2004 • Medical College of Ohio 7/26/2004 C • University of Toledo 7/26/2004 C • Bowling Green State University 7/26/2004 C • Kent State University 9/7/2004 • NEOUCOM 9/7/2004

  8. TFN Status 8/2004 • Last Mile Connections • RFP Completed • 124 college and university sites bid • 30 Schoolnet sites bid • Currently working with vendor’s to develop contracts on an as needed basis • Result: lower last mile costs for most schools and bandwidth enhanced 5 to 8 times
