D29 - Roadmap for LFR development

D29 - Roadmap for LFR development. Davide Mattioli ENEA UTFISSM-PRONOC LEADER (Lead-cooled European Advanced DEmonstration Reactor) WP 1 - Task 1.1 Amsterdam 10-07-2012. Revisions by partners. ANSALDO, SCK-CEN, NRG, JRC, KIT: Text improvements. ANSALDO:

hedya
Télécharger la présentation

D29 - Roadmap for LFR development

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. D29 - Roadmap for LFR development Davide Mattioli ENEA UTFISSM-PRONOC LEADER (Lead-cooled European Advanced DEmonstration Reactor) WP 1 - Task 1.1 Amsterdam 10-07-2012

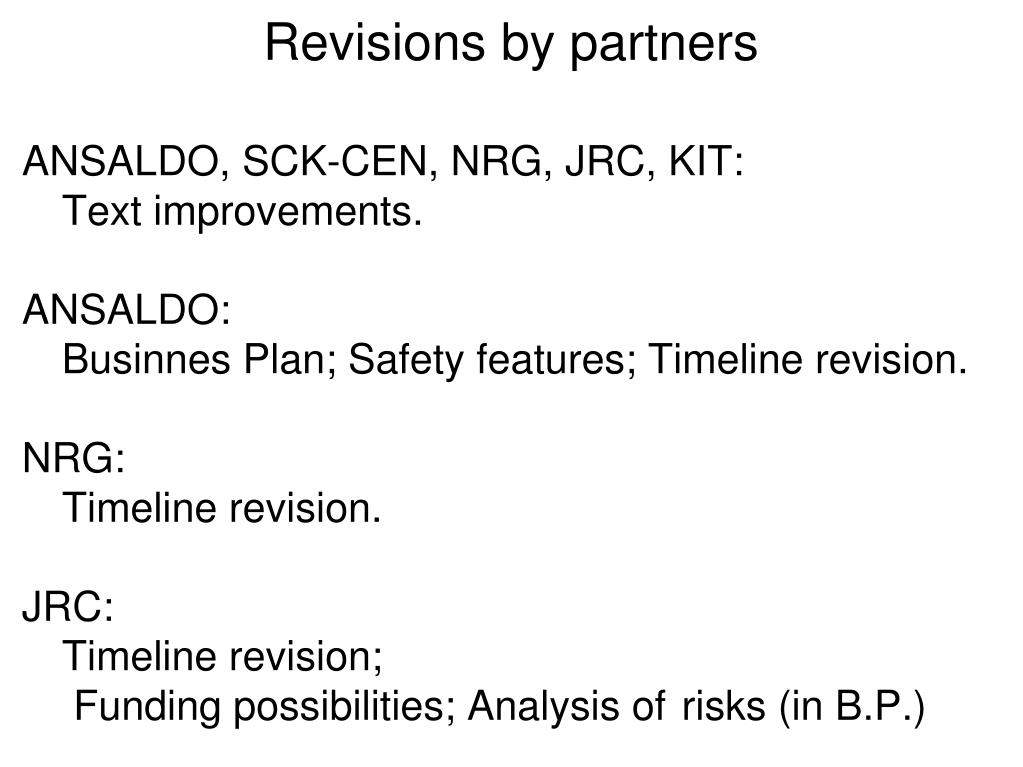

  2. Revisions by partners ANSALDO, SCK-CEN, NRG, JRC, KIT: Text improvements. ANSALDO: Businnes Plan; Safety features; Timeline revision. NRG: Timeline revision. JRC: Timeline revision; Funding possibilities; Analysis of risks (in B.P.)

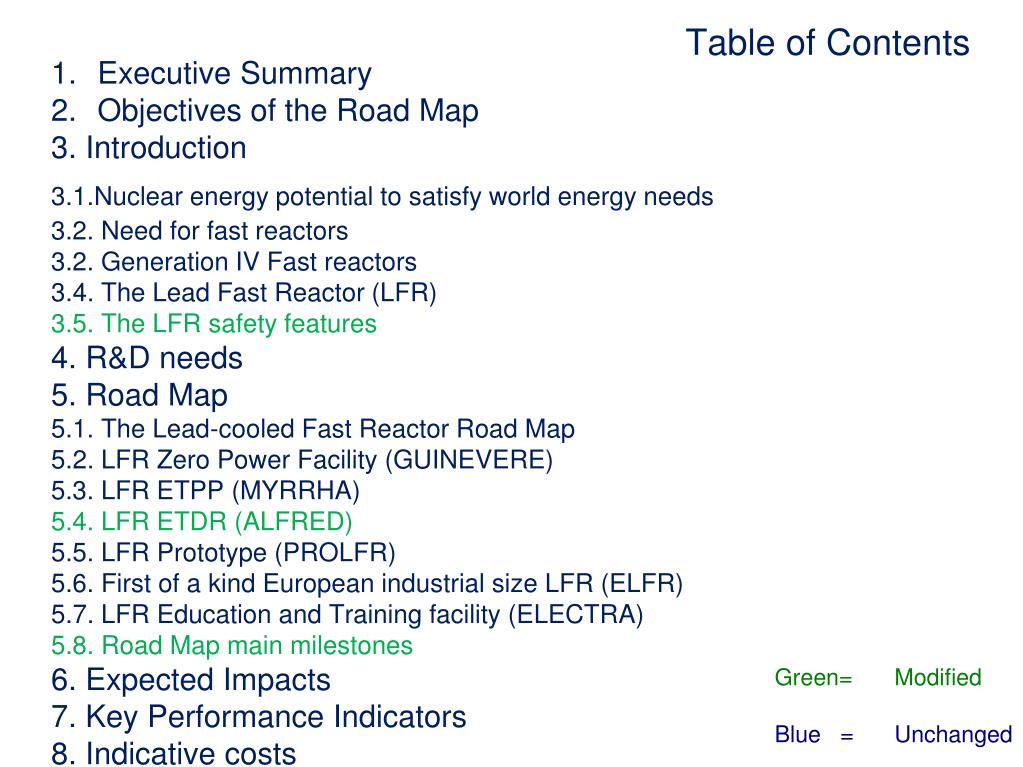

  3. Table of Contents Executive Summary Objectives of the Road Map 3. Introduction 3.1.Nuclear energypotential to satisfy world energyneeds 3.2. Need for fast reactors 3.2. Generation IV Fast reactors 3.4. The Lead Fast Reactor (LFR) 3.5. The LFR safetyfeatures 4. R&D needs 5. Road Map 5.1. The Lead-cooled Fast Reactor Road Map 5.2. LFR Zero PowerFacility (GUINEVERE) 5.3. LFR ETPP (MYRRHA) 5.4. LFR ETDR (ALFRED) 5.5. LFR Prototype (PROLFR) 5.6. First of a kindEuropean industrial size LFR (ELFR) 5.7. LFR Education and Training facility (ELECTRA) 5.8. Road Mapmainmilestones 6. ExpectedImpacts 7. Key Performance Indicators 8. Indicative costs

  4. The LFR safety features Favourable: Lead does not react with air or water. Lead has high density and high thermal inertia. Lead has a low neutron absorption cross section. Lead has a high boiling point. Lead has very low Po-210 production rate. Lead does not form hydrogen. Not favorable: Lead has a high melting point. Lead is opaque. Lead is corrosive and erosive.

  5. LFR ETDR (ALFRED) pre-conceptual design being carried out within the Leader Project (2010-2013) set-up of an international consortium (2013) conceptual design to be carried out by the international consortium (2013-2016) Preliminary contacts with licensing authorities (2013-2016) choice of a dedicated site for construction (2016) basic design for the detailed characterisation of the system (2016-2020) pre-licensing activity (2016-2020) specifications drafting and tendering for commissioning (2020) detailed design by the constructors and construction (2020-2025) licensing (2020-2025), ALFRED commissioning (2025-2026) ALFRED operation (2026 -2034) conceptual re-design (2029-2032) basic re-design (2032-2034) ALFRED refurbishment and new licensing (2034-2035) ALFRED operation phase 2 (2035-....)

  6. Road Map main milestones 2012:establishmentofMYRRHAInternationalConsortium 2013:ALFREDconsortiumagreement 2015:MYRRHACompletionofBasicDesign 2020:ALFREDphase1CompletionofBasicDesign 2020:MYRRHAfuelandmaterialqualification 2023:MYRRHAfulloperation 2024:ALFRED phase 1 (and PROLFR) fuelandmaterialqualification 2025:ALFRED phase 1 fulloperation 2032:ALFRED phase 2 (and ELFR) fuelandmaterialqualification 2034:ALFREDphase2CompletionofBasicDesign 2035: ALFRED phase 2 full operation 2035:PROLFRfulloperation 2045:ELFRfulloperation 12: establishment of MYRRHA International Consortium 2013: ALFRED consortium agreement, site identification 2015: MYRRHA Completion of Basic Design 2020: ALFRED phase 1 Completion of Basic Design 2020: MYRRHA fuel and material qualification 2023: MYRRHA full operation 2024: ALFRED phase 1 (and PROLFR) fuel and material qualification 2025: ALFRED phase 1 full operation 2030: PROLFR Completion of Basic Design 2032: ALFRED phase 2 (and ELFR) fuel and material qualification 2034: ALFRED phase 2 Completion of Basic Design 2035: ALFRED phase 2 full operation 2035: PROLFR full operation 2040: ELFR Completion of Basic Design 2045: ELFR full operation

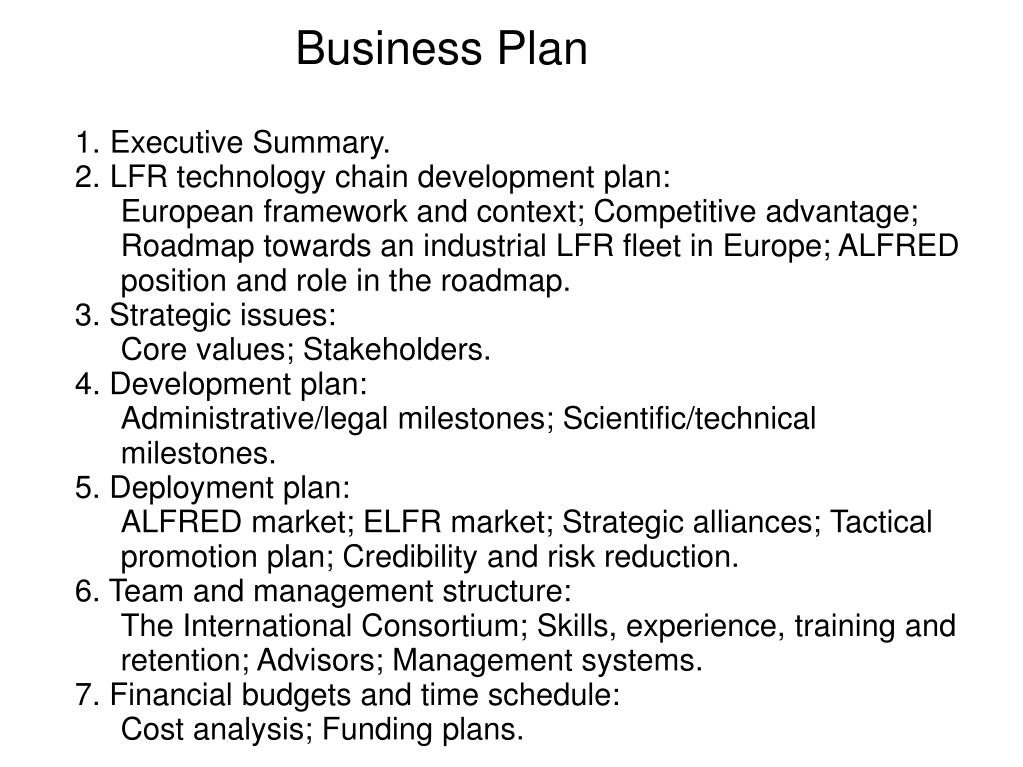

  7. Business Plan Executive Summary. LFR technology chain development plan: European framework and context; Competitive advantage; Roadmap towards an industrial LFR fleet in Europe; ALFRED position and role in the roadmap. 3. Strategic issues: Core values; Stakeholders. 4. Development plan: Administrative/legal milestones; Scientific/technical milestones. 5. Deployment plan: ALFRED market; ELFR market; Strategic alliances; Tactical promotion plan; Credibility and risk reduction. 6. Team and management structure: The International Consortium; Skills, experience, training and retention; Advisors; Management systems. 7. Financial budgets and time schedule: Cost analysis; Funding plans.
