1 / 30

Phase, Item, Formula & Addon

Phase, Item, Formula & Addon . Review. What makes up a database? phase, item, formula, addon When starting to work with the database, what is the 1st area you should check before continuing? top left corner of the window for database name & location. Review.

judd
Télécharger la présentation

Phase, Item, Formula & Addon

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Phase, Item, Formula & Addon

  2. Review • What makes up a database? • phase, item, formula, addon • When starting to work with the database, what is the 1st area you should check before continuing? • top left corner of the window for database name & location

  3. Review • What are some of the advantages of using Estimating Extended? • easy updating / changes, merging of estimates, existing estimates can be re-used, reports can be customized, no saving, ……. • How many different ways can you enter quantities and what are they? • direct quantity entry, calculator, item formula • Can you make item changes in the estimate without affecting the item in the database? • yes

  4. Database & Estimate Files • PES.DAT : contains records that define phases, subcontractors, addons and formulas • PEI.DAT :contain records that define items • PWA.DAT:contains item assembly information • ESTIMATE NAME . PEE :contains data that defines a particular estimate (takeoff)

  5. Setting up of database • the database that you build is the foundationfor all “future” estimates • PrEcIsIoN eStImAtInG iS cAsEsEnSiTiVe • the location of your database should be the same location for all future estimates (spreadsheet) • general information for the database consists of : • information  about  your  company • phasecodeformat (number of decimal places) • number of working hours per day & per week

  6. Phases • Group phase • highest level of the database • general work category (division) • 3000.00 CONCRETE • Regular phase • type of work or type of material • 3111.00 Forms: Footings

  7. Items • Lowestlevel of the database • represents specific task or material • 10 Footing Forms (single use) • used for takeoff to create estimate and where costs are stored

  8. Phases & Items • PHASES & ITEMS are identified by a code & a description • group phases are recommended to be entered all in upper case for visualization

  9. Item setup areas • there are two main areas in the item window screen: • ITEM INFORMATION • COST CATEGORY INFORMATION

  10. Main item areas • Item information • consists of general information about the item, including the phase code, item code, description, takeoff unit, formula, crew and waste factor • Cost category information • you specify information such as item price, order unit, the conversion factor for the order unit if required, the rounding method, taxable and price linking

  11. Item basics • each item is identified by a phase code, item code, description and a takeoff unit • each item has one takeoff unit, which is the unit of measure used during the takeoff process

  12. Item basics • each item has up to five ( 5 ) order units (cost categories ), which is the unit by which the item is priced • you take off vapor barrier in sf ( takeoff unit), but order and price it by the roll (order unit ) • cost categories are: • labour, material, subcontractor, equipment and other

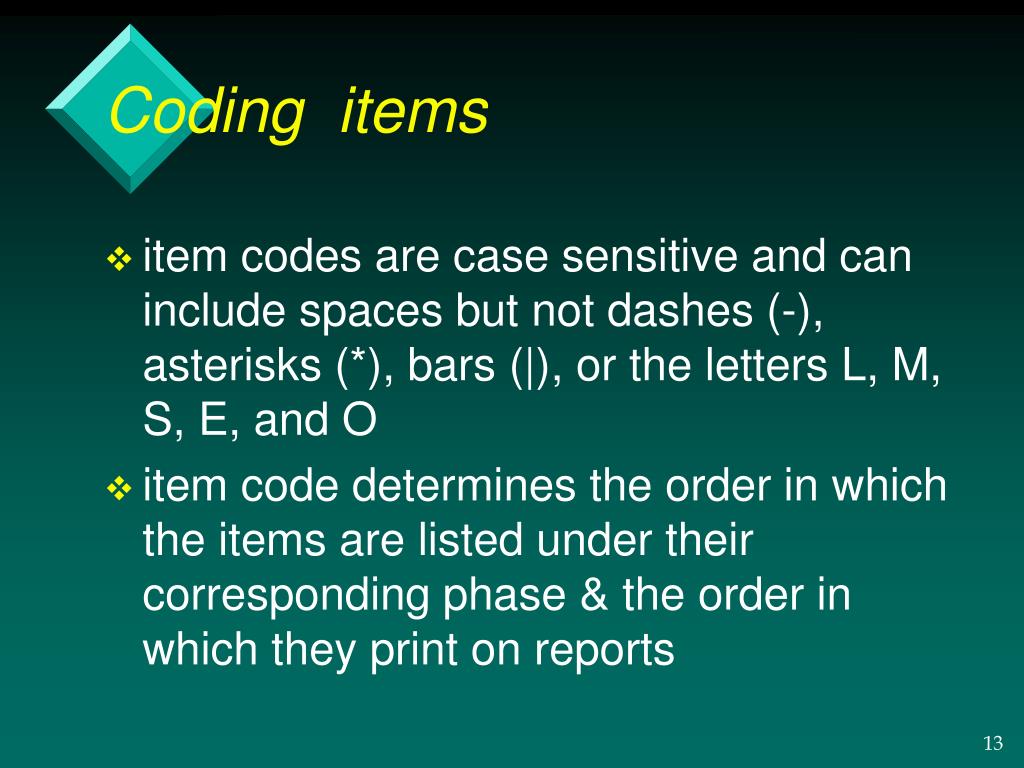

  13. Coding items • item codes are case sensitive and can include spaces but not dashes (-), asterisks (*), bars (|), or the letters L, M, S, E, and O • item code determines the order in which the items are listed under their corresponding phase & the order in which they print on reports

  14. Alphanumeric Codes are More Descriptive • 3.188 Wiremesh • w64 Wiremesh 6x6 4/4 sq • w66 Wiremesh 6x6 6/6 sq • w610 Wiremesh 6x6 10/10 sq 6.110 Studs 2x4 • s4 8 Studs 2 x 4 x 8 • s410 Studs 2 x 4 x 10 • s6 8 Studs 2 x 6 x 8 • s610 Studs 2 x 6 x 10 • s612 Studs 2 x 6 x 12

  15. Steps for setting up an item 1- enter the general item information 2- specify the cost category 3- specify the cost category information 4- enter a memo if required

  16. Enter general item information ( step 1 ) • Description • should be specific • 25 mpa conc., for sidewalk w/ 6% air, m3 • Takeoff Unit • is the unit of measure used during the takeoff process • formula answer • not always the same as the order unit

  17. Enter general item information ( step 1 ) • Formula • used to calculate the takeoff unit • use list available or pick inside the formula field to activate edit formula button if the formula does not exist • Waste factor • specifies a waste percentage for the item • waste can be applied to one or all cost categories under Rounding tab

  18. Select Cost Categories ( step 2 ) • Categories • specifies the cost categories for the item (labor, material, subcontract, equipment, other ) • you can specify up to five ( 5 ) categories for an item

  19. Specify cost category information ( step 3 ) • Price- • specifies the price per order unit • / (per) - • specifies the order unit for the item to be priced • DATE - • shows the last time the item was updated

  20. Specify cost category information ( step 3 ) • CONVERSION / PRODUCTIVITY • defines the relationship between the takeoff unit and the order unit as a conversion factor • if the units are different they are automatically displayed in the convert field • you can switch between conversion ways by using ( / ) button

  21. Specify cost category information ( step 3 ) • Link Button- • allows the linking of items together for fast price editing to several items at once

  22. Specify a default memo ( step 4 ) • pick the NOTES button and it allows you to enter a memo which is displayed on reports and in the spreadsheet detail window EXAMPLE: concrete to have 5 % air-entrainment and must be purchased from RL Concrete Supplies

  23. Saving time • Copy • uses the item list, and duplicates a selected item then edit the information as needed • Prefill • uses the last item’s information to create a new item, then edit as required

  24. Formula Basics • a formula lets you convert drawing dimensions into quantities • formulas are stored as part of the database and are attached to items • formulas are made up of standard mathematical symbols and variables

  25. Formula Basics • variables are the values you specify during takeoff • wall length’ • conc. depth” • the rules of algebraic logic apply • left to right within parentheses • * and / operation performed first • then + and - operations are performed

  26. Formulas in takeoff window SF Conc Wall Forms = Length’ x Height of all Wall’

  27. Formulas • Number of pipes • length’/pipe length’ • 10’/4’ = 2.5 pipes • Roundto(length’/pipe length’,1,1) • 10’/4’ = 2.5 roundup = 3 pipes

  28. Addons ( markup ) • profit, bond fee, permit fee, insurance fee, overhead, sales tax • each is identified by three digit numbers which you define • can be set up to be allocated across those items from which it was earned • the cost of supervision can be allocated across those items that include labor ( L ) as a cost category

  29. Setup steps Database 1- General information 2- Group phases & regular phases 3- Items 4- Formulas 5- Addons Estimate 1- Spreadsheet 2- Select items for takeoff 3- Enter dimensions

  30. Assignment • Perform assignment as per information in Blackboard • Assignment due at the beginning of next class 11:10 am • PRINT BEFORE GETTING TO CLASS
