460 likes | 561 Vues
This project outlines a comprehensive framework for autonomous server administration leveraging virtualization technologies, particularly Xen and TUNe. It includes a detailed preliminary study on system requirements, architecture design, and integration schemes. Key considerations such as migration requirements, performance studies, and resource management frameworks are addressed. Through integration with various server types—including DNS, DHCP, and NFS servers—the project illustrates scenarios of client specifications and migration scenarios, ensuring minimal processing interruptions and preserved TCP connections during operations.
E N D
Plan • Context • Client Specifications • Xen setting up • Preliminary study • Requirements • Architecture • Test Scheme • Integration in TUNe • Introduction to TUNe • Architecture • Wrappers • Diagrams • Project Management • Progress Report
Context Expansion Criteria Shrink Criteria Virtual Machine 1 Virtual Machine 2

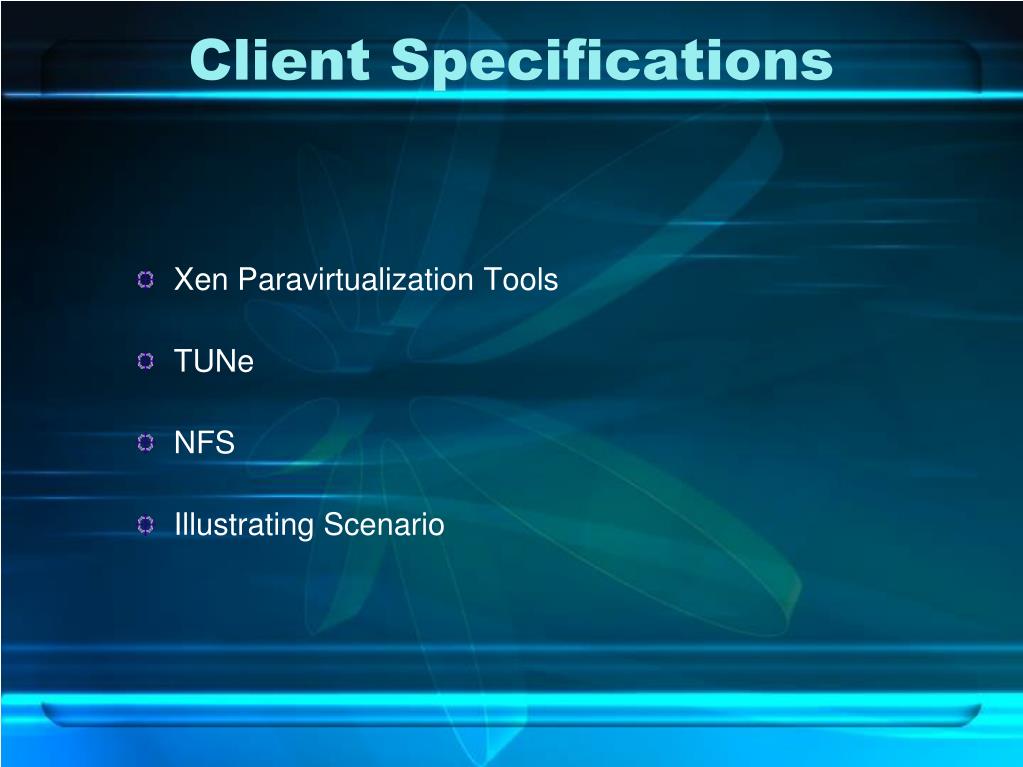

Client Specifications • XenParavirtualization Tools • TUNe • NFS • Illustrating Scenario
Client Specifications Request number rising Request number reduction Server 1 Server 2
Preliminary Study Xen Control Software User Applications User Applications User Applications Domain 0 User Domain 1 User Domain 2 Abstraction Layer Xen Control Interface Abstraction Layer Abstraction Layer Modified Drivers Modified Drivers Modified Drivers Xen Hypervisor Hardware
Preliminary Study DomU xm migrate Dom0-1 Dom0-2
Preliminary Study DomU-1 DomU-2 eth0 eth1 eth0 vif1.0 vif2.0 vif2.0 vif0.0 peth0 xenbr0 eth0 Dom0 Physical Machine

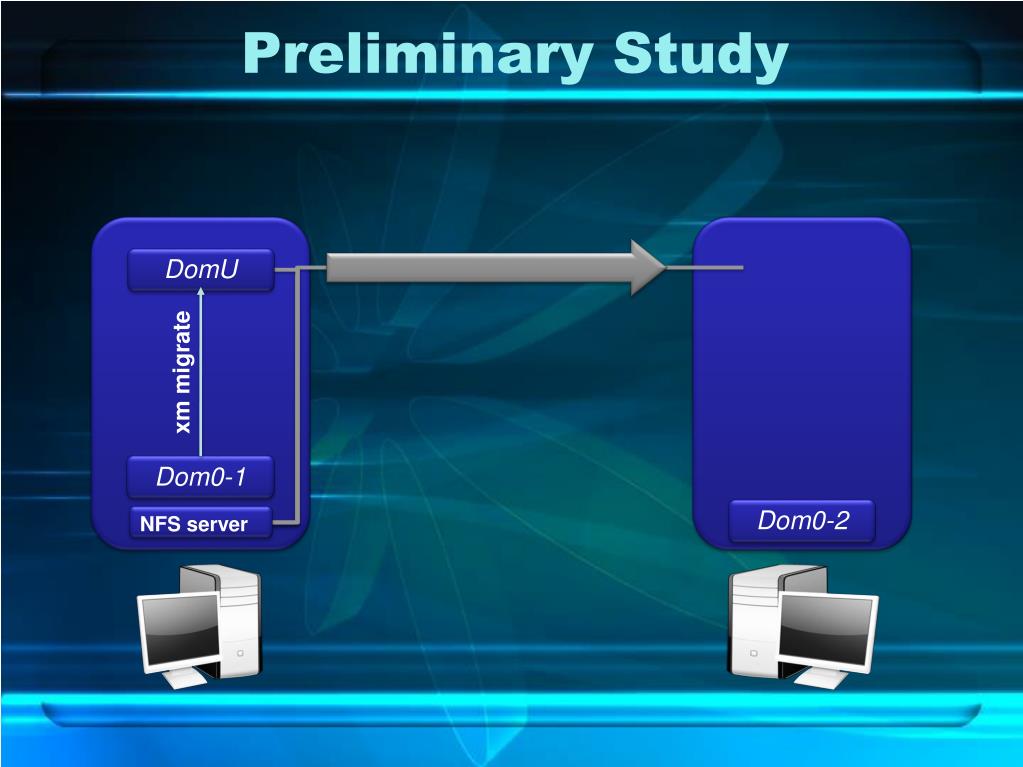

Preliminary Study DomU xm migrate Dom0-1 Dom0-2 NFS server

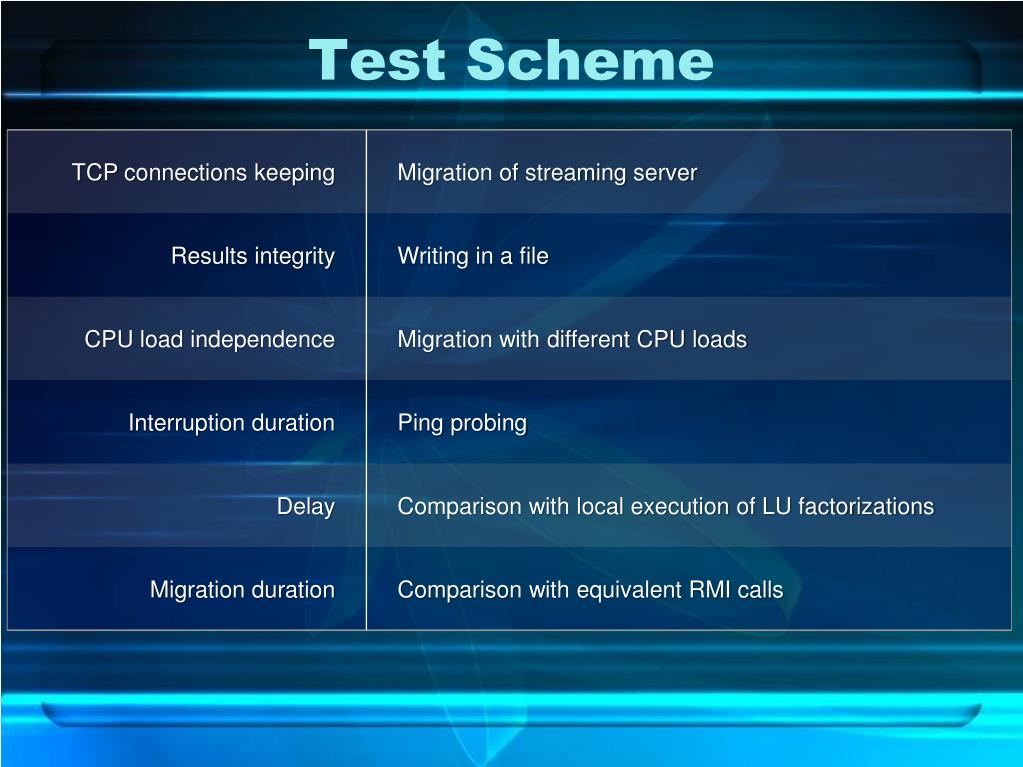

Requirements • Migration requirements: • No task processing interruption • TCP connection keeping • Results consistency • CPU load independence • Migration performance study: • Interruption duration • Migration duration • Delay • Integration in TUNe

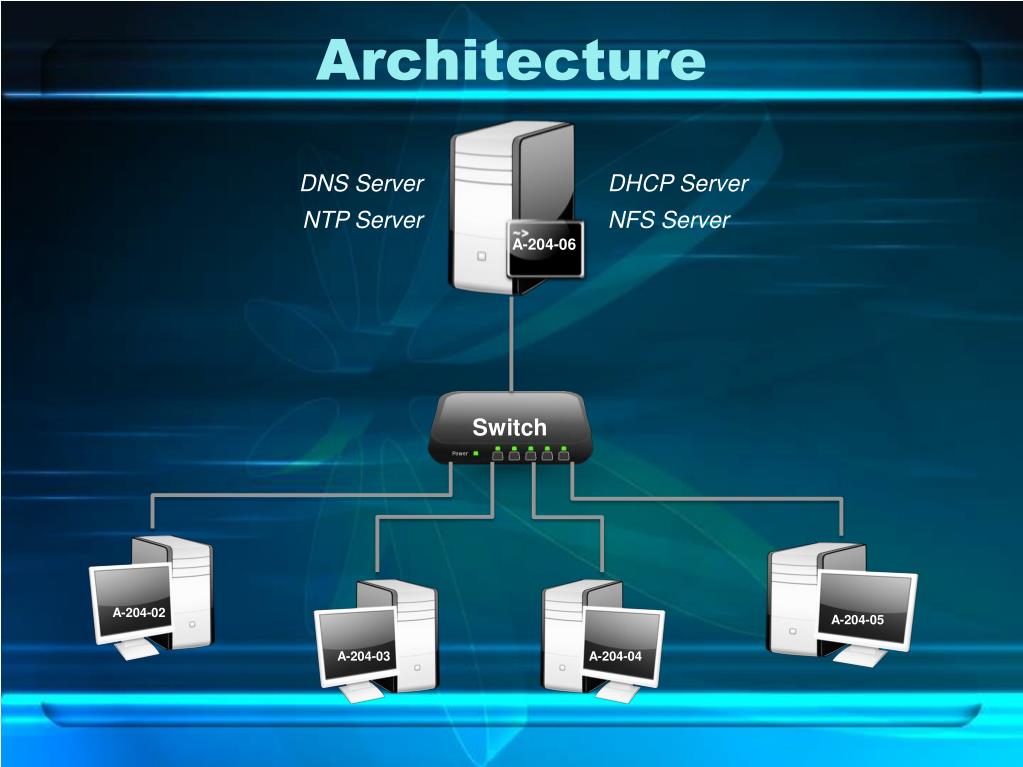

Architecture DNS Server DHCP Server NTP Server NFS Server A-204-06 A-204-02 A-204-03 A-204-04 A-204-05 Switch

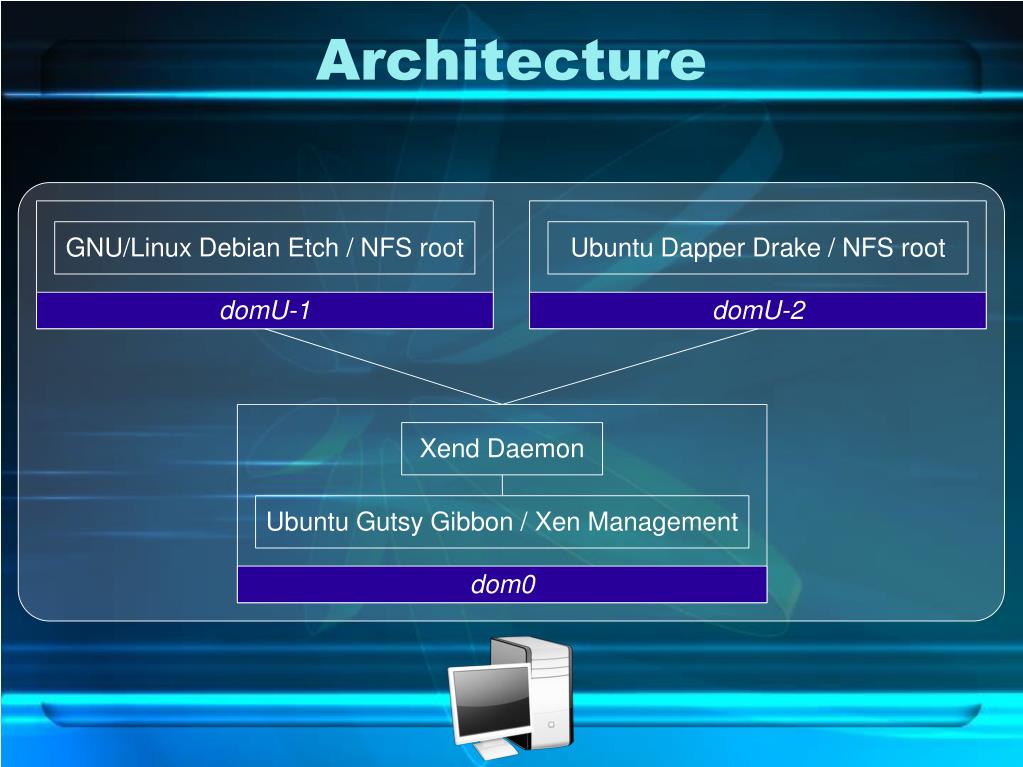

GNU/Linux Debian Etch / NFS root Ubuntu Dapper Drake / NFS root domU-1 domU-2 Xend Daemon Ubuntu Gutsy Gibbon / Xen Management dom0 Architecture
Test SchemeResults consistency DomU Migration Writing in a file Dom0-1 Dom0-2
Test SchemeCPU Load Independence Migration DomU Dom0-1 Dom0-2 CPU loading

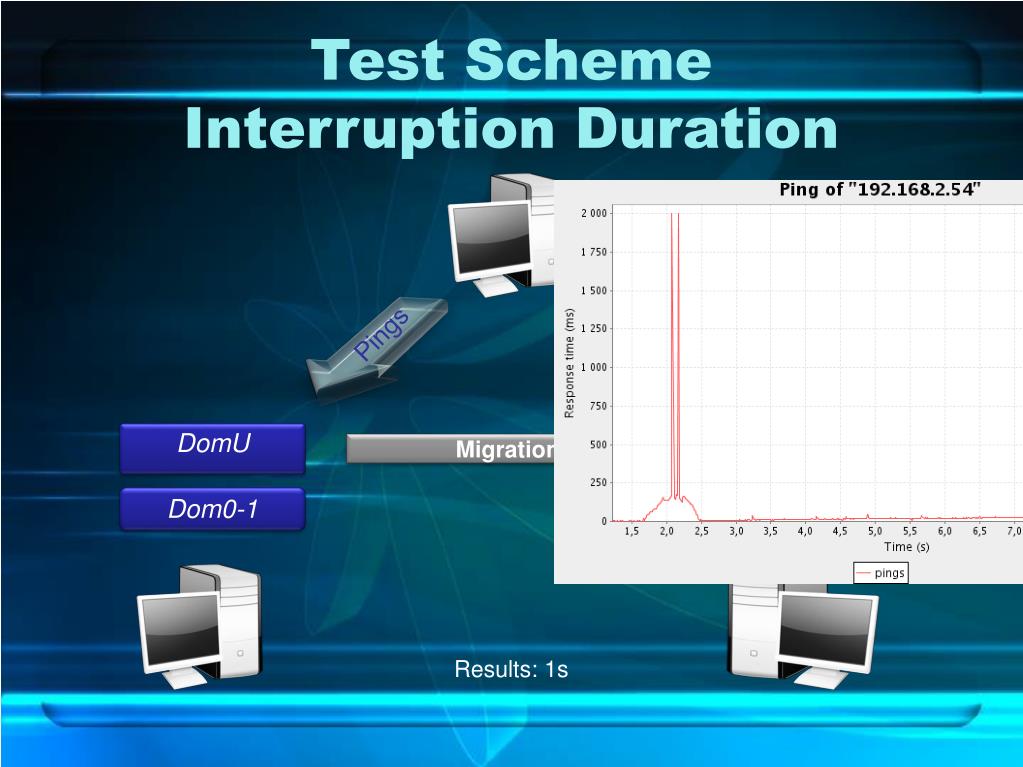

Test SchemeInterruption Duration Monitor Computer Pings Migration DomU Dom0-1 Dom0-2 Results: 1s
Test SchemeDelay DomU Migration LU Factorizations Dom0-2 Dom0-1
Test SchemeMigration duration DomU Ping pong Migration Dom0-1 Chrono Dom0-2
Test SchemeTCP Connection Preservation Streaming Client DomU Streaming Server Migration Dom0-1 Dom0-2
Test SchemeTCP Connection Preservation Streaming Client Output Network Traffic Monitor Dom0 Destination Dom0 Source

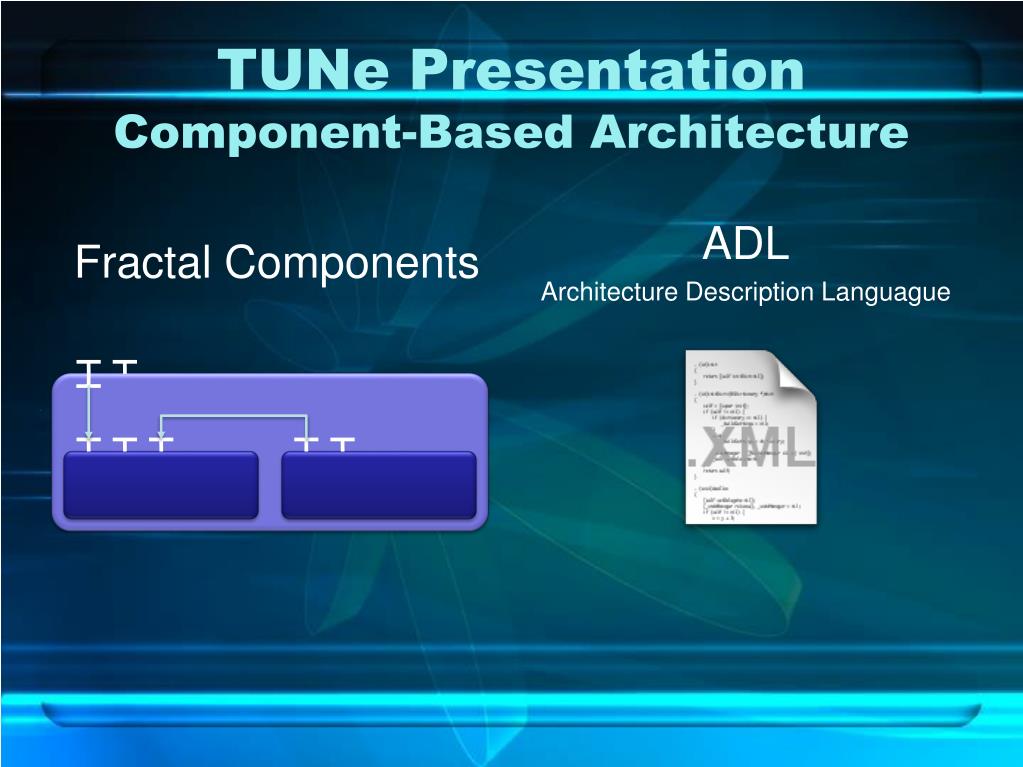

TUNe PresentationComponent-Based Architecture Fractal Components ADL Architecture Description Languague
Stubs Tune Wrapper Legacy Software TUNe Presentation High Level management tools Wrappers

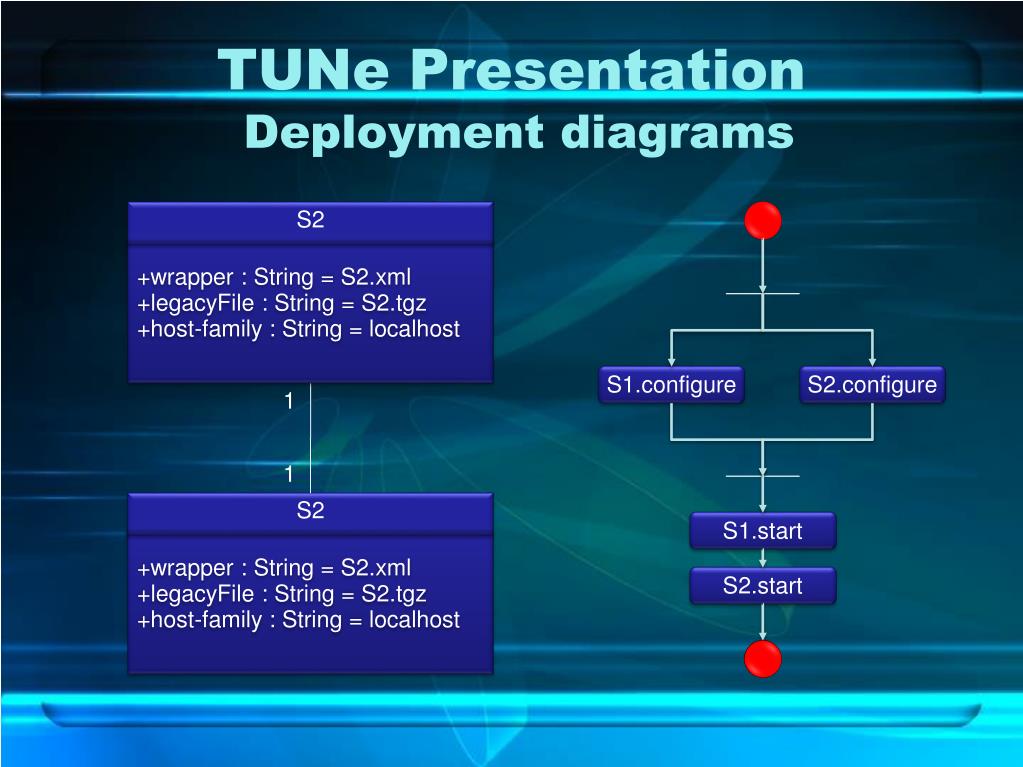

TUNe Presentation Deployment diagrams S2 +wrapper : String = S2.xml +legacyFile : String = S2.tgz+host-family : String = localhost S1.configure S2.configure 1 1 S2 S1.start +wrapper : String = S2.xml +legacyFile : String = S2.tgz+host-family : String = localhost S2.start

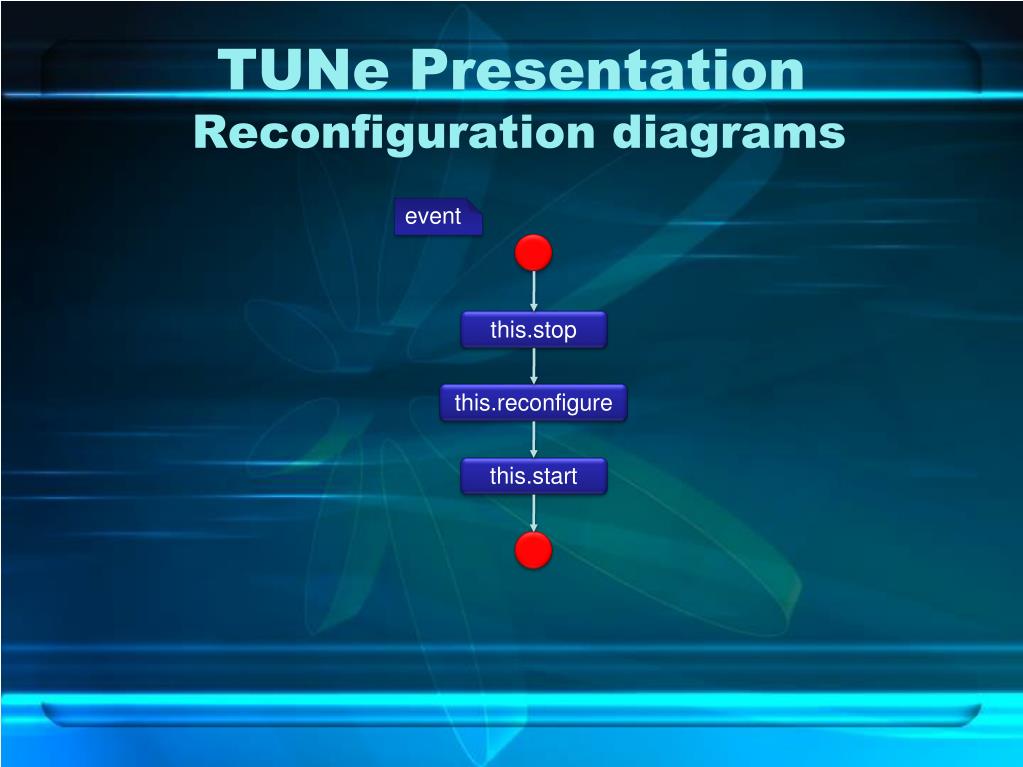

this.stop this.reconfigure this.start TUNe Presentation Reconfiguration diagrams event
Pool Architecture Migration DomU Dom0-1 Dom0-2 Migrate Probe0-1 Probe0-2 Event TUNeAdministrator
Pool ArchitectureTUNe wrappers Migrate Start Stop domU wrapper domU Start Stop Probe wrapper
this.probed.migrate etch1-1.start etch1-1.stop etch1-1-Probe.start etch1-1-Probe.stop Pool ArchitectureTUNe Diagrams Migrate Start Stop
Illustrating Scenario Streaming Client Migration DomU Streaming Server Migrate Dom0-1 Dom0-2 Probe0-1 Probe0-2 CPU loading Event TUNeAdministrator

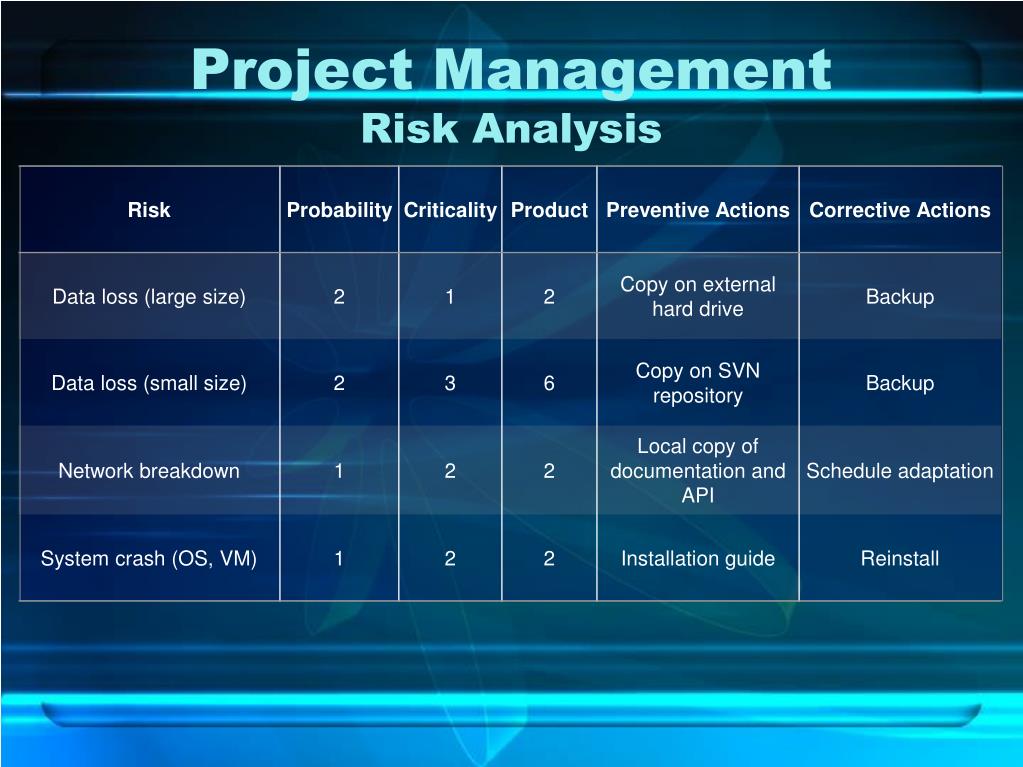

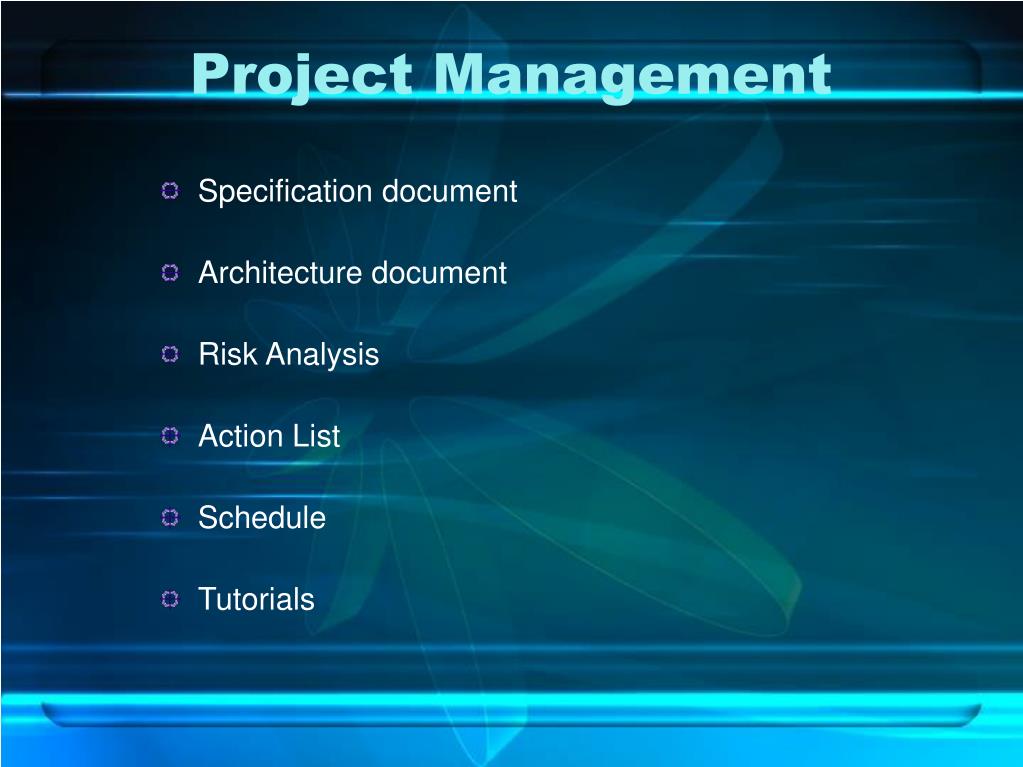

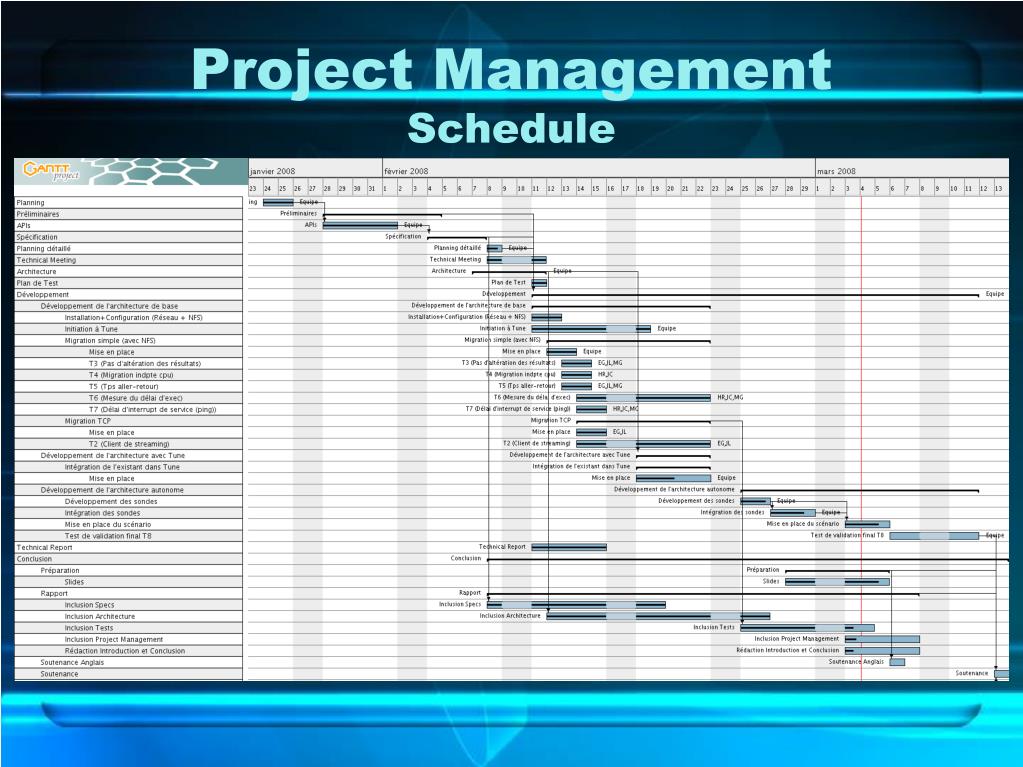

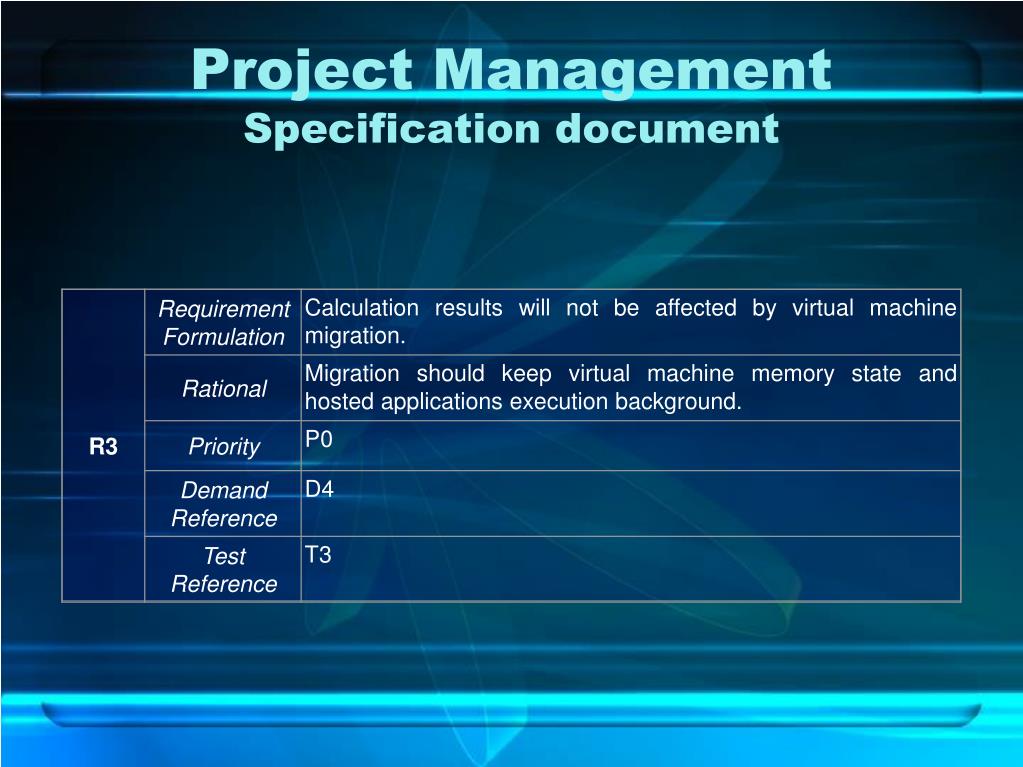

Project Management Specification document Architecture document Risk Analysis Action List Schedule Tutorials

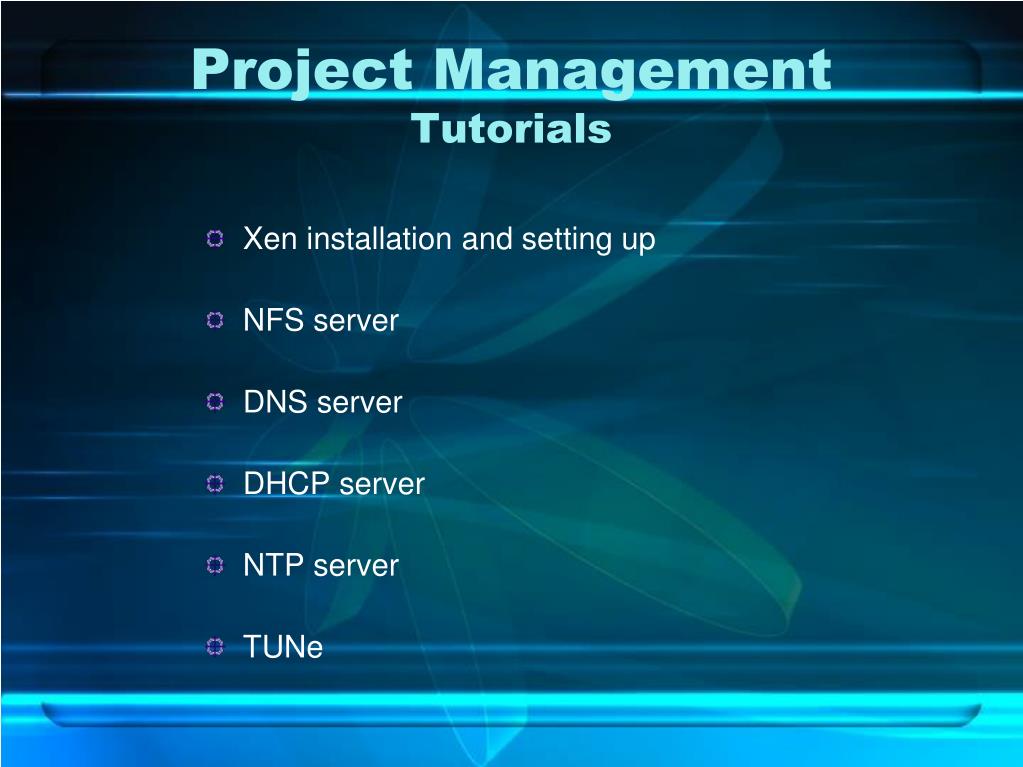

Project ManagementTutorials • Xen installation and setting up • NFS server • DNS server • DHCP server • NTP server • TUNe

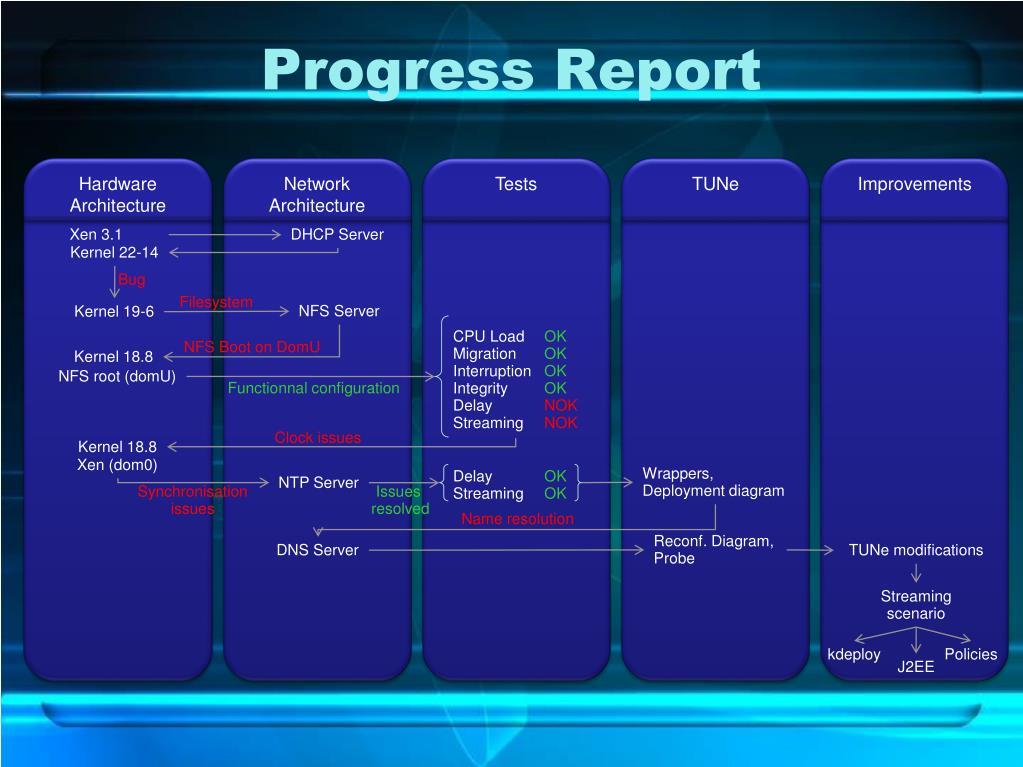

Progress Report Hardware Architecture Network Architecture Tests TUNe Improvements Xen 3.1 DHCP Server Kernel 22-14 Bug Filesystem NFS Server Kernel 19-6 CPU Load OK Migration OK Interruption OK Integrity OK Delay NOK Streaming NOK NFS Boot on DomU Kernel 18.8 NFS root (domU) Functionnal configuration Clock issues Kernel 18.8 Xen (dom0) Wrappers, Deployment diagram Delay OK Streaming OK NTP Server Synchronisation issues Issues resolved Name resolution Reconf. Diagram, Probe DNS Server TUNe modifications Streaming scenario kdeploy Policies J2EE
Progress Report Hardware Architecture Network Architecture Tests TUNe Improvements Xen 3.1 DHCP Server Kernel 22-14 Bug Filesystem NFS Server Kernel 19-6 CPU LoadOK Migration OK Interruption OK IntegrityOK Delay NOK Streaming NOK NFS Boot on DomU Kernel 18.8 NFS root (domU) Functionnal configuration Clock issues Kernel 18.8 Xen (dom0) Wrappers, Deployment diagram Delay OK Streaming OK NTP Server Synchronisation issues Issues resolved Name resolution Reconf. Diagram, Probe DNS Server TUNe modifications Streaming scenario kdeploy Policies J2EE
Progress Report Hardware Architecture Network Architecture Tests TUNe Improvements Xen 3.1 DHCP Server Kernel 22-14 Bug Filesystem NFS Server Kernel 19-6 CPU Load OK Migration OK Interruption OK Integrity OK Delay NOK Streaming NOK NFS Boot on DomU Kernel 18.8 NFS root (domU) Functionnal configuration Clock issues Kernel 18.8 Xen (dom0) Wrappers, Deployment diagram Delay OK Streaming OK NTP Server Synchronisation issues Issues resolved Name resolution Reconf. Diagram, Probe DNS Server TUNe modifications Streaming scenario kdeploy Policies J2EE
Progress Report Hardware Architecture Network Architecture Tests TUNe Improvements Xen 3.1 DHCP Server Kernel 22-14 Bug Filesystem NFS Server Kernel 19-6 CPU Load OK Migration OK Interruption OK Integrity OK Delay NOK Streaming NOK NFS Boot on DomU Kernel 18.8 NFS root (domU) Functionnal configuration Clock issues Kernel 18.8 Xen (dom0) Wrappers, Deployment diagram Delay OK Streaming OK NTP Server Synchronisation issues Issues resolved Name resolution Reconf. Diagram, Probe DNS Server TUNe modifications Streaming scenario kdeploy Policies J2EE
