In October 2009, we provided a project update on the Electronic Faculty Effort & Cost Share initiative. We initiated beta testing in mid-September, uncovering significant performance improvement opportunities. The technical team is currently tuning the system based on identified root causes and revising work plans to address these issues. Notable upcoming activities include beta testing, semi-annual Faculty Engagement Checks (FECs), and preparing for the academic school winter quarter launch from December 16 to March 15, 2010.
E N D
Electronic Faculty Effort & Cost ShareProject Update Strategic Projects October, 2009

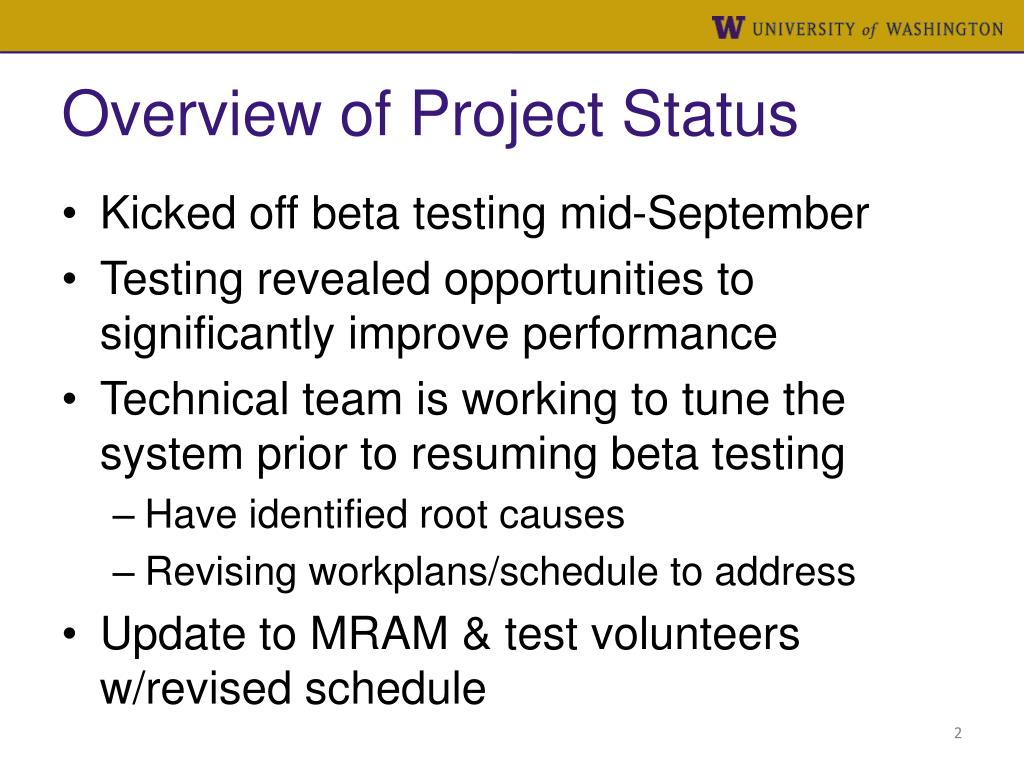

Overview of Project Status • Kicked off beta testing mid-September • Testing revealed opportunities to significantly improve performance • Technical team is working to tune the system prior to resuming beta testing • Have identified root causes • Revising workplans/schedule to address • Update to MRAM & test volunteers w/revised schedule
eFECS Project Activities – Now through Launch 09/09 10/09 11/09 12/09 01/10 02/10 03/10 04/10 05/10 06/09 07/09 08/09 09/09 Beta Test – Semi-Annual FECs Planned Launch – Semi-Annual FECs Planned Launch – Academic School FECs Winter Qtr: Dec 16 – Mar 15 2010 Second Launch Window – Semi-Annual FECs Beta Test – Academic Schools June 16 – Sept 15 2009 Jan 1 – June 30 2009 July 1 – Dec 31 2009 Jan 1 – June 30 2010 Production Support Enhancements Workflow Legend: Calendar Year Reports Academic Year Reports
