DESCRIPTION

Project Management (x470). Module 02 : Knowing What the Project Is, Part 1. Class Road Map. Session 2 Agenda. Project Genesis. Knowing WHAT The Project Is. No formal project approval (initiation) process Unrealistic expectations and assumptions

1 / 67

Télécharger la présentation

Project Management (x470)

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

Playing audio...

  1. Project Management (x470) Module 02 : Knowing What the Project Is, Part 1

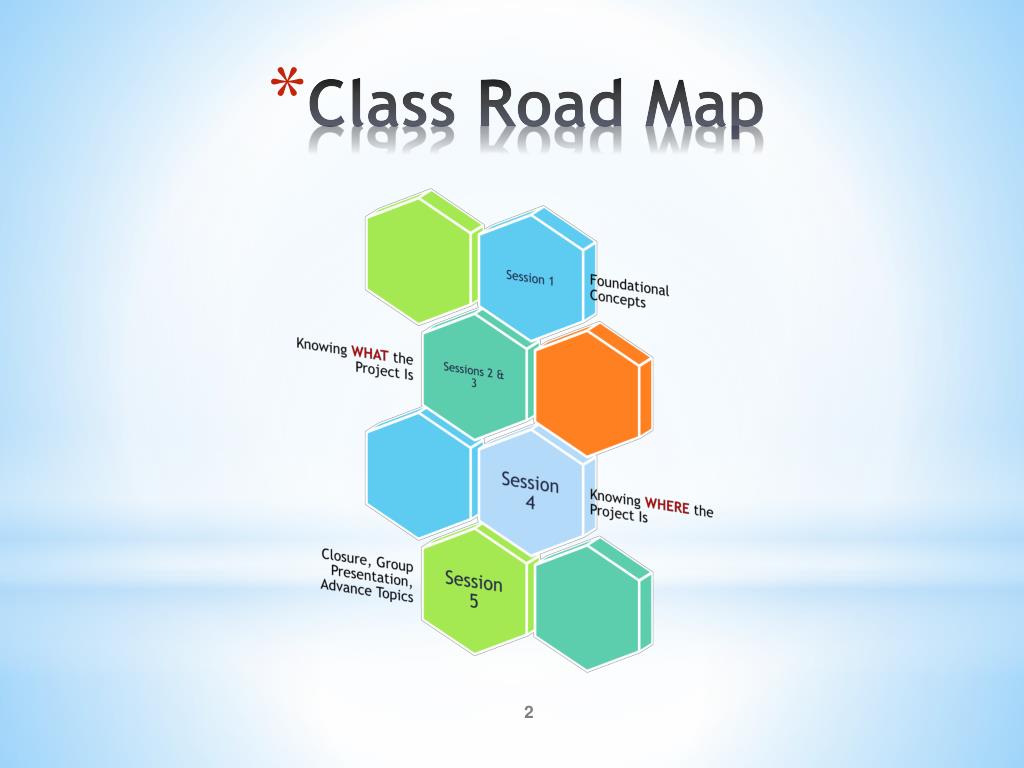

  2. Class Road Map

  3. Session 2 Agenda

  4. Project Genesis Knowing WHAT The Project Is

  5. No formal project approval (initiation) process • Unrealistic expectations and assumptions • Timing of Project Manager engagement • Degree of accuracy for project and product documents • Speed vs Accuracy vs Change Control culture • Functional Areas’ Concern: Spending precious resources’ time on projects that will be disapproved Project Approval (Initiation) Challenges

  6. Project documentation intensity / rigor. Factors: • Duration • Cost • Project risk • Priority / importance • Project classification • Small, Medium, Large • Standard, Light, Tracking • “Project” definition • Projects or investments • Project approval process • Project classification • Strategy alignment • Functional group • Others Project Approval “Monitor & Control” Aspects

  7. Knowing Whatthe Project Is:Planning Fundamentals “Failing to plan is planning to fail.” - Harold Kerzner

  8. Q3: Extreme Approach • Nothing about the project is certain • Product is accepted after some iterations or pulls plug • R & D Q4: Unlikely Situation Solution looking for a problem Unclear GOAL • Q2: Adaptive / Iterative Approach • Product development and process improvement • Production prototype development • Q1: Linear Approach • Low complexity • Well understood technology • Low risk • Completed similar project Project Life Cycle Approaches Clear Unclear Clear SOLUTION / REQUIREMENTS

  9. Linear Extreme Iterative / Adaptive UNCLEAR UNCERTAINTY & COMPLEXITY INCREASES GOAL Lifecycle Approaches Uncertainty & Complexity CLEAR UNCLEAR CLEAR SOLUTION & REQUIREMENTS

  10. Adaptive / Iterative Life Cycle Model Next Cycle?

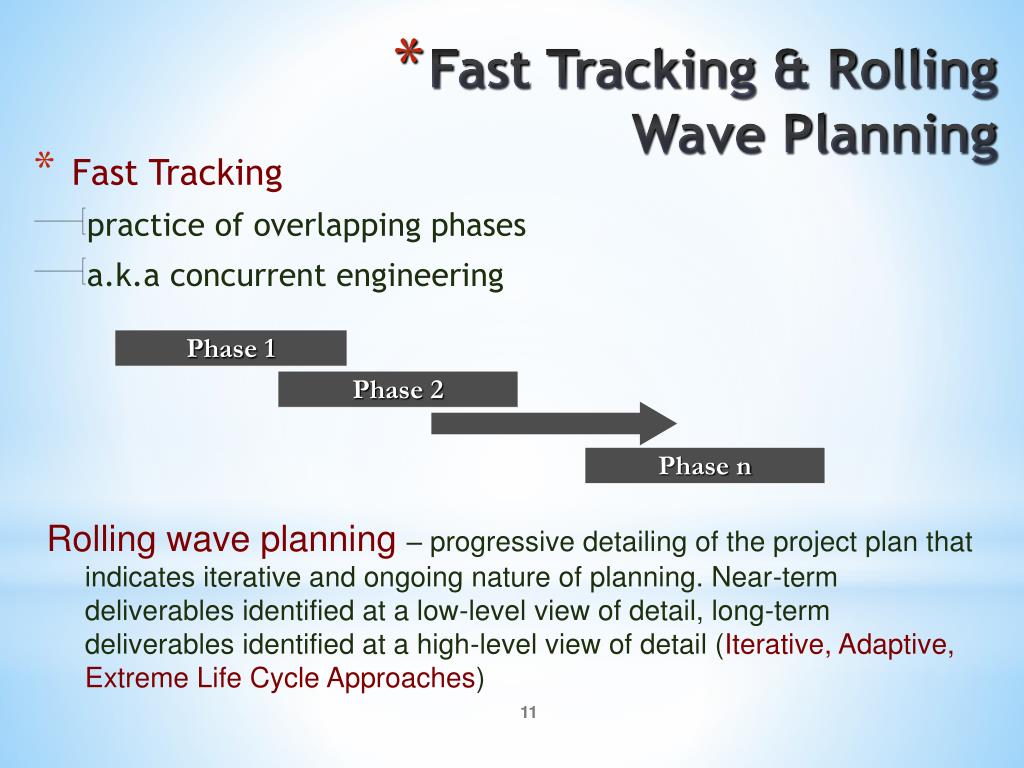

  11. Fast Tracking • practice of overlapping phases • a.k.a concurrent engineering Phase 1 Phase 2 Phase n Fast Tracking & Rolling Wave Planning Rolling wave planning– progressive detailing of the project plan that indicates iterative and ongoing nature of planning. Near-term deliverables identified at a low-level view of detail, long-term deliverables identified at a high-level view of detail (Iterative, Adaptive, Extreme Life Cycle Approaches)

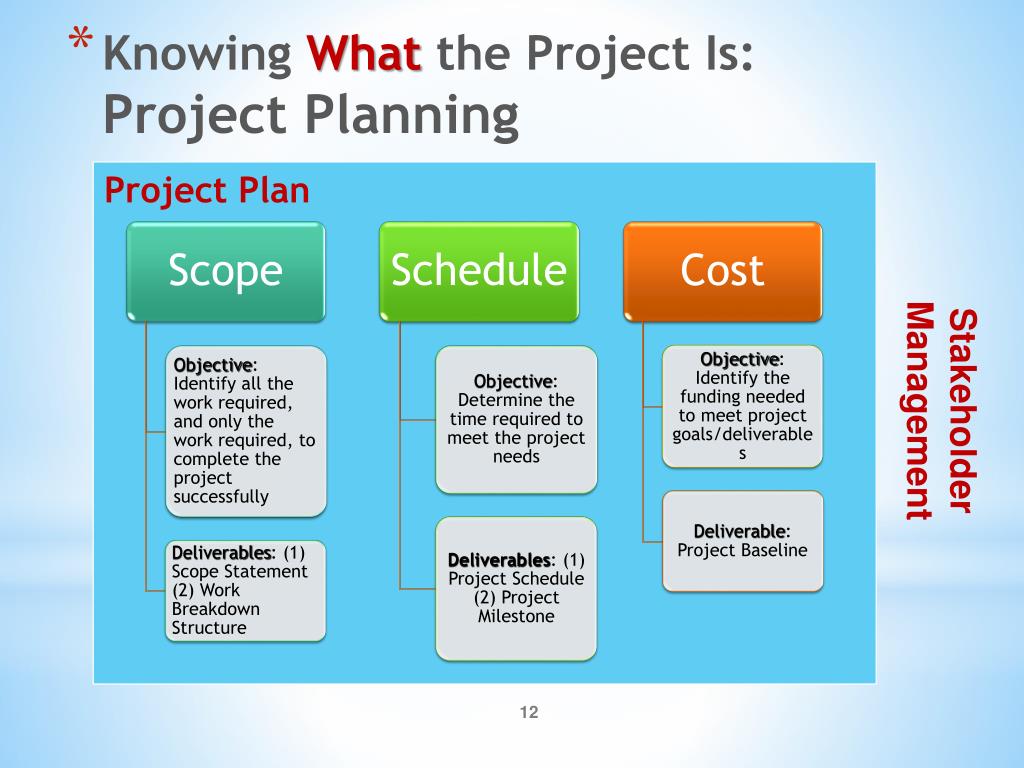

  12. Stakeholder Management Knowing Whatthe Project Is:Project Planning

  13. Objective: Identify all the work required, and only the work required, to complete the project successfully Collect Requirements • Stakeholder Register • Project Charter • Product Needs • Project Mgm’t Needs Define Scope Create WBS Knowing Whatthe Project Is:Scope Planning Steps Scope Statement Work Breakdown Structure Validate Scope Approved Scope Documents

  14. Product scope description • Characteristic of the product that the project will produce • Project life cycle approach • Deliverables • List of sub-products whose full and satisfactory delivery marks project completion. Usually includes milestone deliverables. • Product acceptance criteria • Successful completion metrics • Project exclusions • Project assumptions and constraints • Sponsor approval Knowing Whatthe Project Is:Project Scope Statement

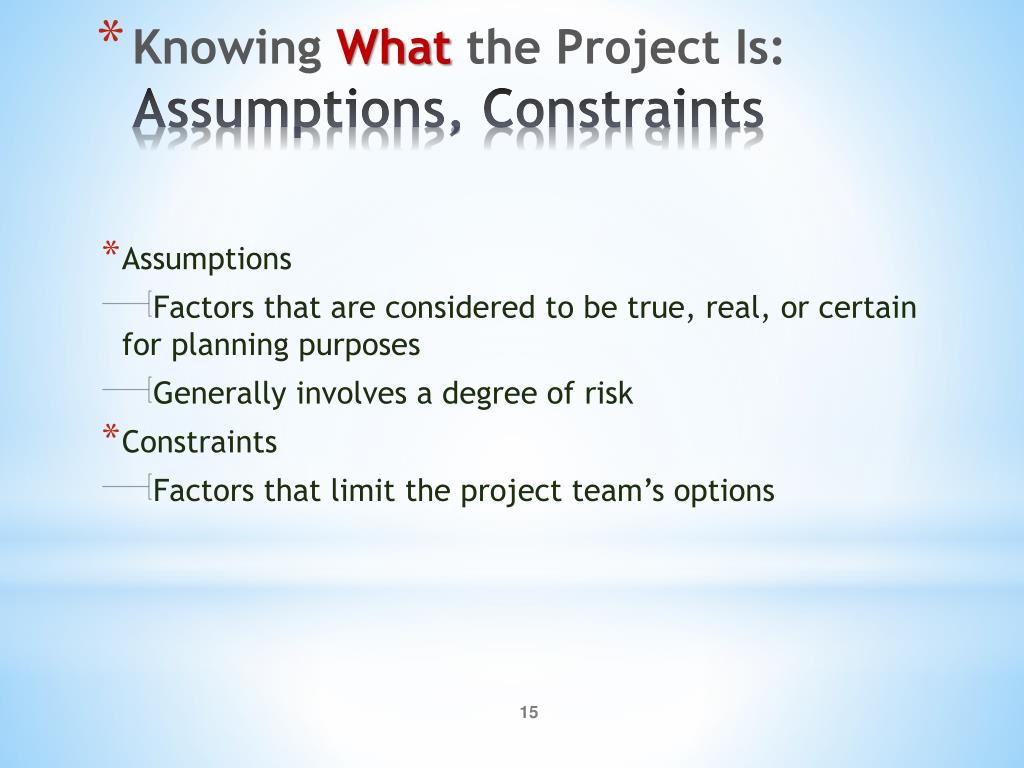

  15. Assumptions • Factors that are considered to be true, real, or certain for planning purposes • Generally involves a degree of risk • Constraints • Factors that limit the project team’s options Knowing Whatthe Project Is:Assumptions, Constraints

  16. Draft a Scope Statement for your project (30 minutes) • Use the workbook template. Team Work

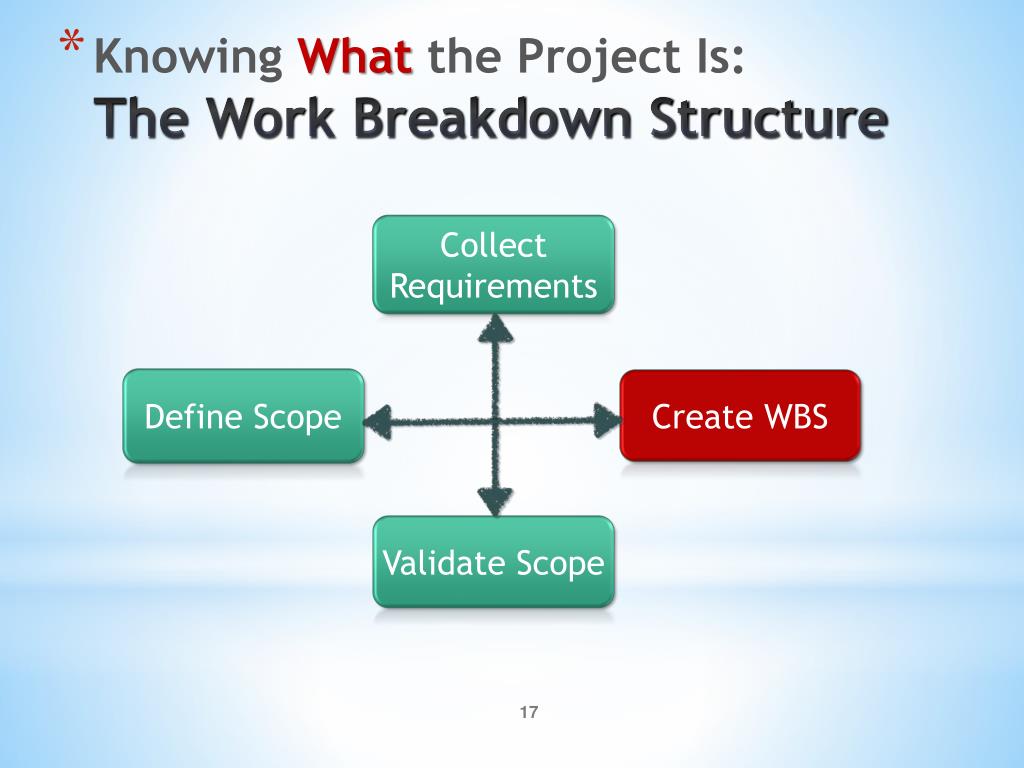

  17. Collect Requirements Define Scope Create WBS Knowing Whatthe Project Is:The Work Breakdown Structure Validate Scope

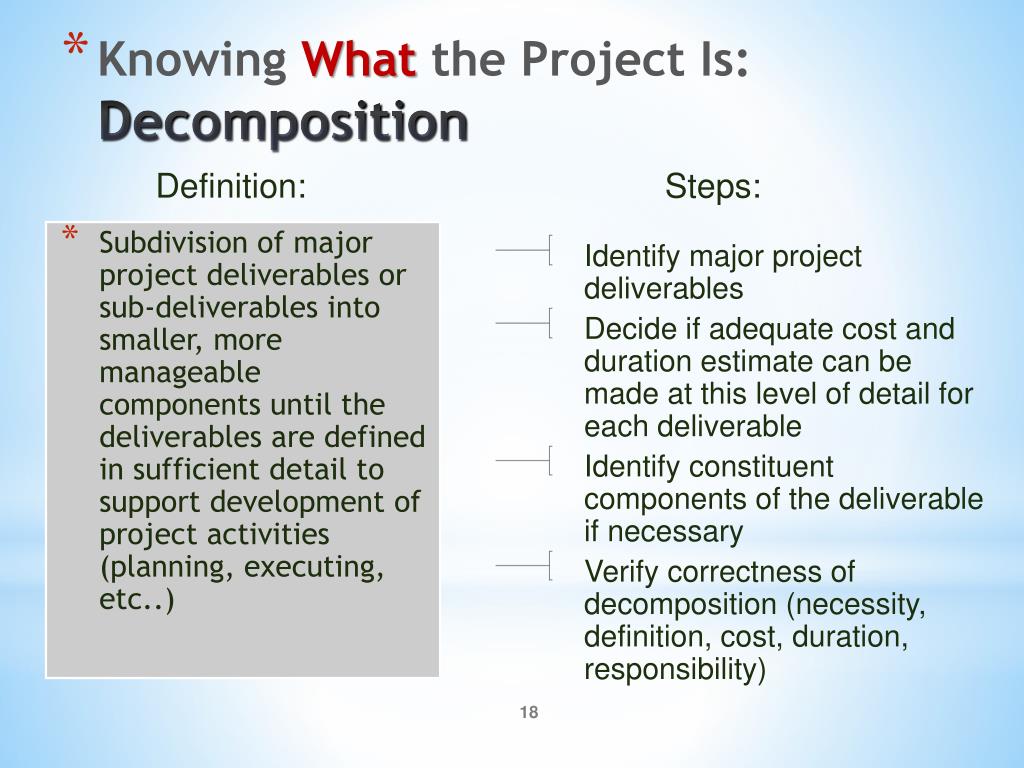

  18. Subdivision of major project deliverables or sub-deliverables into smaller, more manageable components until the deliverables are defined in sufficient detail to support development of project activities (planning, executing, etc..) Definition: Steps: • Identify major project deliverables • Decide if adequate cost and duration estimate can be made at this level of detail for each deliverable • Identify constituent components of the deliverable if necessary • Verify correctness of decomposition (necessity, definition, cost, duration, responsibility) Knowing Whatthe Project Is:Decomposition

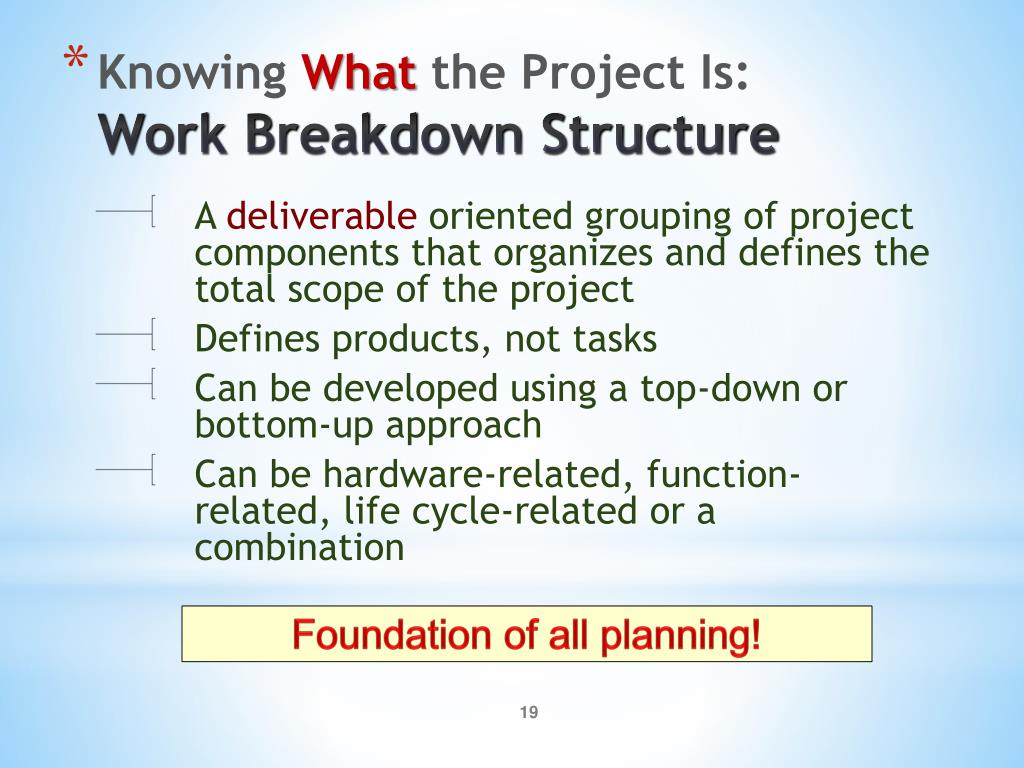

  19. A deliverable oriented grouping of project components that organizes and defines the total scope of the project • Defines products, not tasks • Can be developed using a top-down or bottom-up approach • Can be hardware-related, function-related, life cycle-related or a combination Knowing Whatthe Project Is:Work Breakdown Structure Foundation of all planning!

  20. Lowest level deliverable in a WBS • Work effort guideline - 80 to 150 hours • Ownership assigned at this level • Tasks are identified under this level • Task size guideline - not to exceed 80 hours; less for high risk project Knowing Whatthe Project Is:Work Package

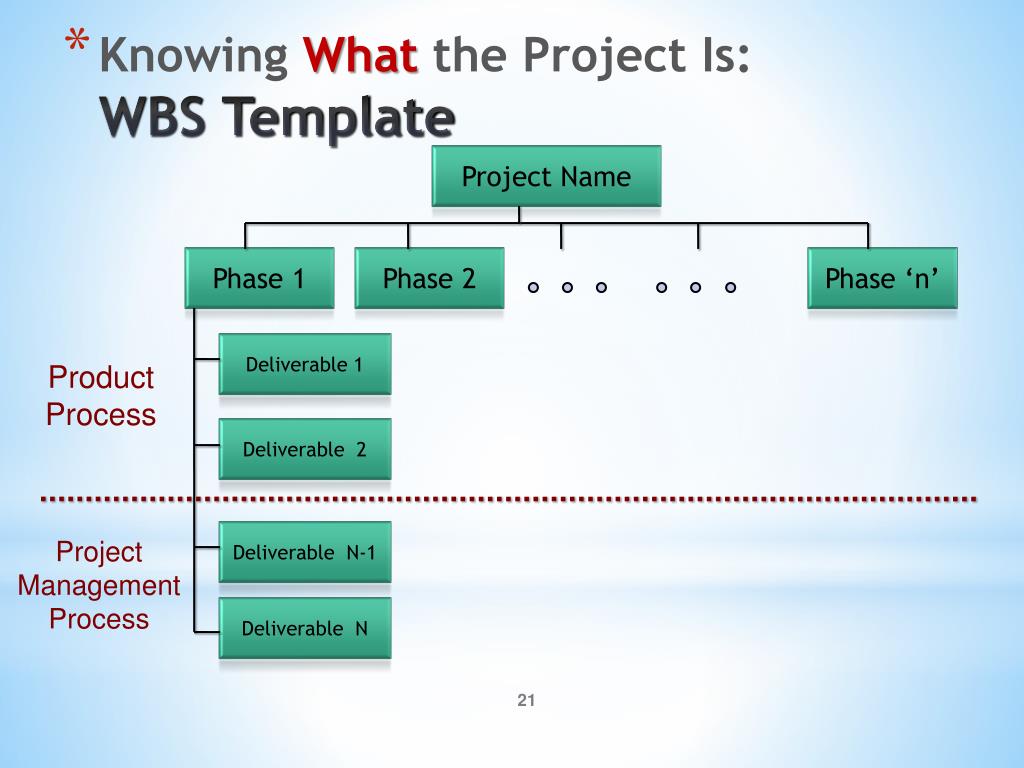

  21. Project Name Phase 1 Phase 2 Phase ‘n’ Deliverable 1 Product Process Deliverable 2 Knowing Whatthe Project Is:WBS Template Project Management Process Deliverable N-1 Deliverable N

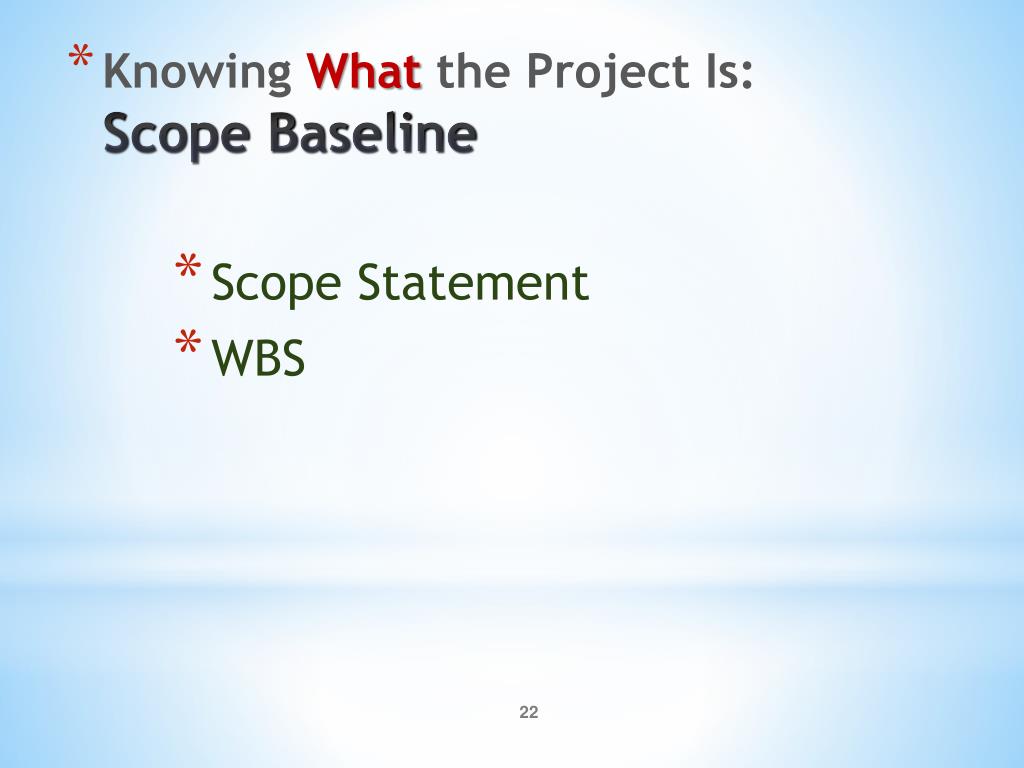

  22. Scope Statement • WBS Knowing Whatthe Project Is: Scope Baseline

  23. May not be fully known at the start of a project • May come from multiple sources / groups • May come at various levels of details • Some stakeholders may not be known initially • May be “wants” and not “needs” • Wants - usually more associated with a solution • Needs - usually more associated with the underlying problem • May conflict with each other • May feed off each other • Usually requires iterations and trade-offs to finalize • May change Knowing Whatthe Project Is:Requirements Challenges

  24. Project Monitoring and Control:Project Flexibility Matrix

  25. Make sure project stakeholders have all been identified • Functional groups that will have a deliverable on the project should be represented on the project team • WBS should represent only the work needed to complete the project successfully • Validate the Scope baseline documents with the project sponsor or approving authority • Process iteration is the norm Knowing Whatthe Project Is:Scope Determination Summary

  26. Construct a life-cycle based WBS for your project • Use a Post-It-Note sheet for each deliverable • Concentrate on product deliverables but add project management process deliverable that have already been discussed in class Team Work(60 minutes)

  27. Objective: Determine the time required to meet the project needs Define the Tasks Comprising the Work Package Estimate the Tasks or Deliverable Resource Sequence the Tasks or / and Deliverables Knowing Whatthe Project Is:Schedule Planning Steps Estimate the Tasks or Deliverable Duration Develop the Schedule

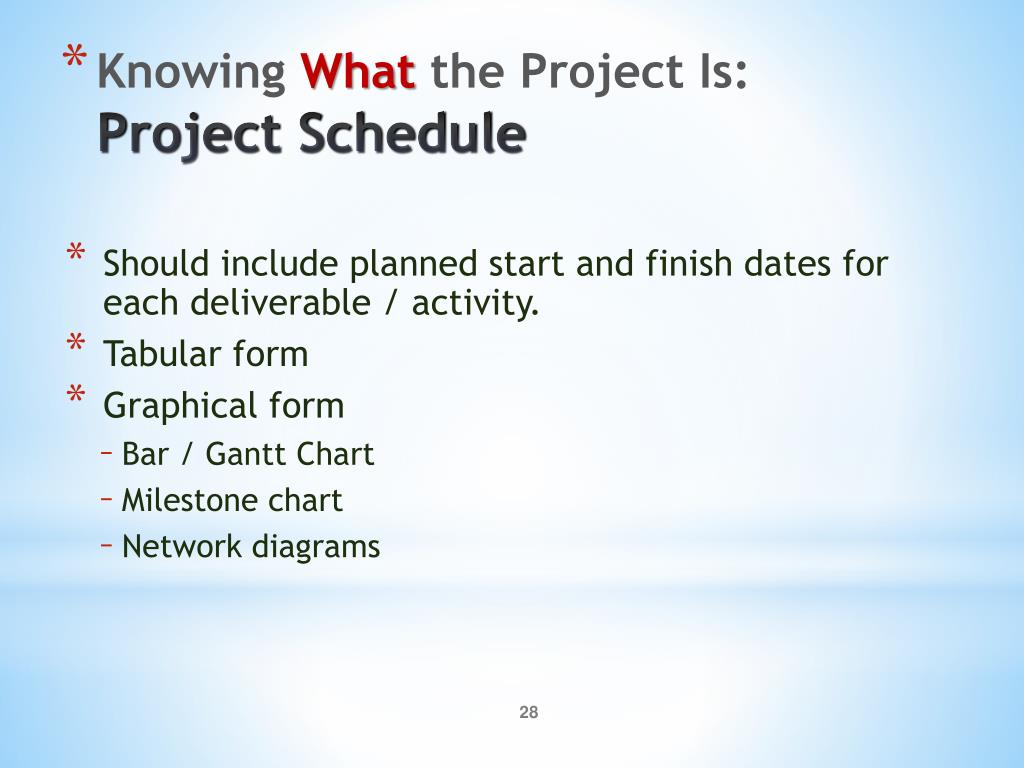

  28. Should include planned start and finish dates for each deliverable / activity. • Tabular form • Graphical form • Bar / Gantt Chart • Milestone chart • Network diagrams Knowing Whatthe Project Is:Project Schedule

  29. Knowing Whatthe Project Is:Bar (Gantt) Charts

  30. Knowing Whatthe Project Is:Milestone Chart

  31. Objective: Identify interdependencies among tasks / deliverables Define the Tasks Comprising the Work Package Estimate the Tasks or Deliverable Resource Sequence the Tasks or / and Deliverables Primary Deliverable: Project Schedule Network Diagram Estimate the Tasks or Deliverable Duration Knowing Whatthe Project Is:Task Sequencing Develop the Schedule

  32. Mandatory – inherent in the nature of the work being done, a.k.a. hard logic • Discretionary – defined by the project team, a.k.a. preferred logic, preferential logic, soft logic • External – involve relationships between project activities and non-project activities Knowing Whatthe Project Is:Activity Dependency

  33. Gantt or bar charts • Milestone charts • Networks (show interdependencies) • Precedence Diagram Method (PDM) • Arrow Diagram Method (ADM) Knowing Whatthe Project Is:Scheduling Techniques

  34. Method of constructing network diagram that uses boxes (nodes) to represent activities and connects them with arrows to show dependencies • a.k.a. Activity On Node (AON) Knowing Whatthe Project Is:Precedence Diagramming Method

  35. FINISH START Eqpt Rcvd Eqpt Inspected FINISH-TO-START START Wall Preparation START-TO-START START Wallpapering Knowing Whatthe Project Is:Precedence Relationships (1 of 2) START Production Burn-In START-TO-FINISH FINISH Operational Acceptance

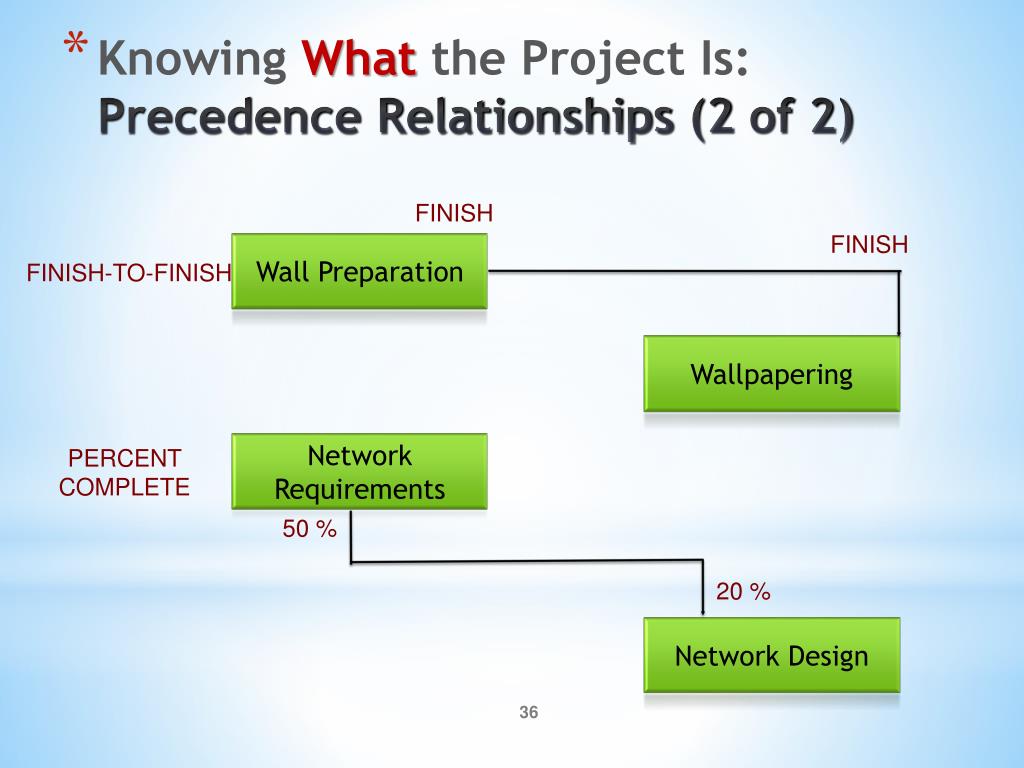

  36. FINISH FINISH Wall Preparation FINISH-TO-FINISH Wallpapering Network Requirements PERCENT COMPLETE Knowing Whatthe Project Is:Precedence Relationships (2 of 2) 50 % 20 % Network Design

  37. EARLY START 01/06/12 TIME DURATION 2 WORK-WEEKS EARLY FINISH 14/06/12 $250,000 ACTIVITY 4 SLACK Knowing Whatthe Project Is:Node Activity Information COST/PROFIT CENTER 2810 LATE FINISH 28/06/12 LATE START 15/06/12

  38. Knowing Whatthe Project Is:Precedence Network

  39. Objective: Estimate the type and quantities of materials, people, equipment or supplies required to complete each task or deliverable Primary Deliverable:Task / deliverable resource requirements Secondary Deliverable:Resource Breakdown Structure Define the Tasks Comprising the Work Package Sequence the Tasks or / and Deliverables Estimate the Tasks or Deliverable Resource Primary Deliverable: Project Schedule Network Diagram Knowing Whatthe Project Is:Resource Estimating Estimate the Tasks or Deliverable Duration Develop the Schedule

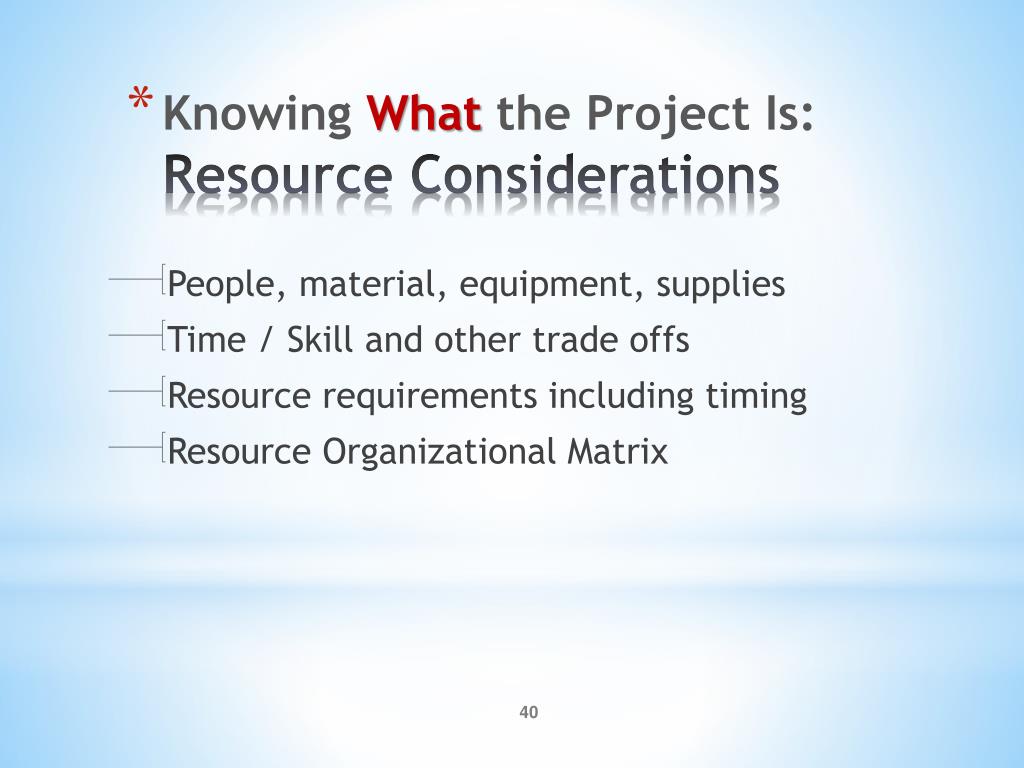

  40. People, material, equipment, supplies • Time / Skill and other trade offs • Resource requirements including timing • Resource Organizational Matrix Knowing Whatthe Project Is:Resource Considerations

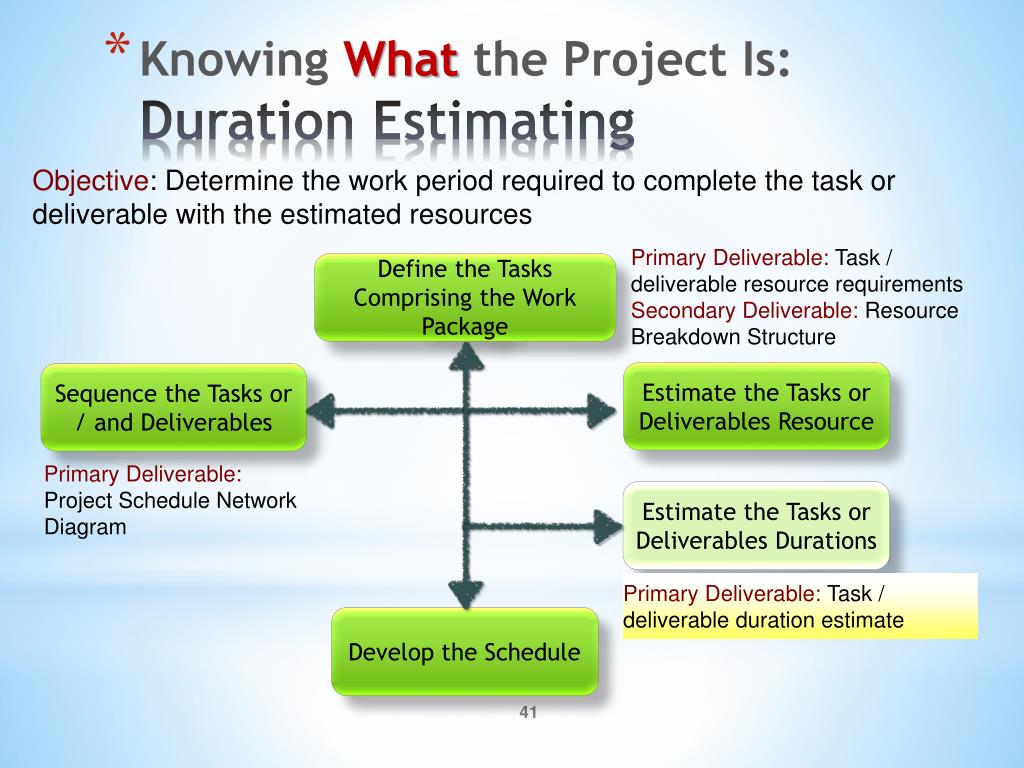

  41. Objective: Determine the work period required to complete the task or deliverable with the estimated resources Primary Deliverable: Task / deliverable resource requirements Secondary Deliverable: Resource Breakdown Structure Define the Tasks Comprising the Work Package Estimate the Tasks or Deliverables Resource Sequence the Tasks or / and Deliverables Primary Deliverable: Project Schedule Network Diagram Estimate the Tasks or Deliverables Durations Knowing Whatthe Project Is:Duration Estimating Primary Deliverable: Task / deliverable duration estimate Develop the Schedule

  42. Expert judgment • Analogous estimating • Parametric estimating • Three-point estimating • Reserve time (contingency) Knowing Whatthe Project Is:Duration Estimating Techniques

  43. Use actual duration of a previous similar activity as basis to estimate duration of the future activity • Approximate (rule of thumb) estimate • Made without any detailed engineering data • A.k.a “Top-down estimating” Knowing Whatthe Project Is:Analogous Estimating

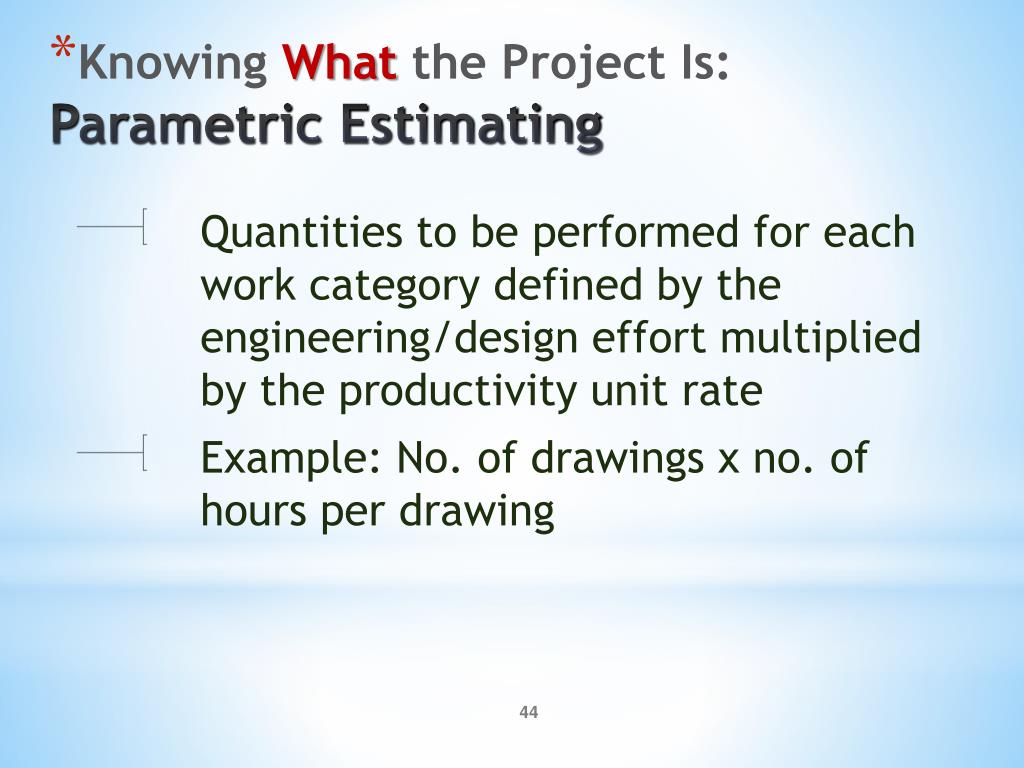

  44. Quantities to be performed for each work category defined by the engineering/design effort multiplied by the productivity unit rate • Example: No. of drawings x no. of hours per drawing Knowing Whatthe Project Is:Parametric Estimating

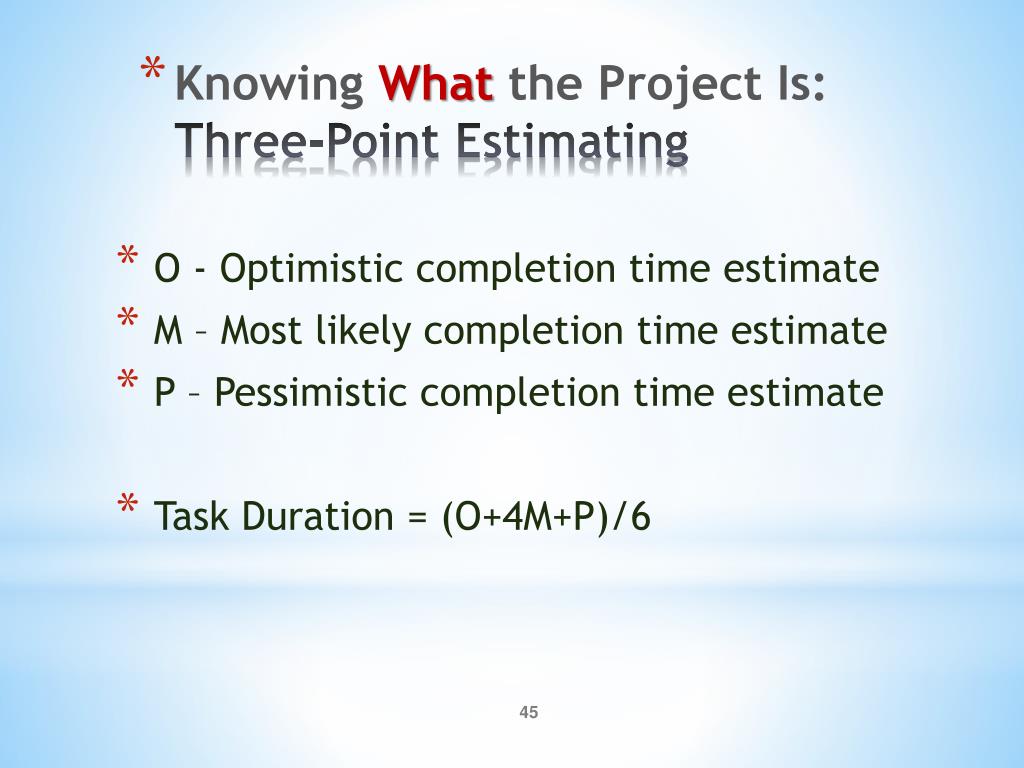

  45. O - Optimistic completion time estimate • M – Most likely completion time estimate • P – Pessimistic completion time estimate • Task Duration = (O+4M+P)/6 Knowing Whatthe Project Is:Three-Point Estimating

  46. Session 3 Agenda

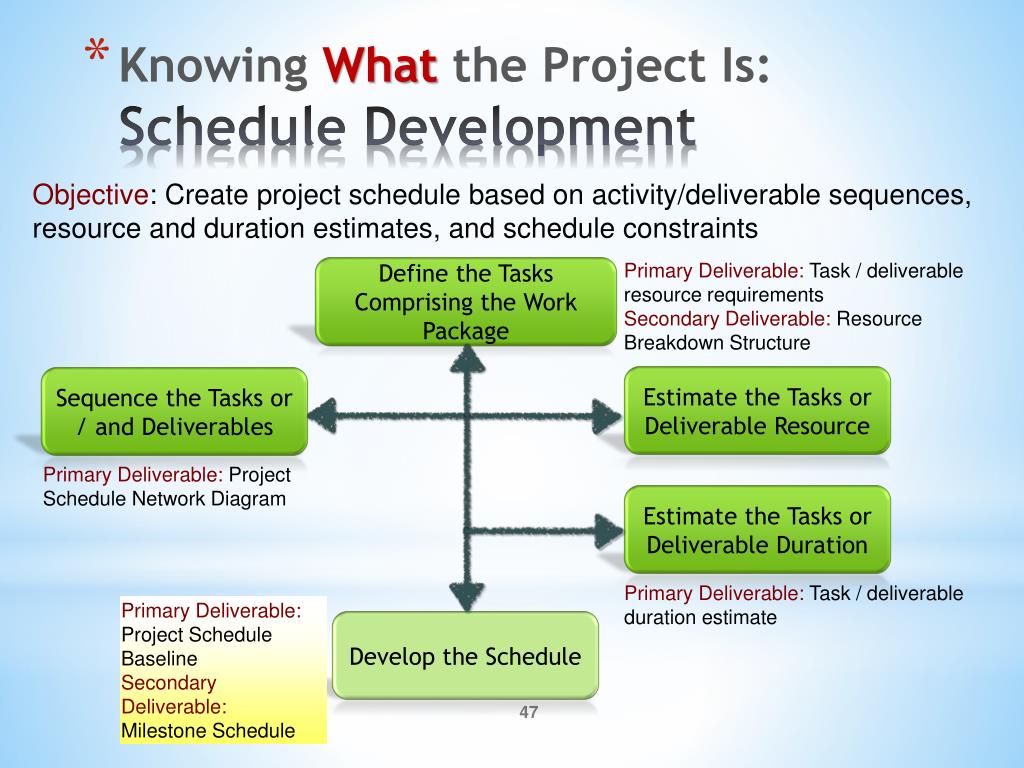

  47. Objective: Create project schedule based on activity/deliverable sequences, resource and duration estimates, and schedule constraints Primary Deliverable: Task / deliverable resource requirements Secondary Deliverable: Resource Breakdown Structure Define the Tasks Comprising the Work Package Estimate the Tasks or Deliverable Resource Sequence the Tasks or / and Deliverables Primary Deliverable: Project Schedule Network Diagram Estimate the Tasks or Deliverable Duration Knowing Whatthe Project Is:Schedule Development Primary Deliverable: Task / deliverable duration estimate Primary Deliverable: Project Schedule Baseline Secondary Deliverable: Milestone Schedule Develop the Schedule

  48. Critical Path • Longest time span through the total system of activities / events • Delay in any activity / task in the critical path delays the whole project • Improvement in total project time means reducing time for activities / events in the critical path • Slack Time (Float) - Time differential between the scheduled completion date and the required date to meet critical path. Knowing Whatthe Project Is:Critical Path and Float

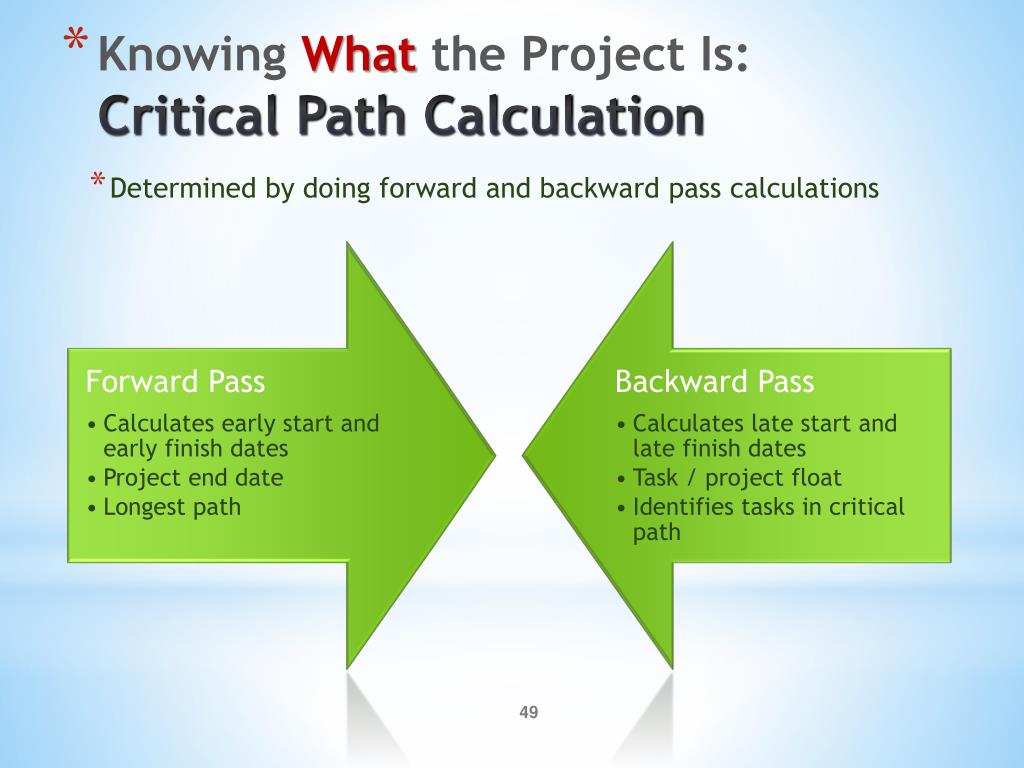

  49. Determined by doing forward and backward pass calculations Knowing Whatthe Project Is:Critical Path Calculation

  50. The first predecessor task(s) have an Early Start (ES) of zero • Early Finish (EF) dates are calculated by adding the task duration (TD) to the earliest date (ES) a task can start • The EF date of the predecessor becomes the ES date for the successor • When there are multiple predecessors, ES is the larger of the EFs for the task Knowing Whatthe Project Is:Forward Pass
