  1. Jpeg decompression algorithm implementation using HLS Final part A presentation Winter 2013-14 Performed by: Dor Kasif, Or FlisherInstructor: Rolf Hilgendorf

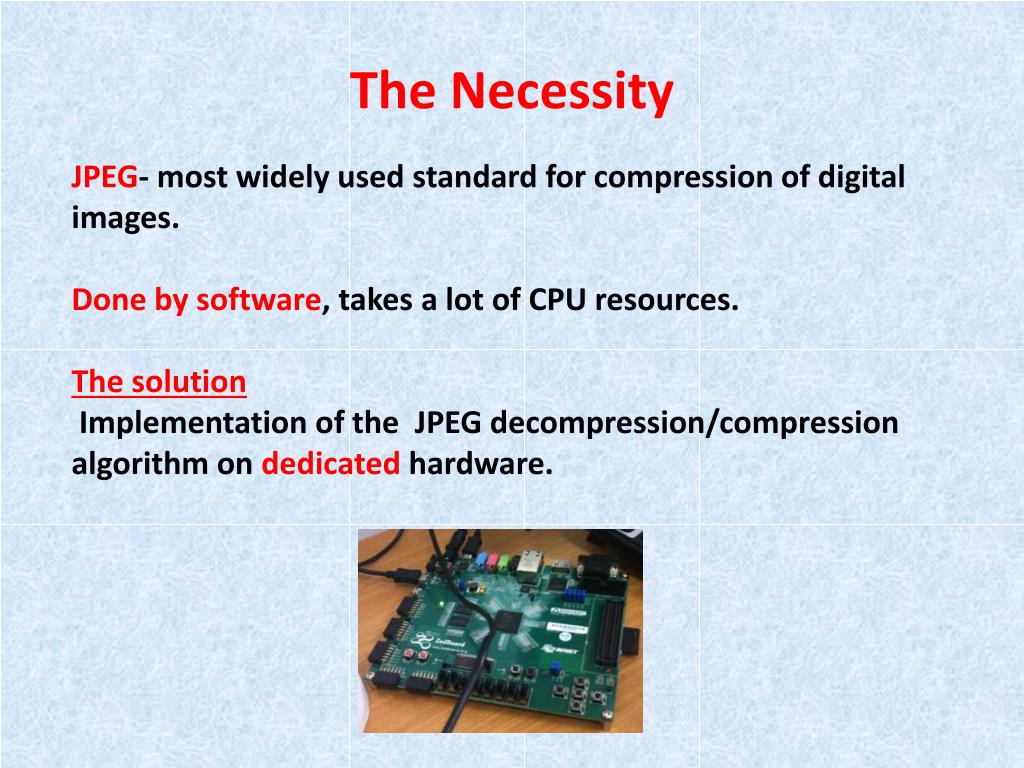

  2. JPEG- most widely used standard for compression of digital images. Done by software, takes a lot of CPU resources. The solution Implementation of the JPEG decompression/compression algorithm on dedicated hardware. The Necessity

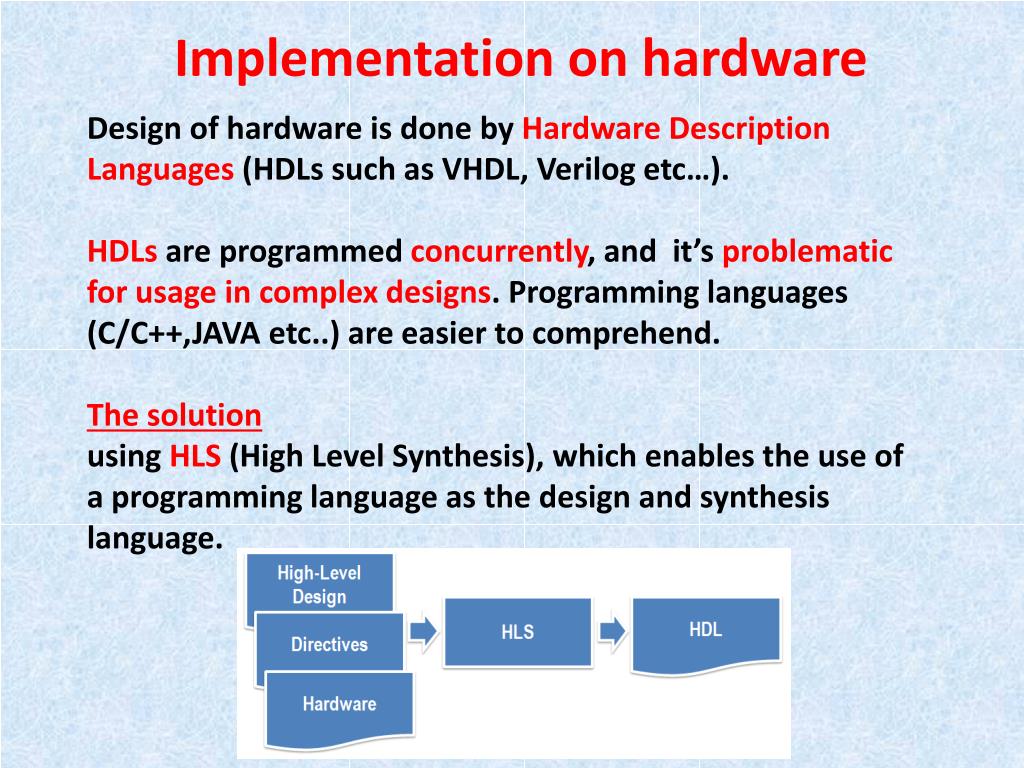

  3. Design of hardware is done by Hardware Description Languages (HDLs such as VHDL, Verilog etc…). HDLs are programmed concurrently, and it’s problematic for usage in complex designs. Programming languages (C/C++,JAVA etc..) are easier to comprehend. The solution using HLS(High Level Synthesis), which enables the use of a programming language as the design and synthesis language. Implementation on hardware

  4. Our objective Developing a JPEG decompressor in a programming language (namely C++), converting it to a Hardware Description Languages(VHDL) Using Vivado HLS, and Implementing it on a FPGA. The decompressed image will then be available for display on screen in RGBformat.

  5. Project Goals • Implementing the Jpeg decompression algorithm on a FPGA Using HLS. • Displaying the decompressed image in a RGBformat on screen. • Optimizing the implementation to reach the optimal performances possible within the performance envelope of the FPGA. • Compare the software decompressed picture to the hardware decompressed picture in terms of Structural Similarity Index Metric (SSIM) .

  6. The VIVADO HLS • Allow us to design hardware using a programing language, which is much more easy to work and design with. • When using a programing language which is inherently serial in nature to design hardware which is inherently concurrent, we can’t use the already well known programming paradigms, so we will need to combine several disciplines. • Those modifications include replacing non synthesizable commands and changes to reduce usage of system resources and optimizing overall system performance.

  7. The VIVADO HLS types • In software, there are numerous types for a Variable : Integer,Char,Float, etc. • A major disadvantage is being unable to access parts of the variable, like bits. Bitwise operations are enabled with programming language but not on a scope appropriate to hardware design. Moreover when designing hardware, system resources are valuable (i.e. board area, wiring etc.) so for some variable representations we’ll need to control the amount of memory allocated for the variable. • The VIVADO HLS presents new types: ap_int<>,ap_uint<>,ap_fixed<><> etc. • Those new types Not only allow us to determine the memory used but also grants us access to every part of the memory itself and in every scope desired (such as a single bit). • For example: a Variable with only two options: “0” (“no”) and “1” (“yes”). • In C/C++: we can use Char , which takes a byte (8 bits) of memory. • In VIVADO HLS : ap_uint<1> - takes 1 bit of memory.

  8. The VIVADO HLS functions • with The VIVADO HLS types we can use some new and helpful functions: • For example we used: • Variable.range- access to certain bits of the Variable • Variable.set-set a certain bit of the Variable to the value “1”.

  9. Our progress

  10. Progress until midterm presentation • Acquired a C++ encoding/decoding algorithm and modified it for our needs-removing the use of non-standard libraries, removing user interface , adjusting the algorithm to process a single color channeletc. • Developing auxiliary Matlabscripts for handling the images and SSIM computation.

  11. Progress until midterm presentation • Modified the decoding algorithm for synthesis in HLS. • Eliminating the use of Cosine functions in the decoding process. • Adjusting the decoder and test-bench for 8x8 blocks + handshake protocol. • Replacing the use of C++ floating point types with VIVADO HLS fixed point types .

  12. Progress since midterm presentation • Making the algorithm usable for the standard RGB color channel. • optimizing the hardware implementation using code optimizations and directives. • Simulating the synthesis in VHDL, thus getting a time assessment and identified the system’s bottle necks.

  13. Implementing the encoding/decoding process

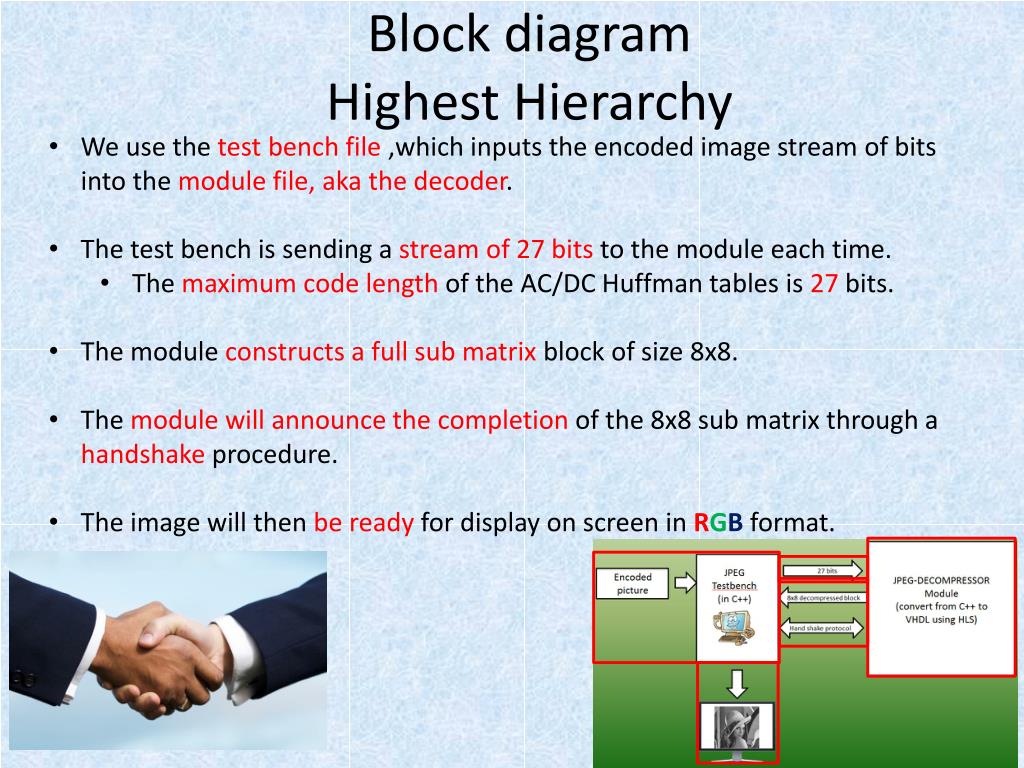

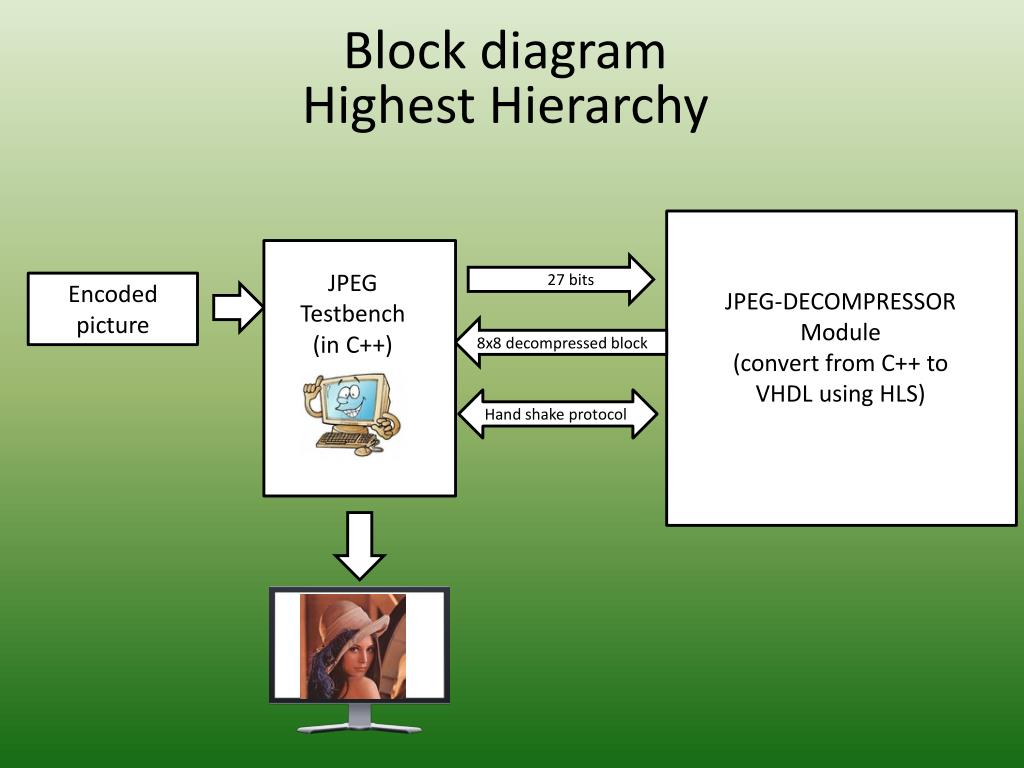

  14. Block diagramHighest Hierarchy 27 bits Encoded picture JPEG Testbench (in C++) JPEG-DECOMPRESSOR Module (convert from C++ to VHDL using HLS) 8x8 decompressed block Hand shake protocol

  15. Block diagramHighest Hierarchy • We use the test bench file ,which inputs the encoded image stream of bits into the module file, aka the decoder. • The test bench is sending a stream of 27 bits to the module each time. • The maximum code length of the AC/DC Huffman tables is 27 bits. • The module constructs a full sub matrix block of size 8x8. • The module will announce the completion of the 8x8 sub matrix through a handshake procedure. • The image will then be ready for display on screen in RGBformat.

  16. Lets See What's Under The Hood

  17. Block diagram module Huffmandecoding Building the sub matrix DE quantization 27 bits Zig Zag Inverse DCT and adding value of 128 to the block 8x8 decompressed block Hand shake protocol The module will do this operation for all (640X480)/(8X8)=4800 blocks

  18. Encountered Problems and SolutionsBefore Midterm • 1. The acquired decompression algorithm wasn't synthesizable. • Solution: Modifying the decoding algorithm for synthesis and adjusting it for 8x8 blocks + handshake protocol. • 2. Problems with HLS handling a matrix of Char pointers (Strings). • Solution: adding a binary-to-integer converter for bit by bit comparison. • 3. Use of Trigonometricfunctions • Solution: Replacing the use of Trigonometric functions with constant variables (pre calculated matrices). • 4. problems with HLS handling C++ float point type and the multiplication of them. • Solution: replacing the use of C++ fixed point types with VIVADO HLS fixed point types.

  19. Block diagram Building the sub matrix module Building the sub matrix Huffmandecoding DE quantization Zig Zag 27 bits Inverse DCT and adding value of 128 to the block 8x8 decompressed block Hand shake protocol

  20. Block diagram Building the sub matrix Hand shake protocol Buffer has less then 27 bits Buffer (3*27bit size) For DC coeff For AC coeff getDCvalue Char to int getACvalue the complete matrix sub matrix buffer

  21. code Improvements • Eliminating the dependency on the binary to integer converter. • The VIVADO HLS types, unlike the standard C/C++ types, allows us access to the bits in the memory itself. • Using the range function, we can compare bit-by-bit between • the buffer and the members of the AC/DC Huffman tables • without the need of converting the buffer into an integer! • Improvement in both area and performance (no need for the converter module) .

  22. Block diagram Building the sub matrix Hand shake protocol Buffer has less then 27 bits Buffer (3*27bit size) For DC coeff For AC coeff getDCvalue Char to int getACvalue the complete matrix sub matrix buffer

  23. Block diagram Building the sub matrix • The input will be inserted into a buffer. • For the matrix DC coefficient, the input will be inserted to the “getDCvalue” in order to find the DC coefficient. • The same for the AC coefficients and “getACvalue”. • The coefficients will be stored inside another buffer. • When there are less then 27 bits inside the buffer, the handshake protocol will be activated and the module will ask for another input. • When the matrix is complete, the processed image will continue into the Huffmandecoding stage.

  24. Block diagram module Building the sub matrix Huffmandecoding DE quantization 27 bits Zig Zag Inverse DCT and adding value of 128 to the block 8x8 decompressed block Hand shake protocol The module will do this operation for all (640X480)/(8X8)=4800 blocks

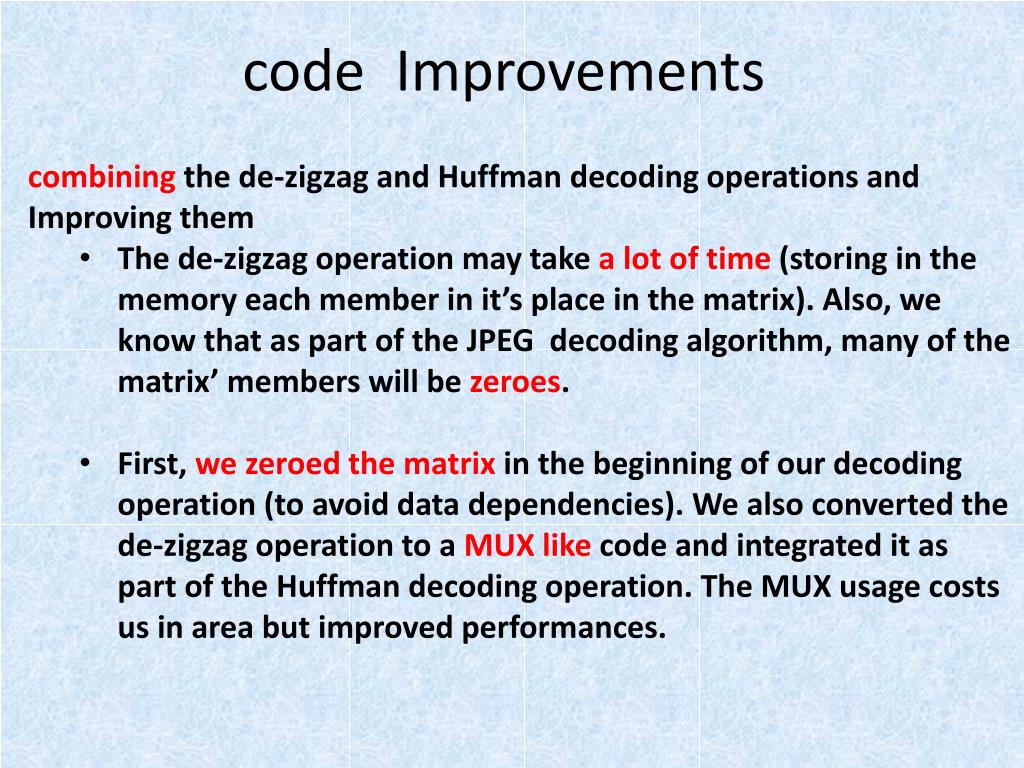

  25. code Improvements • combining the de-zigzag and Huffman decoding operations and Improving them • The de-zigzag operation may take a lot of time (storing in the memory each member in it’s place in the matrix). Also, we know that as part of the JPEG decoding algorithm, many of the matrix’ members will be zeroes. • First, we zeroed the matrix in the beginning of our decoding operation (to avoid data dependencies). We also converted the de-zigzag operation to a MUX like code and integrated it as part of the Huffman decoding operation. The MUX usage costs us in area but improved performances.

  26. Block diagram module Building the sub matrix Huffmandecoding DE quantization Huffmandecoding and de-zigzag Zig Zag 27 bits Inverse DCT and adding value of 128 to the block 8x8 decompressed block Hand shake protocol The module will do this operation for all (640X480)/(8X8)=4800 blocks

  27. Block diagram module • The module will then perform on the sub matrix: • Decoding of the compressed image using Huffman and Differential decoding andDe-Zig Zag operation • De quantization • Inverse DCT and Adding 128 to the image bit map • The module sends back the sub matrix block to the test bench where the test bench will assemble the reconstructed image.

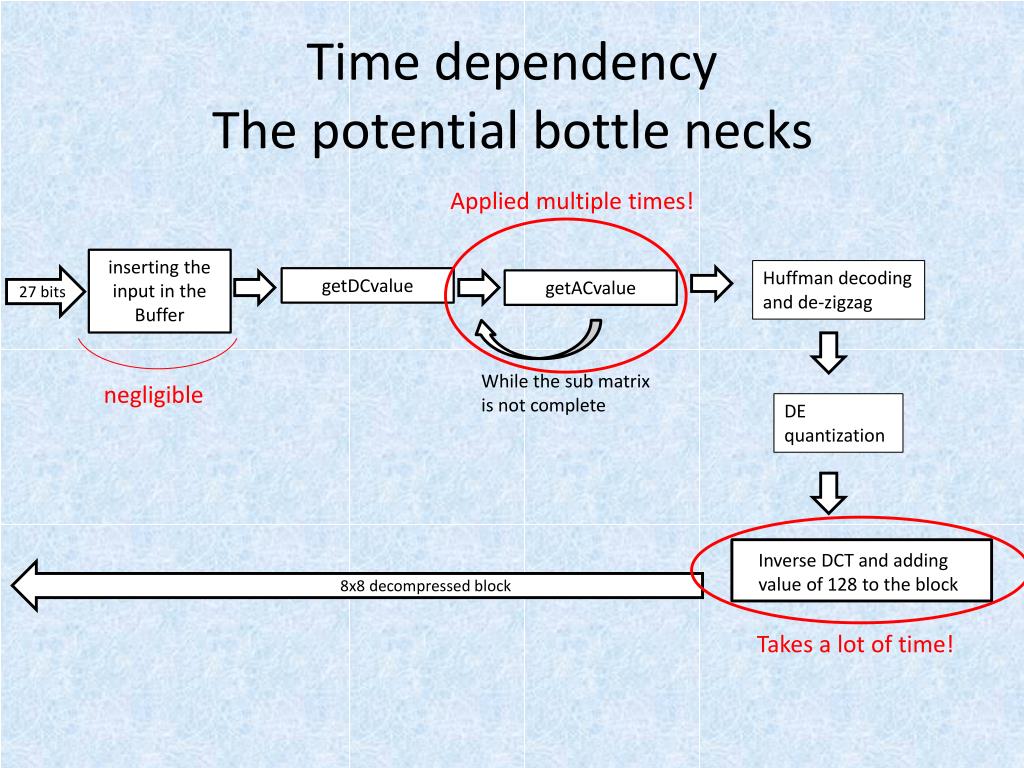

  28. Time dependencyThe potential bottle necks Applied multiple times! inserting the input in the Buffer Huffmandecoding and de-zigzag getDCvalue getACvalue 27 bits Inverse DCT and adding value of 128 to the block While the sub matrix is not complete negligible 8x8 decompressed block DE quantization Takes a lot of time!

  29. Improvements

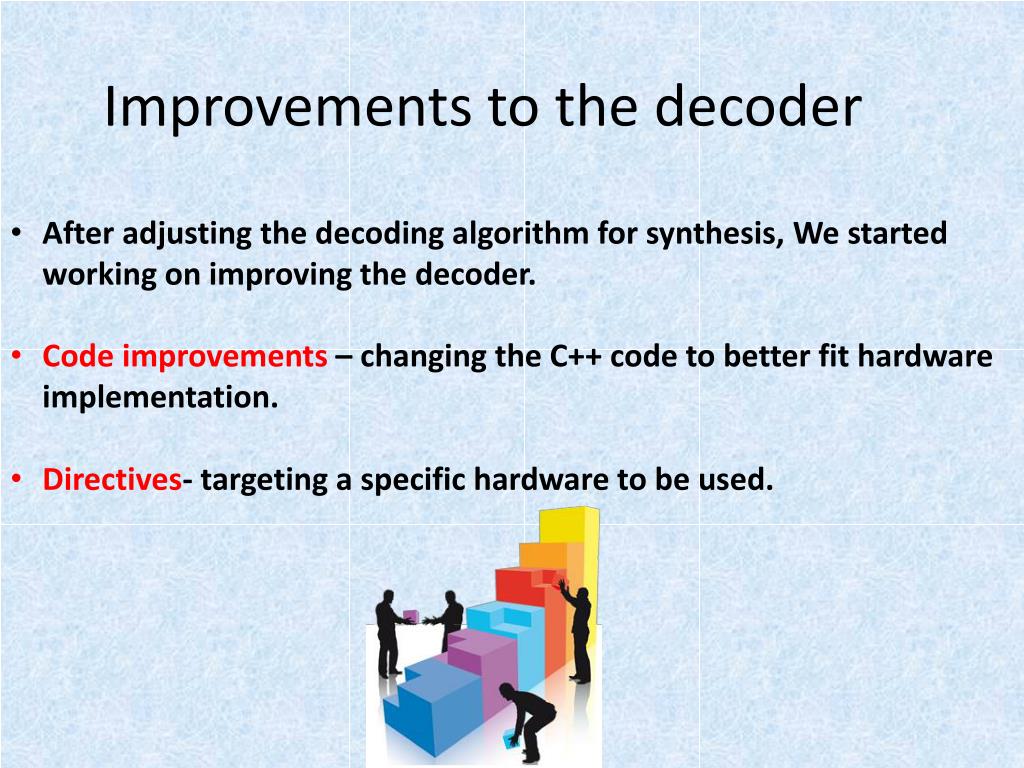

  30. Improvements to the decoder • After adjusting the decoding algorithm for synthesis, We started working on improving the decoder. • Code improvements – changing the C++ code to better fit hardware implementation. • Directives- targeting a specific hardware to be used.

  31. VIVADO HLS Directives • In VIVADO HLS, when synthesizing a module, the VIVADO tries to create the best hardware it can in terms of speed and resources utilization, But it has some limitations. • At first, improvements and changes must be applied to the C++ code to better fit hardware implementation. This method is also limited as it doesn’t allow us to decide the specific hardware to be used. • Using the directives, we are allowed to influence the hardware generating process and improve it even more, by targeting a certain resource to be used and adding hardware for improvements in terms of speed.

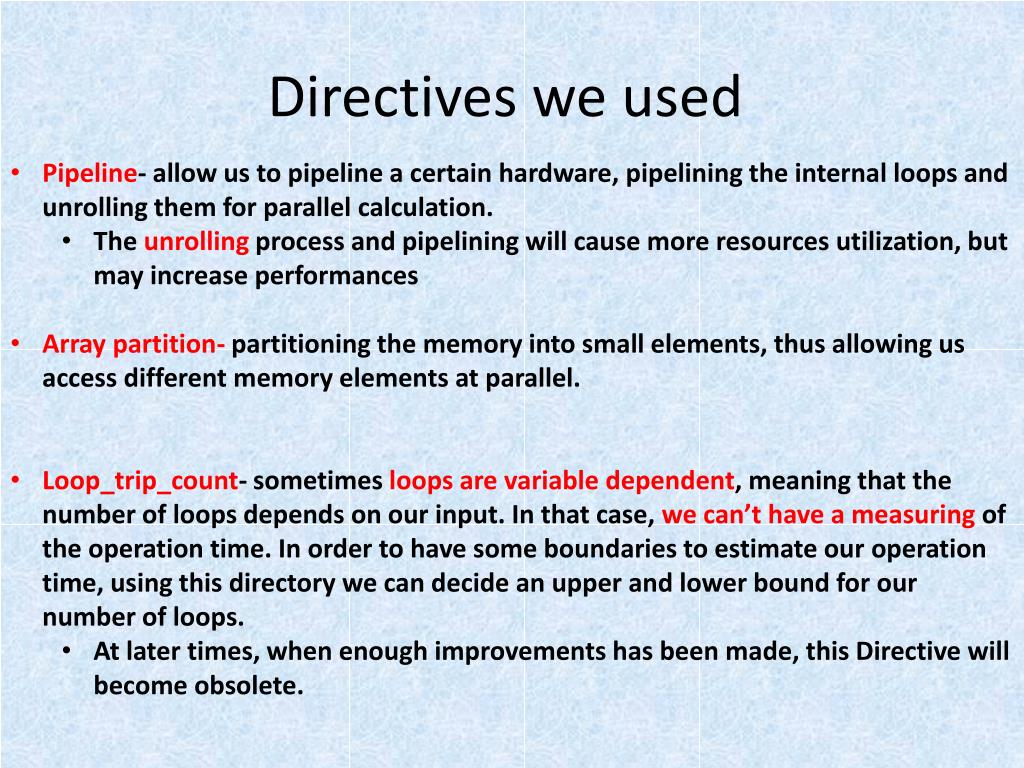

  32. Directives we used • Pipeline- allow us to pipeline a certain hardware, pipelining the internal loops and unrolling them for parallel calculation. • The unrolling process and pipelining will cause more resources utilization, but may increase performances • Array partition-partitioning the memory into small elements, thus allowing us access different memory elements at parallel. • Loop_trip_count- sometimes loops are variable dependent, meaning that the number of loops depends on our input. In that case, we can’t have a measuring of the operation time. In order to have some boundaries to estimate our operation time, using this directory we can decide an upper and lower bound for our number of loops. • At later times, when enough improvements has been made, this Directive will become obsolete.

  33. code Improvements • Limiting memory area • By using VIVADO HLS types, we are able to restrict the memory area each variable takes, thus reducing area utilization.

  34. Time dependencyThe potential bottle necks Applied multiple times! inserting the input in the Buffer Huffmandecoding and de-zigzag getDCvalue getACvalue 27 bits Inverse DCT and adding value of 128 to the block While the sub matrix is not complete negligible 8x8 decompressed block DE quantization Takes a lot of time!

  35. code Improvements Input_to_buffer and shift_bit • Replacing the functions handling the buffer to VIVADO HLS functions • In the past, in order to handle the bits stored in the buffer (inserting the input or shifting them) we applied a FIFO like algorithm, inserting or shifting the input bit by bit- takes time and resources. • Using the VIVADO HLS function range, we are able to replace this algorithm with a simple parallel insertion, greatly improving our time and resource .

  36. code Improvements getDCvalue and getACvalue • Improving the exponentiation function. • In our code, there are several places where we need to calculate 2^i where i is the order of the digit, but the exponentiation function isn’t synthesizable. • At first, we calculated it using a loop: for(j=0;j<i;j++) p=2*p; • -Took time (about iclock cycles) and hardware. • In binary, the number calculated by 2^i is a zeroed number with a “1” in the i-th bit • For example: 2^2=100, 2^4=10000… • we can use the set function to set the i-th bit of a zeroed variable to “1”–almost no hardware and a lot less time (1 clock cycle).

  37. Directive improvements getDCvalue and getACvalue • Pipelining the getACvalue and getDCvalue functions • In a single module operation, the getACvalue function is invoked multiple times until all of the sub matrix AC coefficient are recovered- a potential bottle neck. • In order to accelerate the getACvalue function, we used the pipeline directive. • using the pipeline also forced the function to unroll it’s loops, so it compares the input to the different members of the AC/DC Huffman tables simultaneously, thus greatly accelerating the getACvaluefunction. • We used the same method on the getDCvalue(also part of our bottle neck).

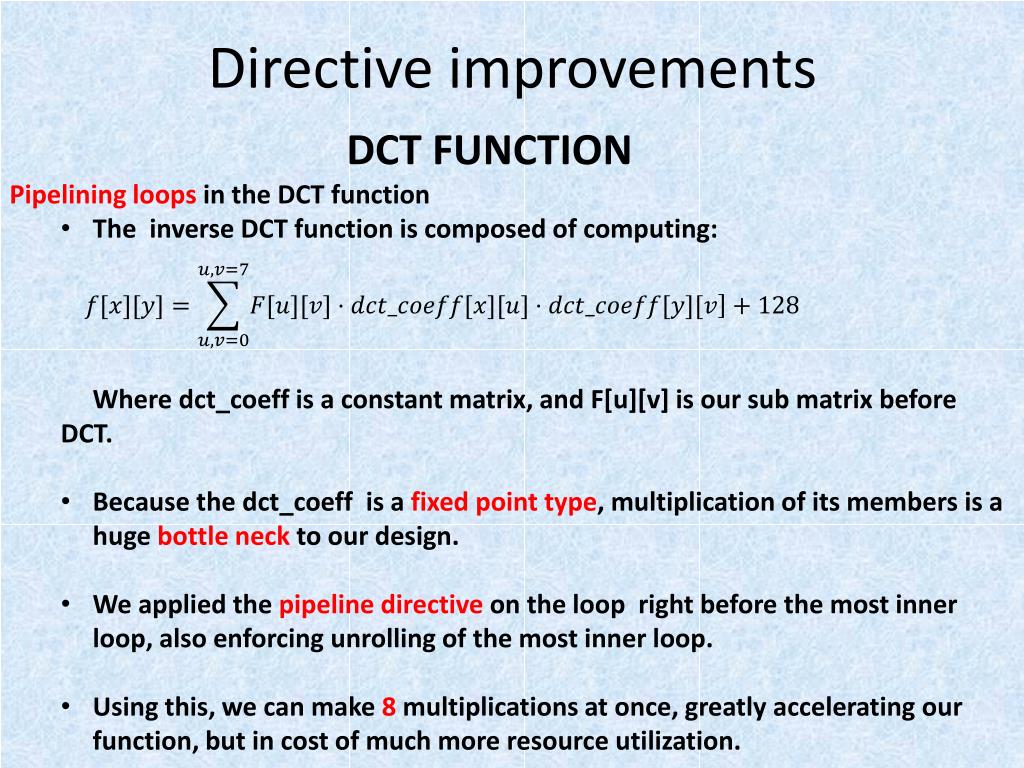

  38. Directive improvements DCT FUNCTION • Pipelining loops in the DCT function • The inverse DCT function is composed of computing: • Where dct_coeff is a constant matrix, and F[u][v] is our sub matrix before DCT. • Because the dct_coeff is a fixed point type, multiplication of its members is a huge bottle neck to our design. • We applied the pipeline directive on the loop right before the most inner loop, also enforcing unrolling of the most inner loop. • Using this, we can make 8 multiplications at once, greatly accelerating our function, but in cost of much more resource utilization.

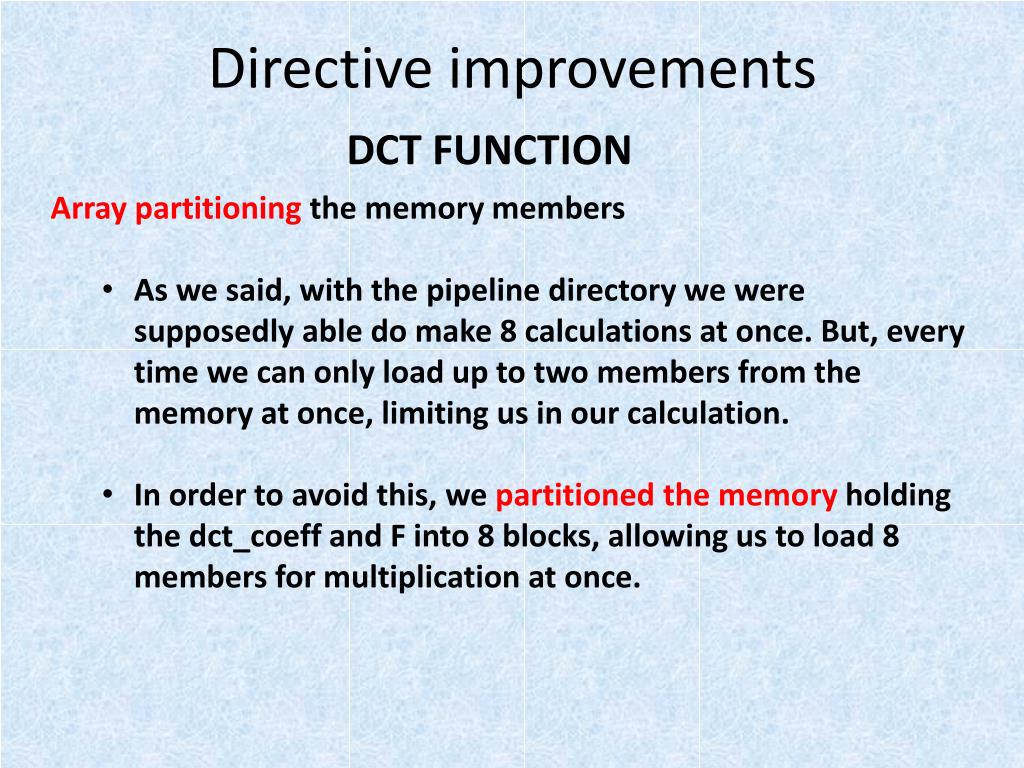

  39. Directive improvements DCT FUNCTION • Array partitioning the memory members • As we said, with the pipeline directory we were supposedly able do make 8 calculations at once. But, every time we can only load up to two members from the memory at once, limiting us in our calculation. • In order to avoid this, we partitioned the memory holding the dct_coeff and F into 8 blocks, allowing us to load 8 members for multiplication at once.

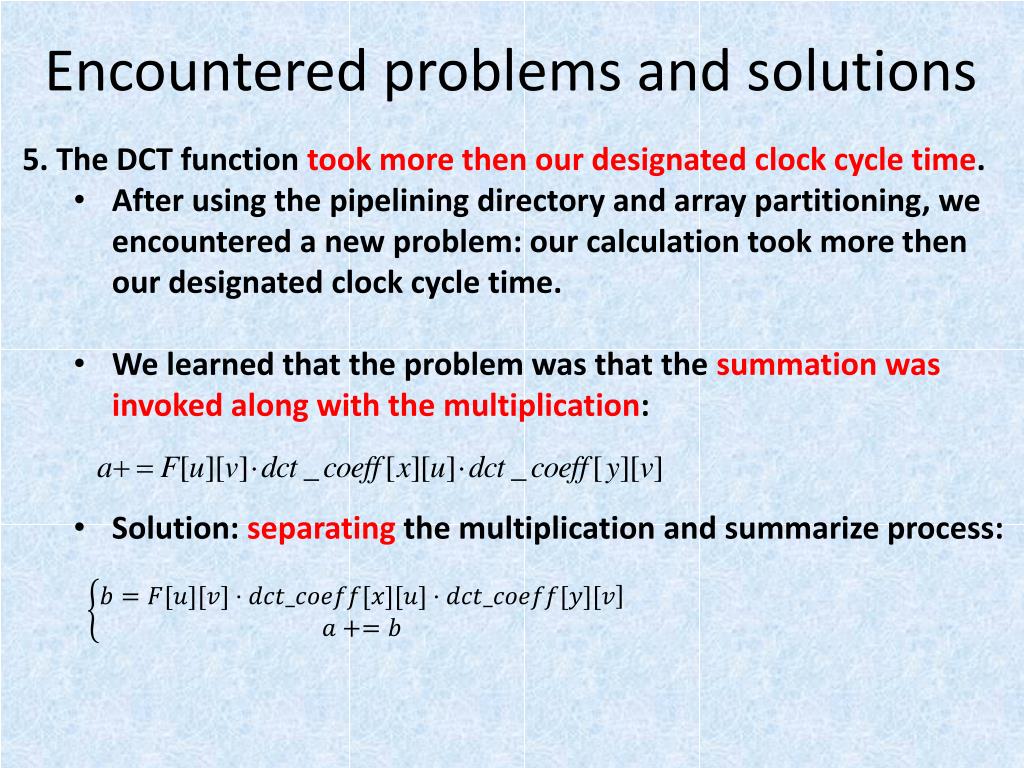

  40. Encountered problems and solutions • 5.The DCT function took more then our designated clock cycle time. • After using the pipelining directory and array partitioning, we encountered a new problem: our calculation took more then our designated clock cycle time. • We learned that the problem was that the summation was invoked along with the multiplication: • Solution: separating the multiplication and summarize process:

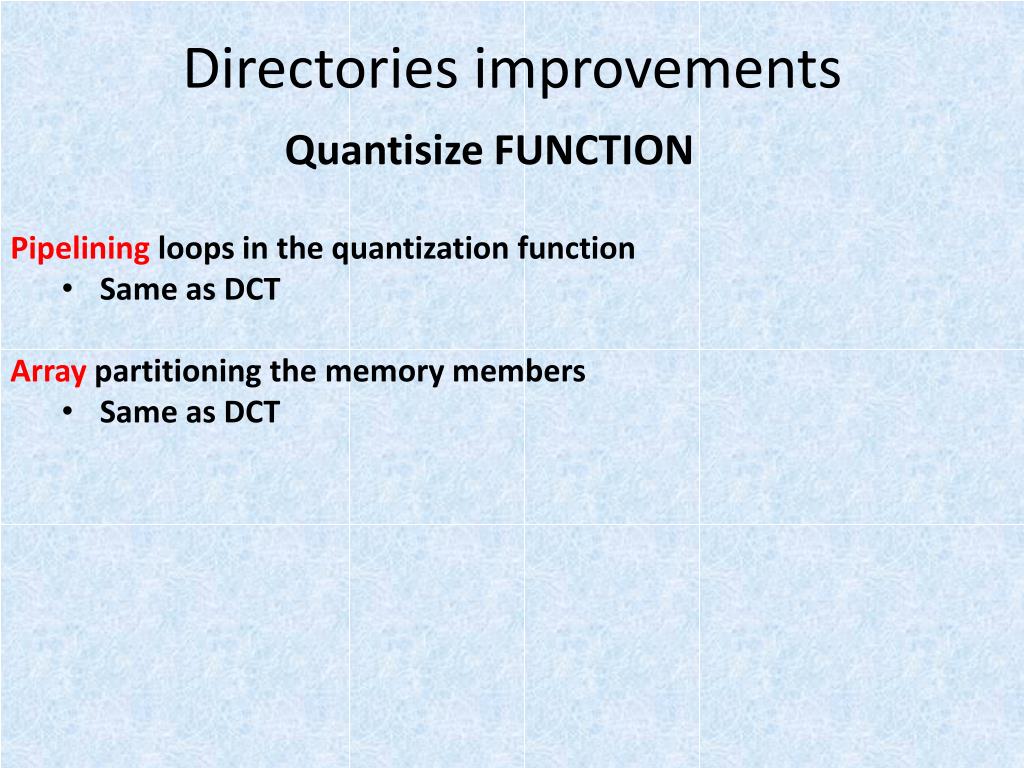

  41. Directories improvements Quantisize FUNCTION • Pipelining loops in the quantization function • Same as DCT • Array partitioning the memory members • Same as DCT

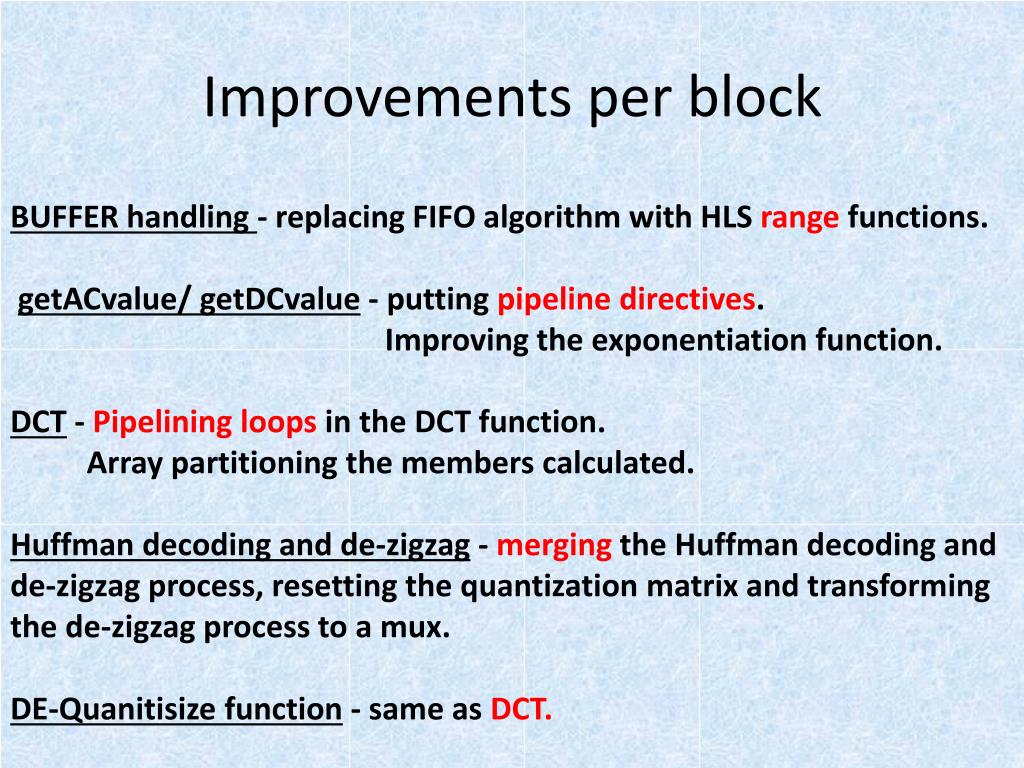

  42. Improvements per block BUFFER handling - replacing FIFO algorithm with HLS range functions. getACvalue/getDCvalue - putting pipeline directives. Improving the exponentiation function. DCT - Pipelining loops in the DCT function. Array partitioning the members calculated. Huffman decoding and de-zigzag - merging the Huffman decoding and de-zigzag process, resetting the quantization matrix and transforming the de-zigzag process to a mux. DE-Quanitisize function - same as DCT.

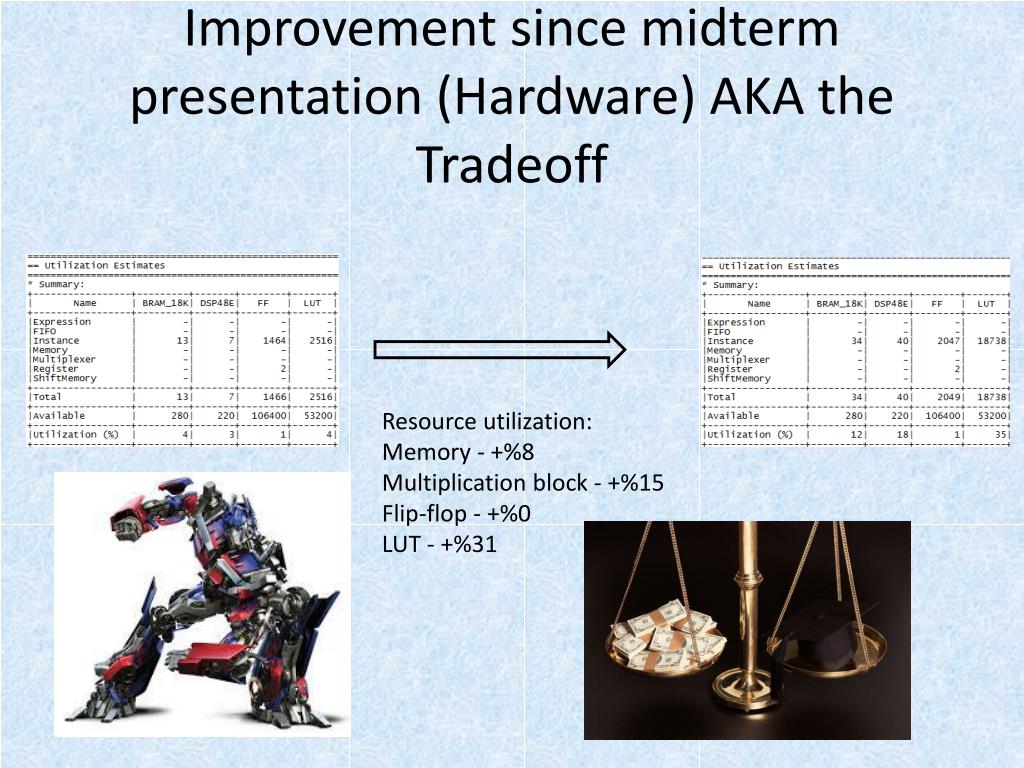

  43. Improvement since midterm presentation (Hardware) AKA the Tradeoff Resource utilization: Memory - +%8 Multiplication block - +%15 Flip-flop - +%0 LUT - +%31

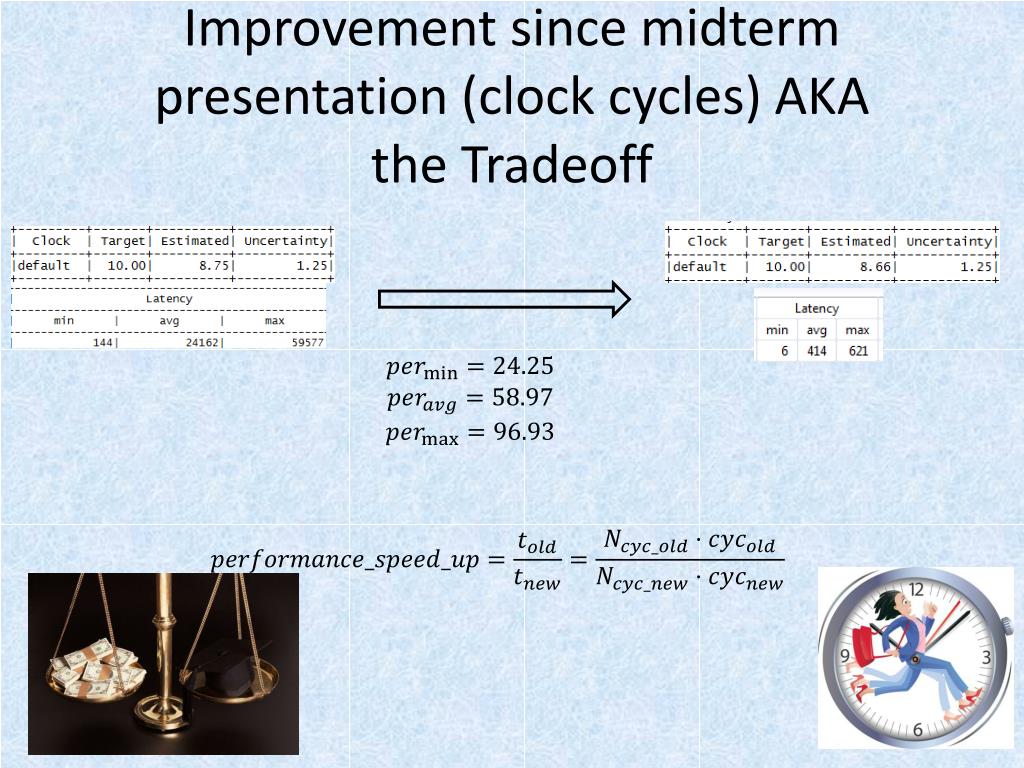

  44. Improvement since midterm presentation (clock cycles) AKAthe Tradeoff

  45. Future planning • Integrating the module into the VIVADO environment. • Upload the image to the memory from an external device. • Integrating the module with other modules that allow us to display the image on screen using VIVADO environment. • Examining the possibility of parallel operations.

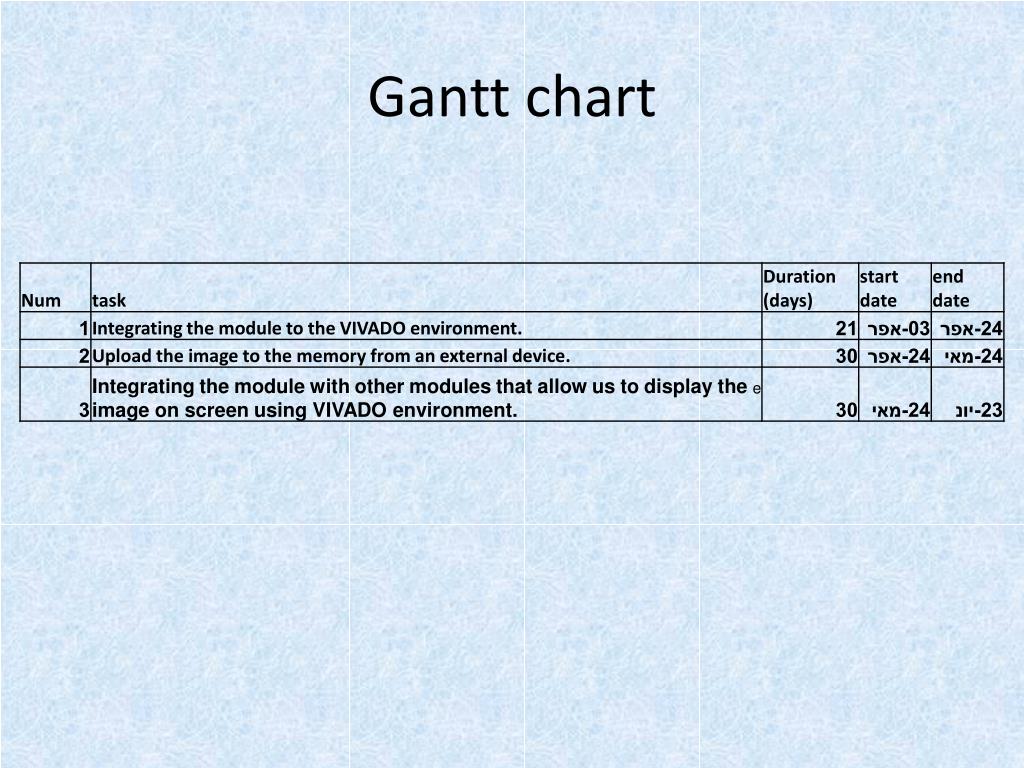

  46. Gantt chart

  47. Gantt chart 23.6.2014 Final B presentation

  48. Resources http://www.cs.northwestern.edu/~agupta/_projects/image_processing/web/JPEGEncoding/report.html -source for the encoding/decoding code http://en.wikipedia.org/wiki/JPEG -jpeg Wikipedia entry http://sipl.technion.ac.il/ -the technion signal and image processing lab-experiment 3 www.stanford.edu/class/ee398a/handouts/lectures/08-JPEG.pdf -Stanford university , department of electrical engineering explanation of the Jpeg format. Essay- The JPEG Still Picture Compression Standard-by Gregory K.Wallace and co. -explanation of the Jpeg format. https://ece.uwaterloo.ca/~z70wang/research/ssim/ Howard Hughes Medical Institute, and Laboratory,. By Z. Wang, A. C. Bovik, H. R. Sheikh,andE. P. Simoncelli -Matlabscript for SSIM computation. Essay-Image Quality Assessment Techniques pn Spatial Domain-by C.Sasivarnan and co.
