An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Preparation of KIPT (Kharkov) computing facilities for CMS data analysis L. Levchuk Kharkov Institute of Physics and Technology (KIPT), Kharkov, Ukraine

  2. WLCG infrastructure of the CMS experiment (CMS computing model) • KIPT T2 center (T2_UA_KIPT): status and prospects • Summary L.Levchuk, NEC'09, Varna, Bulgaria

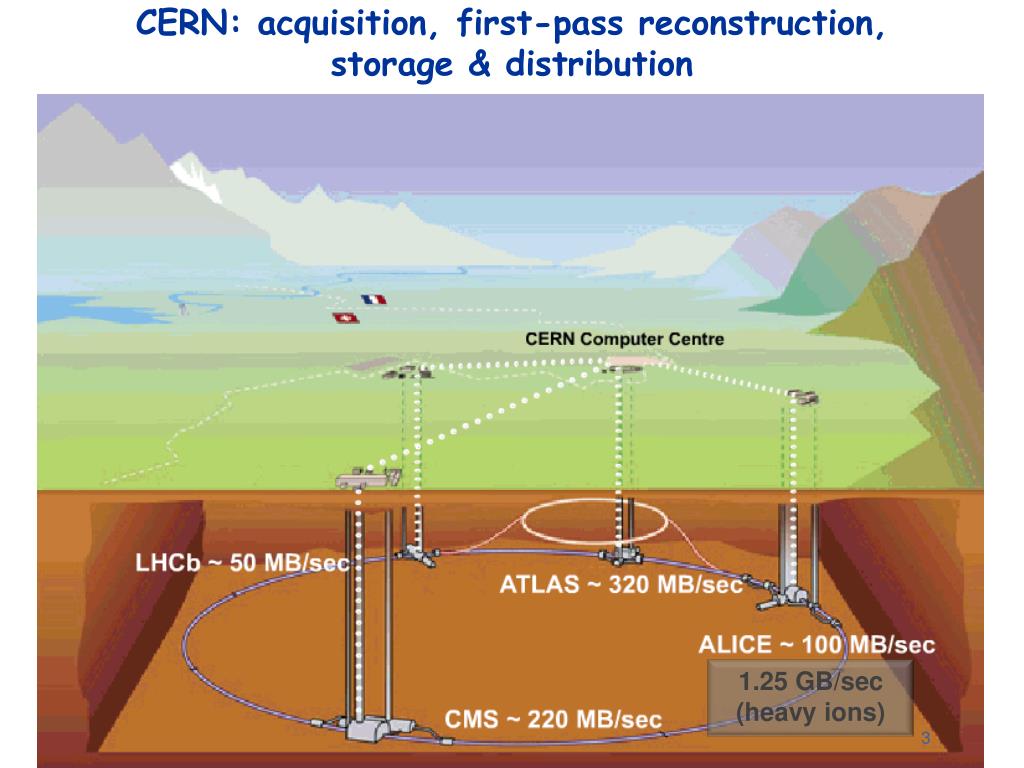

  3. CERN: acquisition, first-pass reconstruction, storage & distribution 1.25 GB/sec (heavy ions) L.Levchuk, NEC'09, Varna, Bulgaria 3 Ian.Bird@cern.ch

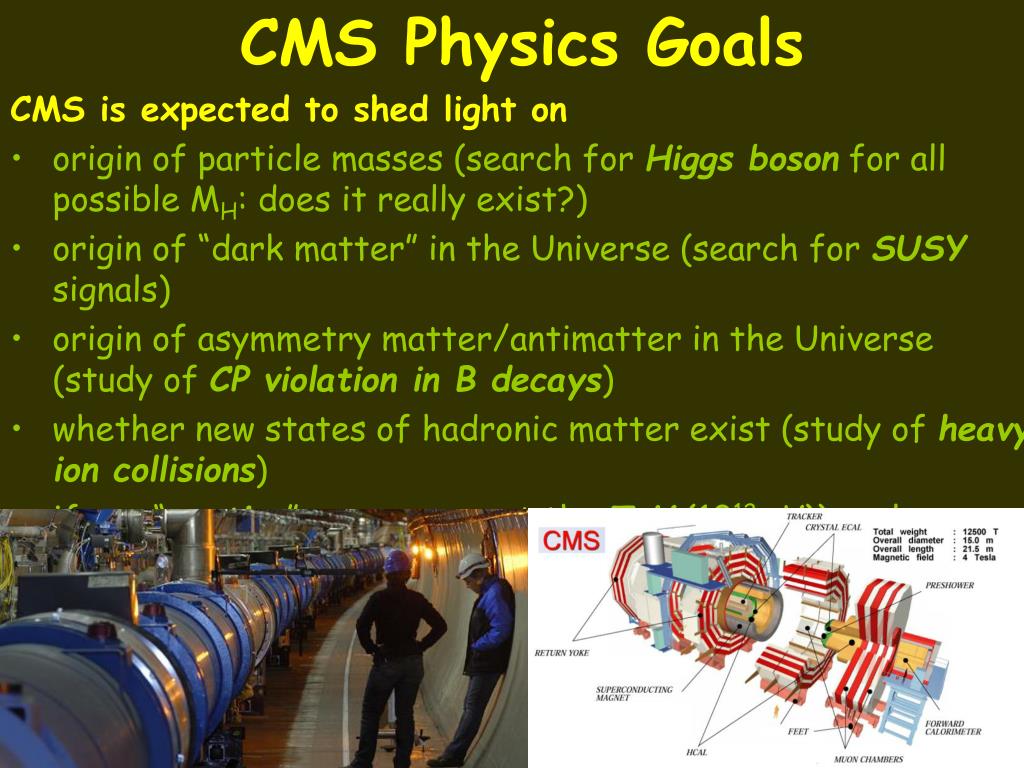

  4. CMS Physics Goals CMS is expected to shed light on • origin of particle masses (search for Higgs boson for all possible MH: does it really exist?) • origin of “dark matter” in the Universe (search for SUSY signals) • origin of asymmetry matter/antimatter in the Universe (study of CP violation in B decays) • whether new states of hadronic matter exist (study of heavy ion collisions) • if any “exotica” can emerge at the TeV (1012 eV)) scale L.Levchuk, NEC'09, Varna, Bulgaria

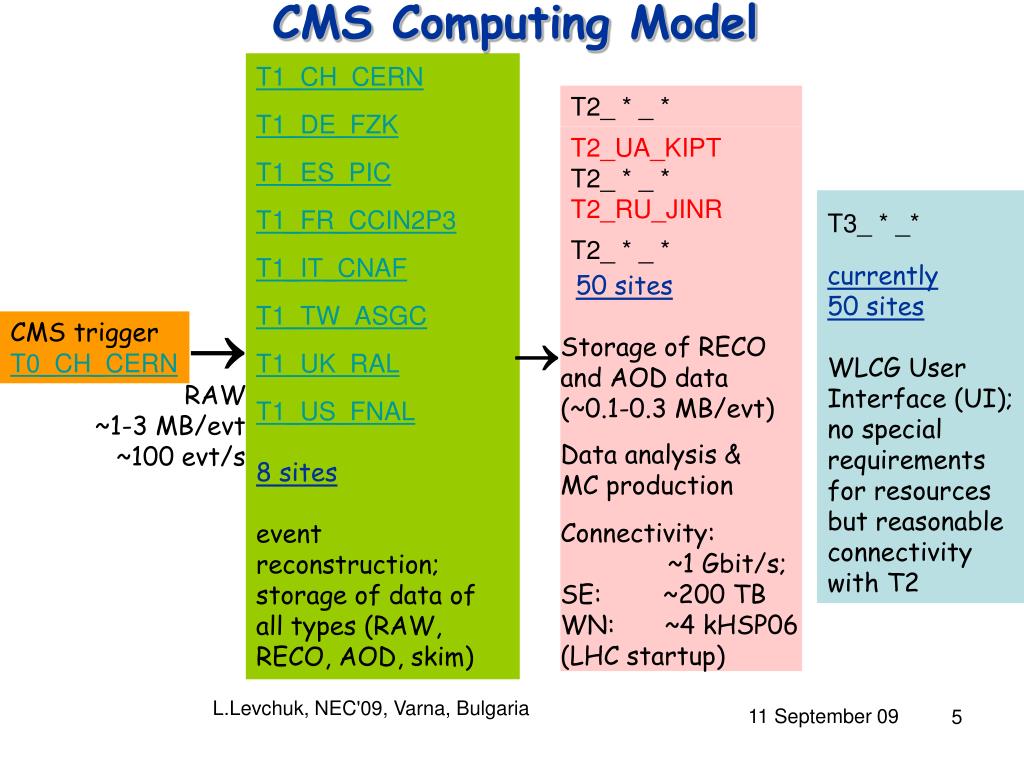

  5. CMS Computing Model CMS trigger T0_CH_CERN  RAW ~1-3 MB/evt ~100 evt/s  L.Levchuk, NEC'09, Varna, Bulgaria

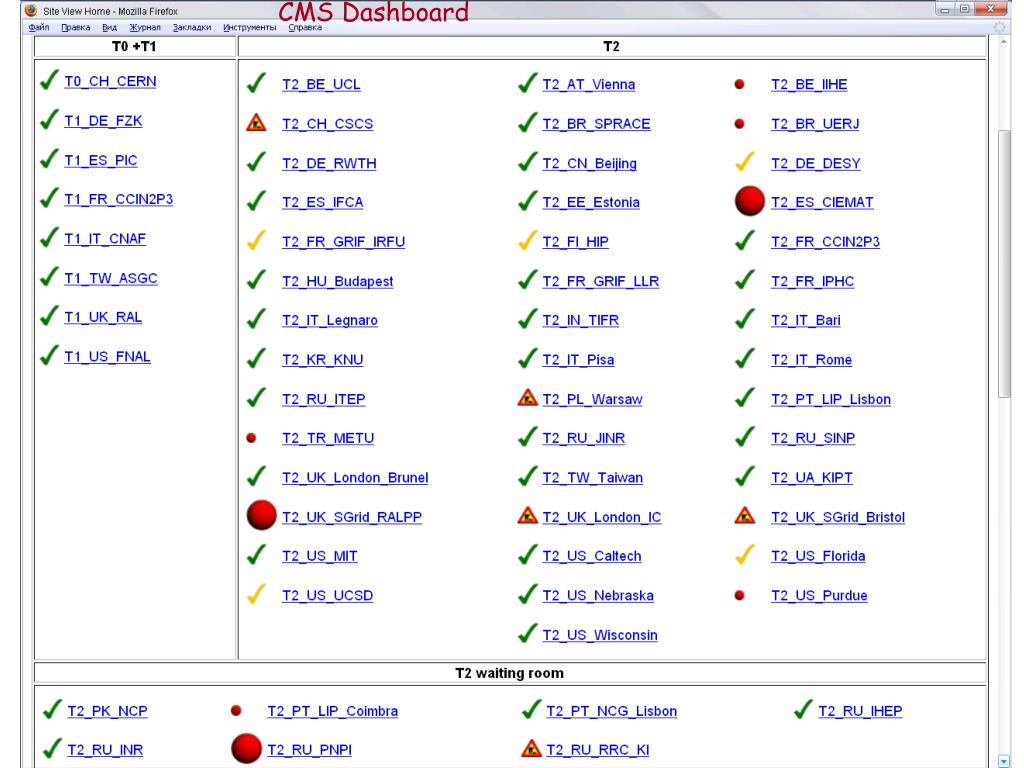

  6. CMS Dashboard

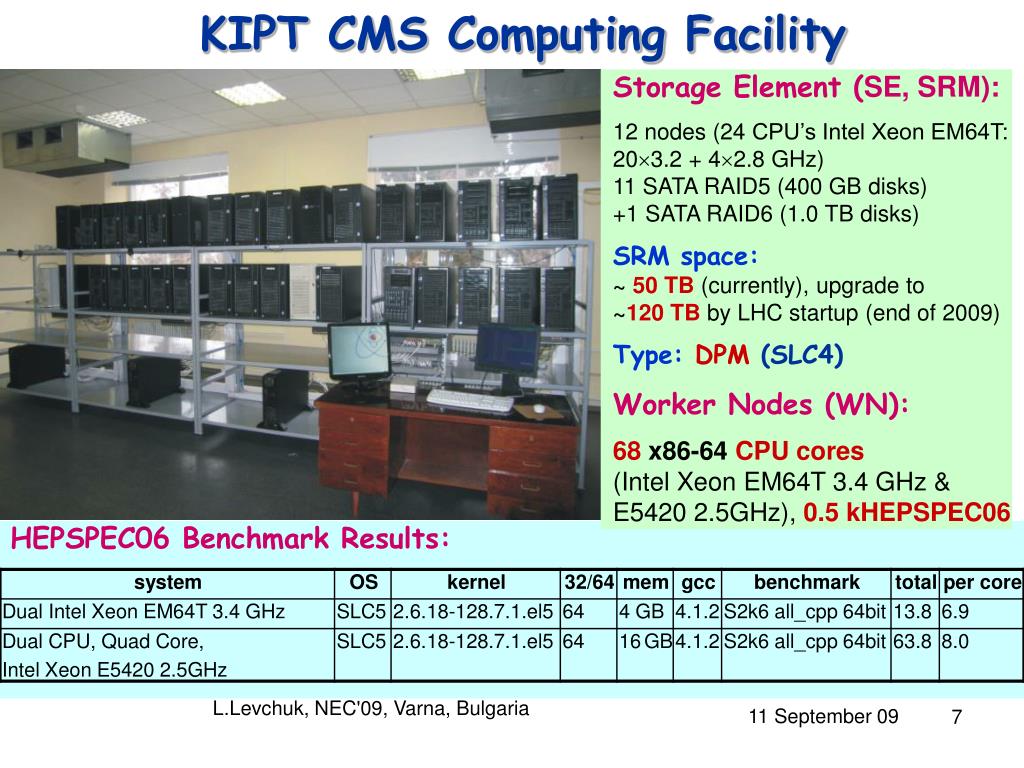

  7. KIPT CMS Computing Facility Storage Element (SE, SRM): 12 nodes (24 CPU’s Intel Xeon EM64T: 203.2 + 42.8 GHz) 11SATA RAID5 (400 GB disks) +1 SATA RAID6 (1.0 TB disks) SRM space: ~ 50 TB(currently), upgrade to ~120 TBby LHC startup (end of 2009) Type:DPM (SLC4) Worker Nodes (WN): 68x86-64 CPU cores (Intel Xeon EM64T 3.4 GHz & E5420 2.5GHz), 0.5 kHEPSPEC06 HEPSPEC06 Benchmark Results: L.Levchuk, NEC'09, Varna, Bulgaria

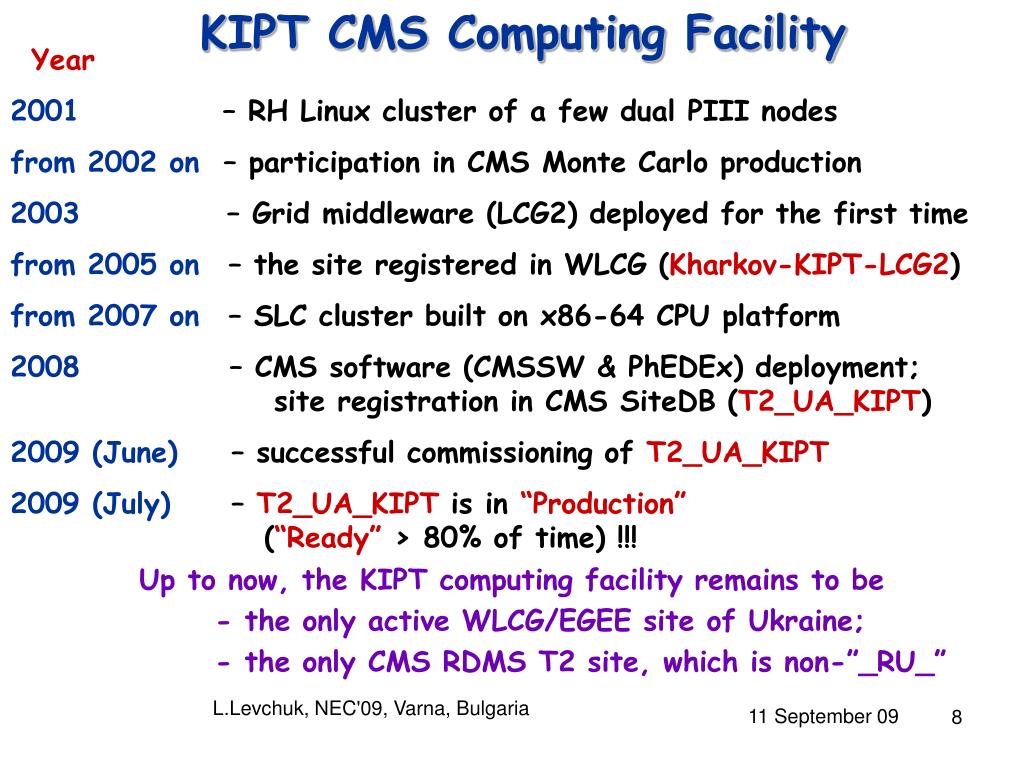

  8. KIPT CMS Computing Facility Year 2001 – RH Linux cluster of a few dual PIII nodes from 2002 on – participation in CMS Monte Carlo production 2003 – Grid middleware (LCG2) deployed for the first time from 2005 on– the site registered in WLCG (Kharkov-KIPT-LCG2) from 2007 on– SLC cluster built on x86-64 CPU platform 2008– CMS software (CMSSW & PhEDEx) deployment; site registration in CMS SiteDB (T2_UA_KIPT) 2009 (June)– successful commissioning of T2_UA_KIPT 2009 (July) – T2_UA_KIPT is in “Production” (“Ready” > 80% of time) !!! Up to now, the KIPT computing facility remains to be - the only active WLCG/EGEE site of Ukraine; - the only CMS RDMS T2 site, which is non-”_RU_” L.Levchuk, NEC'09, Varna, Bulgaria

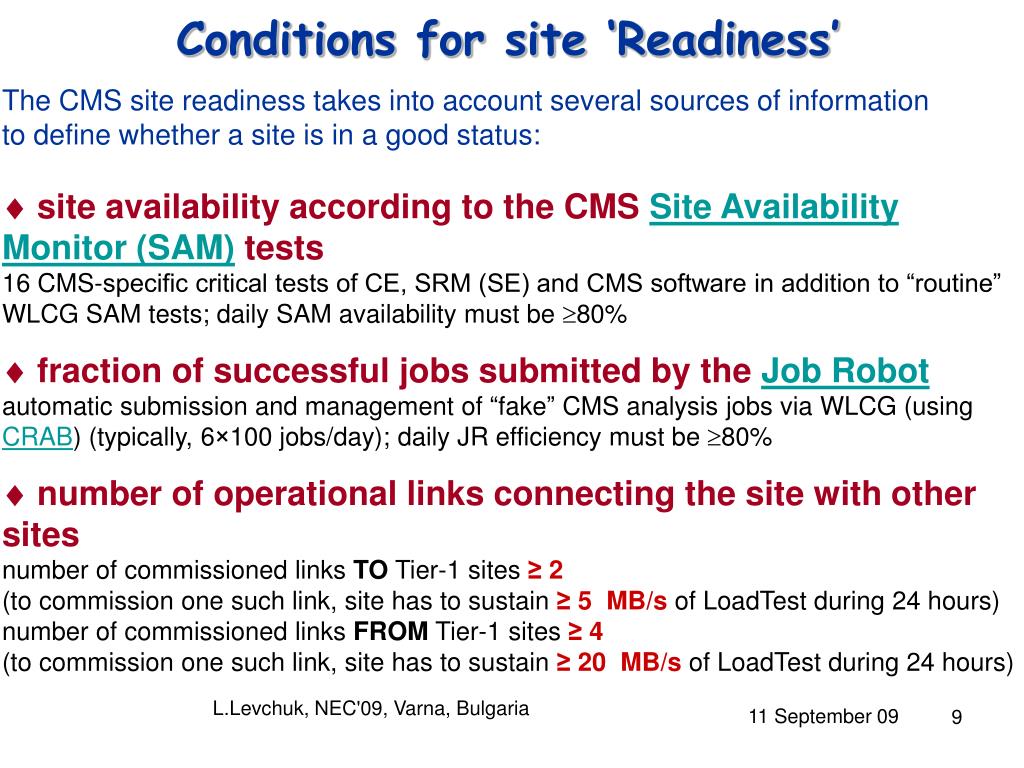

  9. Conditions for site ‘Readiness’ The CMS site readiness takes into account several sources of information to define whether a site is in a good status: site availability according to the CMSSite Availability Monitor (SAM) tests 16 CMS-specific critical tests of CE, SRM (SE) and CMS software in addition to “routine” WLCG SAM tests; daily SAM availability must be 80%  fraction of successful jobs submitted by theJob Robot automatic submission and management of“fake”CMS analysis jobs via WLCG (using CRAB) (typically, 6×100 jobs/day); daily JR efficiency must be 80%  number of operational links connecting the site with other sites number of commissioned links TO Tier-1 sites ≥ 2 (to commission one such link, site has to sustain ≥ 5 MB/s of LoadTest during 24 hours) number of commissioned links FROM Tier-1 sites ≥ 4 (to commission one such link, site has to sustain ≥ 20 MB/s of LoadTest during 24 hours) L.Levchuk, NEC'09, Varna, Bulgaria

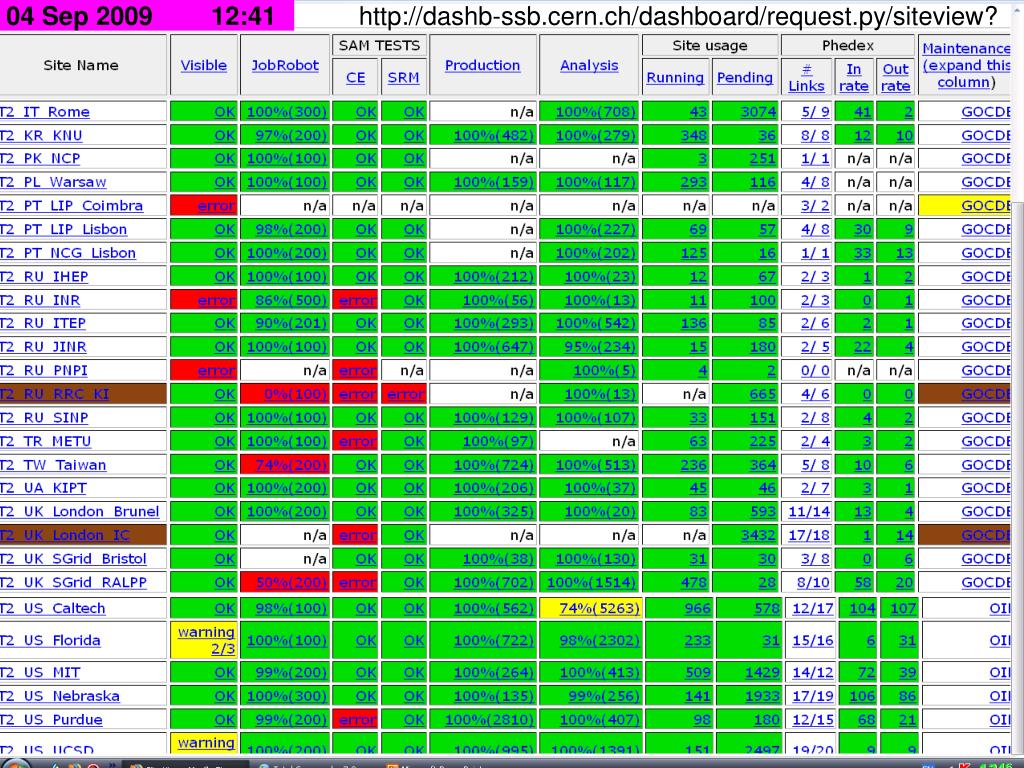

  10. 04 Sep 2009 12:41 http://dashb-ssb.cern.ch/dashboard/request.py/siteview? L.Levchuk, NEC'09, Varna, Bulgaria

  11. Commissioning of first 6 T2_UA_KIPT uplinks LoadTest from: CH_CERN ES_PIC DE_FZK IT_CNAF US_FNAL FR_CCIN2P3 L.Levchuk, NEC'09, Varna, Bulgaria

  12. Commissioning of first 6 T2_UA_KIPT uplinks (II) 33.02 TB L.Levchuk, NEC'09, Varna, Bulgaria

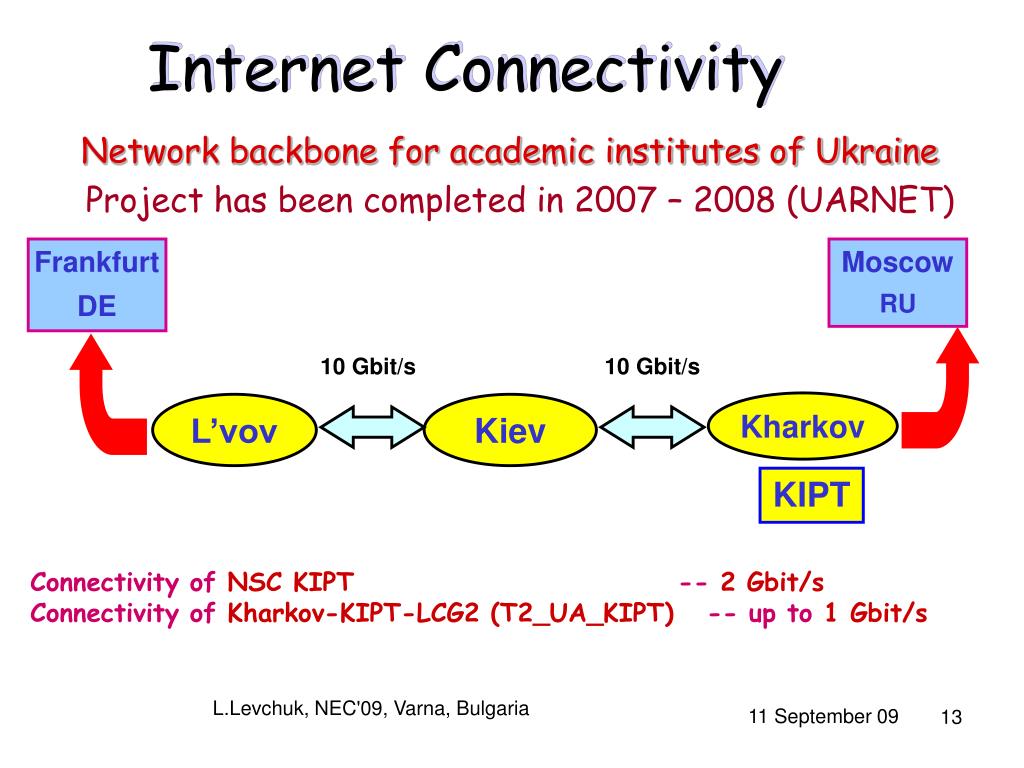

  13. Frankfurt DE Moscow RU 10 Gbit/s 10 Gbit/s Kharkov L’vov Kiev KIPT Internet Connectivity Network backbone for academic institutes of Ukraine Project has been completed in 2007 – 2008 (UARNET) Connectivity of NSC KIPT -- 2 Gbit/s Connectivity of Kharkov-KIPT-LCG2 (T2_UA_KIPT) -- up to 1 Gbit/s L.Levchuk, NEC'09, Varna, Bulgaria

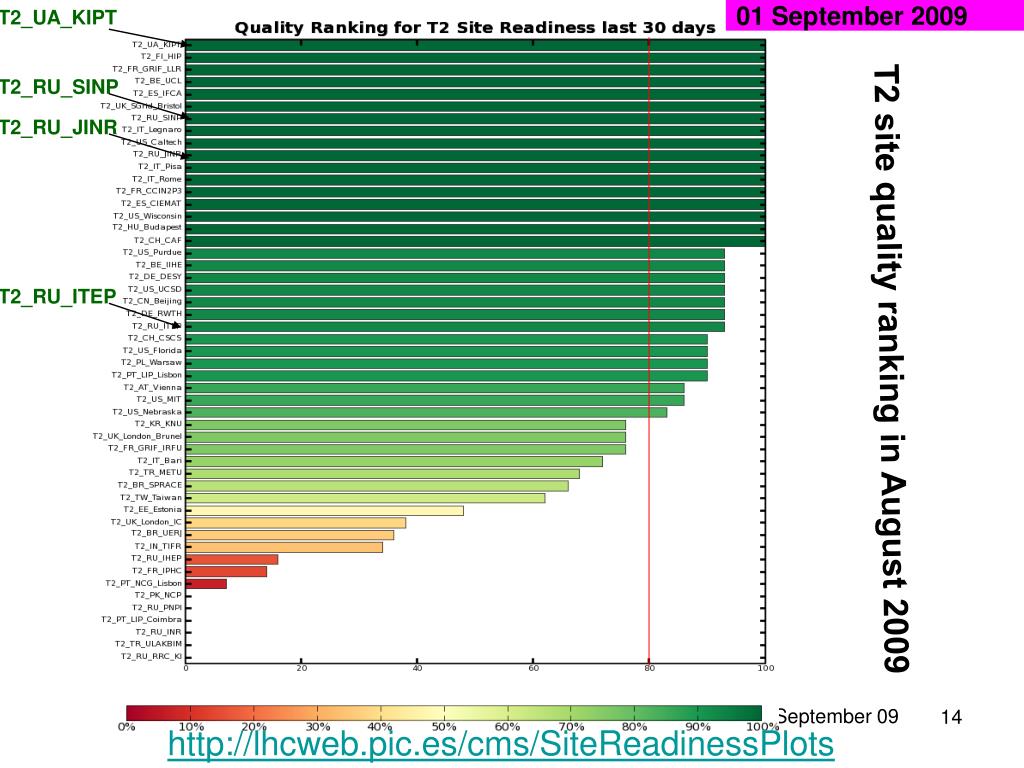

  14. T2_UA_KIPT 01 September 2009 T2_RU_SINP T2_RU_JINR T2_RU_ITEP T2 site quality ranking in August 2009 L.Levchuk, NEC'09, Varna, Bulgaria http://lhcweb.pic.es/cms/SiteReadinessPlots

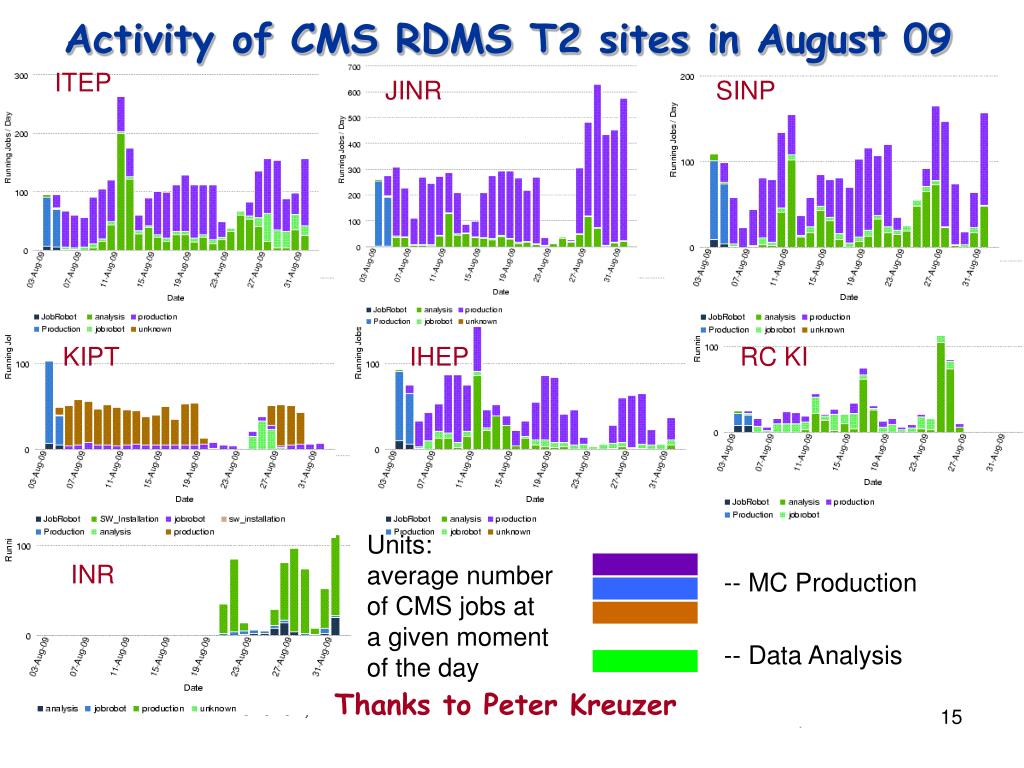

  15. Activity of CMS RDMS T2 sites in August 09 ITEP JINR SINP KIPT IHEP RC KI Units: average number of CMS jobs at a given moment of the day INR -- MC Production -- Data Analysis Thanks to Peter Kreuzer L.Levchuk, NEC'09, Varna, Bulgaria

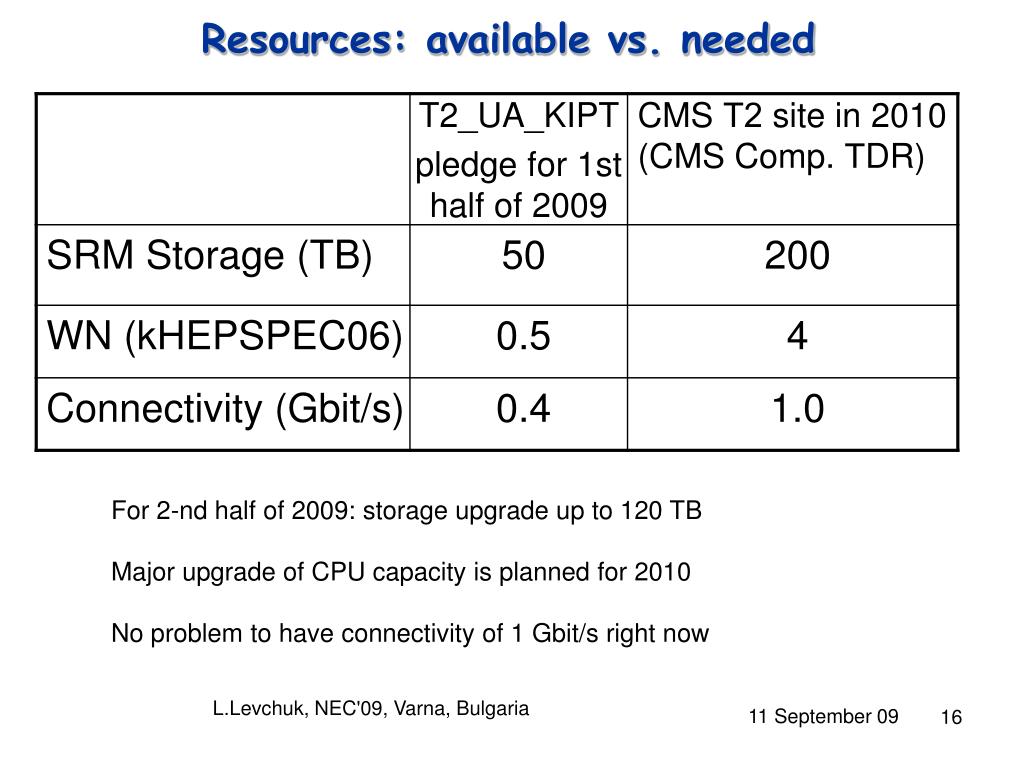

  16. Resources: available vs. needed For 2-nd half of 2009: storage upgrade up to 120 TB Major upgrade of CPU capacity is planned for 2010 No problem to have connectivity of 1 Gbit/s right now L.Levchuk, NEC'09, Varna, Bulgaria

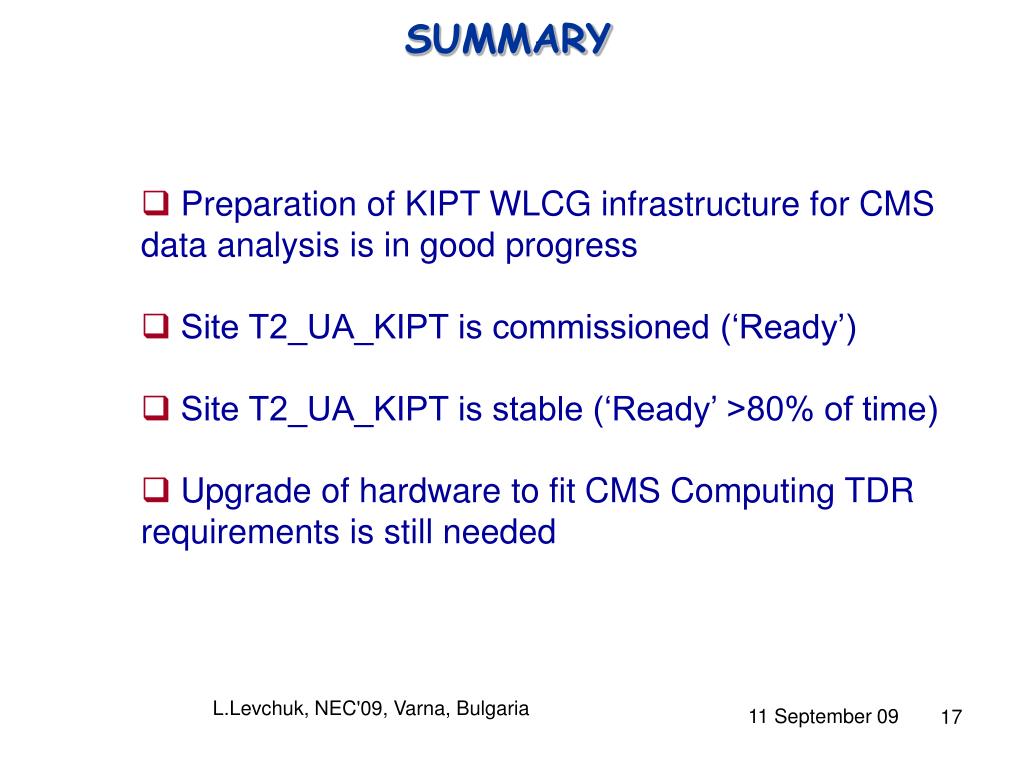

  17. SUMMARY • Preparation of KIPT WLCG infrastructure for CMS data analysis is in good progress • Site T2_UA_KIPT is commissioned (‘Ready’) • Site T2_UA_KIPT is stable (‘Ready’ >80% of time) • Upgrade of hardware to fit CMS Computing TDR requirements is still needed L.Levchuk, NEC'09, Varna, Bulgaria
