Join the Old Dominion University ASV team in developing an advanced ASV featuring an aluminum frame and hydrostatic analysis, propulsion with a Kort nozzle design, obstacle avoidance technology, automated docking, acoustic beacon positioning, and underwater light identification. Stay tuned for testing and integration updates.
E N D
Old Dominion ASV team Co-Captain Chris Shertzer Co-Captain Benjamin McKinley Adam Stofko Richard Blanchette Brittany Garman Ganesh Balasubramanian Zach Carpenter Advising Professor: Dr. Gene Hou

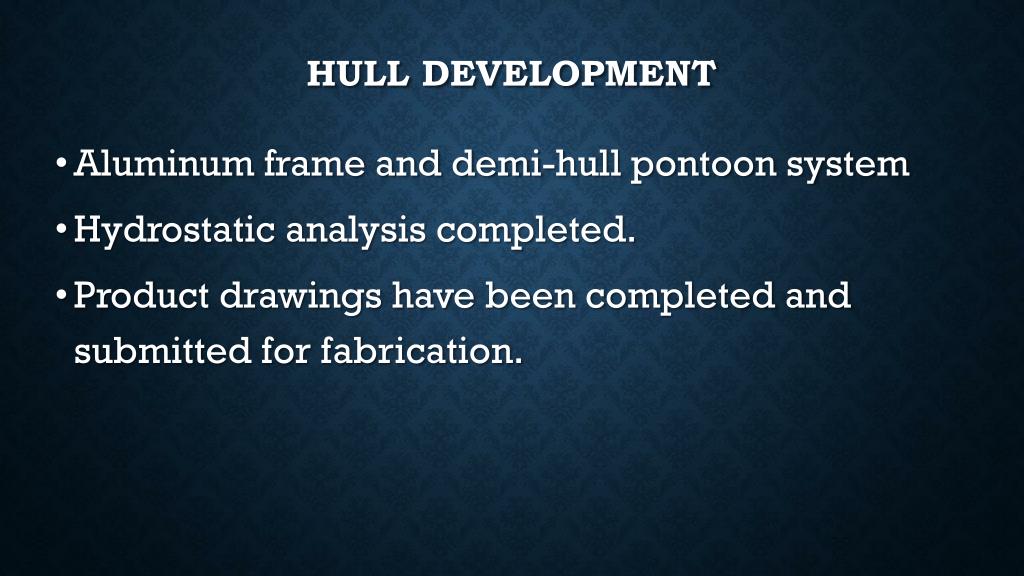

Hull Development • Aluminum frame and demi-hull pontoon system • Hydrostatic analysis completed. • Product drawings have been completed and submitted for fabrication.
Propulsion • A Kort nozzle has been designed and tested using Solid Works • After approval has been given, 3D printing will begin

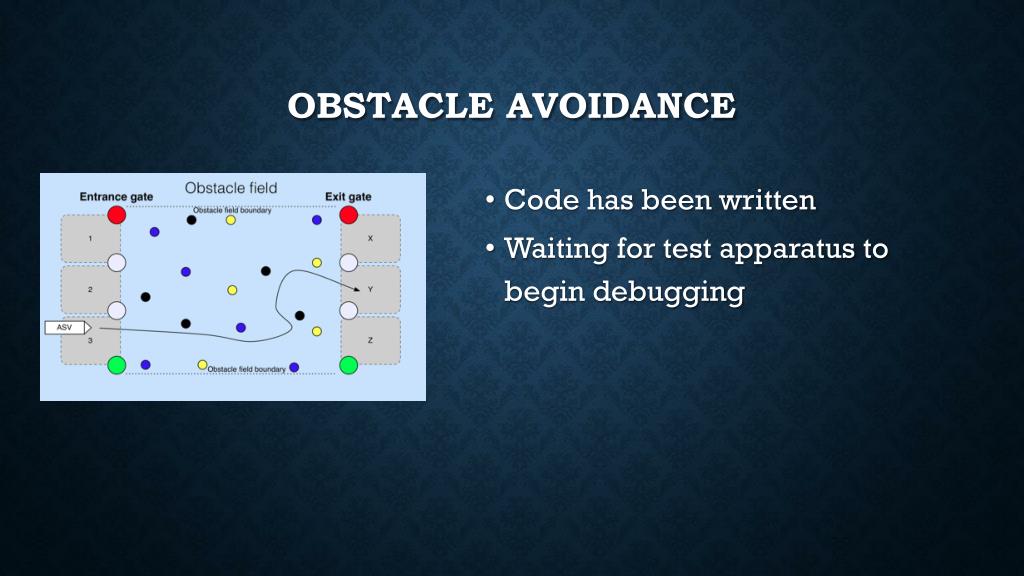

Obstacle Avoidance • Code has been written • Waiting for test apparatus to begin debugging

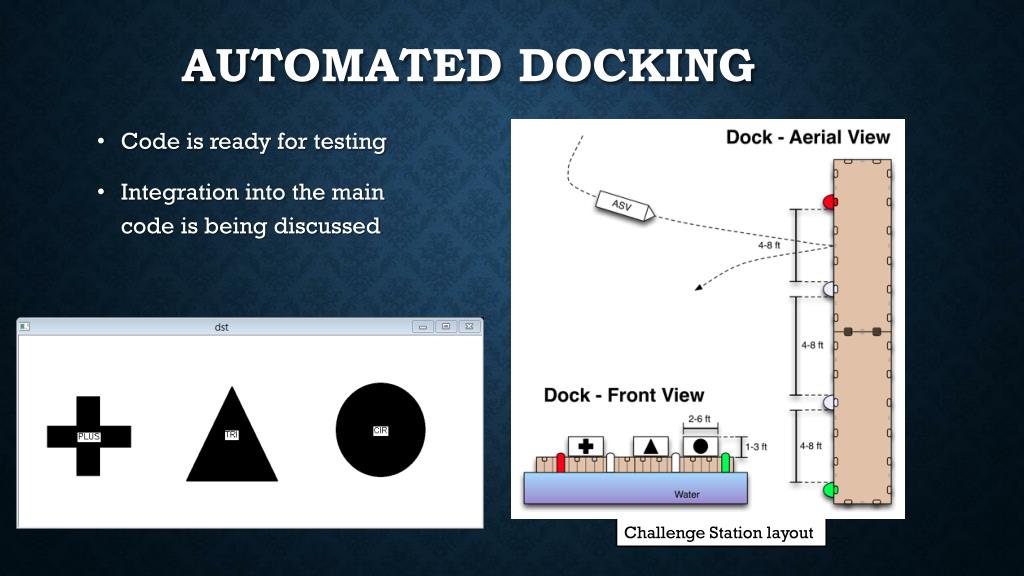

Automated Docking Code is ready for testing Integration into the main code is being discussed Challenge Station layout
Acoustic Beacon Positioning • A device has been developed • Testing is underway 3D Rhino model (McNeel North America, Seattle, WA)

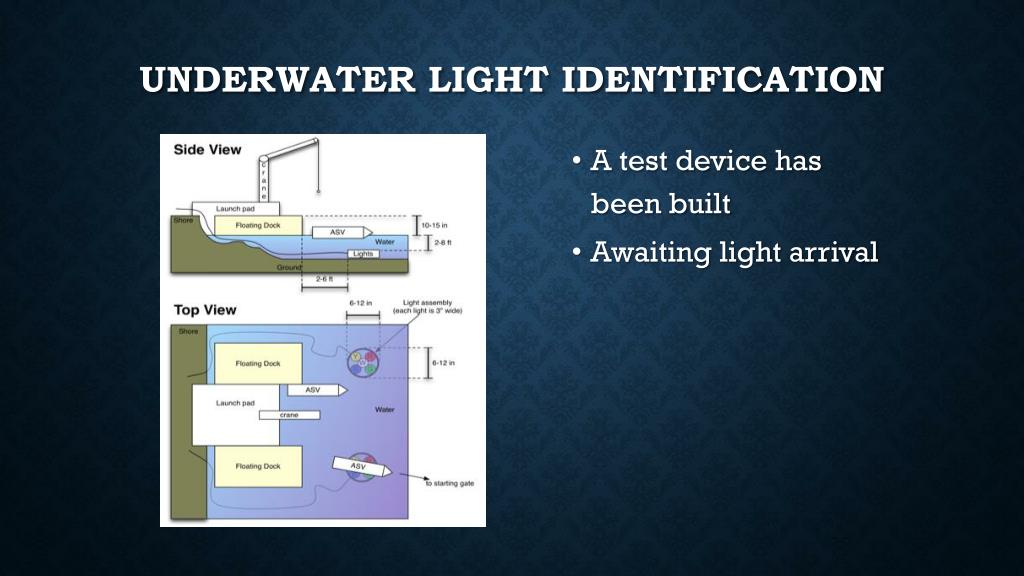

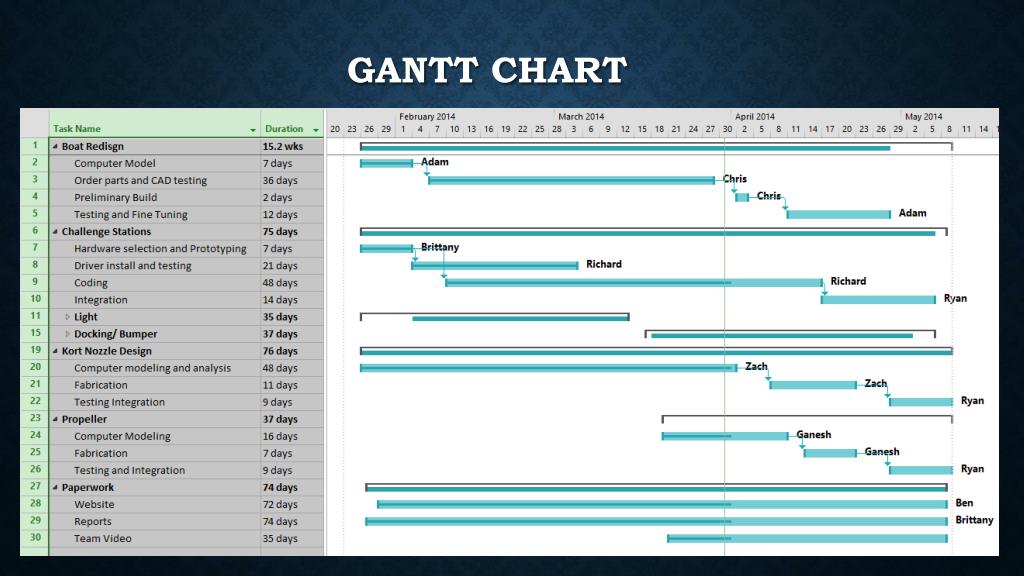

Underwater light Identification • A test device has been built • Awaiting light arrival
