Business: FedEx SmartPost

DESCRIPTION

Business: FedEx SmartPost. Team 16: Alex Johnson Ashwin Nair Phuc Van Nguyen Ziran Zhu. Introduction. Background: FedEx SmartPost delivery model Statement of Need: Limited staging capacity during Peak season Project Objective:

1 / 22

Télécharger la présentation

Business: FedEx SmartPost

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Business: FedEx SmartPost Team 16: Alex Johnson AshwinNair Phuc Van Nguyen Ziran Zhu

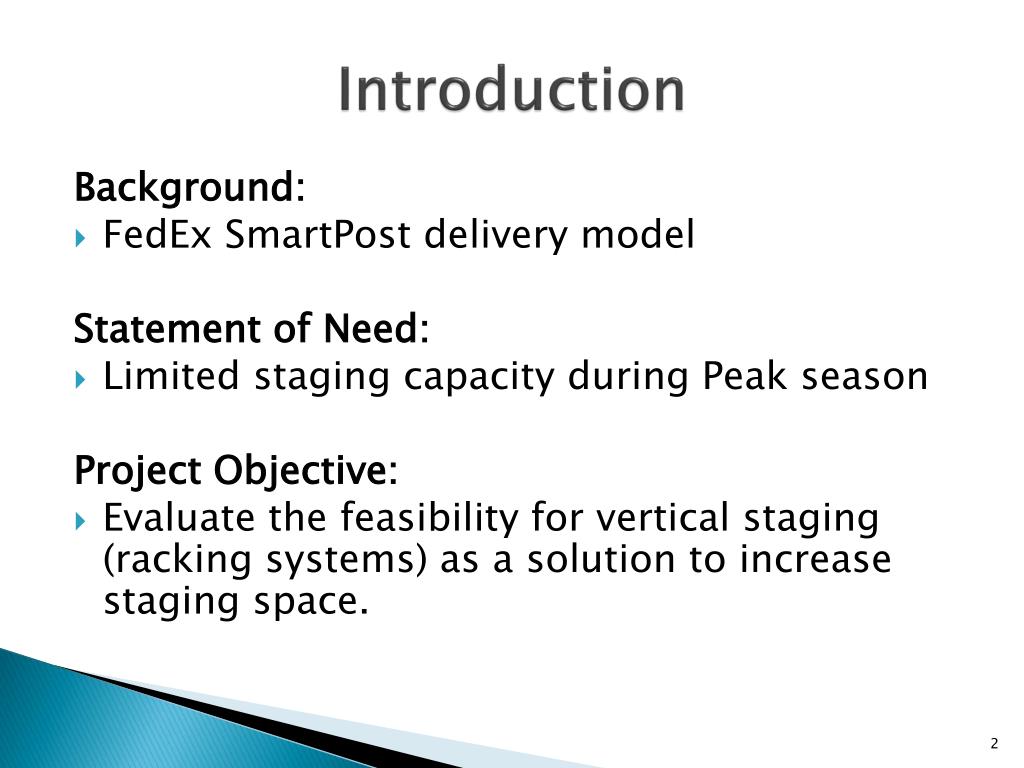

  2. Introduction Background: • FedEx SmartPost delivery model Statement of Need: • Limited staging capacity during Peak season Project Objective: • Evaluate the feasibility for vertical staging (racking systems) as a solution to increase staging space.

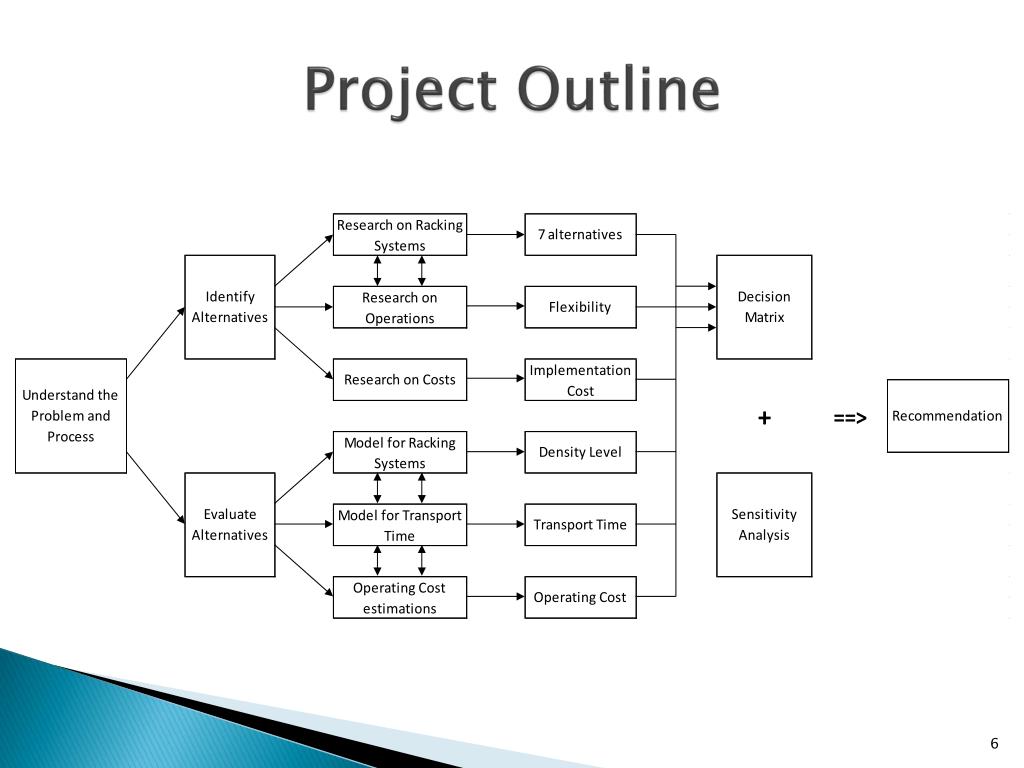

  3. Project Outline

  4. Density Level Calculation

  5. Transport Time Calculation

  6. Project Outline

  7. Floor Staging

  8. SelectiveRacking

  9. Pushback

  10. Gravity Flow

  11. Drive-In (eliminated)

  12. Mezzanine (eliminated)

  13. Horizontal Pallet Transfer System

  14. Result (Evaluation of Alternatives)

  15. Decision Matrix

  16. Conclusions and Recommendations Selective Racking Benefits: • Minimizes implementation cost and improved flexibility Setbacks: • Slowest to remove pallets from the racks and may require additional labor. Gravity Flow Benefit: • Significantly higher pallet staging capacity. Setback: - Relatively more expensive compared to Selective Racking.

  17. Conclusions and Recommendations Pushback • Middle ground solution • Pushback is best where having a cheaper implementation cost and more flexibility while also maintaining a high density level is important.

  18. Operational Improvements and Future Work Additional Operational improvements recommended: • Changes in inspection process • Route organization Considerations for future work: • Identify priorities for each hub’s needs • Refine time and cost estimates • Improve operational processing capacity

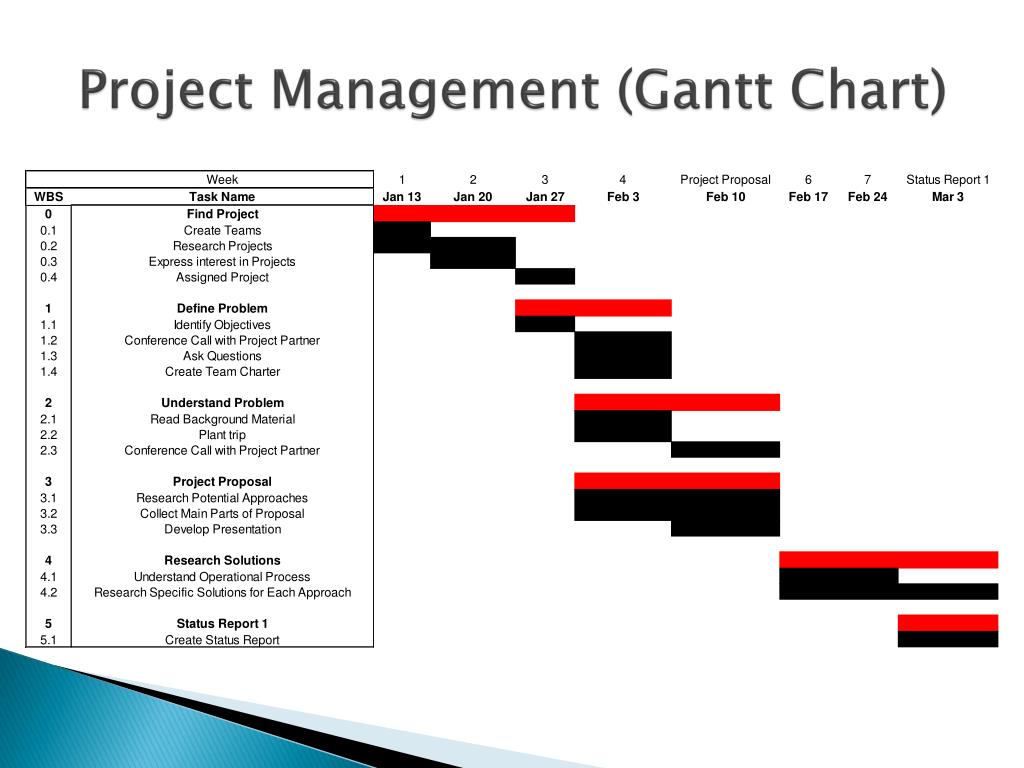

  19. Project Management (Gantt Chart)

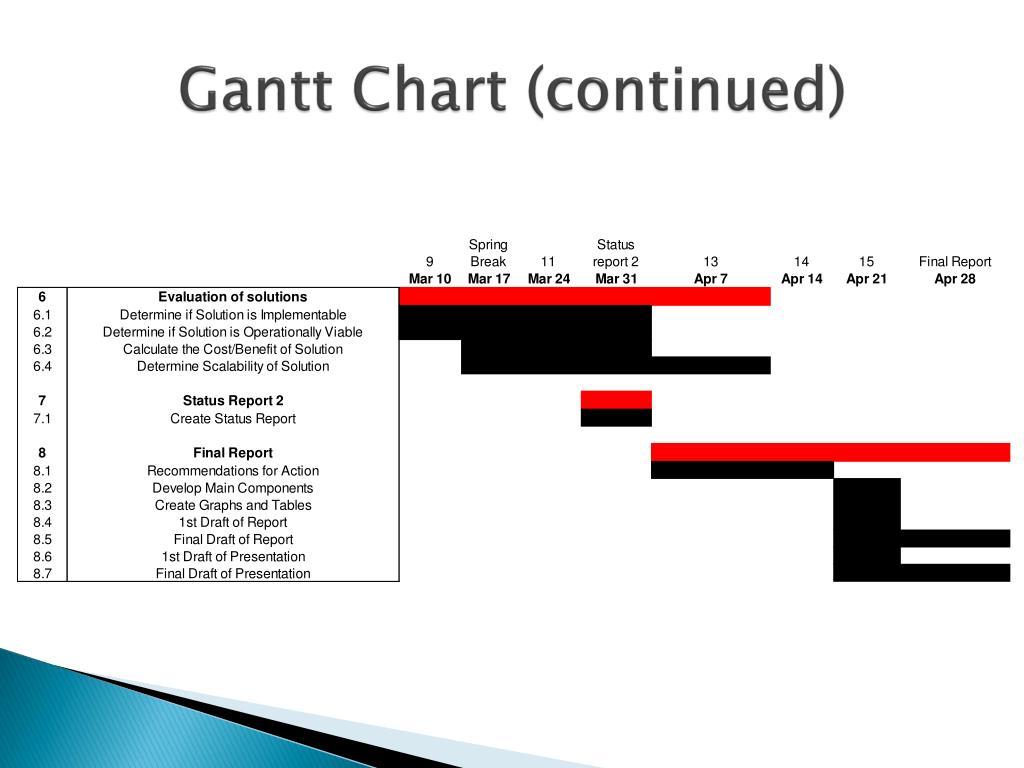

  20. Gantt Chart (continued)

  21. Budget

  22. IE courses relevant to this project • IE 332: Computing in IE • AutoCAD • IE 335: Operations Research – Optimization • Sensitivity Analysis • IE 343: Engineering Economics • Payback period • IE 484: Integrated Production Systems 2 • Material Handling • IE 590: Project Management • Project Management tools
