RFCS Information Day. Introduction to the RFCS Programme Practical Aspects of the Programme Administration and Status RFCS weblinks. ECSC: From the past… 1952: ECSC Treaty (50 years) Expired in July 2002 Assets left: ~ 1.6 bn€. WHY the RFCS Programme?.
E N D

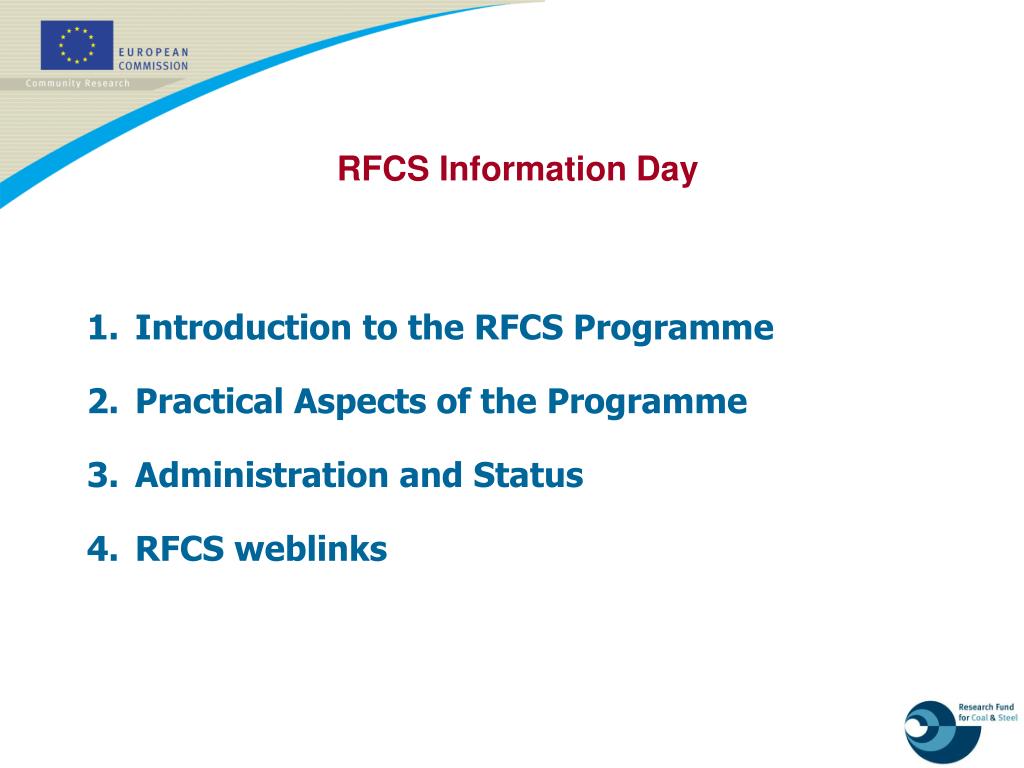

RFCS Information Day • Introduction to the RFCS Programme • Practical Aspects of the Programme • Administration and Status • RFCS weblinks
ECSC: From the past… • 1952: ECSC Treaty (50 years) • Expired in July 2002 • Assets left: ~ 1.6 bn€ WHY the RFCS Programme? * ECSC: European Coal and Steel Community • …to the present: RFCS • 2001: Treaty of Nice • To transfer the ECSC assets to the European Community • To create the • RFCS: 1 Feb 2003
WHAT is the RFCS Programme? Coal 27.2% • A research fund with a budget of ~55 M€/year • Promoting industrial research in the field of • Coal and Steel • Open call for proposals for • Research projects (60% funding) • Pilot & Demonstration projects (50% funding) • Accompanying measures • Deadline: in principle, September 15th of each year • Outside the FP…yet closely co-ordinated & complementary ~ 15 M€/y ~ 40 M€/y Steel 72.8% RFCS funding allocation
RFCS Information Day • Facts and Figures • Typically 40 Million € per year for Steel ~= 30 Grant agreements • Typically 15 Million € per year for Coal ~= 8 Grant agreements • Approximately 350 Grant Agreement running at any one time • 440 Million € invested in Coal and Steel research since 2003 • Good mix of Industry, academia and research centres • Scientific, technical, innovative projects, well defined objectives • Can be complimentary to other funding • Typical funding, 1 to 2 Million €. Occasionally as large as 5 Million €
RFCS Programme management Programme Committee Representatives of the Member States1) COSCO The Commission Coal / Steel Advisory Group Recommended representatives2) CAG/SAG 12 Technical Groups Senior Experts for project monitoring & review 2) Technical Groups + independent Evaluation Experts for selection of projects 2) • Appointed by the Member States • Appointed by the EC

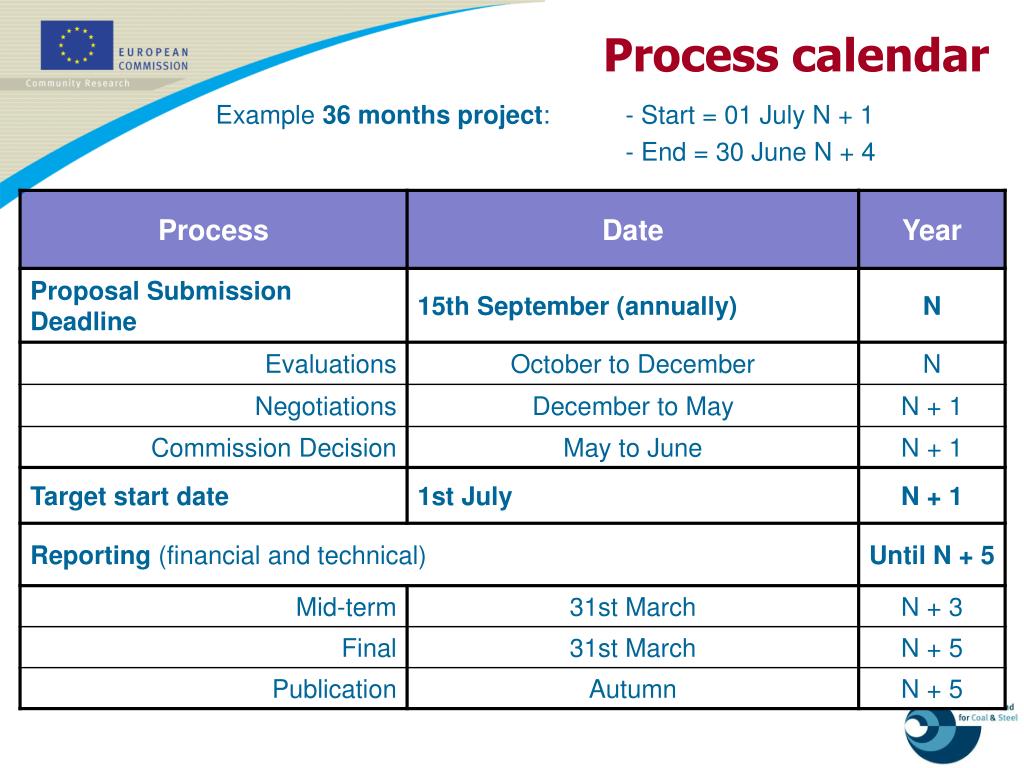

Process calendar Example 36 months project: - Start = 01 July N + 1 - End = 30 June N + 4
Proposal • Evaluation • Negotiations Decision 40% € • Project • - Technical Reports (Annual, Mid-term and Final) • Financial Statements (Mid-term and Final) Mid-Term 40% € Results - Publication Final 20% € Project life cycle
STEEL: Programme Research Objectives Conservation of resources and improvement of working conditions New and improved steelmaking and finishing techniques RTD and the utilisation of steel
STEEL Technical Groups TGS 1 - Ore agglomeration and Iron making TGS 2 - Steelmaking processes TGS 3 - Casting, reheating and direct rolling TGS 4 - Hot and cold rolling processes TGS 5 - Finishing and coating TGS 6 - Physical metallurgy and design of new generic steel grades TGS 7 - Steel products and applications for automobiles, packaging and home appliances TGS 8 - Steel products and applications for building, construction and industry TGS 9 - Factory-wide control, social and environmental issues

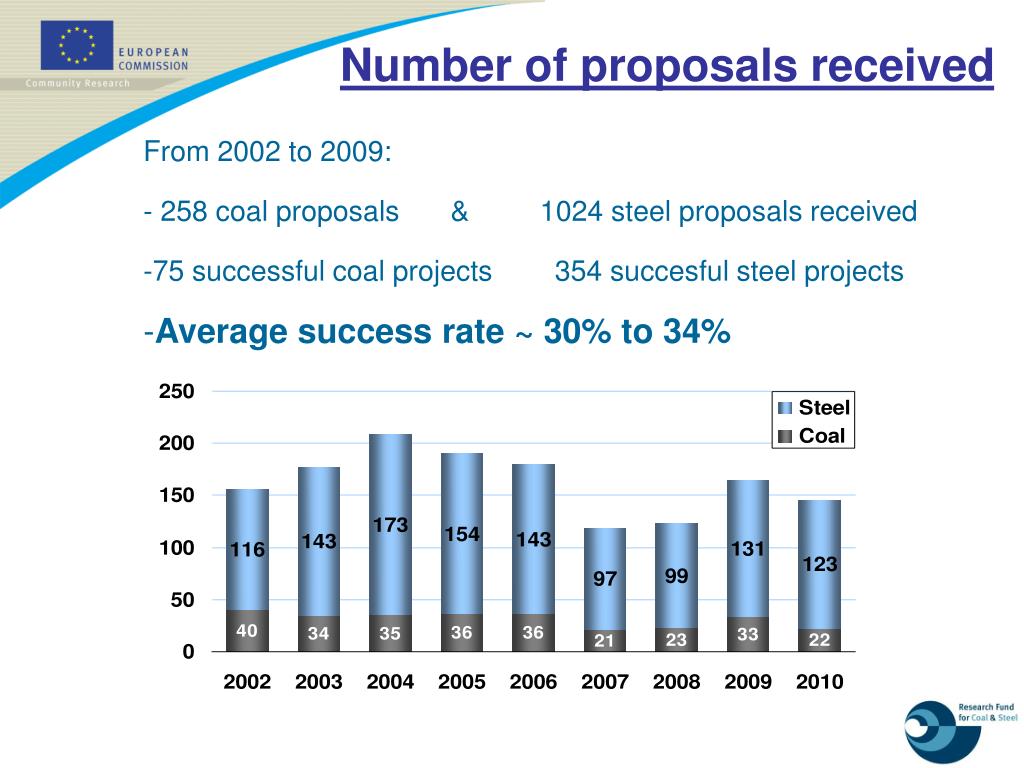

Number of proposals received • From 2002 to 2009: • - 258 coal proposals & 1024 steel proposals received • 75 successful coal projects 354 succesful steel projects • Average success rate ~ 30% to 34%
WHO can participate? • Any legal entity established in any of the Member States • Consortium size – no minimum - but typically 4 to 8 participants • Not necessarily directly connected with the coal or iron and steel industries but the project has to be within the scope of the programme • Partners from Candidate or Third Countries are welcome (though not eligible for EC funding)

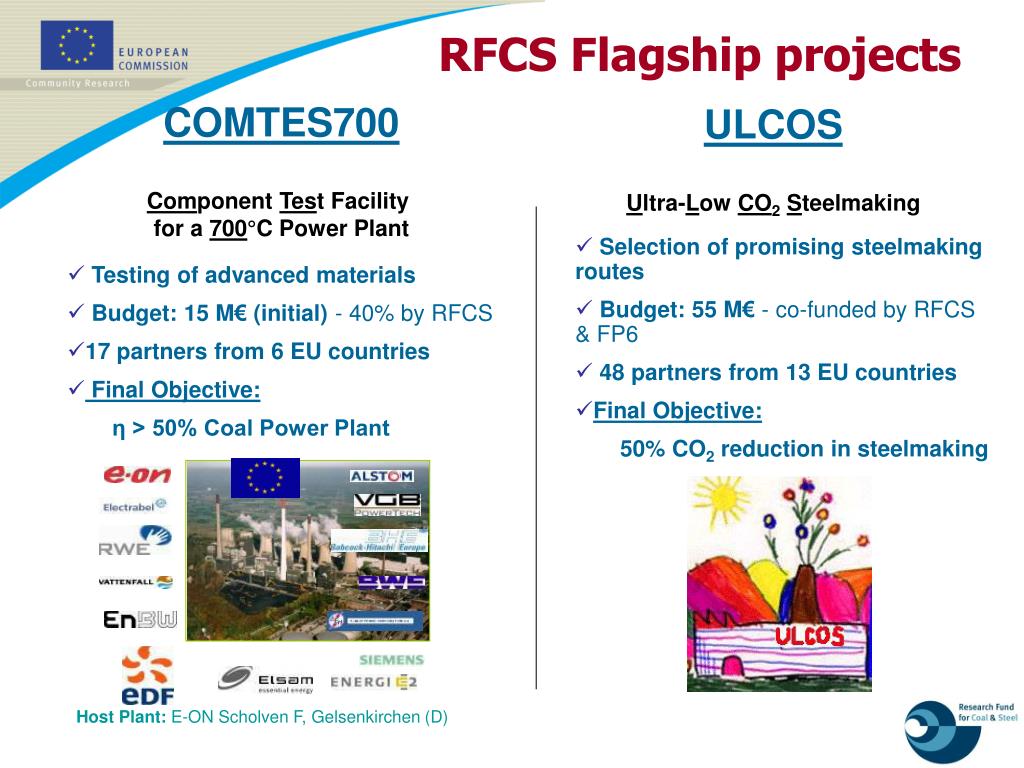

COMTES700 Component Test Facility for a 700°C Power Plant ULCOS Ultra-Low CO2Steelmaking • Selection of promising steelmaking routes • Budget: 55 M€ - co-funded byRFCS & FP6 • 48 partners from 13 EU countries • Final Objective: • 50% CO2 reduction in steelmaking • Testing of advanced materials • Budget: 15 M€ (initial) - 40% by RFCS • 17 partners from 6 EU countries • Final Objective: • η > 50% Coal Power Plant Host Plant: E-ON Scholven F, Gelsenkirchen (D) RFCS Flagship projects
RFCS priorities Annual Priorities agreed with industry • Technical Committee chairs: • TGC suggestions, ESTEP working Groups • Advisory Groups proposes final version Implimentation • Published each year in the ‘infopack’ • 1 “extra” point over 25 points • Helps a good proposal but other proposals which are not in line with the priority are regularly funded
RFCS Information Day • How can you take part? • In a proposal • Read the SYNOPSIS – it gives a good overview of what is currently being funded • Make contact with experienced beneficiaries with whom you can add value • As an expert evaluator • Help us evaluate proposals. Register on CORDIS • Assist in formulating priorities • Take contact with SAG + CAG member
RFCS Weblinks • RFCS website: • - http://cordis.europa.eu/coal-steel-rtd/ • Information Package • - http://cordis.europa.eu/coal-steel-rtd/infopack_en.html • Latest published technical reports: • - http://bookshop.europa.eu/ • - http://cordis.europa.eu/library/ • Synopsis of ongoing RFCS projects: • - http://cordis.europa.eu/coal-steel-rtd/synopsis_en.html
RFCS - COAL research: Funding distribution & activities SOURCING CONVERSION COMBUSTION • Coal mining • CO2 geol. storage • Underground gasification • … • Coal preparation • Coal gasification • Synfuels • … • Clean coal tech. • CO2 capture • Co-combustion • … 36% 49 M€ 19% 26 M€ 45% 61 M€ Total RFCS funding allocation for COAL projects from 2003 to 2011*: 136.6 M€ (*) 2011 provisional figures

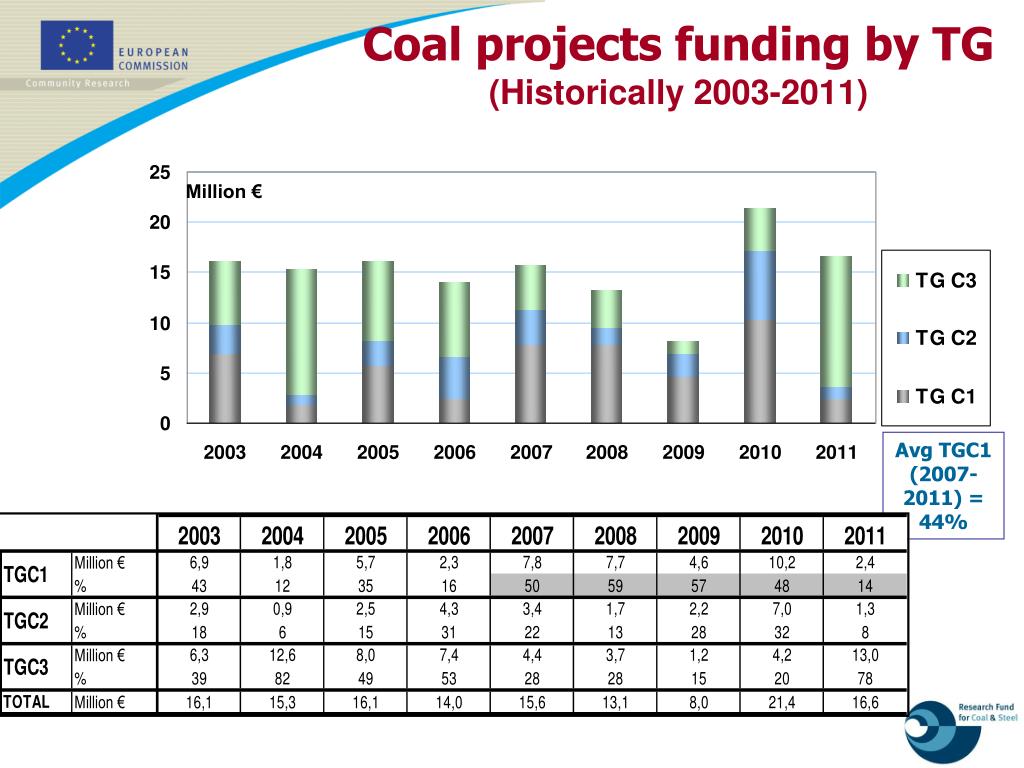

Coal projects funding by TG(Historically 2003-2011) Avg TGC1 (2007-2011) = 44%

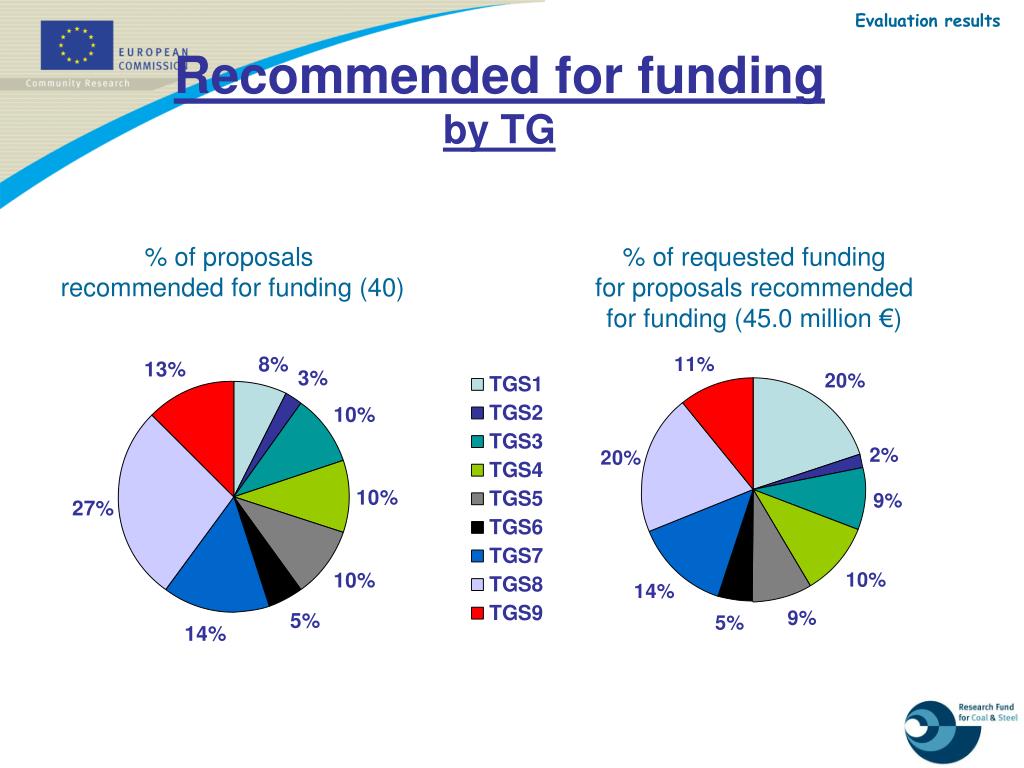

Evaluation results Recommended for funding by TG % of proposals recommended for funding (40) % of requested funding for proposals recommended for funding (45.0 million €)
RFCS Monitoring & Assessment • Main objective = Assess the benefits of the RTD to society and to the industry sectors • Analysis of the RFCS Programme • Make recommendations for the improvement of the RFCS and its effectiveness • RFCS projects (closed) over a 7 year process • Conducted by an expert committee • Creation of working groups in 2011 Q2 and Q3 • Will report in 2012
