An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Autostrada A1 Nowe Marzy, 25 August 2008

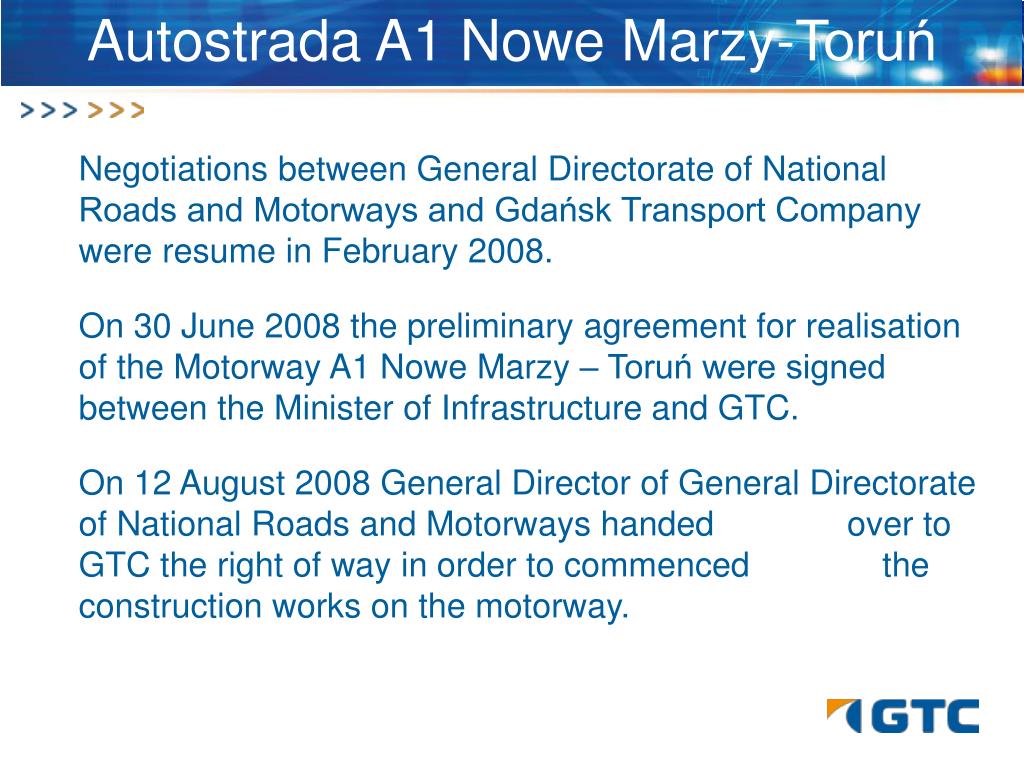

  2. Autostrada A1 Nowe Marzy-Toruń Negotiations between General Directorate of National Roads and Motorways and Gdańsk Transport Company were resume in February 2008. On 30 June 2008 the preliminary agreement for realisation of the Motorway A1 Nowe Marzy – Toruń were signed between the Minister of Infrastructure and GTC. On 12 August 2008 General Director of General Directorate of National Roads and Motorways handed over to GTC the right of way in order to commenced the construction works on the motorway.

  3. Autostrada A1 in 2011 • Total length of the A1Motorway - 569 km, • including: • section Gdańsk -Toruń built in PPP model - 152 km • section Toruń - Łodź built in traditional model - 144 km • section Łódź - Pyrzowice built in PPP model - 180 km • Pyrzowice – boarder with Czech Republic built . in traditional model - 93 km

  4. Autostrada A1 progress Existing sections: 43 km • section Rusocin –Swarożyn - 25 km • section Głuchów –Piotrków Trybunalski - 18 km Currently under construction: 177,5 km • Swarożyn – Nowe Marzy - 65 km • Nowe Marzy – Toruń 62,4 km • węzeł Sośnica - 2,2 km • Sośnica –Bełk - 15,4 km • Bełk – Świerklany 14,1 km • Świerklany – Gorzyczki - 18,3 km

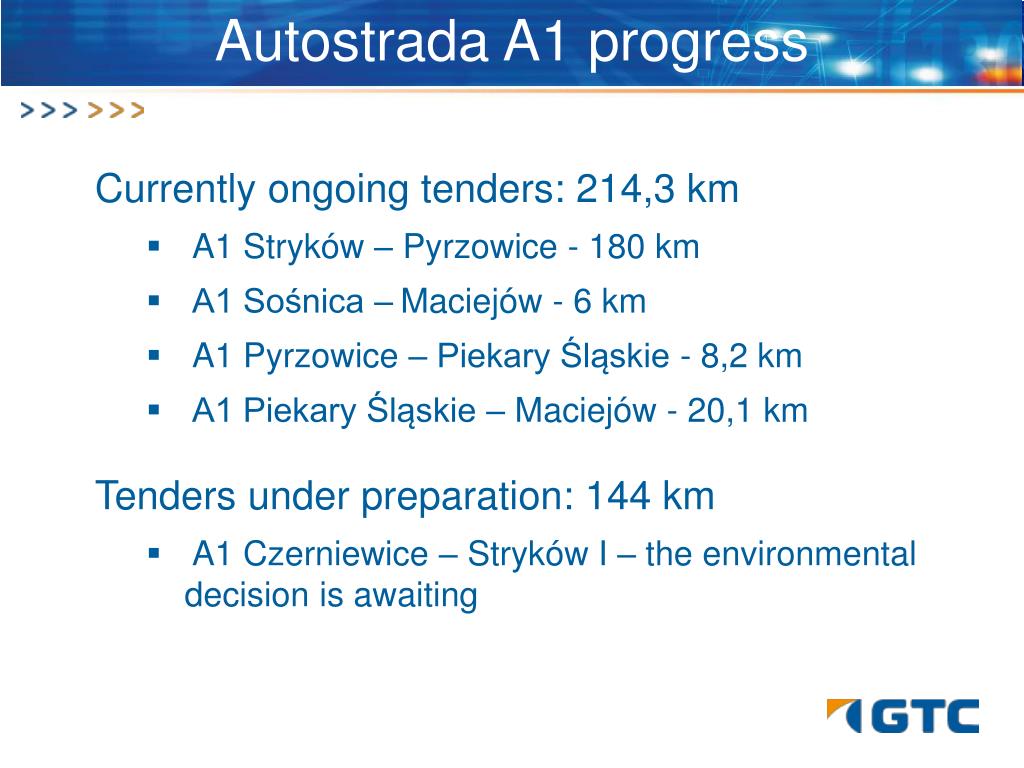

  5. Autostrada A1 progress Currently ongoing tenders: 214,3 km • A1 Stryków – Pyrzowice - 180 km • A1 Sośnica –Maciejów - 6 km • A1 Pyrzowice – Piekary Śląskie - 8,2 km • A1 Piekary Śląskie – Maciejów - 20,1 km Tenders under preparation: 144 km • A1 Czerniewice – Stryków I – the environmental decision is awaiting

  6. Autostrada A1Nowe Marzy - Toruń

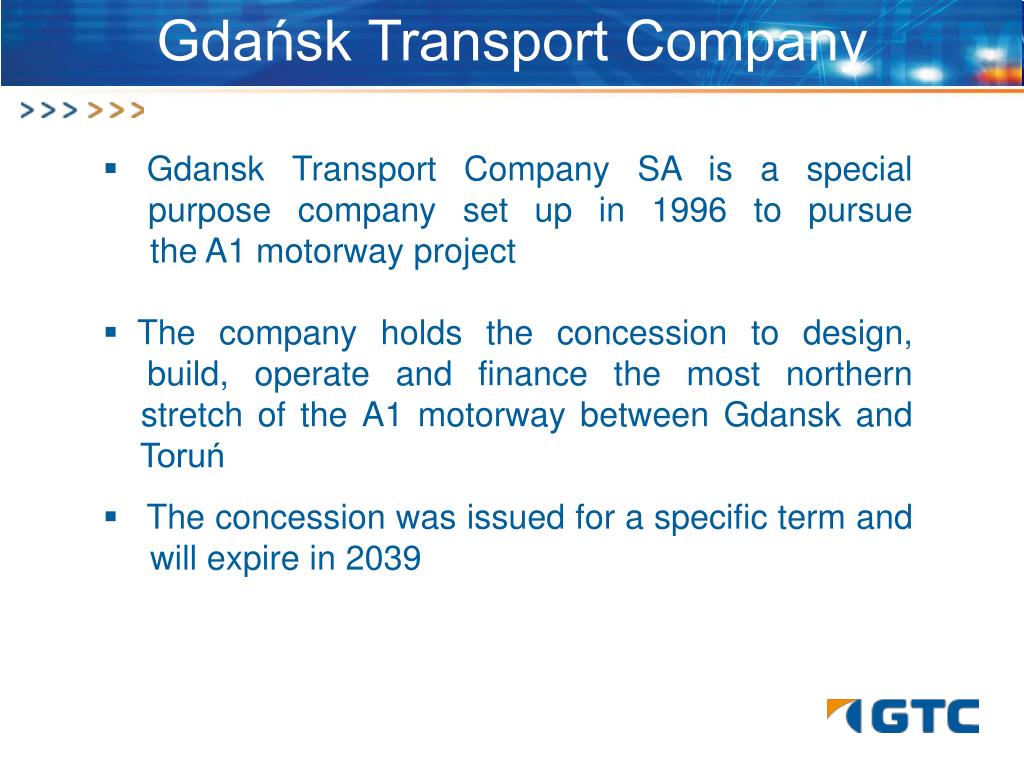

  7. Gdańsk Transport Company • Gdansk Transport Company SA is a special p purpose company set up in 1996 to pursue . the A1 motorway project • The company holds the concession to design, b build, operate and finance the most northern . stretch of the A1 motorway between Gdansk and . Toruń • The concession was issued for a specific term and . will expire in 2039

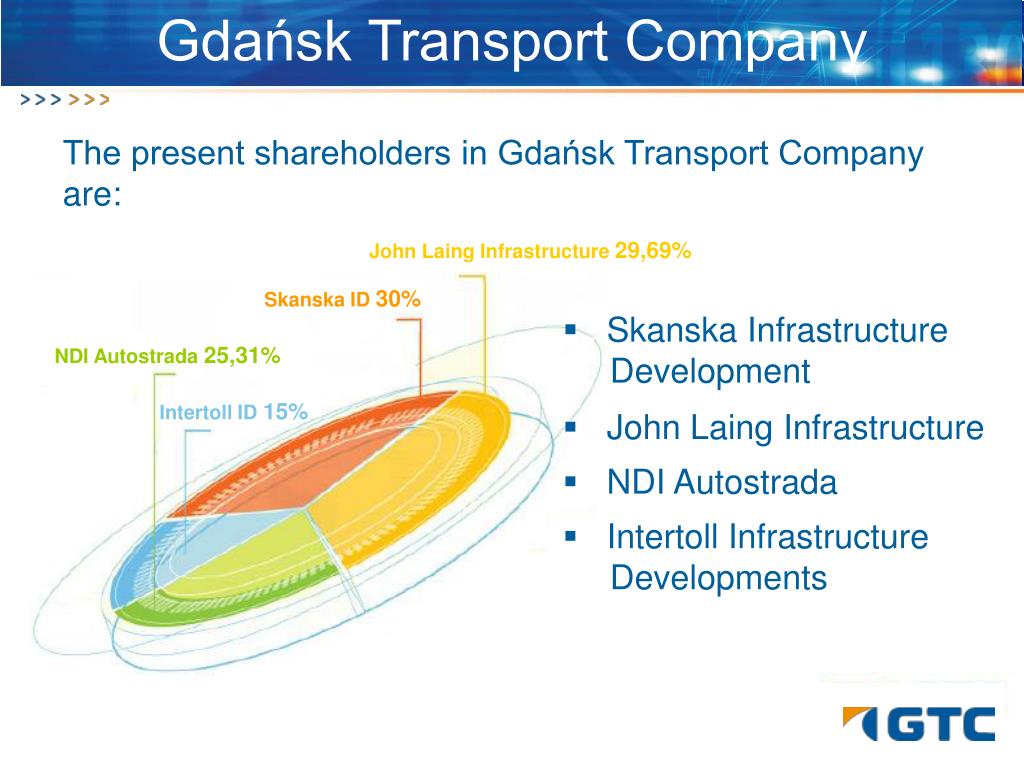

  8. Gdańsk Transport Company The present shareholders in Gdańsk Transport Company are: John Laing Infrastructure29,69% Skanska ID 30% • . Skanska Infrastructure . Development • .JohnLaing Infrastructure • . NDI Autostrada • . Intertoll Infrastructure . Developments NDI Autostrada 25,31% Intertoll ID 15%

  9. Autostrada A1 The construction of the A1 motorway is divided into two phases: • Phase 1 – 90 km stretch .of motorway between .Rusocin and Nowe .Marzy nearGrudziądz. .Completion - October 2008. • Phase 2 – planned 62 km stretch of motorway between n Nowe Marzy and Czerniewice n near Toruń. . Completion -December 2011.

  10. Phase I realisation • Construction works commenced in November 2005. • The first 25-km section Rusocin – Swarożyn was open . for traffic in December 2007. Completion of the . next 65 km of Phase 1 is scheduled for 15 October. • 3 274 643 drivers have used the motorway till now, . currently average daily traffic oscillates around 20,5 . thousand cars, the highest traffic on the A1 was . 25 603 vehicles.

  11. Project scope • Works includes construction of: • Completely new section of the . motorway from the junction Nowe . Marzy to the junction Lubicz .(51,72 km) and the bridgeover .the Vistula River. • Modernisationof partly existing. section from the junction Lubicz .toCzerniewice (10,70 km)and .finishing construction of the two .bridges over the VistulaRiver .in Toruń and Drwęca River.

  12. Project scope • Total length – 62 km • Interchanges - 5 • Toll Stations - 6 • Travellers Service Areas – 4 pairs • Motorway Maintenance Area - 1 • Engineering Structures –51 • Modernisation of existing - 15 • Environmental mitigation facilities • Road furniture

  13. A1 Motorway route Localisation of the bridge over the Vistula River near Toruń and the interchange „Czerniewice”

  14. A1 Motorway route Localisation of the MOP „Nowa Wieś” and the bridge over the Drwęca River

  15. A1 Motorway route Localisation of the interchange „Lubicz”

  16. A1 Motorway route Localisation of the interchange „Turzno”

  17. A1 Motorway route Localisation of the MOP „Nowy Dwór”

  18. A1 Motorway route Localisation of the Dźwierzyńskie Lake

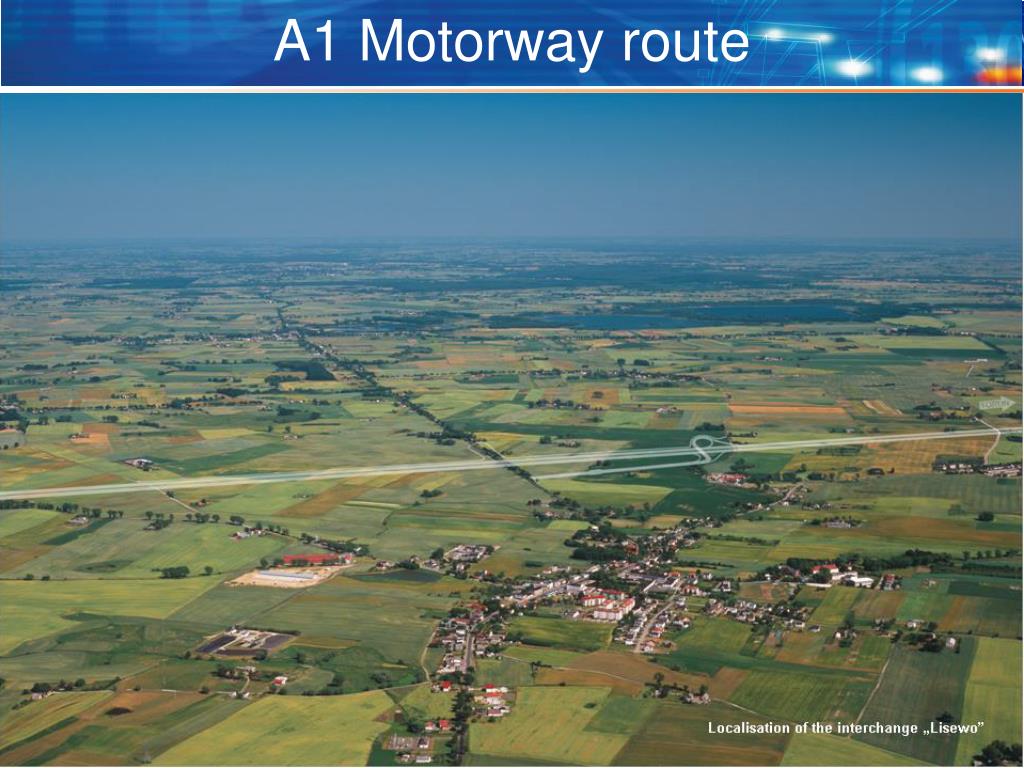

  19. A1 Motorway route

  20. A1 Motorway route

  21. Site organisation Scotland, Scandinavia South of Poland

  22. Contract structure Ministry of Infrastructure GDDKiA LendersEIB, NIB Independent EngineerWS Atkins Polska Shareholders Skanska ID, Intertoll ID, John Laing Infrastructure, NDI Autostrada Construction Law Inspectors Equipment SupplierIntertoll ID EPC ContractorSkanska -NDI Operations & MaintenanceIntertoll Polska Toll Plaza ContractorIntertoll Construction Polska

  23. www.a1.com.pl
