  1. IEEE 802.15 Working Group for Wireless Personal Area Networks (WPAN™) TG1 Opening Report March 2002 St Louis, MO USA Ian Gifford, Consultant

  2. Contents • Summary • Session #17/St Louis Overview • Objectives (see summary) • Submissions • SB3 Preliminary RevCom dispositions • Project Planning Status • Next Meeting Status • Drafting History Ian Gifford, Consultant

  3. Summary [1 of 2] • Task Group 1 (TG1) is deriving a draft standard from the Bluetooth™ specification under IEEE PAR 802.15.1 • After Session #16 the Ballot Review Committee (BRC) completed their review and resubmitted the SB3 unresolved comments report to RevCom 1Feb02. • The project will attend the 20Mar02 IEEE-SA StdBd Committee Meetings (RevCom) in Piscataway, NJ USA. • More info: • http://standards.ieee.org/board/stdsbd/meeting-notice.html Ian Gifford, Consultant

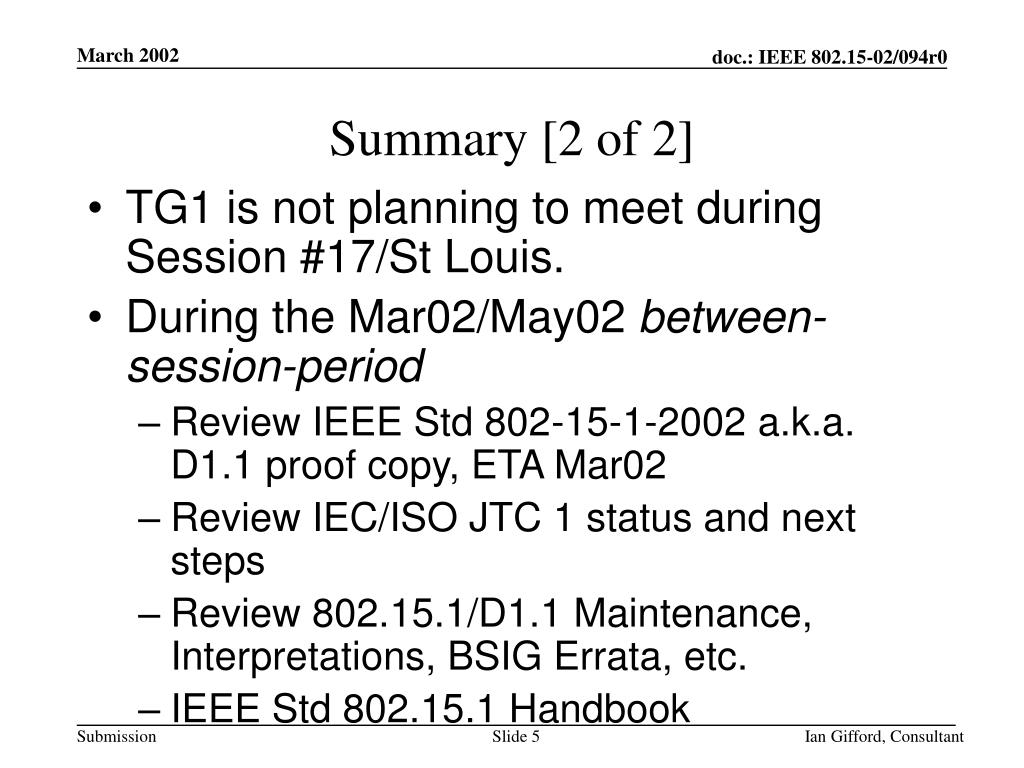

  4. Summary [2 of 2] • TG1 is not planning to meet during Session #17/St Louis. • During the Mar02/May02 between-session-period • Review IEEE Std 802-15-1-2002 a.k.a. D1.1 proof copy, ETA Mar02 • Review IEC/ISO JTC 1 status and next steps • Review 802.15.1/D1.1 Maintenance, Interpretations, BSIG Errata, etc. • IEEE Std 802.15.1 Handbook Ian Gifford, Consultant

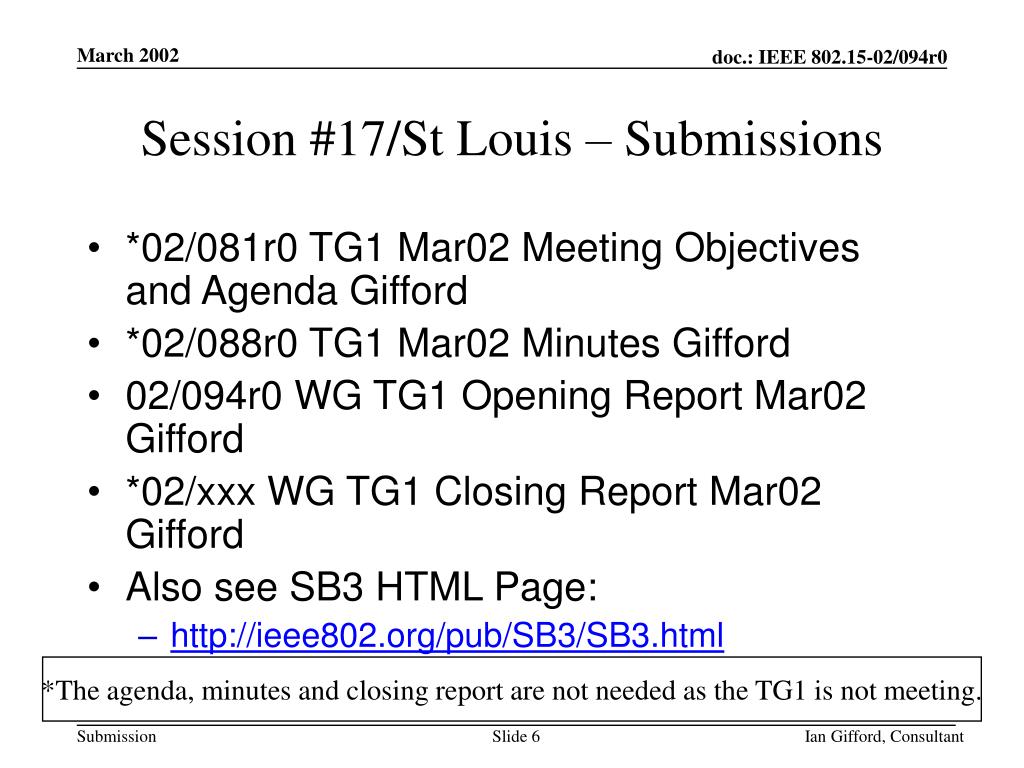

  5. Session #17/St Louis – Submissions • *02/081r0 TG1 Mar02 Meeting Objectives and Agenda Gifford • *02/088r0 TG1 Mar02 Minutes Gifford • 02/094r0 WG TG1 Opening Report Mar02 Gifford • *02/xxx WG TG1 Closing Report Mar02 Gifford • Also see SB3 HTML Page: • http://ieee802.org/pub/SB3/SB3.html *The agenda, minutes and closing report are not needed as the TG1 is not meeting. Ian Gifford, Consultant

  6. IEEE 802.15 Working Group for Wireless Personal Area Networks (WPAN™) RevCom preliminary dispositions and Project 802.15.1 next steps Ian Gifford, Consultant

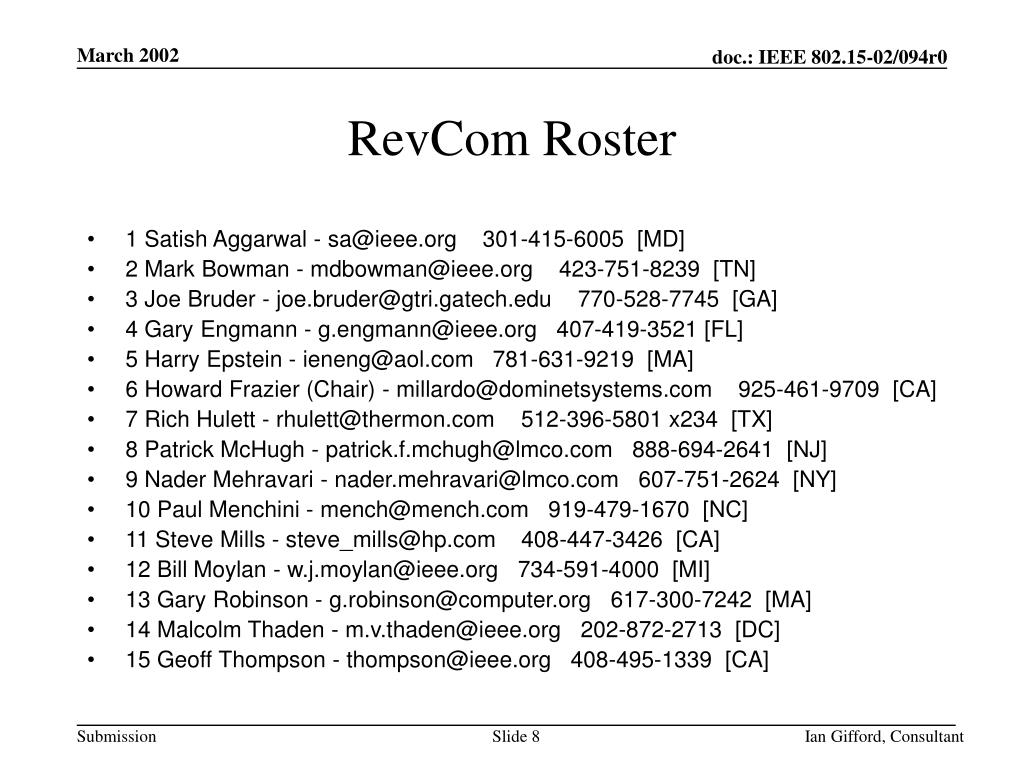

  7. RevCom Roster • 1 Satish Aggarwal - sa@ieee.org 301-415-6005 [MD] • 2 Mark Bowman - mdbowman@ieee.org 423-751-8239 [TN] • 3 Joe Bruder - joe.bruder@gtri.gatech.edu 770-528-7745 [GA] • 4 Gary Engmann - g.engmann@ieee.org 407-419-3521 [FL] • 5 Harry Epstein - ieneng@aol.com 781-631-9219 [MA] • 6 Howard Frazier (Chair) - millardo@dominetsystems.com 925-461-9709 [CA] • 7 Rich Hulett - rhulett@thermon.com 512-396-5801 x234 [TX] • 8 Patrick McHugh - patrick.f.mchugh@lmco.com 888-694-2641 [NJ] • 9 Nader Mehravari - nader.mehravari@lmco.com 607-751-2624 [NY] • 10 Paul Menchini - mench@mench.com 919-479-1670 [NC] • 11 Steve Mills - steve_mills@hp.com 408-447-3426 [CA] • 12 Bill Moylan - w.j.moylan@ieee.org 734-591-4000 [MI] • 13 Gary Robinson - g.robinson@computer.org 617-300-7242 [MA] • 14 Malcolm Thaden - m.v.thaden@ieee.org 202-872-2713 [DC] • 15 Geoff Thompson - thompson@ieee.org 408-495-1339 [CA] Ian Gifford, Consultant

  8. RevCom Preliminary dispositions, as of 8Mar02, 4pm Ian Gifford, Consultant

  9. RevCom Next Steps • The BRC can contact any member whose comment requires a reply. • We will contact Bruder to try and illicit a change from ABSTAIN to an APPROVAL vote. • We will contact McHugh and see if he has the latest SB3 Unresolved comments from SB3 report [Unresolved-comments-from-SB3.pdf] • 802.15.1 RevCom Mentor GaryR “Be sure he [McHugh] is reading the latest documents because I also do not understand his response. I thought the 802.15 responses were very well done.” dated 8Mar02. • We will deftly contact the remaining six (6) members to determine their vote i.e., Bowman, Engmann, Mehravari, Menchini, Mills, and Thompson. • The BRC will attend the 20Mar02 RevCom Meeting. Ian Gifford, Consultant

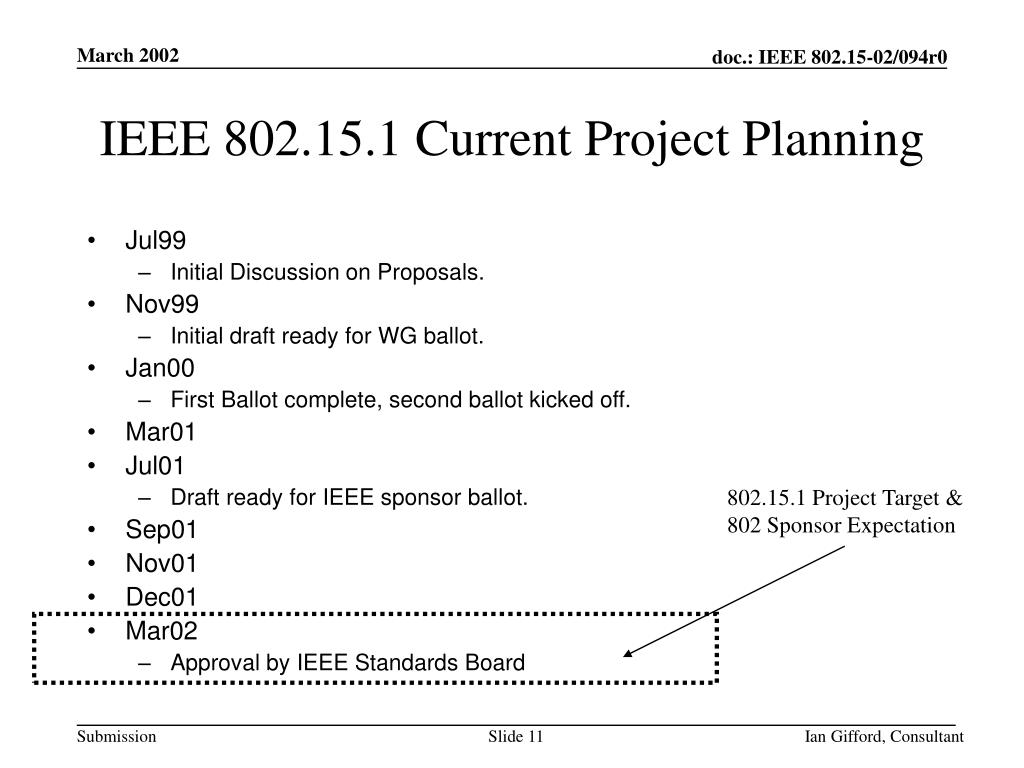

  10. IEEE 802.15.1 Current Project Planning • Jul99 • Initial Discussion on Proposals. • Nov99 • Initial draft ready for WG ballot. • Jan00 • First Ballot complete, second ballot kicked off. • Mar01 • Jul01 • Draft ready for IEEE sponsor ballot. • Sep01 • Nov01 • Dec01 • Mar02 • Approval by IEEE Standards Board 802.15.1 Project Target & 802 Sponsor Expectation Ian Gifford, Consultant

  11. Tentative Needs for May02 Interim • 13-17May02 (5 Days) • 0 People TG1 leadership is not planning to attend the May02 Plenary. Ian Gifford, Consultant

  12. IEEE 802.15 Future Meetings • May 13-17, 2002, Sydney, NSW, AU, Wentworth Sydney Hotel, Interim Meeting. • July 8-11, 2002 Vancouver, BC Canada, Hyatt Regency, 802 Plenary Meeting. • September 9-13, 2002, Hyatt Regency Monterey, 802.15 Interim Meeting. • November 11-14, 2002 Koloa, HI USA, Hyatt Regency Kauai, 802 Plenary Meeting. • More Info: • http://ieee802.org/15/pub/Meeting_Plan.html • http://ieee802.org/meeting/ Ian Gifford, Consultant

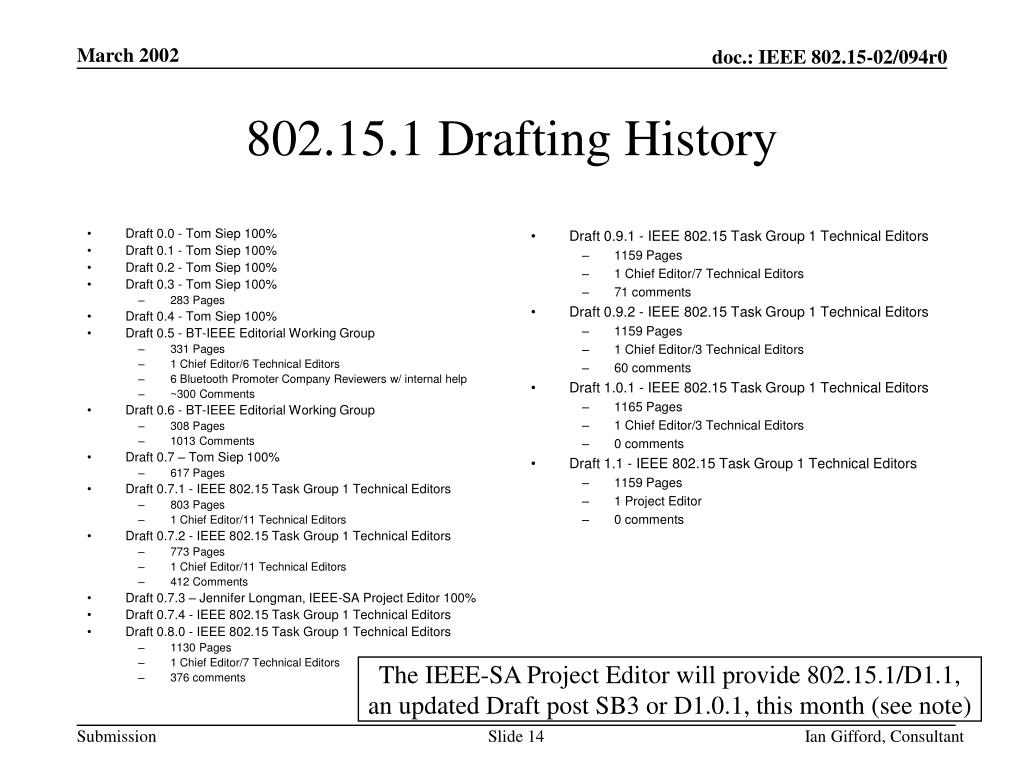

  13. Draft 0.0 - Tom Siep 100% Draft 0.1 - Tom Siep 100% Draft 0.2 - Tom Siep 100% Draft 0.3 - Tom Siep 100% 283 Pages Draft 0.4 - Tom Siep 100% Draft 0.5 - BT-IEEE Editorial Working Group 331 Pages 1 Chief Editor/6 Technical Editors 6 Bluetooth Promoter Company Reviewers w/ internal help ~300 Comments Draft 0.6 - BT-IEEE Editorial Working Group 308 Pages 1013 Comments Draft 0.7 – Tom Siep 100% 617 Pages Draft 0.7.1 - IEEE 802.15 Task Group 1 Technical Editors 803 Pages 1 Chief Editor/11 Technical Editors Draft 0.7.2 - IEEE 802.15 Task Group 1 Technical Editors 773 Pages 1 Chief Editor/11 Technical Editors 412 Comments Draft 0.7.3 – Jennifer Longman, IEEE-SA Project Editor 100% Draft 0.7.4 - IEEE 802.15 Task Group 1 Technical Editors Draft 0.8.0 - IEEE 802.15 Task Group 1 Technical Editors 1130 Pages 1 Chief Editor/7 Technical Editors 376 comments Draft 0.9.1 - IEEE 802.15 Task Group 1 Technical Editors 1159 Pages 1 Chief Editor/7 Technical Editors 71 comments Draft 0.9.2 - IEEE 802.15 Task Group 1 Technical Editors 1159 Pages 1 Chief Editor/3 Technical Editors 60 comments Draft 1.0.1 - IEEE 802.15 Task Group 1 Technical Editors 1165 Pages 1 Chief Editor/3 Technical Editors 0 comments Draft 1.1 - IEEE 802.15 Task Group 1 Technical Editors 1159 Pages 1 Project Editor 0 comments 802.15.1 Drafting History The IEEE-SA Project Editor will provide 802.15.1/D1.1, an updated Draft post SB3 or D1.0.1, this month (see note) Ian Gifford, Consultant
