Monthly TCR Calculation DRAFT 3

DESCRIPTION

Monthly TCR Calculation DRAFT 3. James J. Teixeira 05/11/02 Also review ERCOT Protocols Section 7 for more details and additional data. Process Overview. SSWG Case Selection. Outage Scheduler Query for Study Month to CSV. PSSE. Apply IDEV’s. MS Access – Filter outages to be considered.

1 / 20

Télécharger la présentation

Monthly TCR Calculation DRAFT 3

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. MonthlyTCR CalculationDRAFT 3 James J. Teixeira 05/11/02 Also review ERCOT Protocols Section 7 for more details and additional data

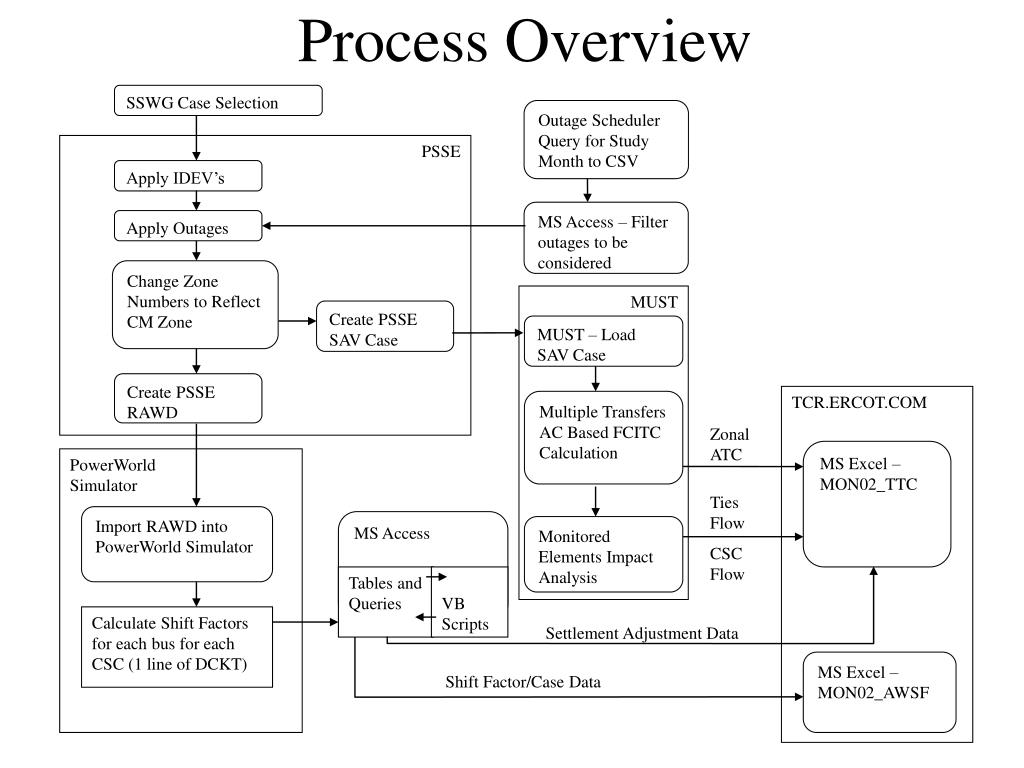

  2. Process Overview SSWG Case Selection Outage Scheduler Query for Study Month to CSV PSSE Apply IDEV’s MS Access – Filter outages to be considered Apply Outages Change Zone Numbers to Reflect CM Zone MUST Create PSSE SAV Case MUST – Load SAV Case Create PSSE RAWD TCR.ERCOT.COM Multiple Transfers AC Based FCITC Calculation Zonal ATC MS Excel – MON02_TTC PowerWorld Simulator Ties Flow Import RAWD into PowerWorld Simulator MS Access Monitored Elements Impact Analysis CSC Flow Tables and Queries VB Scripts Calculate Shift Factors for each bus for each CSC (1 line of DCKT) Settlement Adjustment Data MS Excel – MON02_AWSF Shift Factor/Case Data

  3. Process Overview • Outage Scheduler • PSSE Version 26.2.3 (Moving to Version 28) • Apply Outages • Change Zone Numbers to CM Zone Number • PowerWorld Simulator Version 8.0 • Calculate raw Shift Factors • Copy/Paste raw Shift Factor and Bus Data to MS Access

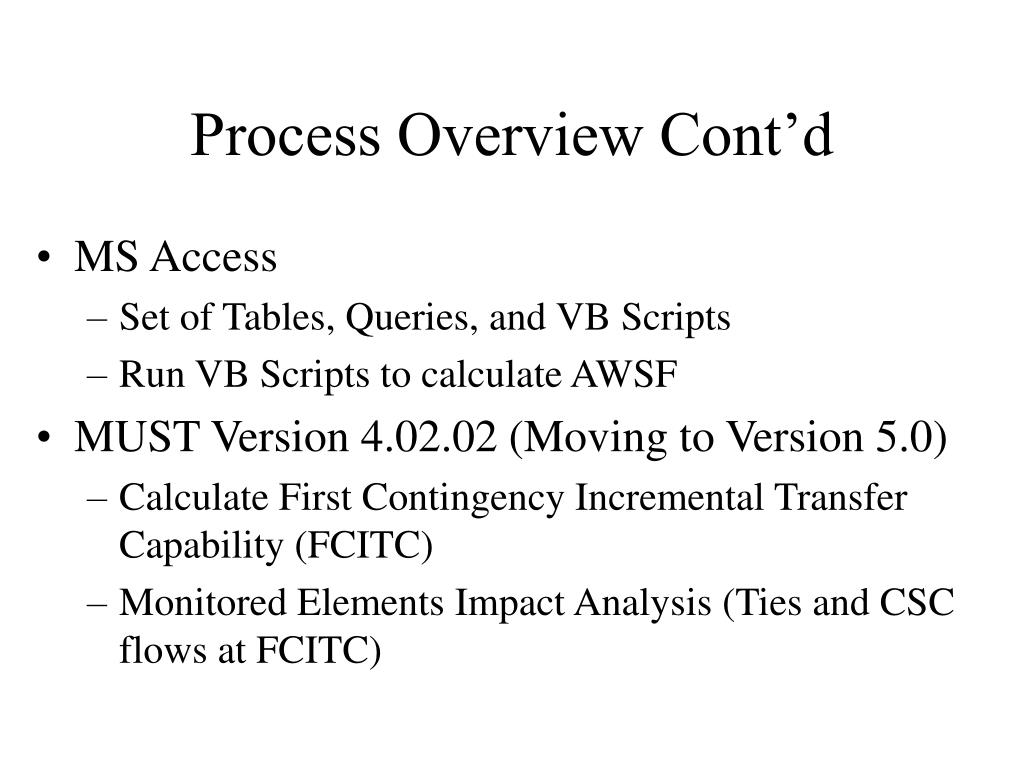

  4. Process Overview Cont’d • MS Access • Set of Tables, Queries, and VB Scripts • Run VB Scripts to calculate AWSF • MUST Version 4.02.02 (Moving to Version 5.0) • Calculate First Contingency Incremental Transfer Capability (FCITC) • Monitored Elements Impact Analysis (Ties and CSC flows at FCITC)

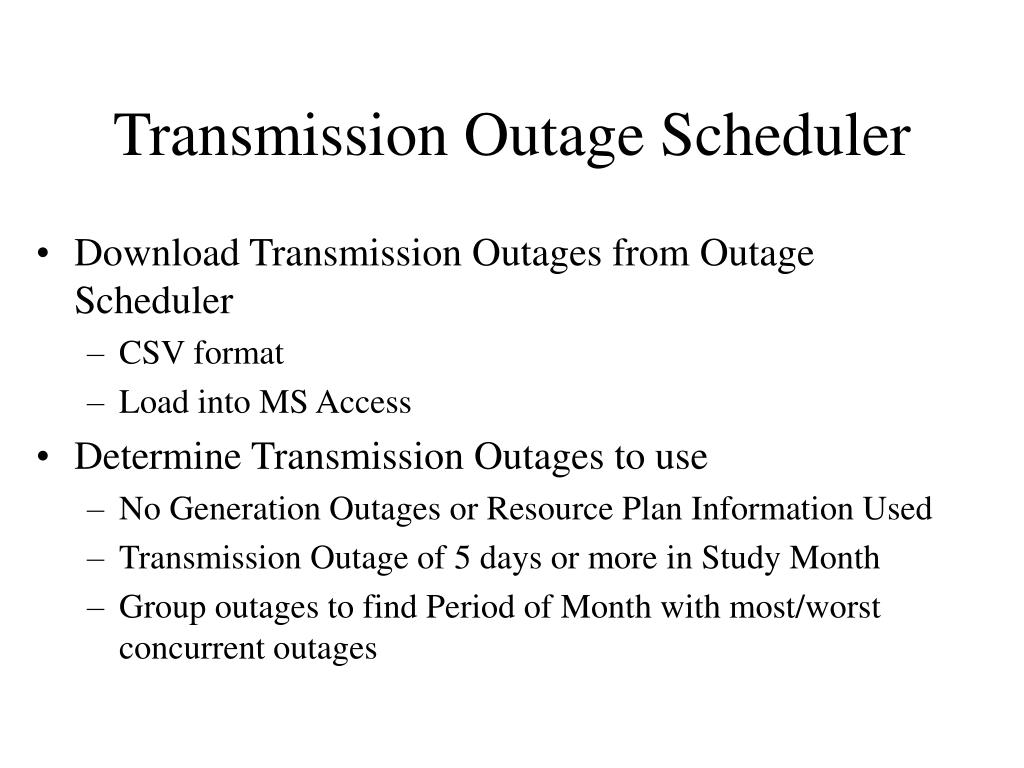

  5. Transmission Outage Scheduler • Download Transmission Outages from Outage Scheduler • CSV format • Load into MS Access • Determine Transmission Outages to use • No Generation Outages or Resource Plan Information Used • Transmission Outage of 5 days or more in Study Month • Group outages to find Period of Month with most/worst concurrent outages

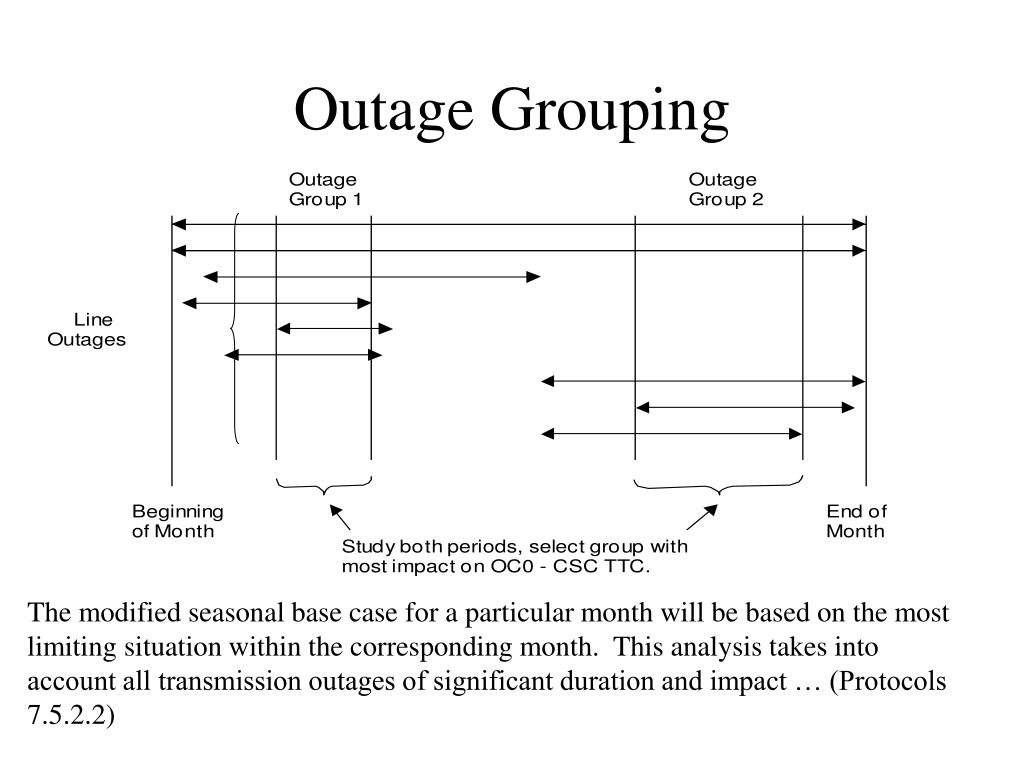

  6. Outage Grouping The modified seasonal base case for a particular month will be based on the most limiting situation within the corresponding month. This analysis takes into account all transmission outages of significant duration and impact … (Protocols 7.5.2.2)

  7. PSSE • Determine PSSE Seasonal SSWG On Peak Base Case to use • Apply Applicable IDEV’s to Base Case to apply latest transmission updates to case • Supplied by TDSP’s • Apply Selected Transmission Outages to Base Case • Change Zone Numbers in Base Case with applied outages to CM Zone numbers • Solve, Save, and Create RAWD • Case also provides Online Generation Level for AWSF

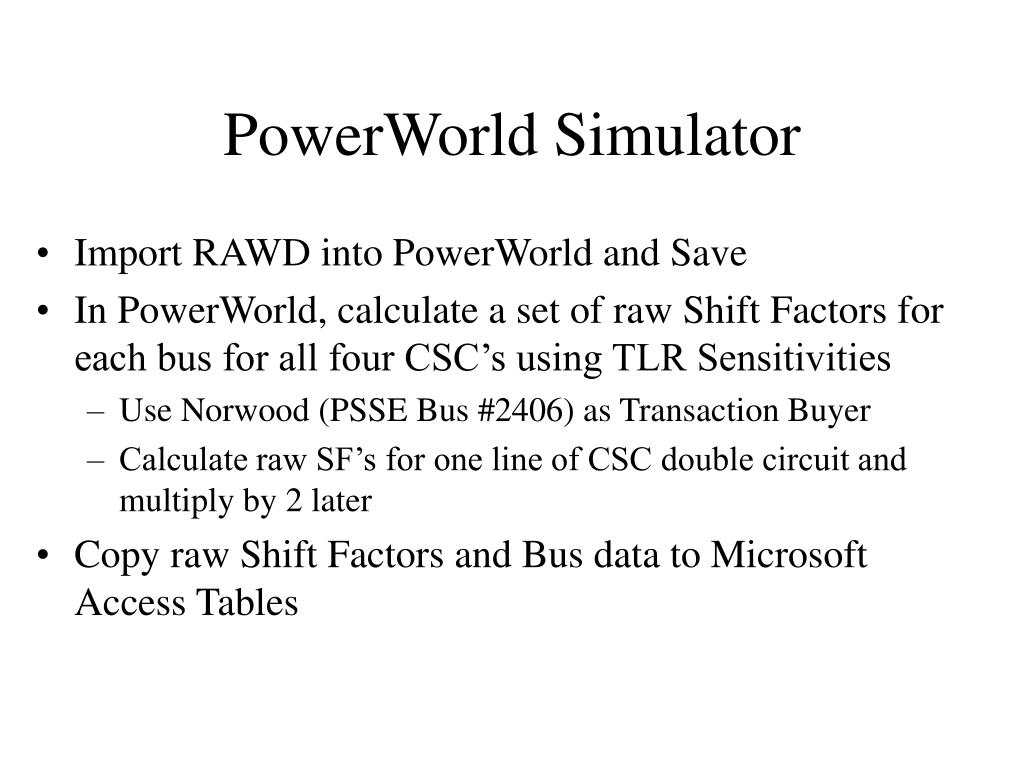

  8. PowerWorld Simulator • Import RAWD into PowerWorld and Save • In PowerWorld, calculate a set of raw Shift Factors for each bus for all four CSC’s using TLR Sensitivities • Use Norwood (PSSE Bus #2406) as Transaction Buyer • Calculate raw SF’s for one line of CSC double circuit and multiply by 2 later • Copy raw Shift Factors and Bus data to Microsoft Access Tables

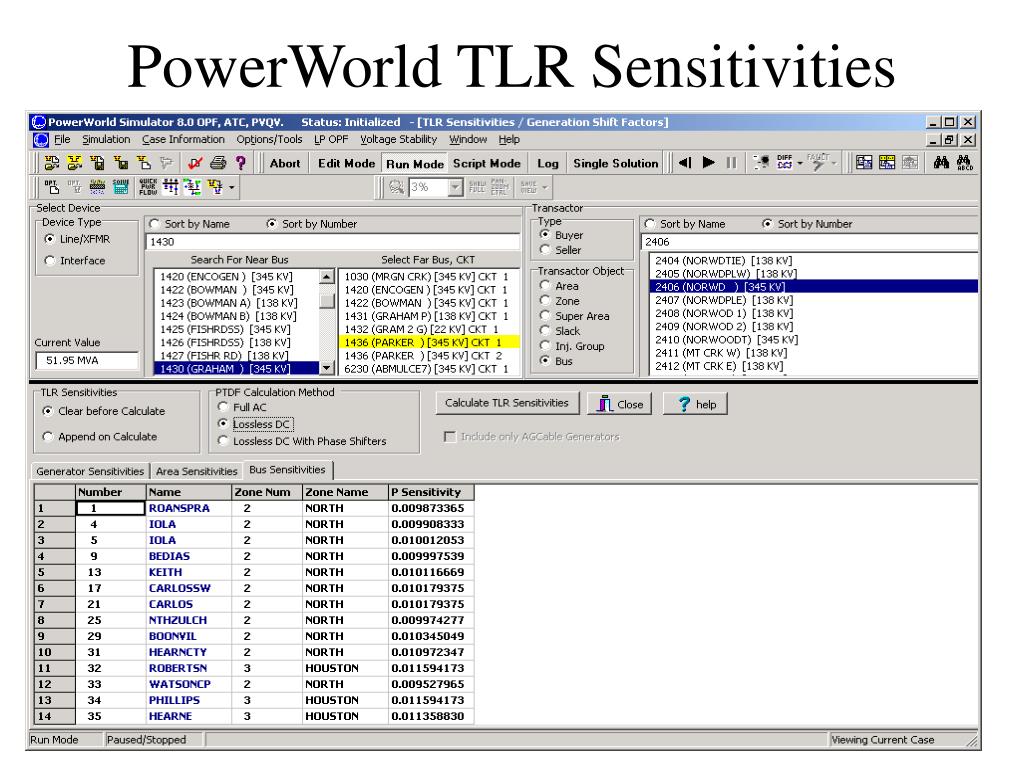

  9. PowerWorld TLR Sensitivities

  10. MS Access • Run VB scripts to calculate all data found in MON02_AWSF.xls • Summation of Weighted Shift Factors • Average Weighted Shift Factors • Min, Max, Average, Std Deviation • In MON02_AWSF.xls, run VB script to move data from Access to Excel

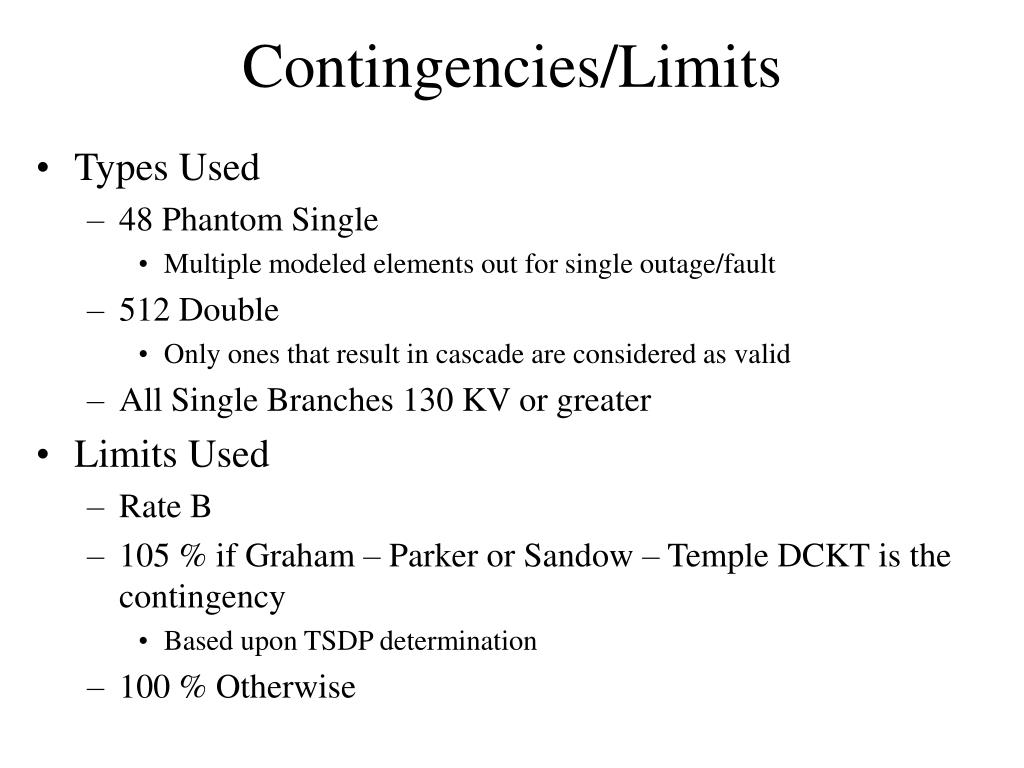

  11. Contingencies/Limits • Types Used • 48 Phantom Single • Multiple modeled elements out for single outage/fault • 512 Double • Only ones that result in cascade are considered as valid • All Single Branches 130 KV or greater • Limits Used • Rate B • 105 % if Graham – Parker or Sandow – Temple DCKT is the contingency • Based upon TSDP determination • 100 % Otherwise

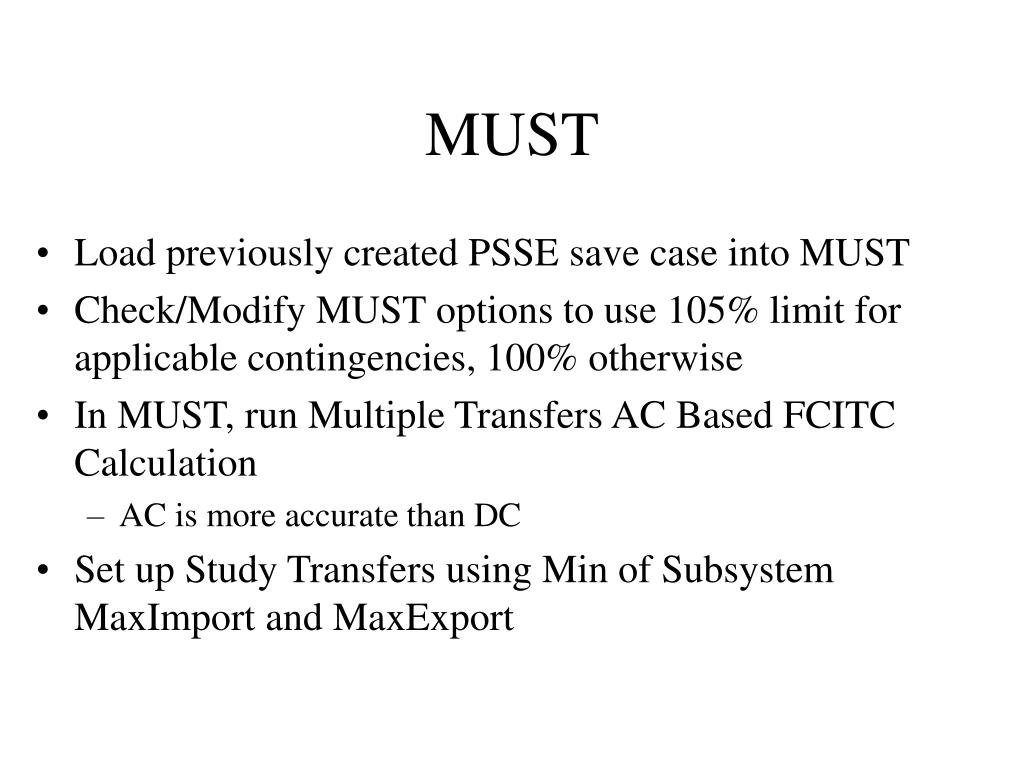

  12. MUST • Load previously created PSSE save case into MUST • Check/Modify MUST options to use 105% limit for applicable contingencies, 100% otherwise • In MUST, run Multiple Transfers AC Based FCITC Calculation • AC is more accurate than DC • Set up Study Transfers using Min of Subsystem MaxImport and MaxExport

  13. MUST Cont’d • Calculate Study Transfers • Examine AC FCITC Multiple Transfers Report to determine lowest AC FCITC where the limiting element is a CRE or the Contingency is a CRE (Protocol 7.5.2) • This number is the Zonal ATC found in MON02_TTC.xls

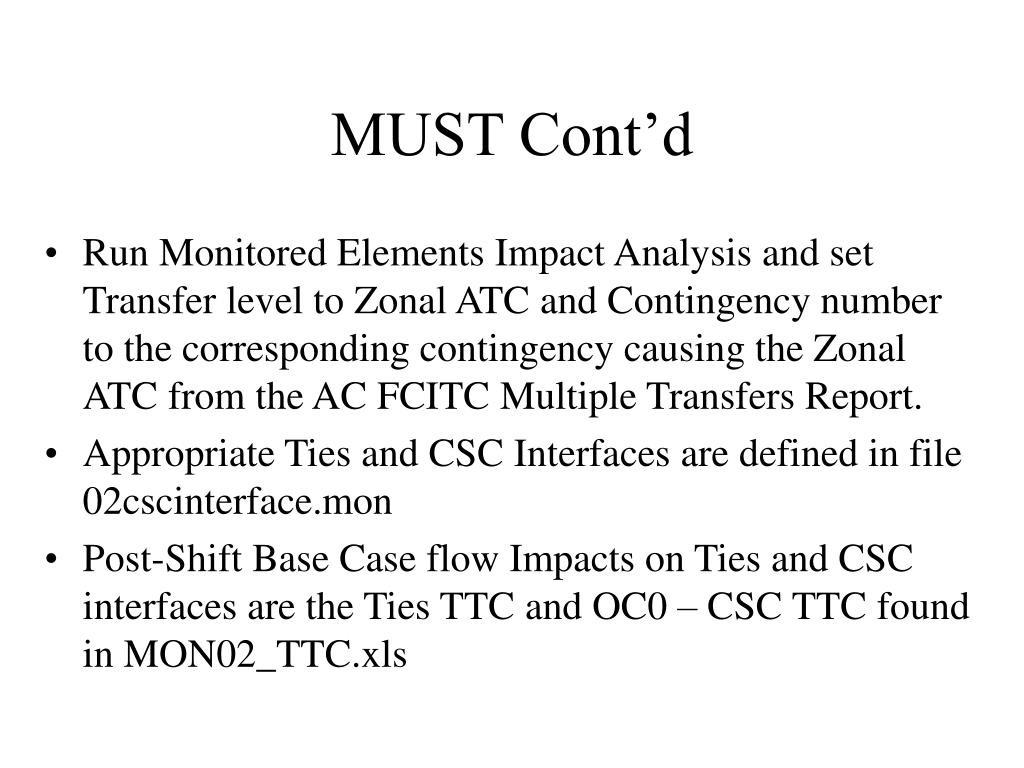

  14. MUST Cont’d • Run Monitored Elements Impact Analysis and set Transfer level to Zonal ATC and Contingency number to the corresponding contingency causing the Zonal ATC from the AC FCITC Multiple Transfers Report. • Appropriate Ties and CSC Interfaces are defined in file 02cscinterface.mon • Post-Shift Base Case flow Impacts on Ties and CSC interfaces are the Ties TTC and OC0 – CSC TTC found in MON02_TTC.xls

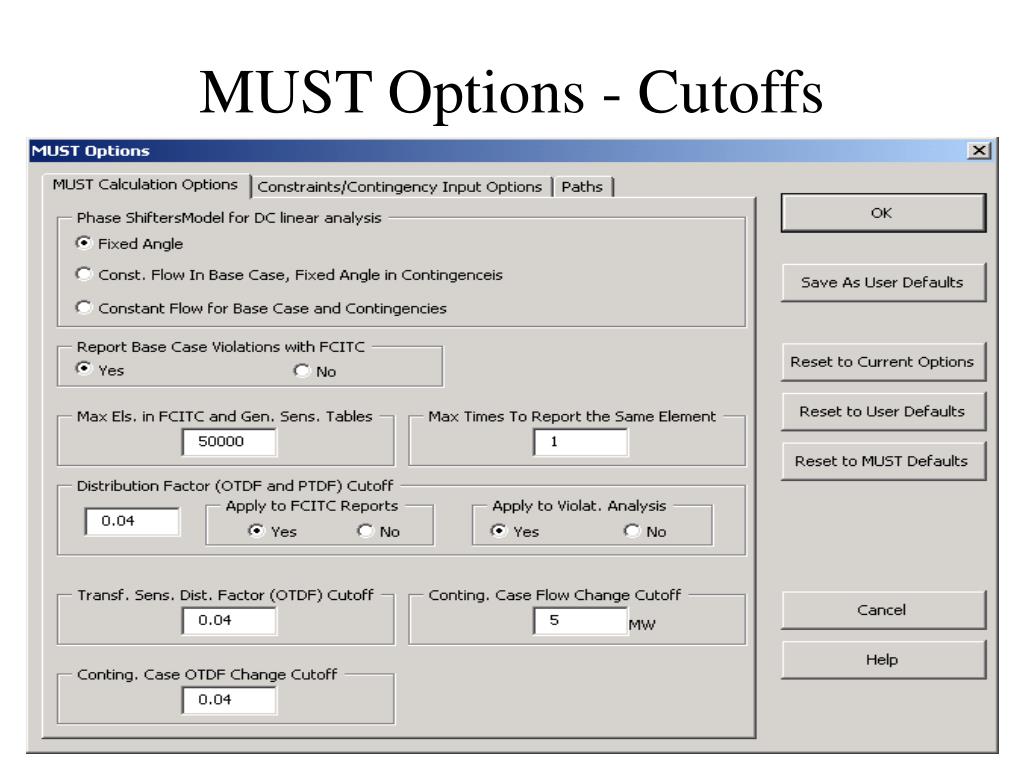

  15. MUST Options - Cutoffs

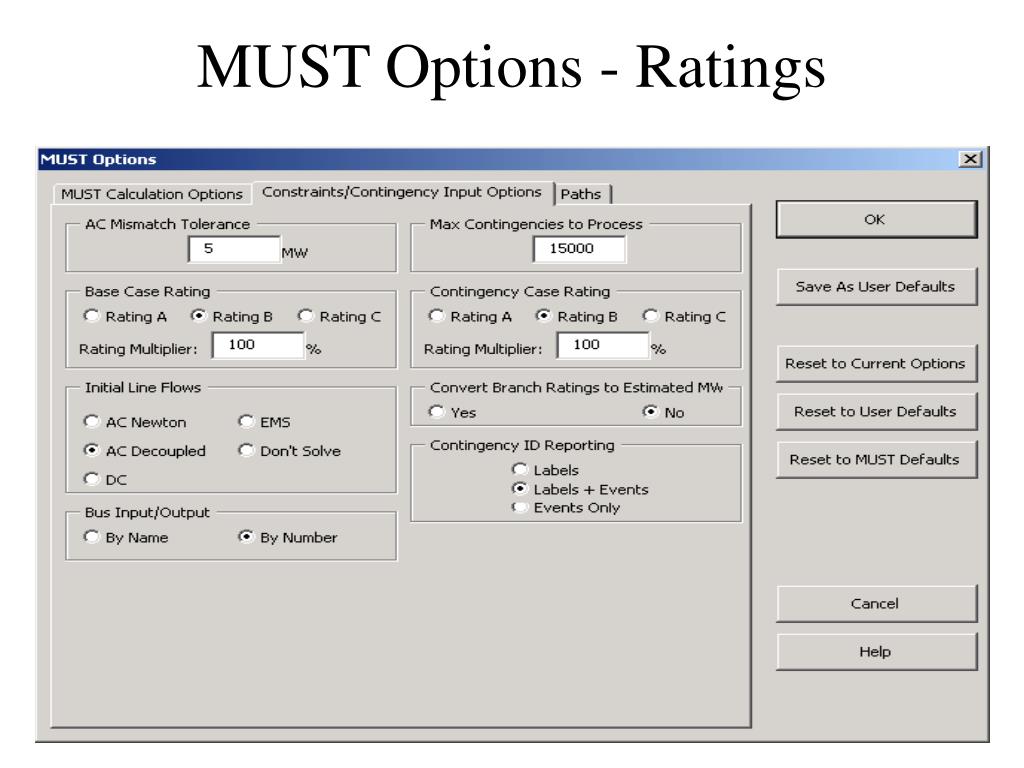

  16. MUST Options - Ratings

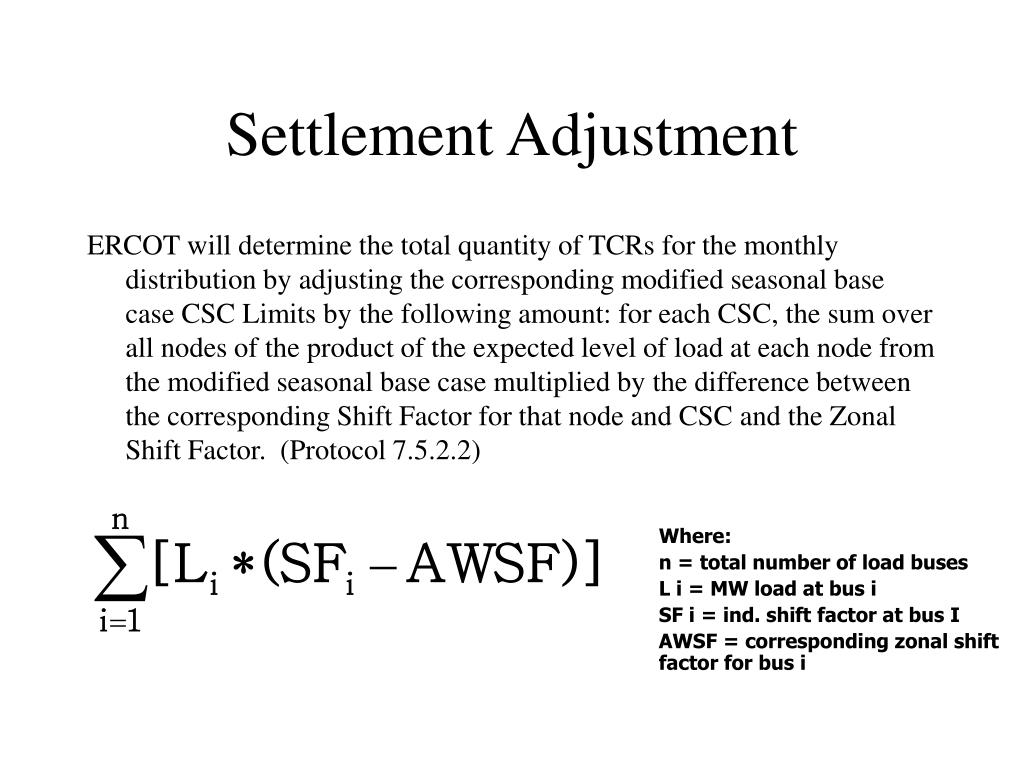

  17. Settlement Adjustment ERCOT will determine the total quantity of TCRs for the monthly distribution by adjusting the corresponding modified seasonal base case CSC Limits by the following amount: for each CSC, the sum over all nodes of the product of the expected level of load at each node from the modified seasonal base case multiplied by the difference between the corresponding Shift Factor for that node and CSC and the Zonal Shift Factor. (Protocol 7.5.2.2) Where: n = total number of load buses L i = MW load at bus i SF i = ind. shift factor at bus I AWSF = corresponding zonal shift factor for bus i

  18. TCR Calculation Results

  19. Posted Information • TCR.ERCOT.COM • PTI PSSE save case and RAWD • MUST configuration files • MON02_AWSF.xls • MON02_TTC.xls • MON02_IM.xls & MON02LoadMappingCMzones.xls • CSC Development Information at WWW.ERCOT.COM/Participants/CSC/

  20. Questions?
