Resource Management Chapter 12 © 2007 Pearson Education
Types of Constraints • Technical • Physical • Resource • Materials • Human resources • Time • Mixed
Resource Loading The amounts of individual resources that a schedule requires during specific time periods. Resource loading table
Resource Leveling (Smoothing) A multivariate, combinatorial problem Objectives • To determine the resource requirements so that they will be available at the right time • To allow each activity to be scheduled with the smoothest possible transition across resource usage levels
Prioritization Rules for Leveling • Smallest amount of slack • Smallest duration • Lowest ID number (FCFS) • Greatest number of successor tasks • Requiring the most resources
Resource leveling(method one) • Develop resource leveling table • Determine activity Late finish dates • Identify resource Over allocation • Level the resource loading table • Requires more than one run-through due to ripple effects • Examine conflicts (apply rules) • Select activity to be reconfigured • Start over looking for more conflicts

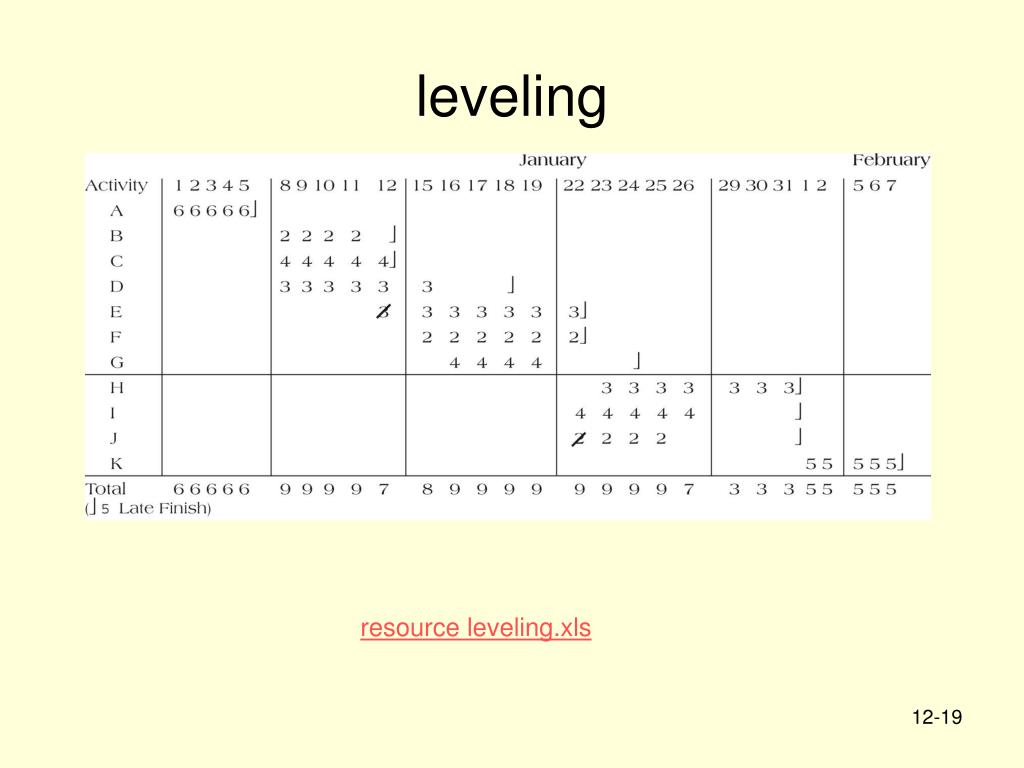

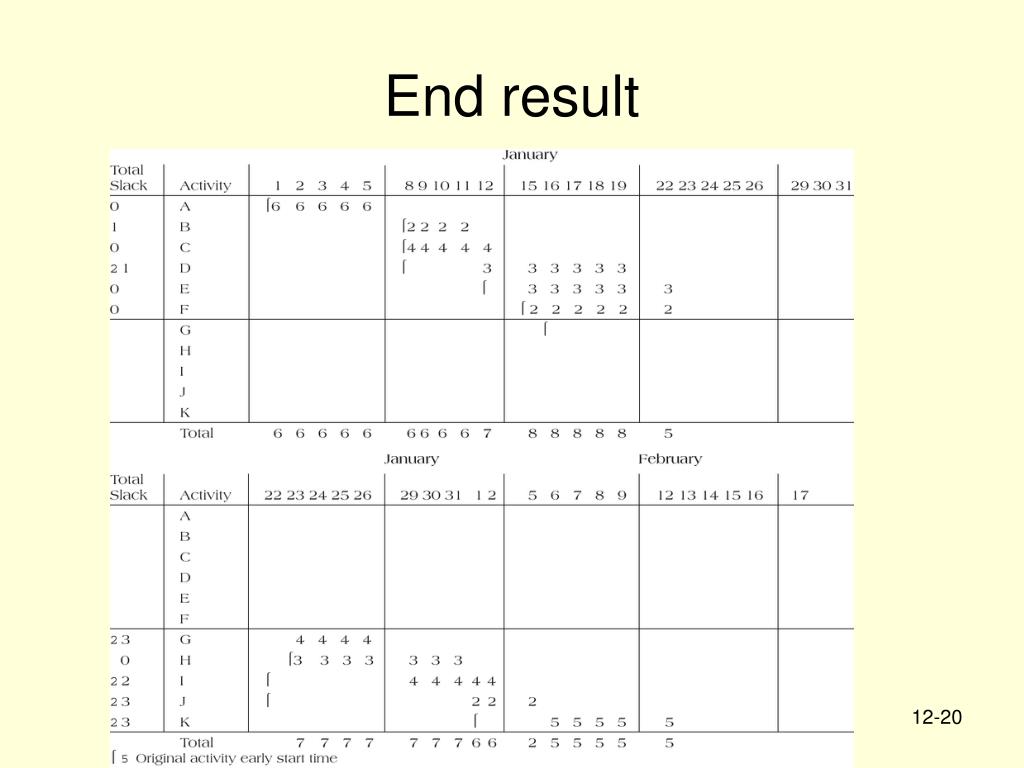

leveling resource leveling.xls
A much better Way • Use MS Project • Enter resources • Assign resources to tasks • Use Resource leveling tool • Sample resource leveling.mpp
Resource Loading chartsMethod two • Create a project activity network diagram • Develop resource loading table • Determine activity late finish dates • Identify resource over allocation • Resource level the loading table

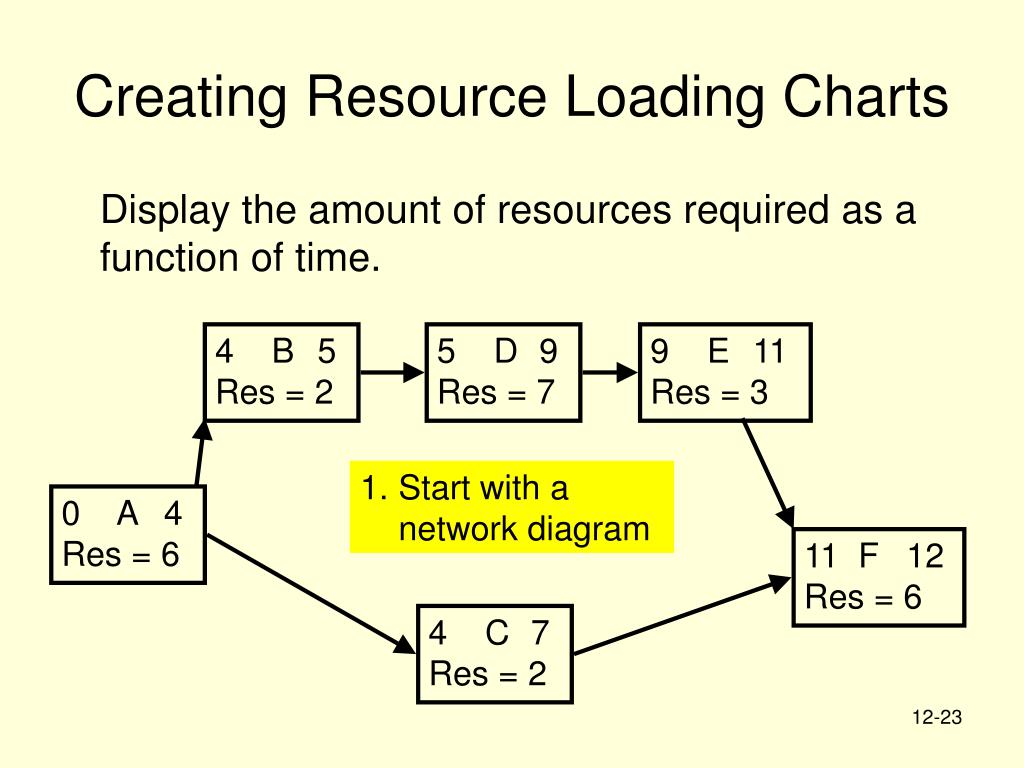

4 B 5 Res = 2 5 D 9 Res = 7 9 E 11 Res = 3 0 A 4 Res = 6 11 F 12 Res = 6 4 C 7 Res = 2 Creating Resource Loading Charts Display the amount of resources required as a function of time. • Start with a network diagram
Creating Resource Loading Charts • Produce a table that shows the duration, early start, late finish, slack, and resource(s) required for each activity.
8 6 Resources D 4 A F B E 2 C 2 4 6 8 10 12 14 Project Days Creating Resource Loading Charts • Draw an initial loading chart with each activity scheduled at its ES. Resource imbalance

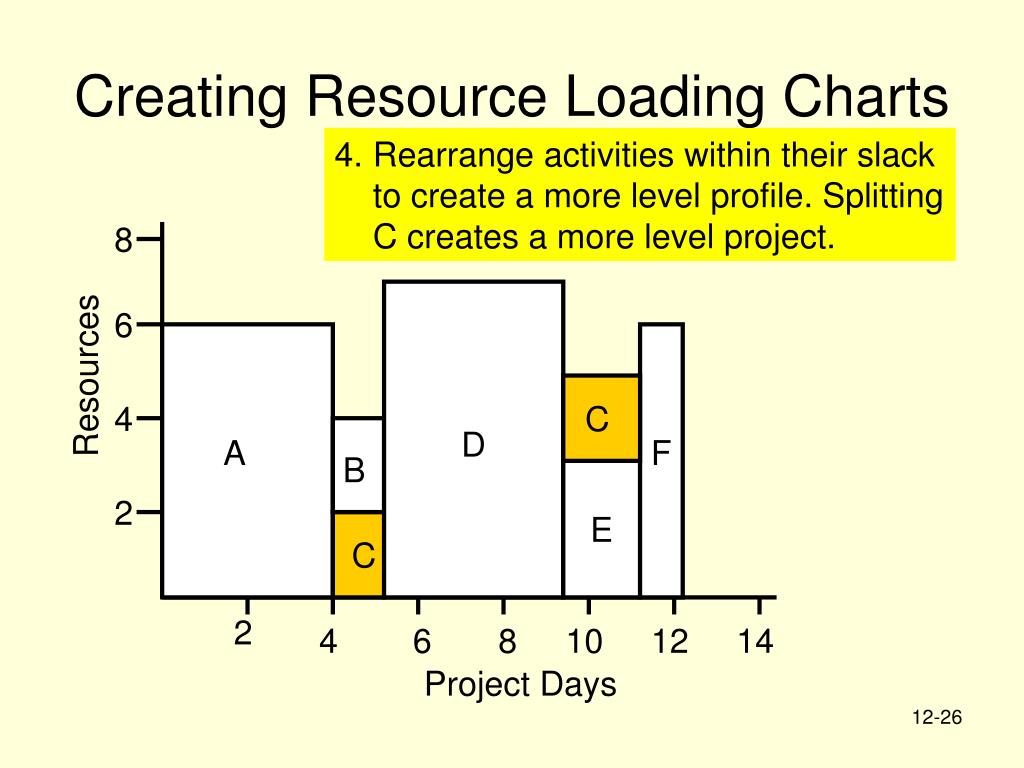

8 6 Resources D 4 A C F B E 2 C 2 4 6 8 10 12 14 Project Days Creating Resource Loading Charts • Rearrange activities within their slack to create a more level profile. Splitting C creates a more level project.

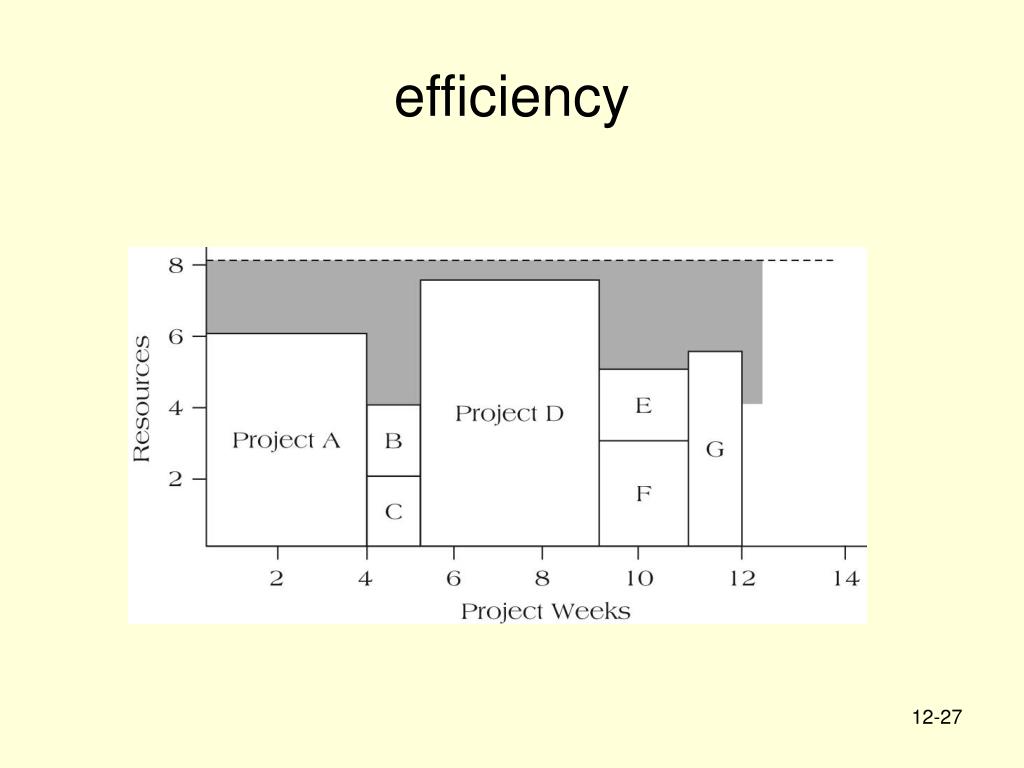

Key Parameters in Multi-Project Environments • Schedule slippage • Possible $ penalty • Resource utilization • More efficient is better • In-process inventory • Reduce back log
Prioritizing Resource Allocations in Multi-Project Environments • First come first served • Greatest resource demand • Greatest resource utilization • Minimum late finish time • Mathematical programming
