1 / 27

Energy Science Building General Construction Pre-Proposal Meeting Argonne, Illinois

Energy Science Building General Construction Pre-Proposal Meeting Argonne, Illinois. April 6, 2011 http://www.anl.gov/esb/. Outline. Introduction Instructions to Offerors Scope of Work Project Schedule Payment Process Safety/Insurance Project Approach Questions & Answers Closing

rocco
Télécharger la présentation

Energy Science Building General Construction Pre-Proposal Meeting Argonne, Illinois

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Energy Science BuildingGeneral Construction Pre-Proposal MeetingArgonne, Illinois April 6, 2011 http://www.anl.gov/esb/

  2. Outline • Introduction • Instructions to Offerors • Scope of Work • Project Schedule • Payment Process • Safety/Insurance • Project Approach • Questions & Answers • Closing • Site Visit UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  3. Introduction • Prequalified Contractors • Barton Malow Company • Clark Construction Group, LLC • Gilbane Building Company • Power Construction Company, LLC • Ragnar Benson Construction • Walsh Construction UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  4. Introduction • Team Members • George Paliulionis – DOE Federal Project Director • Angela Harvey – DOE Deputy Federal Project Director • Karen Hellman – Argonne Project Director • Jeff Sims – Argonne Project Manager • John Szott – Argonne Deputy Project Manager • Pat Hogan – Argonne Construction Manager • Anne Frankowski - Argonne Supervisor Contracts UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  5. Introduction • Roles & Responsibilities • Architect – HDR Architecture, Inc. • Civil Engineer – Mackie Consultants LLC • Commissioning Agent – KJWW Engineering Consultants • Building Envelope Commissioning – Wiss, Janney, Elstner Associates, Inc. • Construction Manager – Jacobs • Materials Testing - TBD UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  6. RFP Mandatory Requirements • Evidence required with response to RFP • Proposed Project Manager • - At least 15 Years Experience • - At least 3 Completed Projects of Similar Type • - Completed Projects with Storm Water Pollution Prevention Plan (SWPPP) • - Governmental Project Experience • - OSHA 30-Hour Training Course • Proposed Superintendent • - At least 20 Years Experience • - At least 5 Completed Projects of Similar Type • - Completed Projects with Storm Water Pollution Prevention Plan (SWPPP) • - Governmental Project Experience • - OSHA 30-Hour Training Course UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  7. RFP Mandatory Requirements • Proposed Safety Manager • - At least 15 Years Construction Industry Experience • - Certified Safety Professional or comparable professional registration • - At least 5 Completed Projects with Safety incentive Programs • - Completed Projects with Storm Water Pollution Prevention Plan (SWPPP) • Proposed MEP Subcontractor • - At least 10 Years Experience within the past 12 years with construction of laboratories (with a project value of $15MM or greater). • Proposed Scheduler • - At least 3 Years Experience with CPM Scheduling Applications • - At least 2 Completed Projects as Scheduler of Similar Type • Attendance at Pre-Proposal Meeting UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  8. RFP Evaluation of Additive Alternates • Lowest Responsive Responsible Offeror based on Funds Available • Example (Funding Available of $1,500,000) • Contractor 1Contractor 2Contractor 3 • Base Proposal $1,000,000 $850,000 $1,5000,000 • Alternate 1 $500,000 $300,000 No Evaluation • Alternate 2 No Evaluation$350,000No Evaluation • Total $1,500,000 $1,500,000 $1,5000,00 • Based on funding available at time of proposal opening, Contractor 2 is identified as the apparent low offeror and awarded the project. • Proposals maybe rejected if deemed materially unbalanced UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  9. RFP Time & Material Rates / Unit Prices • All-Inclusive (i.e. shall include costs for labor, supervision, material, equipment, bond, overhead, profit, etc.). • Not Utilized for determining “Low-Offeror” • Offeror shall provide rates for the following labor types: • Carpenter Electrician Iron Worker • Laborer Operator Plumber • Pipefitter Glazier Insulator Mason • Painter Roofer Cement Finisher • Sheet Metal Worker Low Voltage Electrician • Refer to Technical Specifications for details regarding Unit Price work. UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  10. Explanation or Interpretation of RFP Documents • All requests shall be submitted in writing by close of business, Wednesday, April 20, 2011. UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  11. RFP Davis-Bacon Compliance • The minimum wages paid laborers and mechanics engaged in construction work within the scope of this request shall be in accordance with the Department of Labor minimum wage determination. • Refer to Paragraph VII – D-B Compliance of the RFP document for additional information. UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  12. RFP Safety Performance Requirements • Offerors must complete and submit with its proposal the Contractor Safety Questionnaire, PFS-525 (March 8, 2011) UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  13. RFP Subcontracting Plan • Required to be submitted by Successful Offeror • Intent to include Small, Disadvantaged and Women-Owned Businesses on the ESB Project • The Statutory ESB Project Goals are: • - 23% Small Businesses • - 5% Small Disadvantaged Businesses • - 5% Women-Owned Small Businesses • - 3% Hub-Zone Businesses • - 3% Service-Disabled Veteran-Owned Small Businesses • Reference the Small Business Model Subcontracting Plan included with the RFP for details. UChicago Argonne, LLC |ESB Pre-Proposal Meeting, April 6, 2011

  14. RFP Performance & Payment Bonds • Required to be submitted by Successful Offeror within 10 calendar days of the effective date of the Contract • Payment Bond on Argonne Form (Enclosure 1.H) • Performance Bond on Argonne Form (Enclosure 1.I) • Include all costs for Performance & Payment Bonds in the Proposal Amount. UChicago Argonne, LLC |ESB Pre-Proposal Meeting, April 6, 2011

  15. RFP Proposal Submittals • Evidence for Mandatory Requirements (Resumes, etc.) • Proposal Form, dated March 8, 2011 (Enclosure 1.N) • List of Subcontractors, dated December 7, 2010 (Enclosure 1.O) • Time & Materials Rates, dated January 13, 2011 (Enclosure 1.L) • Unit Prices, dated March 8, 2011 (Enclosure 1.M) • Workplace Substance Abuse Programs at DOE Sites Certification of Compliance (Enclosure 1.S) • Pre Award Information Booklet, including Booklet of Representations & Certifications (Enclosure 2) • Contractor Safety Questionnaire, PFS-525 (Enclosure 3) UChicago Argonne, LLC |ESB Pre-Proposal Meeting, April 6, 2011

  16. RFP Proposal Date / Time / Location • Date – Wednesday, May 4, 2011 • Time – On or before 3:00 P.M., Local Prevailing Time • Location - Argonne National Laboratory • Building 201, OCF-PRO • 9700 South Cass Avenue • Lemont, IL 60439 • Attn: Anne Frankowski • Reference - RFP No. 1-AF61-P-00092-00 UChicago Argonne, LLC |ESB Pre-Proposal Meeting, April 6, 2011

  17. Project Scope • General Construction • - Telecommunications • - Laboratory Equipment • - Laboratory Furnished/Laboratory Installed Items • BIM • - Provided for Proposal • - Updated and Provided to Successful Contractor • - Contract Closeout Expectations UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  18. Project Schedule • Contract Award on or about June 10, 2011 • Construction Start ~ August 2011 • Construction Substantial Completion (Beneficial Occupancy) by June 30, 2013 • Final Completion three (3) months after BO • Construction Duration - 23 Months UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  19. Payment Process • Availability of Funds Clause • - Funds Available FY11 - $11,000,000 • Funds Available FY12 - $32,000,000 • Tax Exempt Project • Progress Payment Retainage – 10% • Cost Loaded P6 Schedule • Earned Value Reporting UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  20. Safety / Insurance • Safety Guide • Safety Incentive Plan • Safety Questionnaire • Conventional Insurance UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

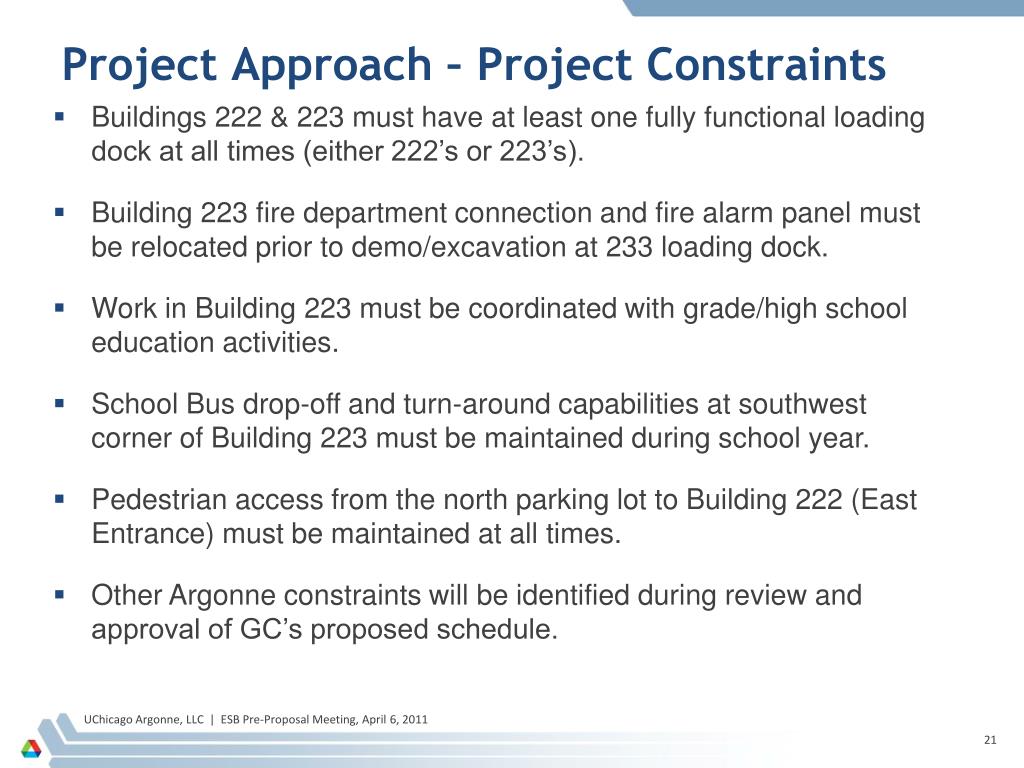

  21. Project Approach – Project Constraints • Buildings 222 & 223 must have at least one fully functional loading dock at all times (either 222’s or 223’s). • Building 223 fire department connection and fire alarm panel must be relocated prior to demo/excavation at 233 loading dock. • Work in Building 223 must be coordinated with grade/high school education activities. • School Bus drop-off and turn-around capabilities at southwest corner of Building 223 must be maintained during school year. • Pedestrian access from the north parking lot to Building 222 (East Entrance) must be maintained at all times. • Other Argonne constraints will be identified during review and approval of GC’s proposed schedule. UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011 21

  22. Project Approach • Overall Site Boundaries UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  23. Project Approach • Site Logistics • Overall site boundaries • Temporary work outside “permanent” boundary • Telecommunication logistics • Temporary power • Outside Food Vendors “Roach Coach” • Laboratory Facilities • Sanitary Facilities • Cafeteria UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  24. Project Approach • Project Management System - Prolog • RFI Process • Submittal Process • Other processes • Field Change Authority • GC will be authorized to proceed with schedule-critical additional work via the Argonne FCA process • Material Testing Firm • Commissioning Agent UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011 24

  25. Questions & Answers UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  26. Closing & Summary • Addendum 1 to include: • Penthouse panel and louver profile revisions. • Architectural and Structural revisions at terrace above north entrance. • Furniture package. • Lab flooring finish and pattern revisions. • Flash steam recovery system. • Sizing of condensate system pressure powered pumps. • Mechanical related demo & new work for Bldg. 222 & 223. • Control pressure sensors for air and water systems. • Metering of utilities for building energy use calculations and display in lobby kiosk. • Lighting controls and circuiting. • Sub-metering of electrical circuits for building energy use calculations and reporting. • BMS monitoring of additional sub-meters on the Lab and Domestic Water, Process Cooling and Clean Steam Make-Up Water Systems. UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011

  27. Closing & Summary • Addendum due to be issued week of April 11, 2011 • Proposals due - May 4, 2011. • Thank you for attending UChicago Argonne, LLC | ESB Pre-Proposal Meeting, April 6, 2011
