The Central Scotland Green Network (CSGN) is facilitating wood energy initiatives across 19 councils, with significant progress reported. Site visits have been completed for councils, including Clackmannanshire, Glasgow City, and Fife. Current investments may generate 120,352 MWh from 37,610 tonnes of wood fuel, requiring about £31 million and 48MW installed capacity. Viable schemes are identified, with the potential for quick payback through the Renewable Heat Incentive. Next steps include finalizing reports and obtaining council consents for tenders.
E N D
Central Scotland Green Network Planning Investment in Wood Energy: Support for central Scotland Councils
Contact with 19 Councils – 10 progressing • CLACKMANNANSHIRE COUNCIL • CITY OF EDINBURGH COUNCIL • EAST AYRSHIRE COUNCIL – SITE VISITS COMPLETED • EAST DUNBARTONSHIRE COUNCIL • EAST LOTHIAN COUNCIL • EAST RENFREWSHIRE COUNCIL • FALKIRK COUNCIL • FIFE COUNCIL – SITE VISITS 80% COMPLETED • GLASGOW CITY COUNCIL – SITE VISITS COMPLETED • INVERCLYDE COUNCIL – SUPPORTED INVERCLYDE JOINT CAMPUS, NO SITES AGREED AS YET • MIDLOTHIAN COUNCIL • NORTH AYRSHIRE COUNCIL • NORTH LANARKSHIRE COUNCIL – SITE VISITS COMPLETED • RENFREWSHIRE COUNCIL – 4 SITE VISITS COMPLETED • SOUTH AYRSHIRE COUNCIL – SITE VISITS COMPLETED • SOUTH LANARKSHIRE COUNCIL – NO SITES AGREED YET • STIRLING COUNCIL – SITE VISITS COMPLETED • WEST DUNBARTONSHIRE COUNCIL • WEST LOTHIAN COUNCIL – SITE VISITS COMPLETED

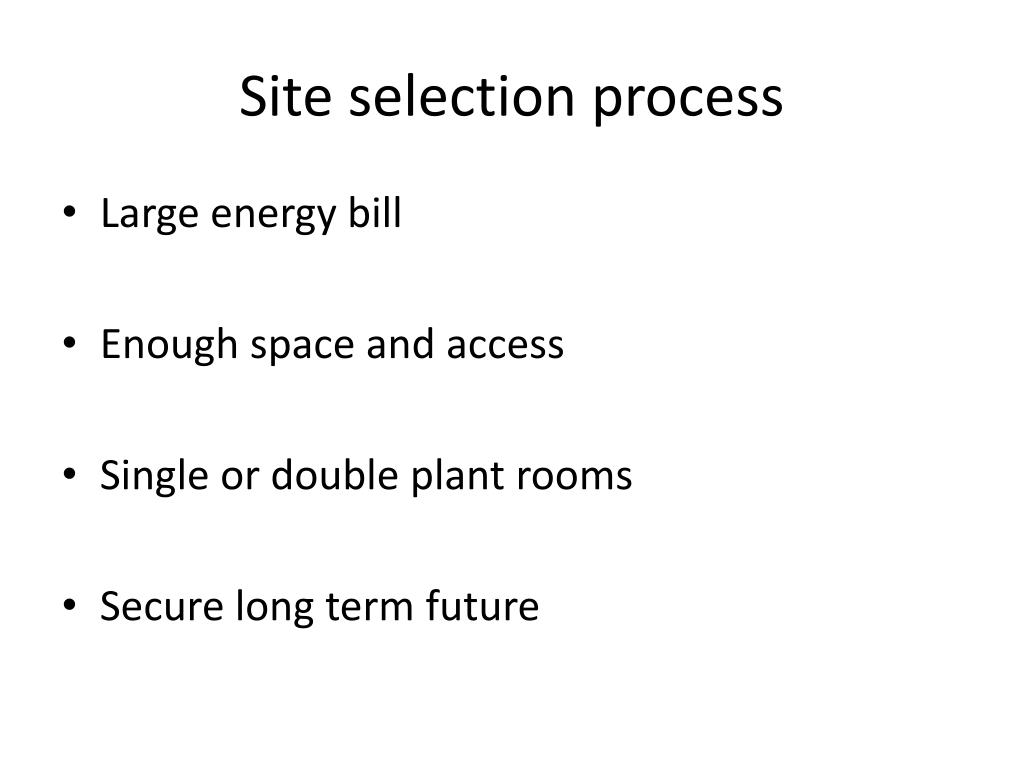

Site selection process • Large energy bill • Enough space and access • Single or double plant rooms • Secure long term future

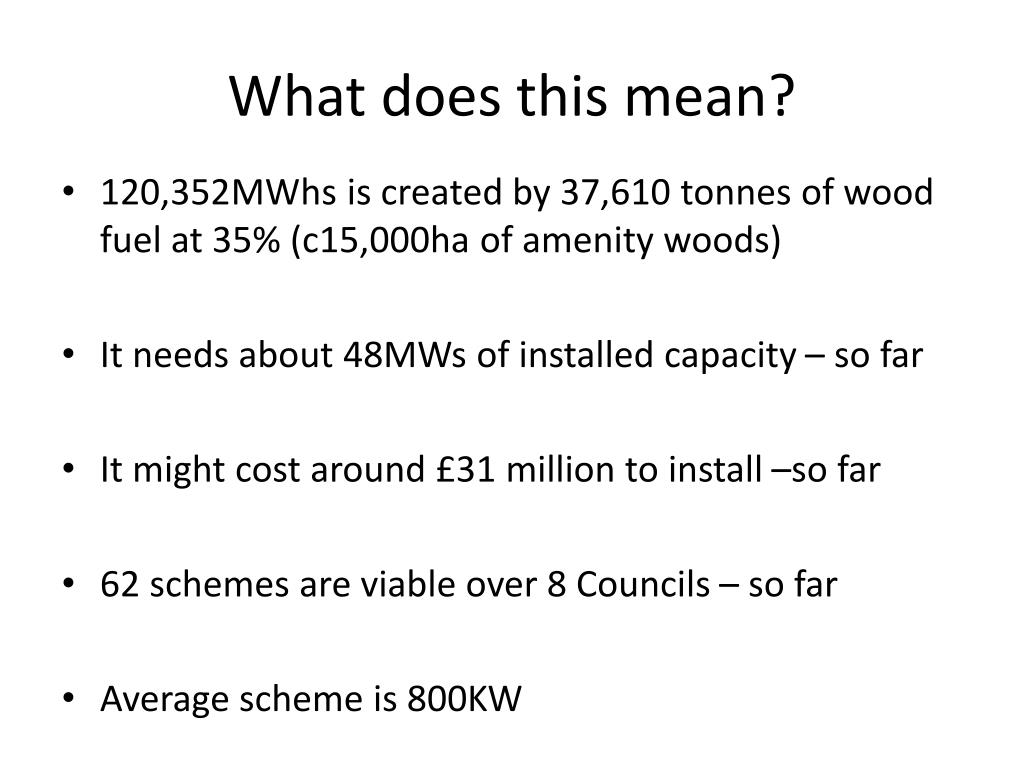

What does this mean? • 120,352MWhs is created by 37,610 tonnes of wood fuel at 35% (c15,000ha of amenity woods) • It needs about 48MWs of installed capacity – so far • It might cost around £31 million to install –so far • 62 schemes are viable over 8 Councils – so far • Average scheme is 800KW
Viability The £30 million capital would be repaid in 5 years with RHI at £52/MWh
Stirling High School • 1830MWhs of gas use
Stirling High School • A £300,000 scheme for a 500KW boiler
Next steps • Complete the reports in the light of RHI • Review woodland resources • Workshop and study tour – 25th March • Obtain Council consent to tender • Develop ESCO tenders
