DESCRIPTION

LIU evolution. H. Damerau, R. Garoby, B. Goddard, S. Gilardoni, K. Hanke , D. Manglunki, M. Meddahi , B. Mikulec, L. Ponce, E. Shaposhnikova , M . Vretenar Acknowledge work from ABP, ABT, RF, OP, BI, STI, EPC , MSC, VSC , …. and US-LARP collaborators. Contents.

1 / 27

Download Presentation
Télécharger la présentation

LIU evolution

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. LIU evolution • H. Damerau, R. Garoby, B. Goddard, S. Gilardoni, K. Hanke, • D. Manglunki, M. Meddahi, B. Mikulec, L. Ponce, E. Shaposhnikova, • M. Vretenar • Acknowledge work from ABP, ABT, RF, OP, BI, STI, EPC, MSC, VSC, …. • and US-LARP collaborators

  2. Contents • Post LS2 HL-LHC requirements • Corresponding LIU beam requirements • 2012 proton injector chain performance • Limitations and mitigations • Unknowns, risks and remaining issues • Post LS2 expected performance • Conclusion

  3. HL-LHC beam parameters at 7 TeV

  4. Corresponding required beam parameters through injector chain Assumptions: B. Goddard, Chamonix 12

  5. 2012 injector beam parameters

  6. 2012 Performance and limitations at SPS ejection Large improvement is required for either 25 or 50 ns beam! 6

  7. Limitations: 25 ns space charge/brightness • PSB: exy [mm]  -0.42 Nb [e12] / DQy, with 160 MeV injection • Confident to run with DQy of at least -0.4 • Need 3.4e12 in 1.9 mm: potential for 3.4e12 in 1.7 mm (OK) • PS: exy [mm]  -0.26 Nb [e12] / DQy , with 2 GeV injection • Confident to run with DQy of at least -0.26 (operational beam reached -0.28) • Need 3.2e12 in 2.0 mm: potential for 3.2e12 in 3.0 mm (Not OK) • Cannot digest fully what PSB can provide • Need to increase DQy to -0.37 to reach the required brightness • SPS: exy [mm]  -1.22 Nb [e12] / DQy, with Q20 optics at 26 GeV • Reasonably confident to run with DQy -0.15 (single bunch brightness) • Need 2.5e11 in 2.1 mm: potential for 2.5e11 in 2.0 mm (OK) For 25 ns: suggests limit will be PS, as PSB delivers more than PS can digest

  8. Limitations: 50 ns space charge/brightness • PSB: exy [mm]  -0.42 Nb [e12] / DQy, with 160 MeV injection • Confident to run with DQy of at least -0.4 • Need 2.7e12 in 2.2 mm: potential for 3.4e12 in 1.7 mm (easy!) • PS: exy [mm]  -0.26 Nb [e12] / DQy , with 2 GeV injection • Confident to run with DQy of at least -0.26 (operational beam reached -0.28) • Need 2.6e12 in 2.4 mm: potential for 2.6e12 in 2.4 mm (Just OK) • SPS: exy [mm]  -1.22 Nb [e12] / DQy, with Q20 optics at 26 GeV • Reasonably confident to run with DQy -0.15 (single bunch brightness) • Need 4.0e11 in 2.5 mm: potential for 4.0e11 in 3.3 mm (Not OK) • Need to increase DQy to -0.2 to reach the required brightness For 50 ns: PSB and PS OK, limit in SPS

  9. Other limitations and actions • SPS TMCI : single bunch • Q20 now used: above ~3.6e11 per bunch (Q’=0) • PS longitudinal phase plane: • Should increase limits from present ~1.7e11 to ~3e11 p+/b while keeping the beam splitting quality • Combine effects of different actions: • New longitudinal damper using dedicated broad band cavity • Fast RF feedback systems upgraded on all High Power RF systems • One turn-delay feedbacks renovated • More RF voltage at 40 MHz installed for better SPS capture efficiency • PS-SPS transfer parameters • Larger longitudinal emittance required for beam stability both in the PS and SPS, but its leads to higher capture losses in the SPS. • Simulations predict a significant gain by optimising the PS bunch rotation with spare RF cavities. First MD results  are very encouraging – Helga Timkó et al.

  10. SPS longitudinal instabilitiesP. Baudrenghien, W. Höfle, E. Shaposhnikova, US LARP collaborators • Longitudinal stability: 25 ns beam unstable at 2-3e10 p+/b , Q26 • Presently mitigated with controlled long. emittance blow up (0.6 eVs) and 800 MHz RF voltage used in bunch shortening mode • Q20 has increased the threshold on flat top by factor 1.6 • Both 25 and 50 ns beams, affected • After upgrade (double 200 MHz RF power, 6 shorter assemblies – vs. 4 today -> reduced impedance) : • At reach: 2.3e11 p+/b for 25 ns, and >3.4e11 p+/b for 50 ns • Planned upgrades of the 800 MHz low and high power equipment are mandatory. US-LARP collaboration has been, and still is, essential. • Higher power will only remove limitation from the beam loading, but not from longitudinal instabilities with high intensity since cannot have much larger longitudinal emittance at injection to the LHC -> should find the source of this instability

  11. ecloud • PS: observed but not yet a limitation • Transverse damper proved to be effective to damp instability observed • Studies are ongoing to investigate HL-LHC regime • Mitigations being investigated (coating, double bunch rotation, …) • SPS: potentially a major performance limit (beamloss, vacuum, ecloud instability and incoherent emittance growth) • Scrubbing for 25 ns could be tough…StSt chambers, OP limitations… • But in 2012 machine in good shape – no limit from ecloud. Crucial to have 2 weeks to investigate scrubbing after LS1 (to decide between scrubbing and coating) • aC coating now fully validated as mitigation (still LIU baseline) • HBW feedback could cure vertical single bunch ECI –much work on-going – indispensable US-LARP collaboration (with W. Höfle and team)

  12. ‘Operational’ limitations • Mainly in SPS (to date) • Heating of extraction kickers: should be ‘solved’ with final shielded MKE in LS1. Expect limit to be at least twice present beam power -ABP, ABT groups • Outgassing of dump and impact on injection kickers MKP vacuum: extra differential pumping and sectorisation planned. Effect is mainly a limitation for scrubbing and setting up, rather than LHC filling –ABP, ABT, VAC groups • ZS sparking was previously a concern, but 2012 performance has been very good. Still working on ‘ppm’ voltage modulation as mitigation – EPC, ABT, CO groups • New beam intercepting and protection devices needed (major simulation & design efforts from STI) • BI development for measuring with adequate accuracy reduced beam sizes, higher brightness and intensity

  13. Essential MDs LIU Beam studies Review – organised by Giovanni Rumolo - 28 August 2012 Giovanni Rumolo - LMC 17 Oct. 12

  14. Expected performance after LS2 LIU preferred option is 25 ns

  15. Unresolved questions/issues • Electron cloud • aC coating or scrubbing (+HBW damper) in SPS? • Is ecloud going to be an issue in PS? • Prospects for increasing (already ambitious) target for PS longitudinal stability for 50 ns beam? • Prospect for PS significantly exceeding -0.26 in space charge tune shift for 25 ns beam? • Study to assess maximum tolerable Laslett tune shift with no resonance compensation. • One quarter resonance excited by Space charge under study  • Alternative schemes : longer bunches, resonance compensation, acceleration/deceleration, dedicated injection optics ….

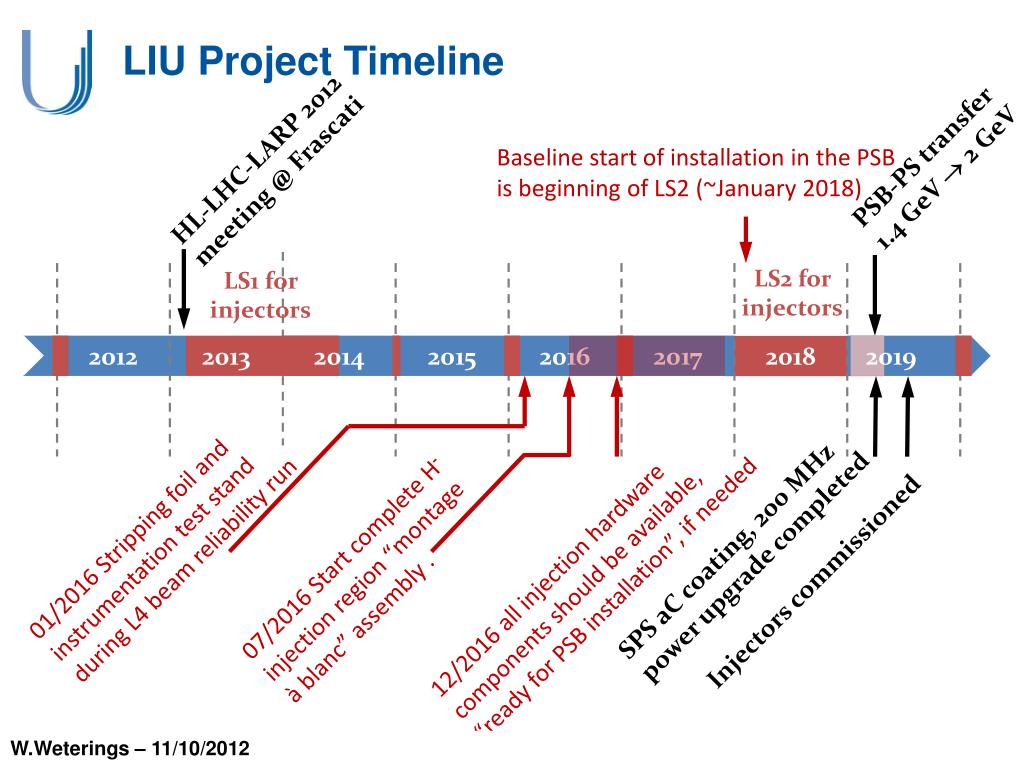

  16. LIU Project Timeline HL-LHC-LARP 2012 meeting @ Frascati PSB-PS transfer 1.4 GeV 2 GeV Baseline start of installation in the PSB is beginning of LS2 (~January 2018) LS2 for injectors LS1 for injectors 2019 2012 2013 2014 2015 2016 2017 2018 01/2016 Stripping foil and instrumentation test stand during L4 beam reliability run SPS aC coating, 200 MHz power upgrade completed 12/2016 all injection hardware components should be available, “ready for PSB installation”, if needed 07/2016 Start complete H- injection region “montage à blanc” assembly . Injectors commissioned W.Weterings – 11/10/2012

  17. Conclusions (I) • For HL-LHC era, requirements are challenging • 25 ns: need x2 present intensity, >x2 present brightness • 50 ns: need x2.2 present intensity, 30% above present brightness • Baseline LIU does not reach HL-LHC ‘point-like’ requirements. • To even get close: • Need all planned upgrades to be fully effective, and to approach single bunch limits with multi-bunch operation • Need “stretch” loss/blowup levels in injectors, with HL-LHC ≤10% blowup, and losses of around 3%... • Limits are different for 25 and 50 ns production • PSB performance sufficient with 160 MeV injection for both • 25 ns: PS space charge tune shift (2 GeV injection fixed by PSB). • 50 ns: brightness in SPS, PS longitudinal stability, PS beam loading

  18. Conclusions (II) • Not totally impossible to approach HL-LHC request, providing • Losses and blowup can eventually be reduced to “stretch” levels • PS can run with higher space charge tune shift, nearer DQ≈ -0.32 • PS longitudinal stability can improve significantly above present expectation (today at 1.7e11, LIU baseline 3e11, need 3.7e11) • SPS can increase brightness limit, to DQ≈ -0.17 • Realistic time for re-commissioning after LS2 to be foreseen • LS2 will be ‘LIU shutdown’… • Planning and organisation of this should start now! • Support from US-LARP is acknowledged, much needed , and should continue (space charge studies in PS, damper systems in SPS, Beam dynamics through injector chains, SPS LLRF upgrades…)

  19. Introductory remarks

  20. Q20 optics: experience from deployment • Q20 deployed in SPS and TLs, now working operationally – H. Bartosik , Y. Pappaphilipou , BTP, RF, OP et al. • More stability in SPS and slightly lower exy to LHC as result (0.1-0.2 um) • In the SPS: more orbit fluctuation than with Q26 at the ejection point creating larger oscillations in the TL – being analysed – Eliana Gianfelice et al. • Satellites as well as the 6 b have a bigger profile and more tails – Karel Cornelis – Wolfgang Bartmann Lene Drosdal satellite bunches

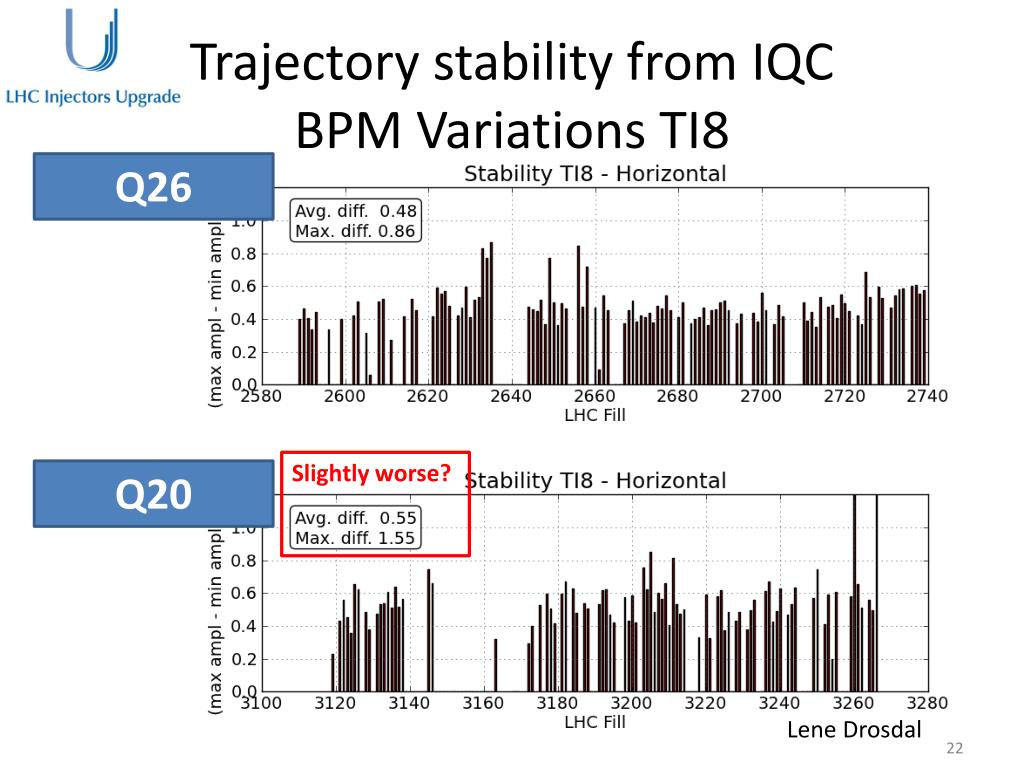

  21. Trajectory stability from IQCBPM Variations TI8 Q26 Slightly worse? Q20 Lene Drosdal

  22. Re-commissioning after LS2 • Will not be “plug n play” to recover pre-LS2 performance • Three ‘new’ injectors to startup, together • PSB: new ramp to 2 GeV, (maybe) new H- injection at 160 MeV, new RF, new instrumentation, new beam transfer • PS: new 2 GeV injection, new longitudinal FB, new instrumentation • SPS: (probably) rebuilt after ecloud coating (744 MBs, 216 MQs), ‘new’ RF 200 MHz, new high bandwidth FB, new orbit and BLM system, new scraper and TL collimators • Normal startup: 1-2 weeks per machine • Must count months per machine to recover pre-LS2 performance • A concrete LS2 plus commissioning plan to work on (in 2012) • Will certainly take period LS2-LS3 to reach baseline LIU goals

  23. SPS beam loading • SPS 200 MHz: x2 power, 46 (shorter) cavities, -20% impedance • Will allow 10 MV at extraction for 3 A RF current (now 1.5 A) • Need to operate existing power plants in pulsed mode (0.751.05 MW) • After upgrade: same voltage available as now (if pulsed) for 2.3e11 p+/b (25 ns) and 4.6e11 p+/b (50 ns). E.Shaposhnikova
