SCT - brief overview

SCT - brief overview. Current situation: barrel module production will start very soon. Significant number of modules available by the summer forward module production delayed by problems with hybrid. Possibly 9-12 months before production of modules begins?

sienna
Télécharger la présentation

SCT - brief overview

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

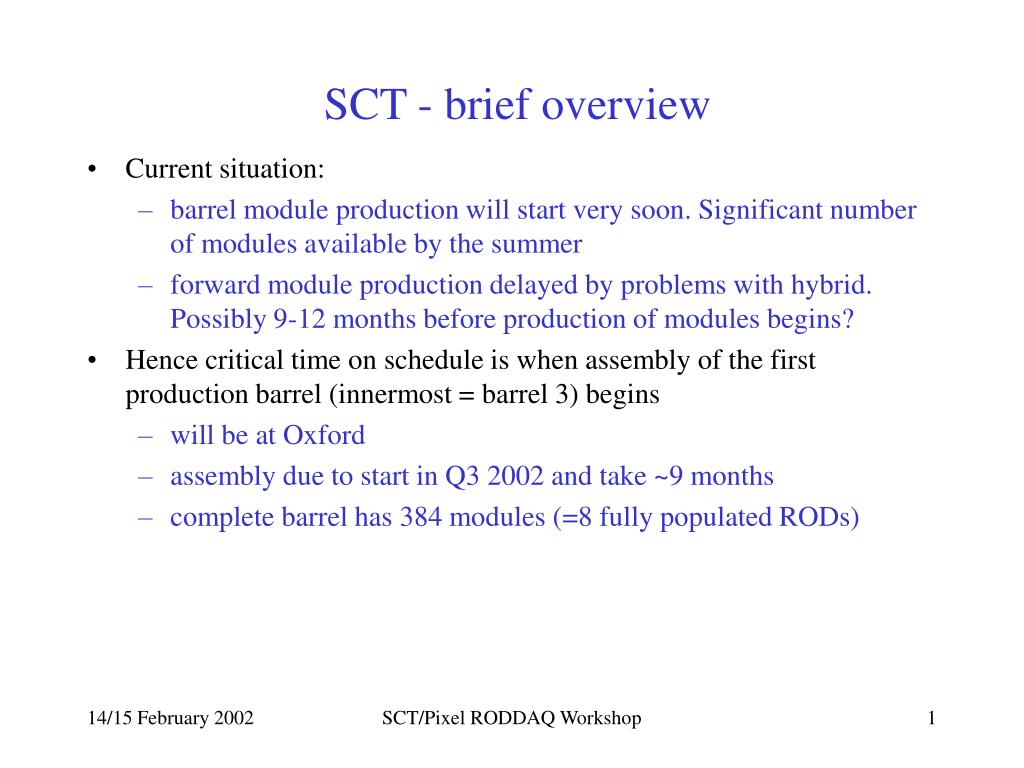

  1. SCT - brief overview • Current situation: • barrel module production will start very soon. Significant number of modules available by the summer • forward module production delayed by problems with hybrid. Possibly 9-12 months before production of modules begins? • Hence critical time on schedule is when assembly of the first production barrel (innermost = barrel 3) begins • will be at Oxford • assembly due to start in Q3 2002 and take ~9 months • complete barrel has 384 modules (=8 fully populated RODs) SCT/Pixel RODDAQ Workshop

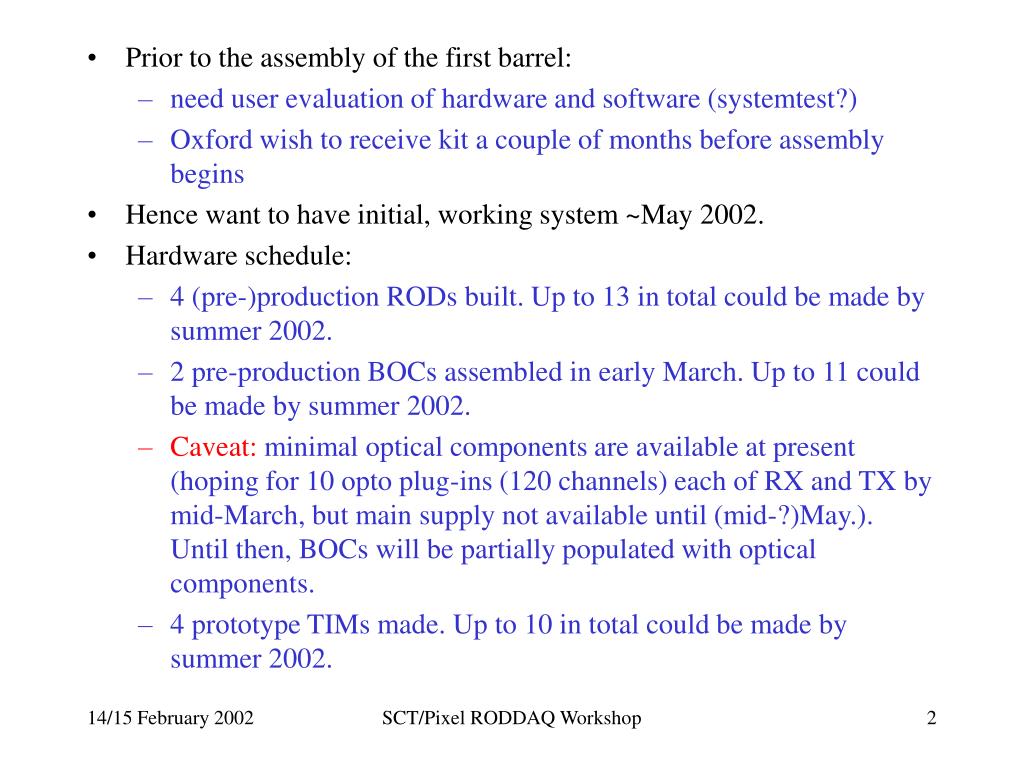

  2. Prior to the assembly of the first barrel: • need user evaluation of hardware and software (systemtest?) • Oxford wish to receive kit a couple of months before assembly begins • Hence want to have initial, working system ~May 2002. • Hardware schedule: • 4 (pre-)production RODs built. Up to 13 in total could be made by summer 2002. • 2 pre-production BOCs assembled in early March. Up to 11 could be made by summer 2002. • Caveat: minimal optical components are available at present (hoping for 10 opto plug-ins (120 channels) each of RX and TX by mid-March, but main supply not available until (mid-?)May.). Until then, BOCs will be partially populated with optical components. • 4 prototype TIMs made. Up to 10 in total could be made by summer 2002. SCT/Pixel RODDAQ Workshop

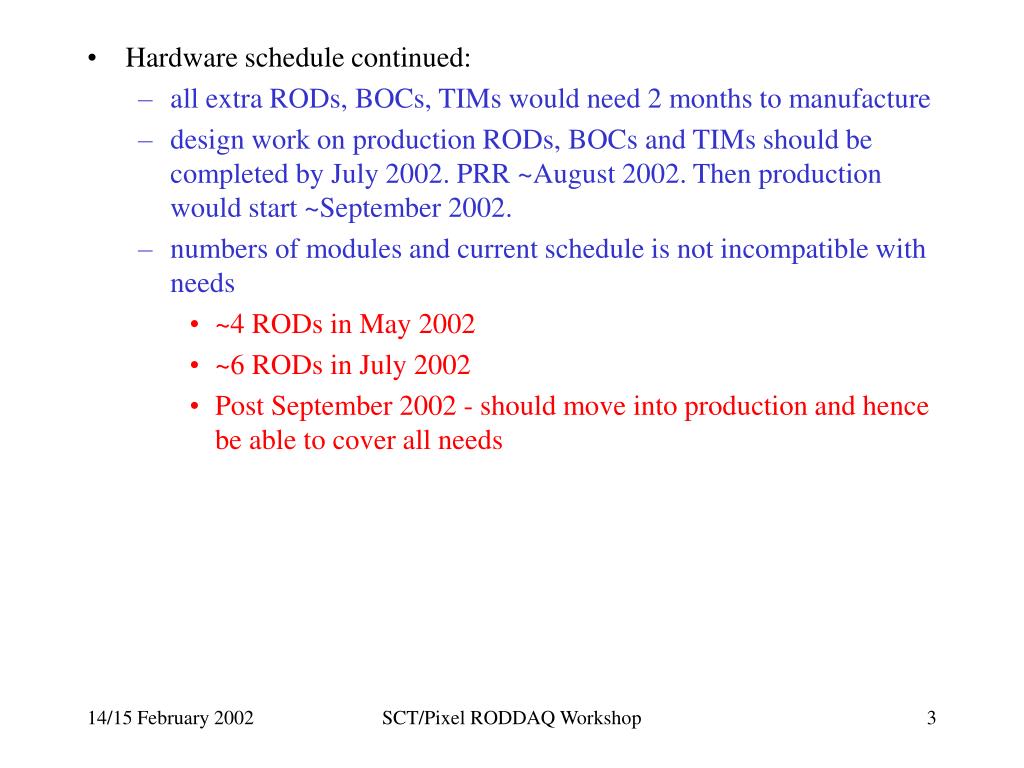

  3. Hardware schedule continued: • all extra RODs, BOCs, TIMs would need 2 months to manufacture • design work on production RODs, BOCs and TIMs should be completed by July 2002. PRR ~August 2002. Then production would start ~September 2002. • numbers of modules and current schedule is not incompatible with needs • ~4 RODs in May 2002 • ~6 RODs in July 2002 • Post September 2002 - should move into production and hence be able to cover all needs SCT/Pixel RODDAQ Workshop

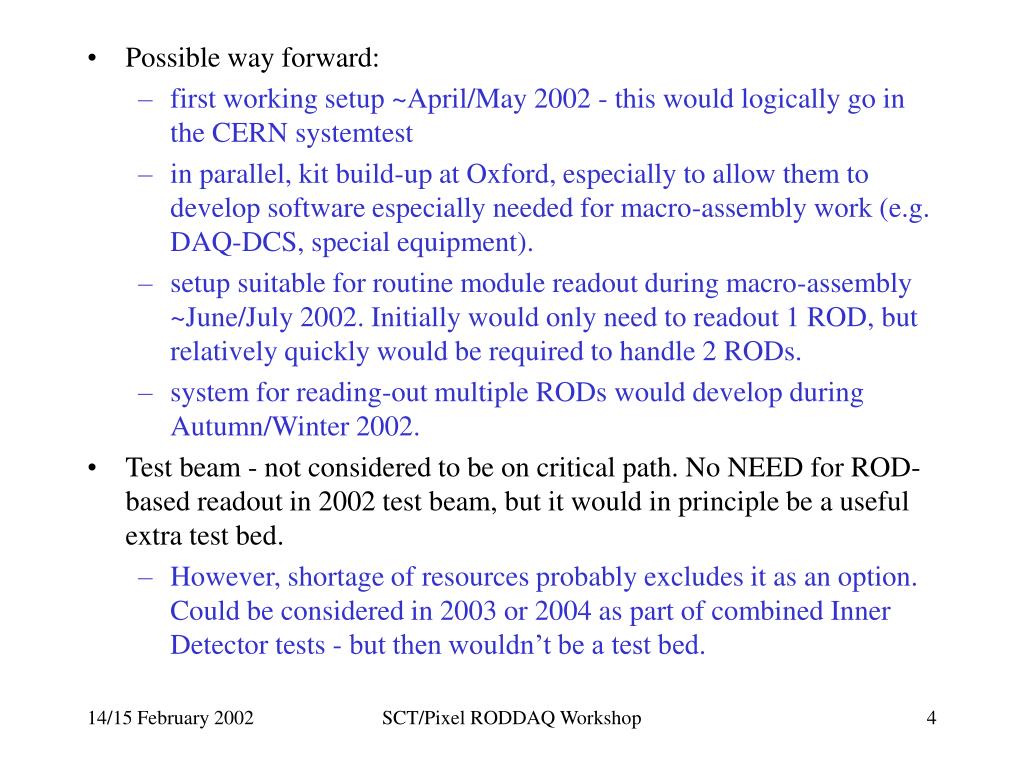

  4. Possible way forward: • first working setup ~April/May 2002 - this would logically go in the CERN systemtest • in parallel, kit build-up at Oxford, especially to allow them to develop software especially needed for macro-assembly work (e.g. DAQ-DCS, special equipment). • setup suitable for routine module readout during macro-assembly ~June/July 2002. Initially would only need to readout 1 ROD, but relatively quickly would be required to handle 2 RODs. • system for reading-out multiple RODs would develop during Autumn/Winter 2002. • Test beam - not considered to be on critical path. No NEED for ROD-based readout in 2002 test beam, but it would in principle be a useful extra test bed. • However, shortage of resources probably excludes it as an option. Could be considered in 2003 or 2004 as part of combined Inner Detector tests - but then wouldn’t be a test bed. SCT/Pixel RODDAQ Workshop

  5. What does a working setup need? • see Requirements Document of GFM and PWP! • following is not a definitive list: • (re)configure and readout module or groups of modules • recovery from power supply trips/module hangups • event data retrieval, analysis and storage (via VME backplane) • historgram booking,filling and storage • (re)characterisation of modules - including a variety of possible parameter scans • handle an increasing number of modules, up to O(103) • implies • DAQ and DCS must interact reliably and coherently • control interface must allow great flexibility • some functions may be developed on the RCC and migrate to ROD DSPs SCT/Pixel RODDAQ Workshop

  6. Summary • April/May 2002 - 1st DAQ required (systemtest and Oxford), with developing functionality towards... • July 2002 - DAQ with most of required functionality, capable of supporting macro-assembly activities, though initially with only 1 or 2 RODs, but expanding with time to... • ~March 2003 - completion of first barrel - DAQ can read out ~8 RODS (400 detectors). • Up to this point, only single-crate arrangements with no use of S-link are assumed. This is probably necessary at macro-assembly sites to minimise complexity. • Further in the future - multi-crate DAQ, when >1 barrel are brought together. Timeframe for this is less clear. Also at what stage do we need to integrate T/DAQ equipment (start of 2004, when should have all 4 barrels together?). SCT/Pixel RODDAQ Workshop
