This week's report covers significant milestones achieved during the demolition and construction phases at the site. The West Entry demolition is complete, and work on drilled piers and footers has begun. The 1927 wing demolition is nearing completion, and phase 1 tasks, including removal of air handling units and shutdown of the main electrical panel, have been accomplished. Continued efforts are focused on MEP installations in the 1927 wing, preparation for floor cuts, and wall work to facilitate relocations for Taco Bell and C-Store.
E N D
05/07/12 – 5/13/12 Phase 1 Demolition at West Entry Complete; Drilled Piers and footers Started

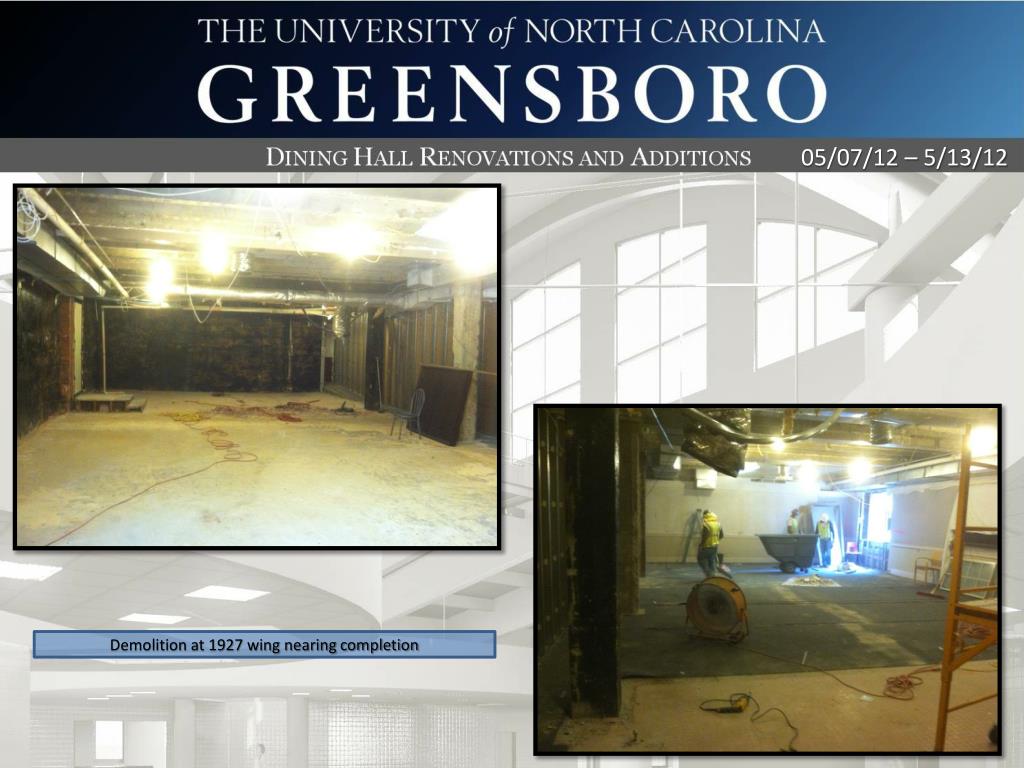

05/07/12 – 5/13/12 Demolition at 1927 wing nearing completion
05/07/12 – 5/13/12 Phase 1 Air Handler Units removed
05/07/12 – 5/13/12 • Field Measured Phase 3 Rotunda • Completed Electrical Shutdown to relocate Main Electrical Panel During the break… • Exterior • Complete drilled piers • Form and Pour Footings at South Side • Interior • Continue with MEP in 1927 Wing • Prep for floor cut at main electrical room • Wall off existing area at Spartan Grille to facilitate Taco Bell/C-Store Relocation NEXT WEEK LOOK AHEAD Phase 3 Rotunda Field Measurement and Verification
