DESCRIPTION

CIM Test Development Process. 18 January 2011. EPRI Project 071103. CIM test process overview. CIM Test Methodology compatible with IEC WG 14 CIM Users Group OpenSG And possibly MultiSpeak Test process defined, documented and repeatable

1 / 9

Télécharger la présentation

CIM Test Development Process

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. CIM Test Development Process 18 January 2011 EPRI Project 071103

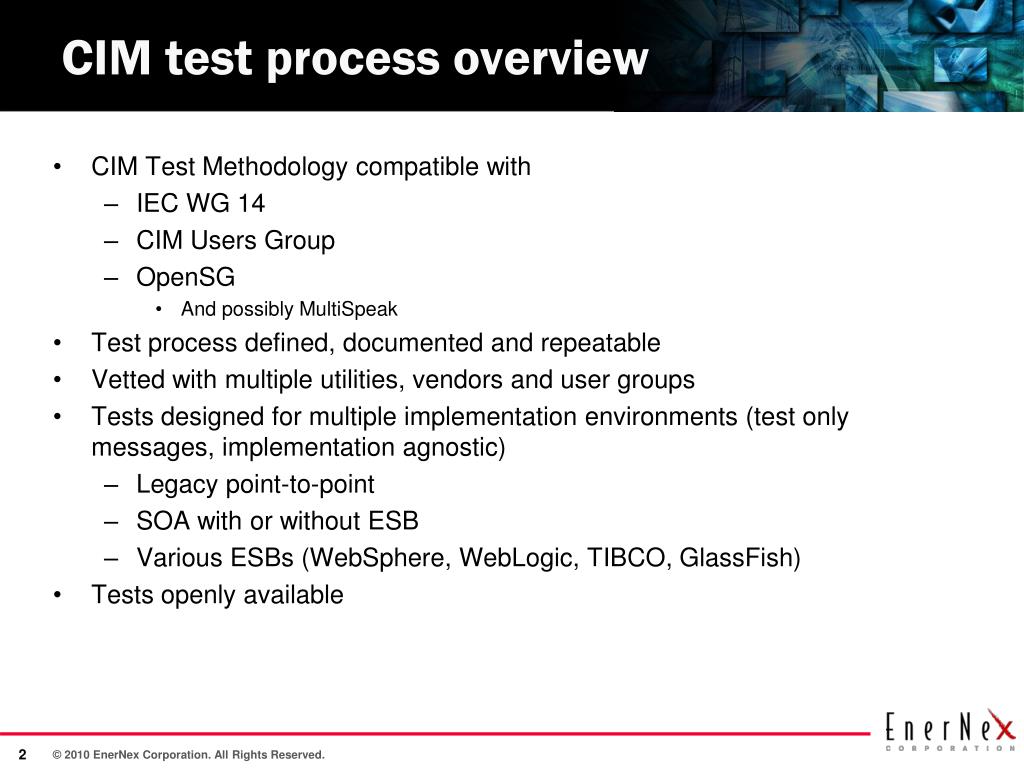

  2. CIM test process overview • CIM Test Methodology compatible with • IEC WG 14 • CIM Users Group • OpenSG • And possibly MultiSpeak • Test process defined, documented and repeatable • Vetted with multiple utilities, vendors and user groups • Tests designed for multiple implementation environments (test only messages, implementation agnostic) • Legacy point-to-point • SOA with or without ESB • Various ESBs (WebSphere, WebLogic, TIBCO, GlassFish) • Tests openly available

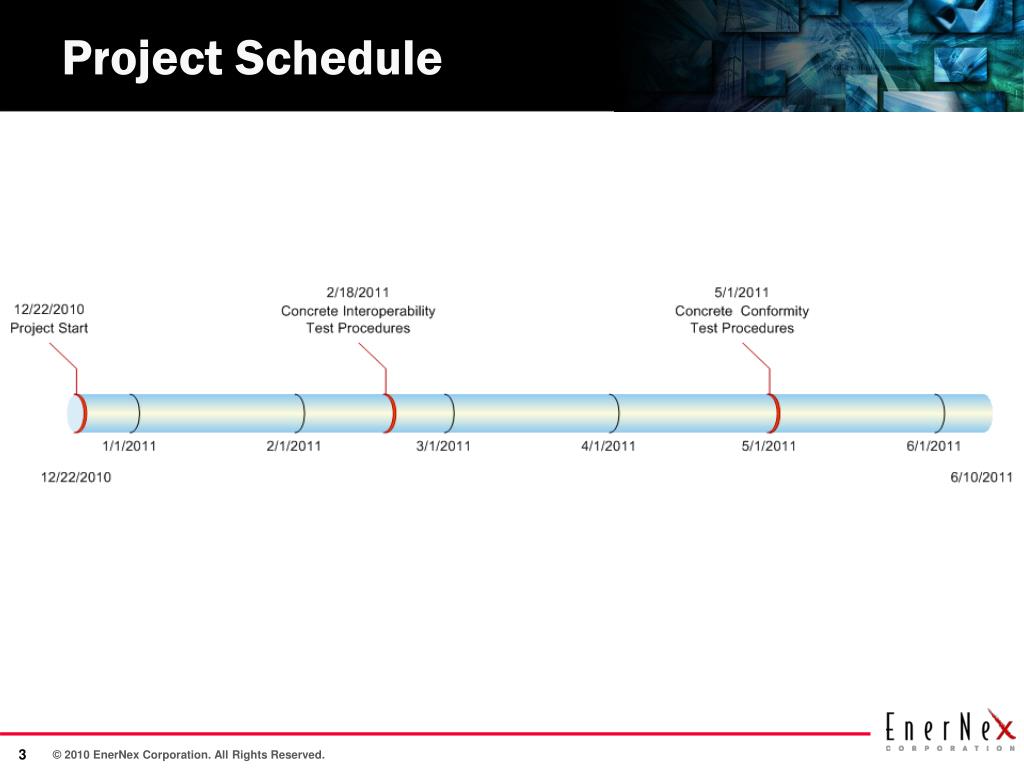

  3. Project Schedule

  4. Types of CIM-based Tests

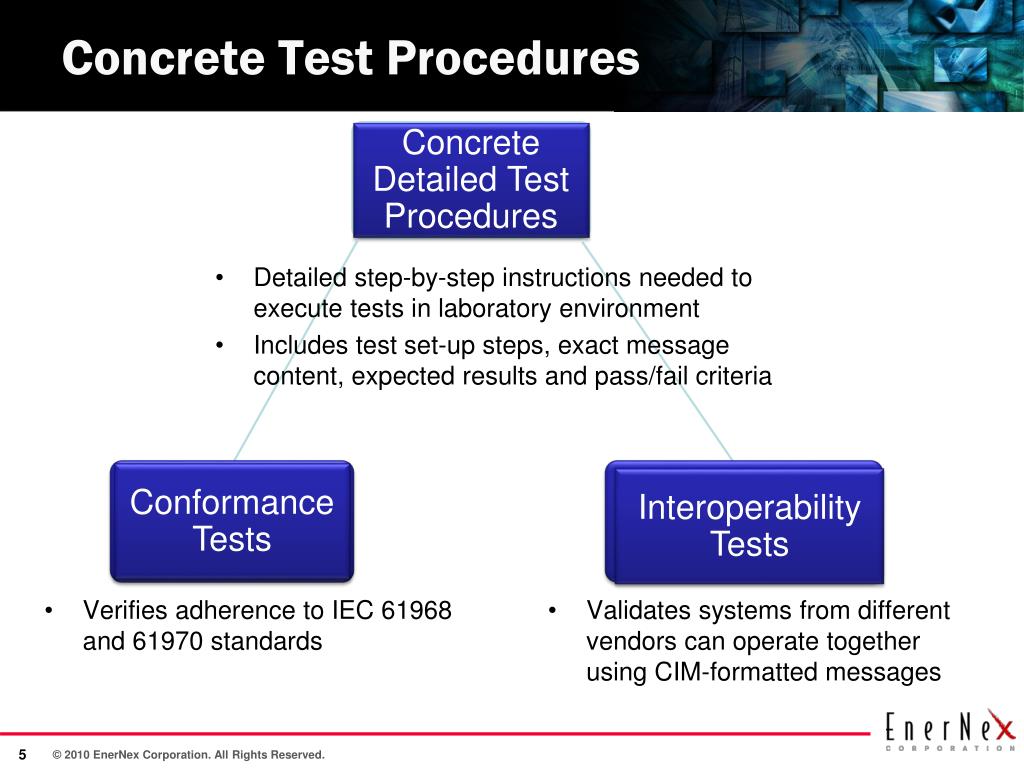

  5. Concrete Test Procedures • Detailed step-by-step instructions needed to execute tests in laboratory environment • Includes test set-up steps, exact message content, expected results and pass/fail criteria Conformance Tests Interoperability Tests Concrete Detailed Test Procedures • Verifies adherence to IEC 61968 and 61970 standards • Validates systems from different vendors can operate together using CIM-formatted messages

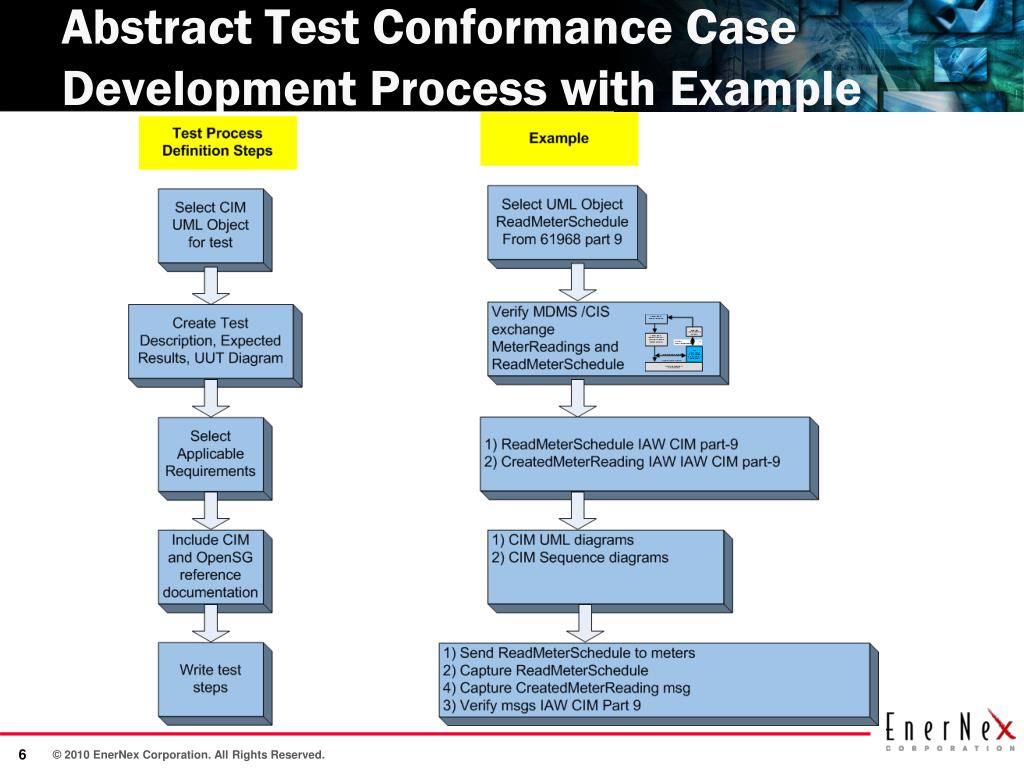

  6. Abstract Test Conformance Case Development Process with Example

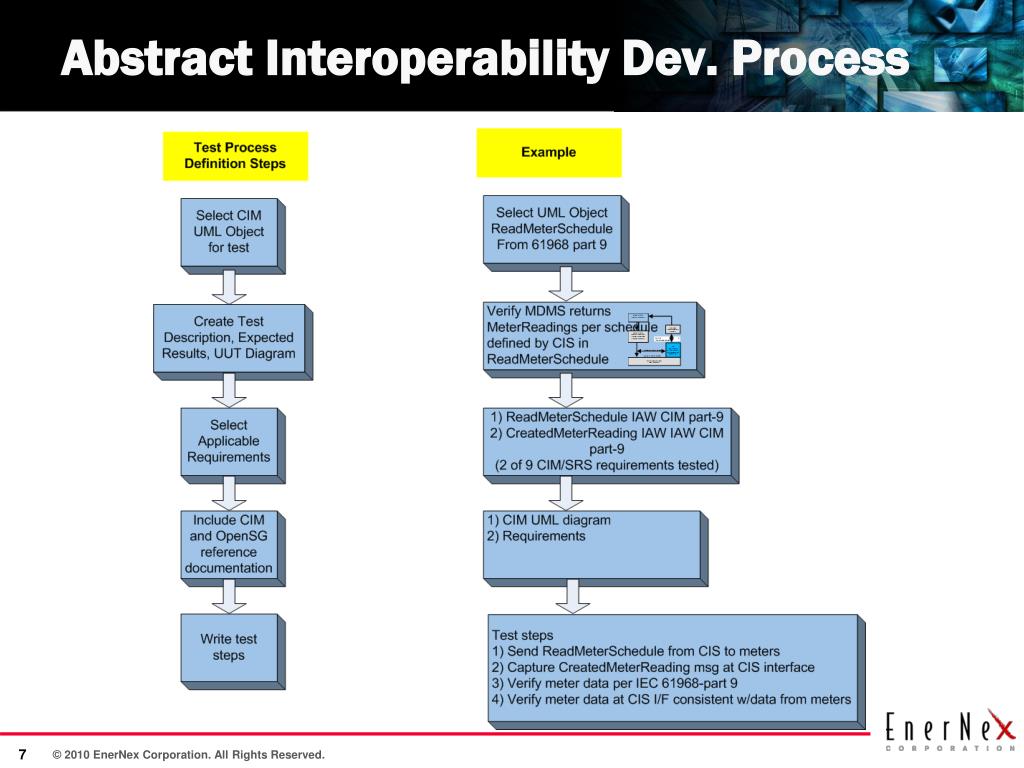

  7. Abstract Interoperability Dev. Process

  8. UUT Diagram: Interoperability Test

  9. Next Steps • Review and update sample abstract test case • Write detailed sample concrete test procedure • Instructions and procedures to connect up to an web service endpoints (e.g. MDMS & CIS) • POCs at Utilities/EPRI to coordinate testing • POCs at venders
