Intraday Trading

Intraday Trading. March 2011. Process. RAs raised a Modification (18_10) in March 2010, proposing the implementation of “intra-day trading” in the SEM. The Modifications Committee established a Working Group, which has met on seven occasions, in addition to a number of conference calls.

udell
Télécharger la présentation

Intraday Trading

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Intraday Trading March 2011

  2. Process • RAs raised a Modification (18_10) in March 2010, proposing the implementation of “intra-day trading” in the SEM. • The Modifications Committee established a Working Group, which has met on seven occasions, in addition to a number of conference calls. • Widespread involvement from across the industry • Agreement of working assumptions on all major design components • The key output is the High Level Design Summary, which has been presented to and unanimously recommended for further development by the Modifications Committee and has been provided to the SEM Committee.

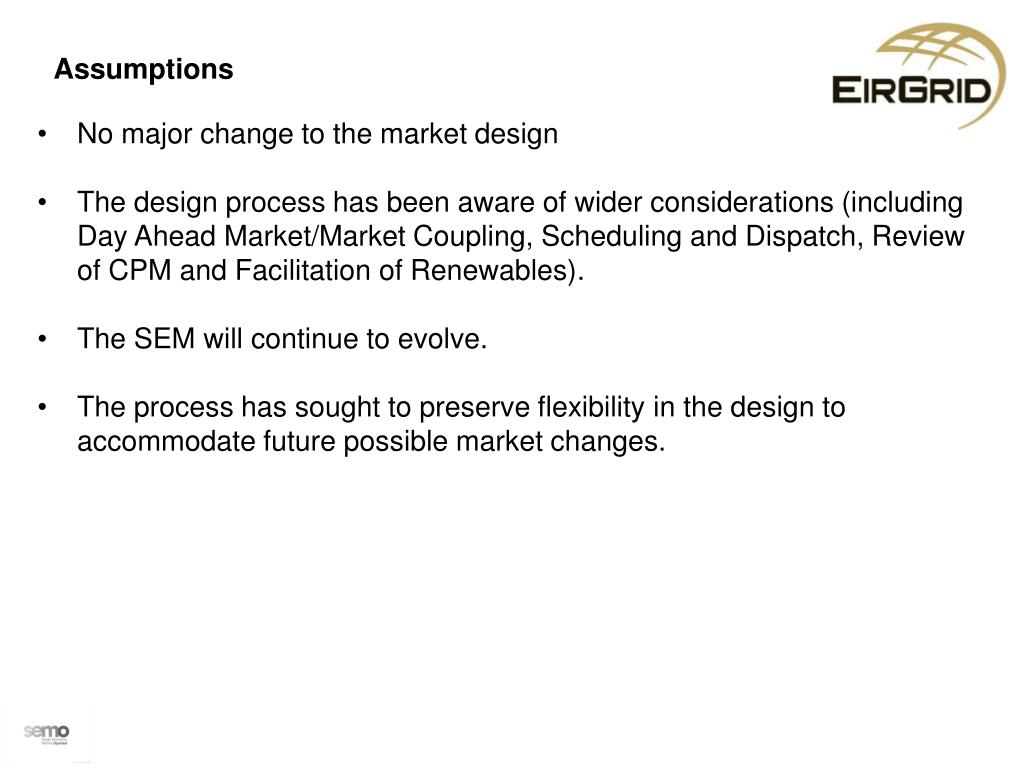

  3. Assumptions • No major change to the market design • The design process has been aware of wider considerations (including Day Ahead Market/Market Coupling, Scheduling and Dispatch, Review of CPM and Facilitation of Renewables). • The SEM will continue to evolve. • The process has sought to preserve flexibility in the design to accommodate future possible market changes.

  4. Proposed SEM Intra-Day Trading Design: Three Gate Windows / Trading Windows OPTIMISATION TIME HORIZON Trading Day - 1 Trading Day EA1 Trading Window Ending Overlap Opt’n Period EA1 EA1 Interconnector Unit trades fixed Gate Window Opening (GWO) e.g. as per current Gate Window Closure (GWC) Ending Overlap Opt’n Period EA2 Trading Window EA2 EA1 and EA2 Interconnector Unit trades fixed GWO GWC WD1 WD1 Trading Window Ending Overlap Opt’n Period Start Overlap Opt’n Period GWO GWC GATE WINDOW 10:00 TD-29 to 09:30 TD-1 GATE WINDOW 09:30 TD-1 to 11:30 TD-1 GATE WINDOW 11:30 TD-1 to 08:00 TD

  5. SEM Intra-Day Trading Design: Trading and Settlement • Enhanced trading opportunities, recognising the value of explicit capacity auctions: • Unused Interconnector capacity from EA1 Trading Window can be utilised in subsequent Trading Windows. • Superposition will allow the physical capacity of Interconnectors to be observed, whilst enabling trading in excess of the capacity in each direction (import, export). This provides opportunities to arbitrage and deliver price efficiencies. • Settlement will continue to be Ex-Post, based on Dispatch and Generator Unit performance against Dispatch. No changes are proposed to settlement payments or charges.

  6. SEM Intra-Day Trading Design: Impacts • SEM Intra-Day Trading will deliver compliance and regulatory intent: • Implementation in line with SEM Committee Decision on Intra-Day Trading • Compliance with EU Congestion Management Guidelines • Opportunity for greater utilisation of infrastructure (Moyle and EWIC), closer to real time. • Greater competition through increased trading opportunities (including superposition), with reduced trading risks (more opportunities to alter trading positions). • Greater Generator Unit cost-reflective bidding (bringing market timelines closer to fuel purchase timelines). • Agreed Credit Cover mechanisms, consistent with the original market principles, will be put in place.

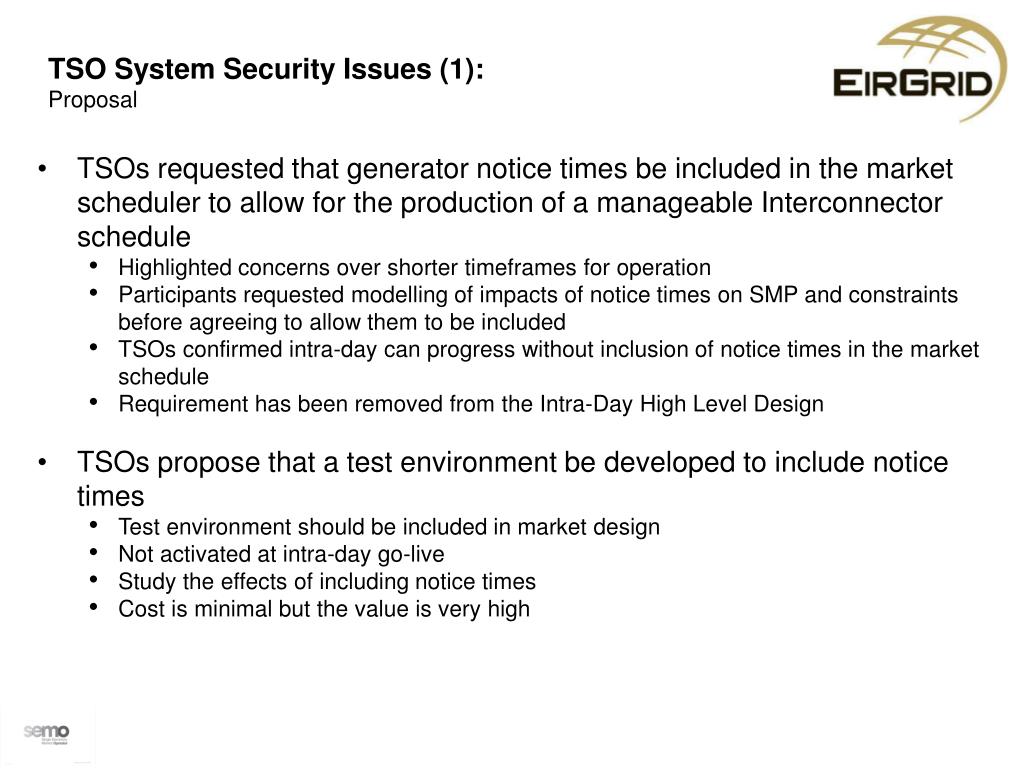

  7. TSO System Security Issues (1): Proposal • TSOs requested that generator notice times be included in the market scheduler to allow for the production of a manageable Interconnector schedule • Highlighted concerns over shorter timeframes for operation • Participants requested modelling of impacts of notice times on SMP and constraints before agreeing to allow them to be included • TSOs confirmed intra-day can progress without inclusion of notice times in the market schedule • Requirement has been removed from the Intra-Day High Level Design • TSOs propose that a test environment be developed to include notice times • Test environment should be included in market design • Not activated at intra-day go-live • Study the effects of including notice times • Cost is minimal but the value is very high
