This document outlines crucial steps and components for preparing project proposals under the INCO-2005-C-WBC/SSA-3 call. It includes detailed instructions on proposal structure, administrative requirements, and evaluation criteria. Key sections include a summary, project objectives, relevance to call objectives, potential impact, resource allocation, project management strategies, and plans for implementation. Important timelines for submission and contract preparation are highlighted to ensure compliance with project application procedures.
E N D
Project Proposals Under FPx CECRA: answering INCO-2005-C-WBC/SSA-3 Malcolm Watson, MChem. Section for Chemical Technology and Environmental Protection

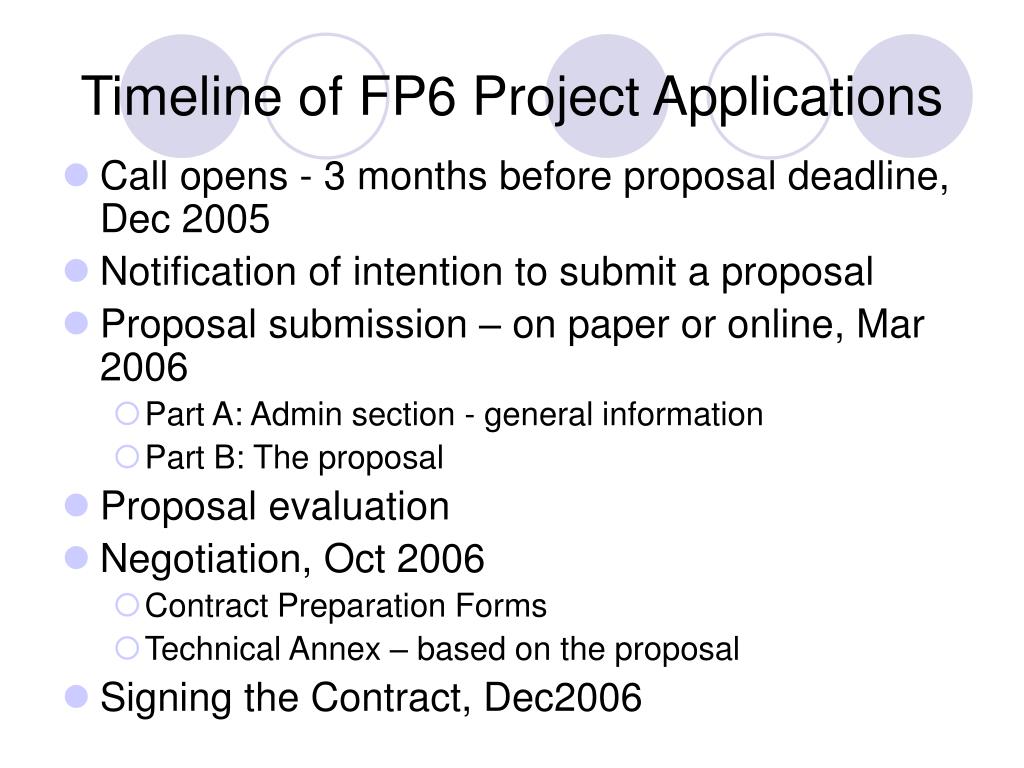

Timeline of FP6 Project Applications • Call opens - 3 months before proposal deadline, Dec 2005 • Notification of intention to submit a proposal • Proposal submission – on paper or online, Mar 2006 • Part A: Admin section - general information • Part B: The proposal • Proposal evaluation • Negotiation, Oct 2006 • Contract Preparation Forms • Technical Annex – based on the proposal • Signing the Contract, Dec2006

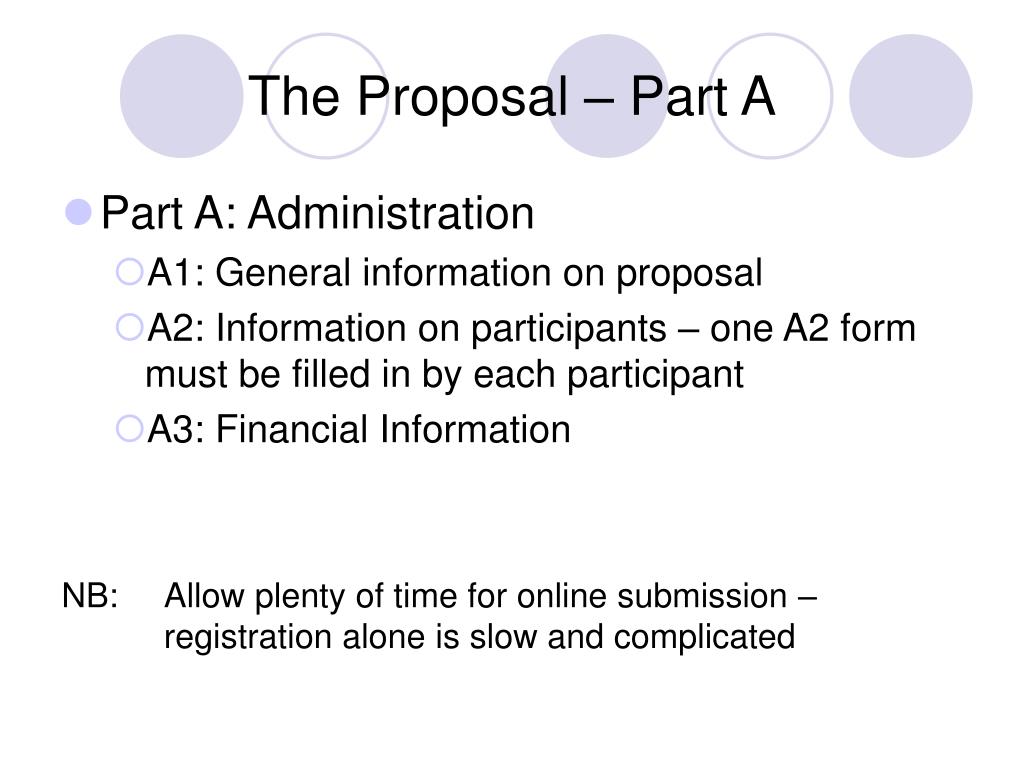

The Proposal – Part A • Part A: Administration • A1: General information on proposal • A2: Information on participants – one A2 form must be filled in by each participant • A3: Financial Information NB: Allow plenty of time for online submission – registration alone is slow and complicated

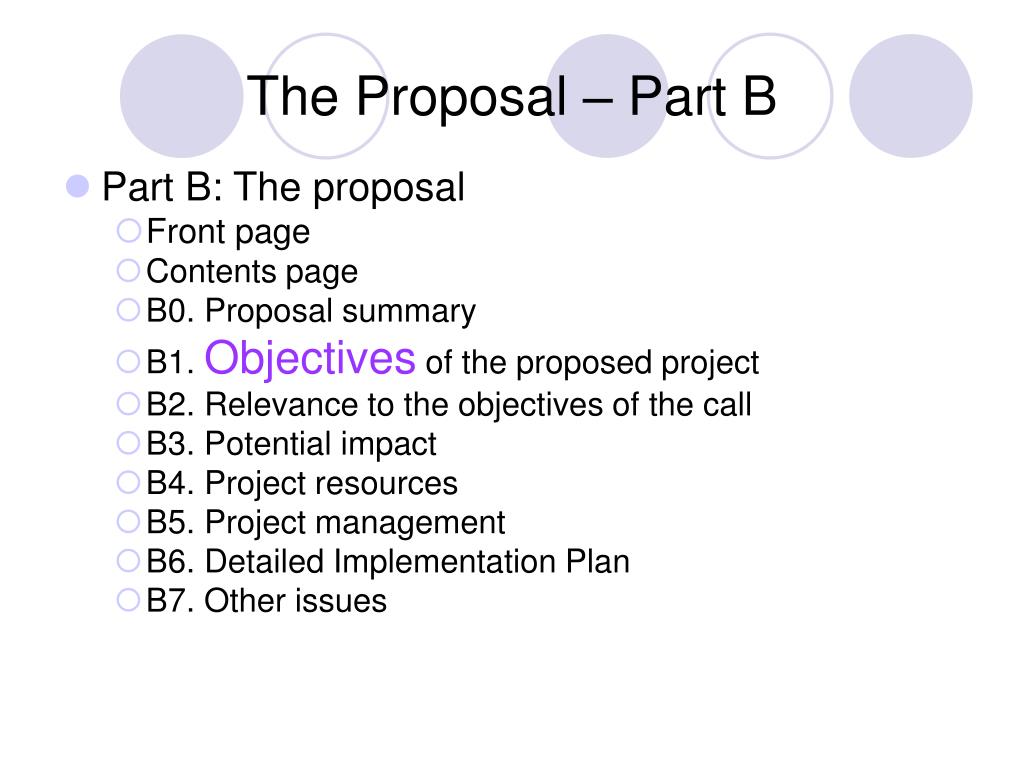

The Proposal – Part B • Part B: The proposal • Front page • Contents page • B0. Proposal summary • B1. Objectives of the proposed project • B2. Relevance to the objectives of the call • B3. Potential impact • B4. Project resources • B5. Project management • B6. Detailed Implementation Plan • B7. Other issues

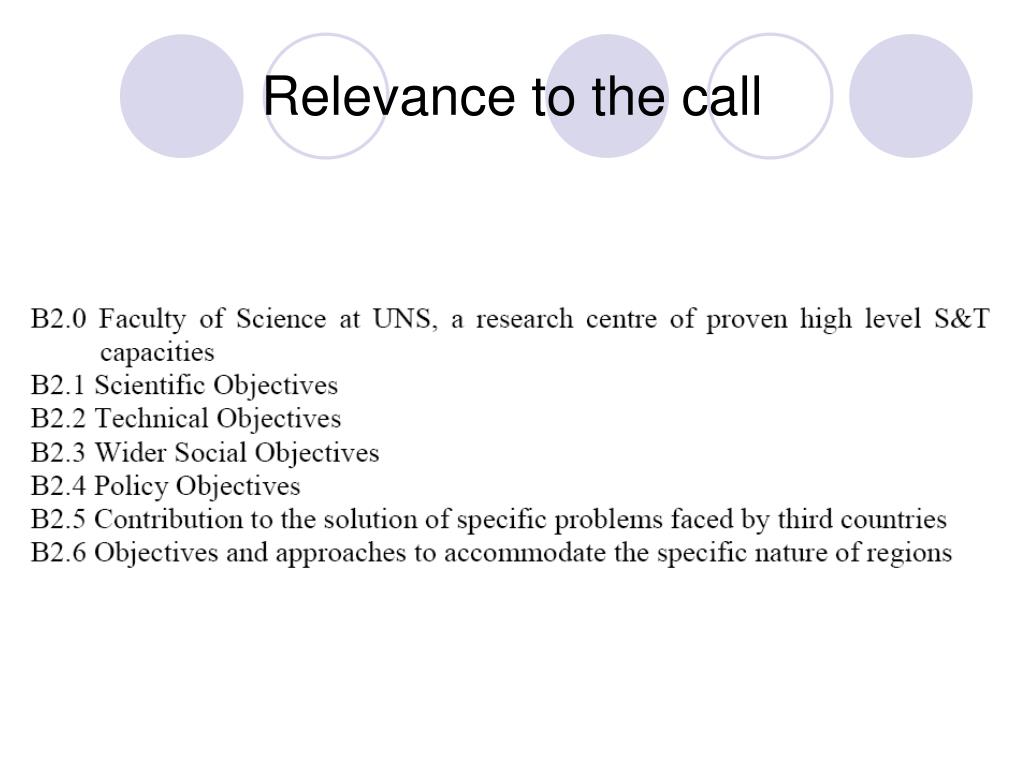

The Call: INCO-WBC/SSA-3 • Priorities for the single call SSA in 2005 • Networking, academic visits, hiring young researchers, maintaining S&T capacity • Criteria for relevance • Deliverables • Contribution to Research and Technological Development • Networking with other EU insitutions • Increased job oppurtunities
The Proposal – Part B • Part B: The proposal • Front page • Contents page • B0. Proposal summary • B1. Objectives of the proposed project • B2. Relevance to the objectives of the call • B3. Potential impact • B4. Project resources • B5. Project management • B6. Detailed Implementation Plan • B7. Other issues
The Proposal – Part B • Part B: The proposal • Front page • Contents page • B0. Proposal summary • B1. Objectives of the proposed project • B2. Relevance to the objectives of the call • B3. Potential impact • B4. Project resources • B5. Project management • B6. Detailed Implementation Plan • B7. Other issues

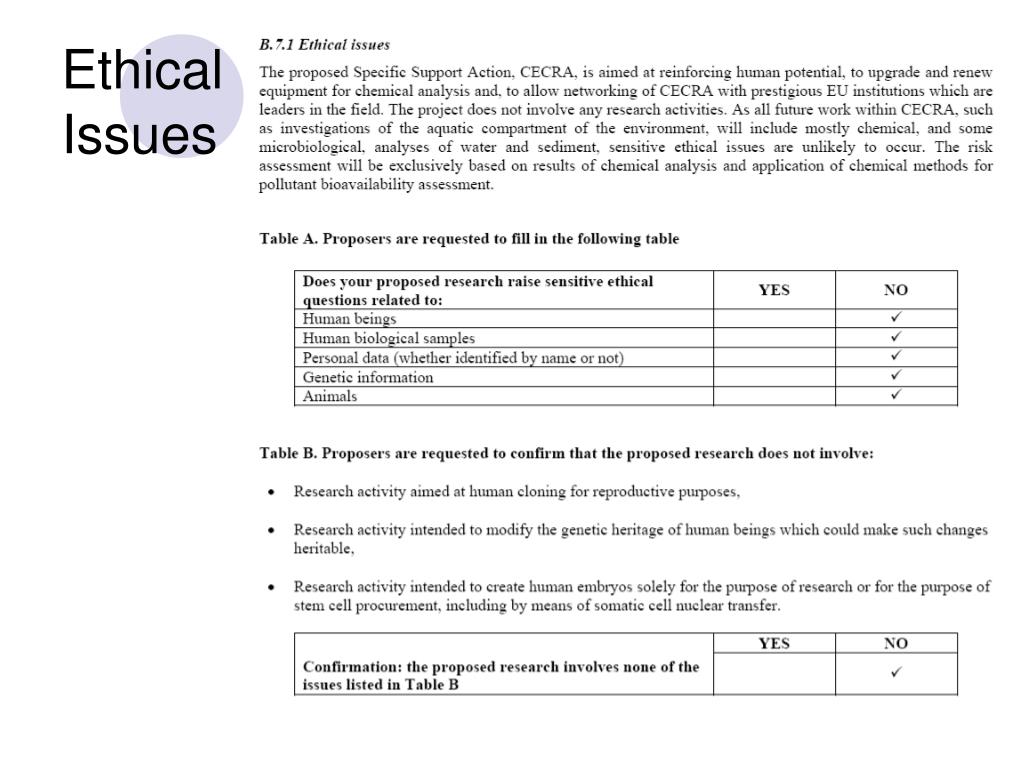

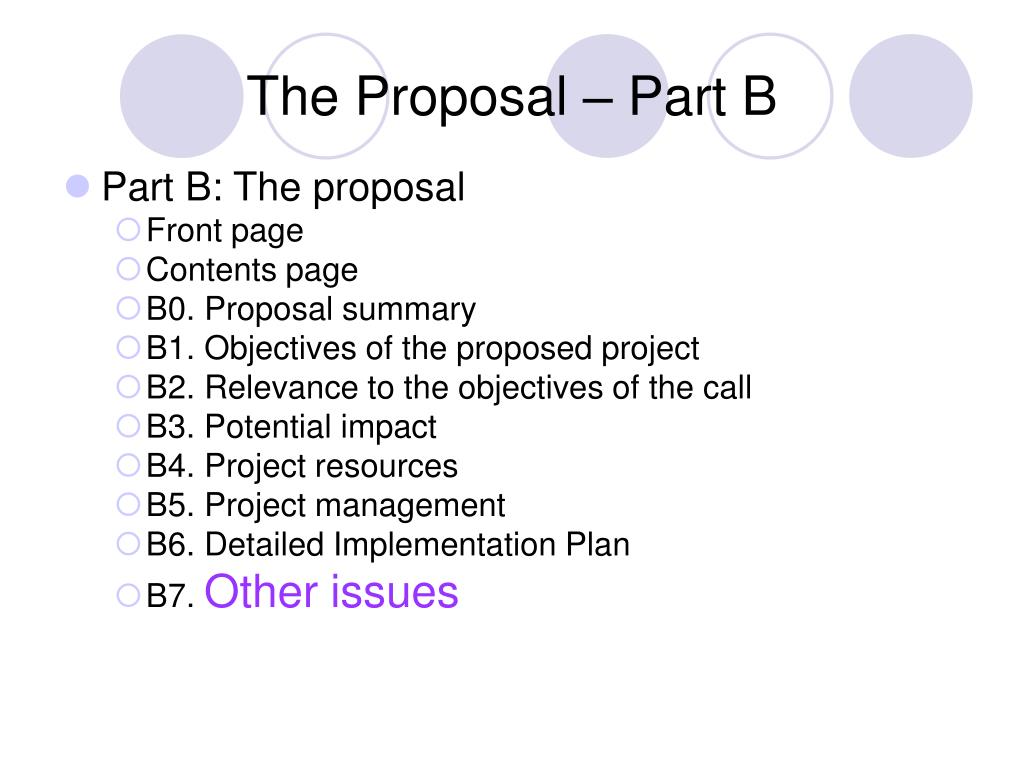

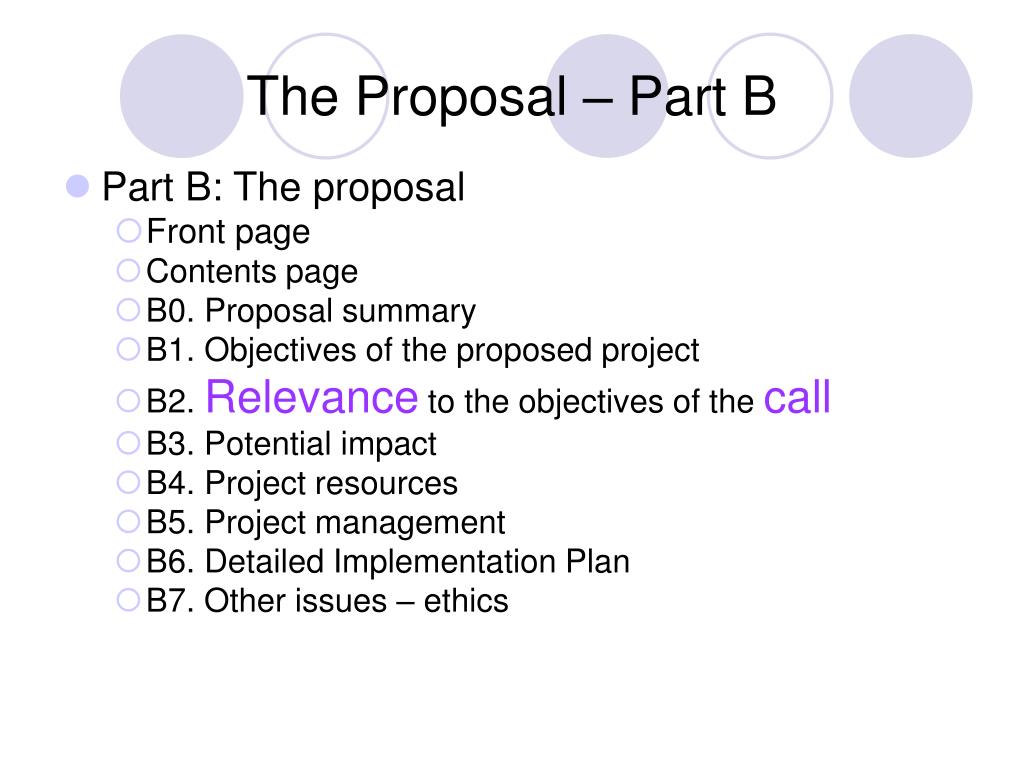

The Proposal – Part B • Part B: The proposal • Front page • Contents page • B0. Proposal summary • B1. Objectives of the proposed project • B2. Relevance to the objectives of the call • B3. Potential impact • B4. Project resources • B5. Project management • B6. Detailed Implementation Plan • B7. Other issues – ethics

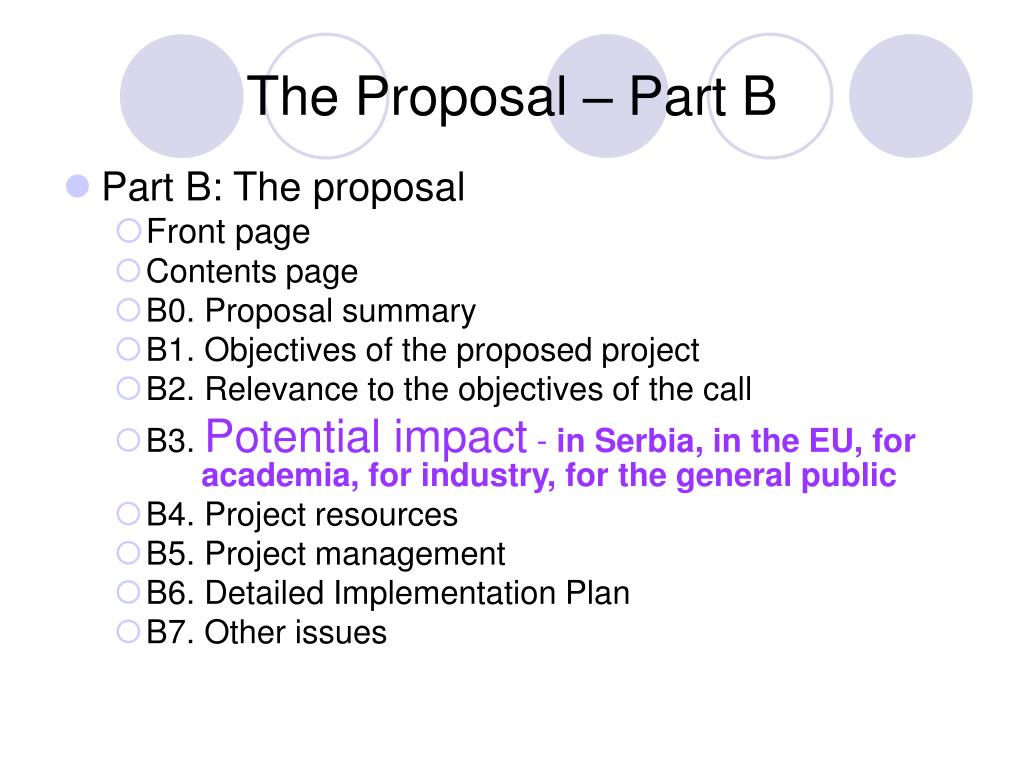

The Proposal – Part B • Part B: The proposal • Front page • Contents page • B0. Proposal summary • B1. Objectives of the proposed project • B2. Relevance to the objectives of the call • B3. Potential impact-in Serbia, in the EU, for academia, for industry, for the general public • B4. Project resources • B5. Project management • B6. Detailed Implementation Plan • B7. Other issues

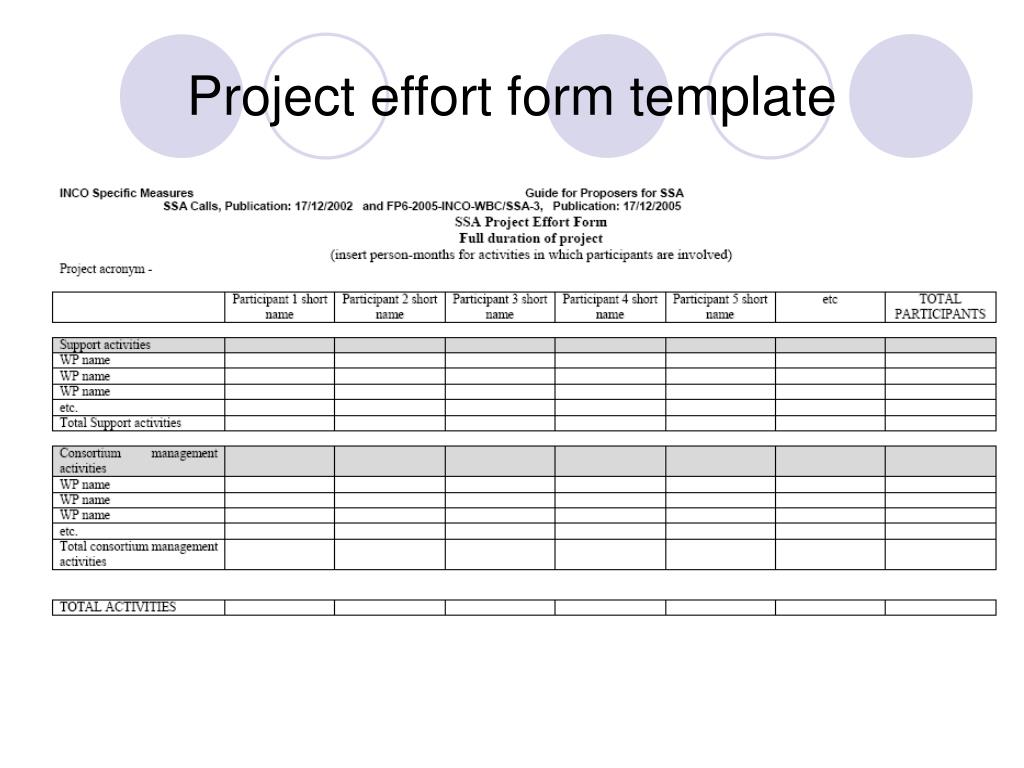

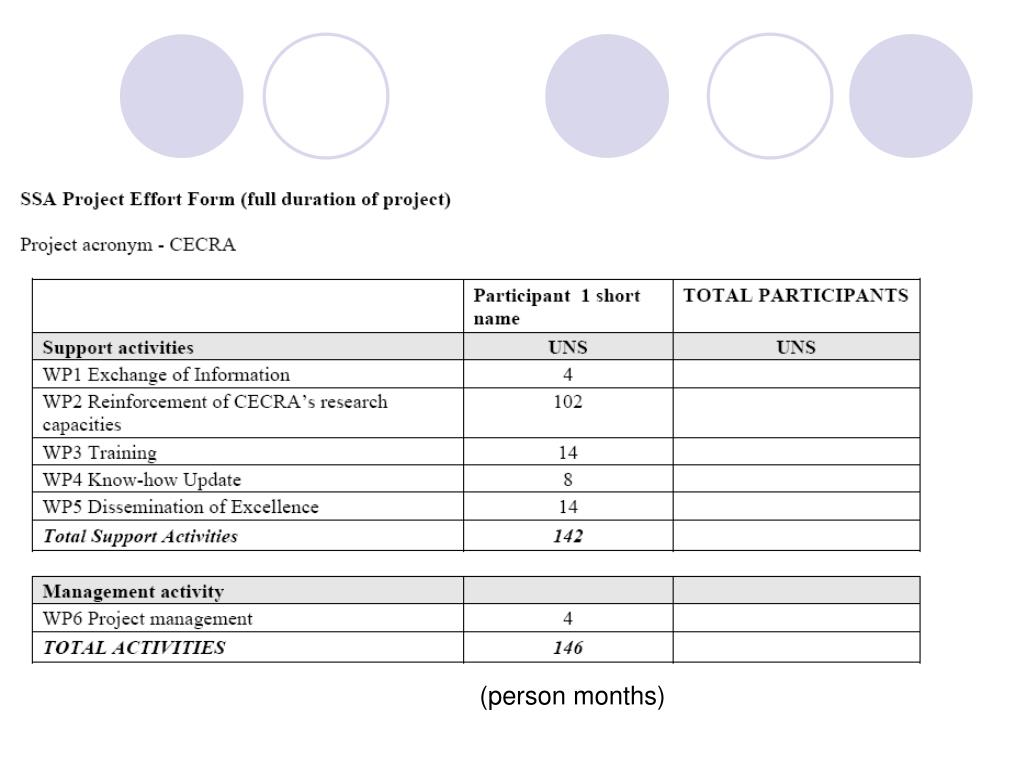

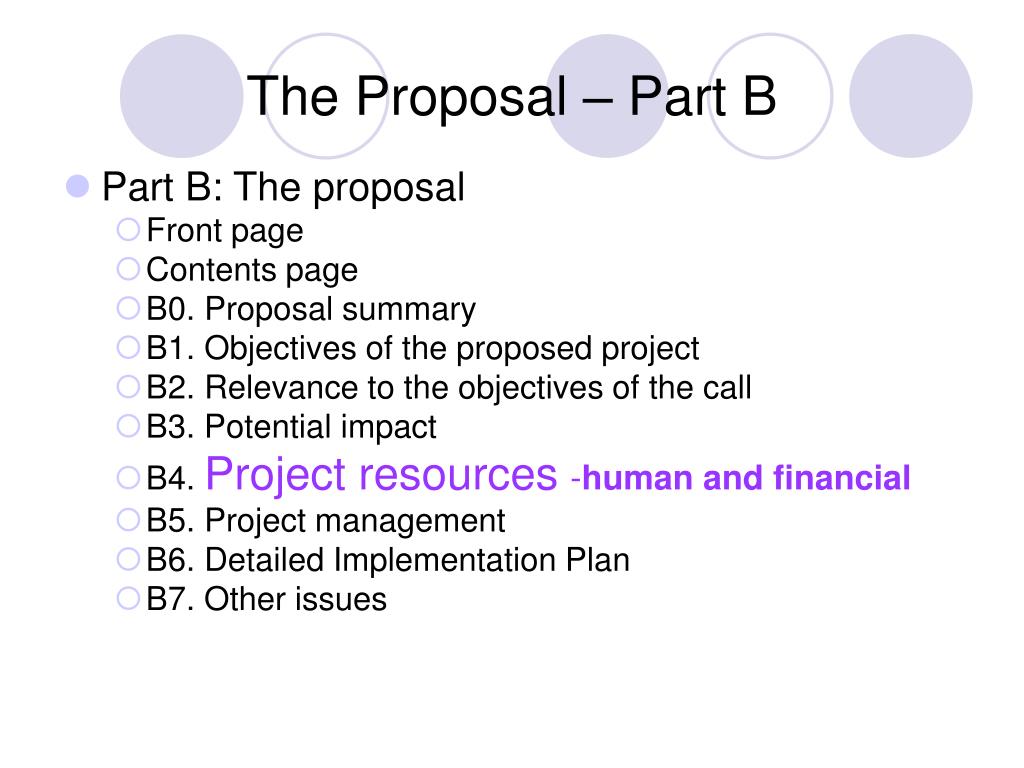

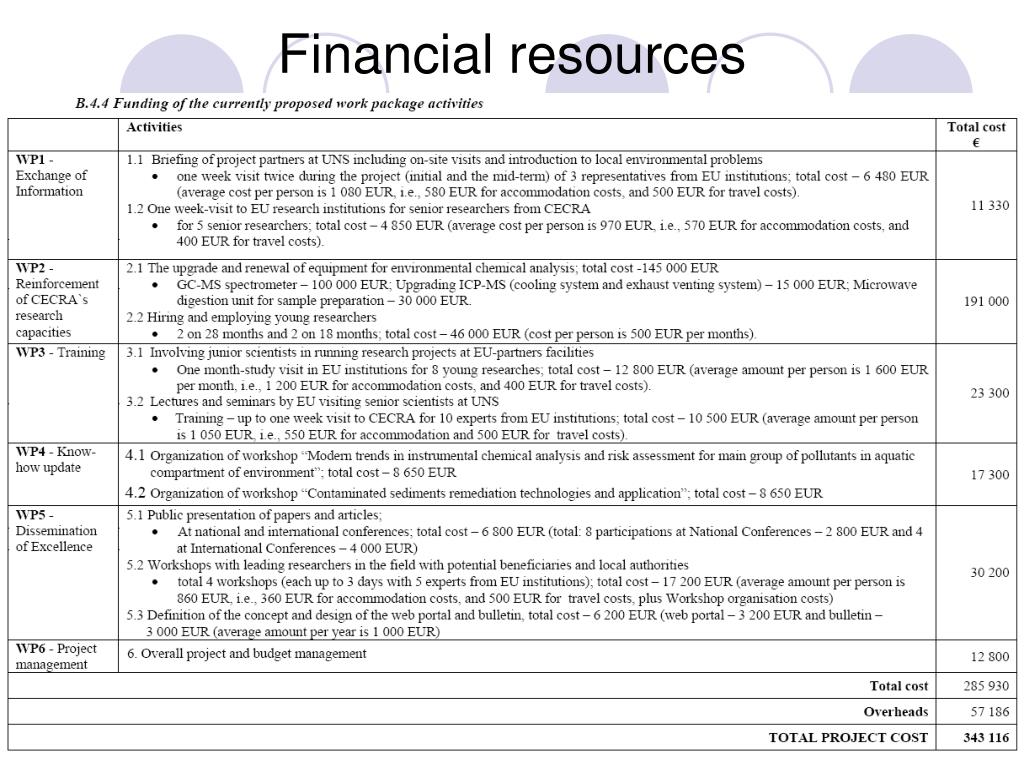

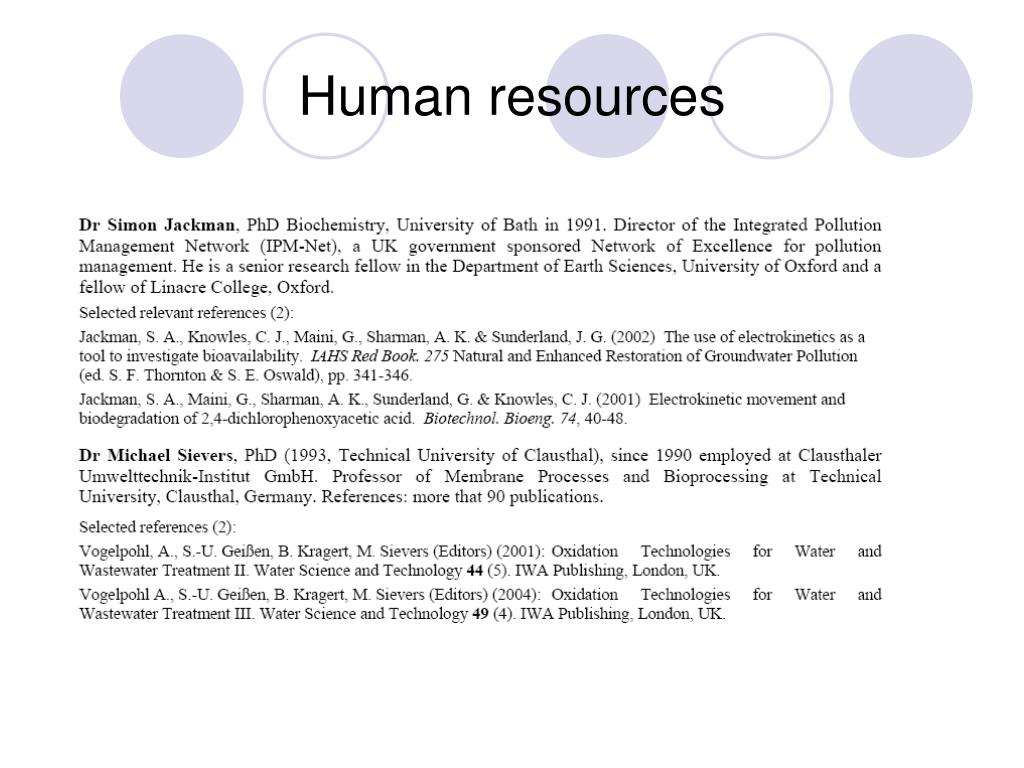

The Proposal – Part B • Part B: The proposal • Front page • Contents page • B0. Proposal summary • B1. Objectives of the proposed project • B2. Relevance to the objectives of the call • B3. Potential impact • B4. Project resources-human and financial • B5. Project management • B6. Detailed Implementation Plan • B7. Other issues
The Proposal – Part B • Part B: The proposal • Front page • Contents page • B0. Proposal summary • B1. Objectives of the proposed project • B2. Relevance to the objectives of the call • B3. Potential impact • B4. Project resources • B5. Project management • B6. Detailed Implementation Plan • B7. Other issues

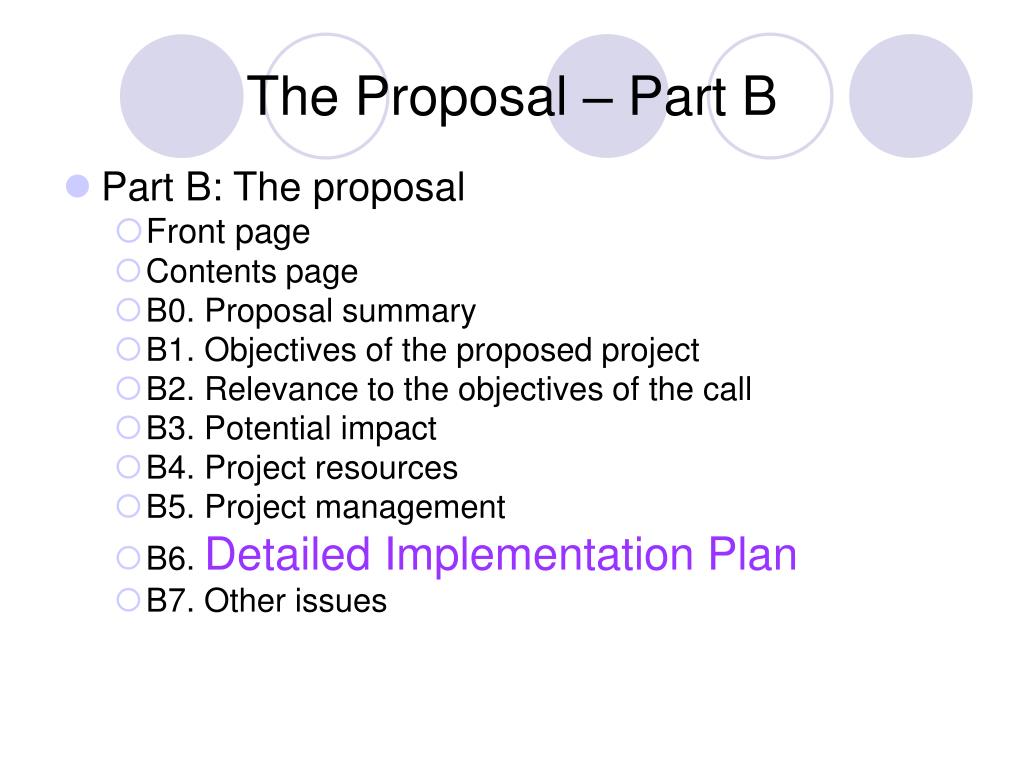

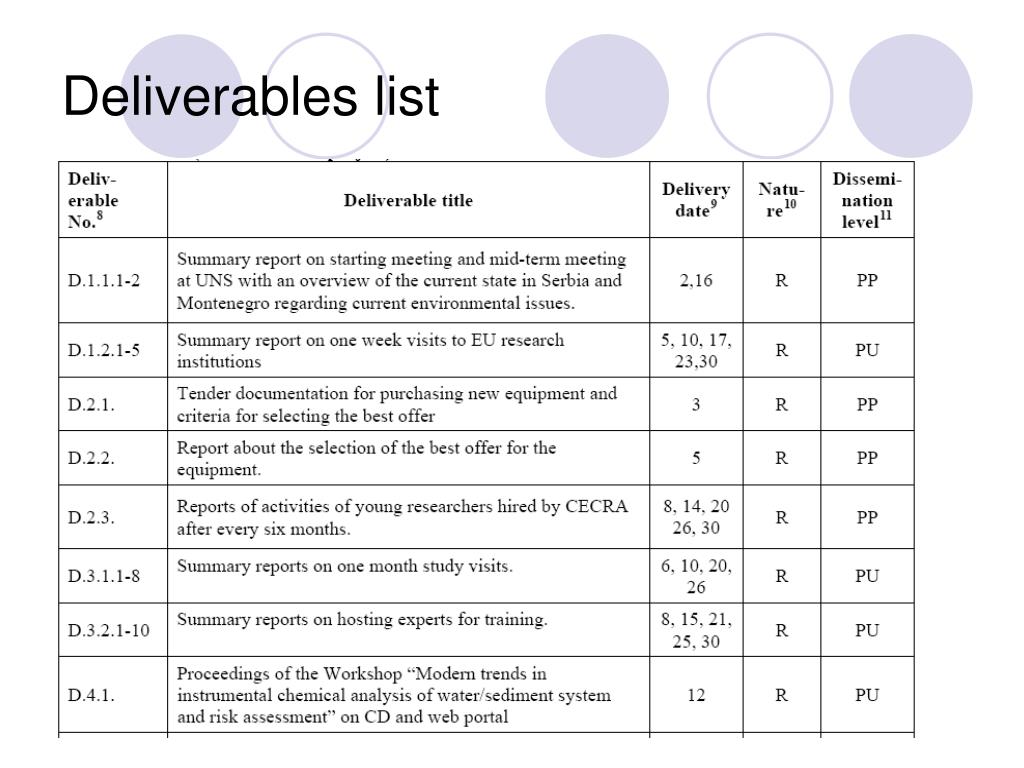

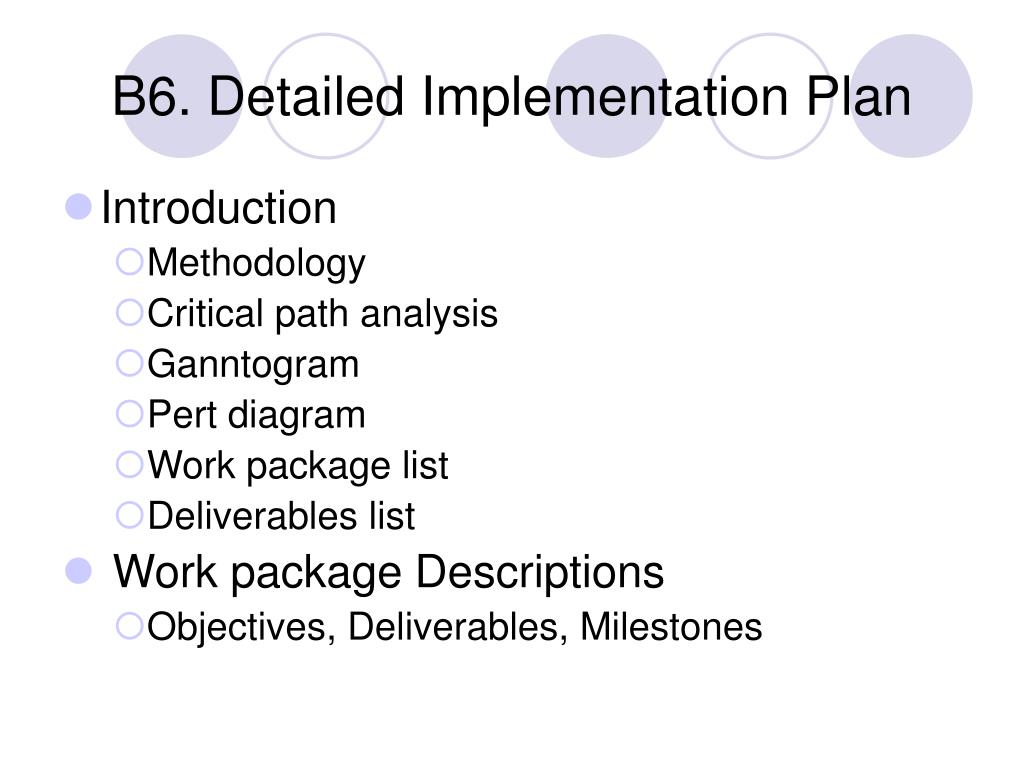

B6. Detailed Implementation Plan • Introduction • Methodology • Critical path analysis • Ganntogram • Pert diagram • Work package list • Deliverables list • Work package Descriptions • Objectives, Deliverables, Milestones

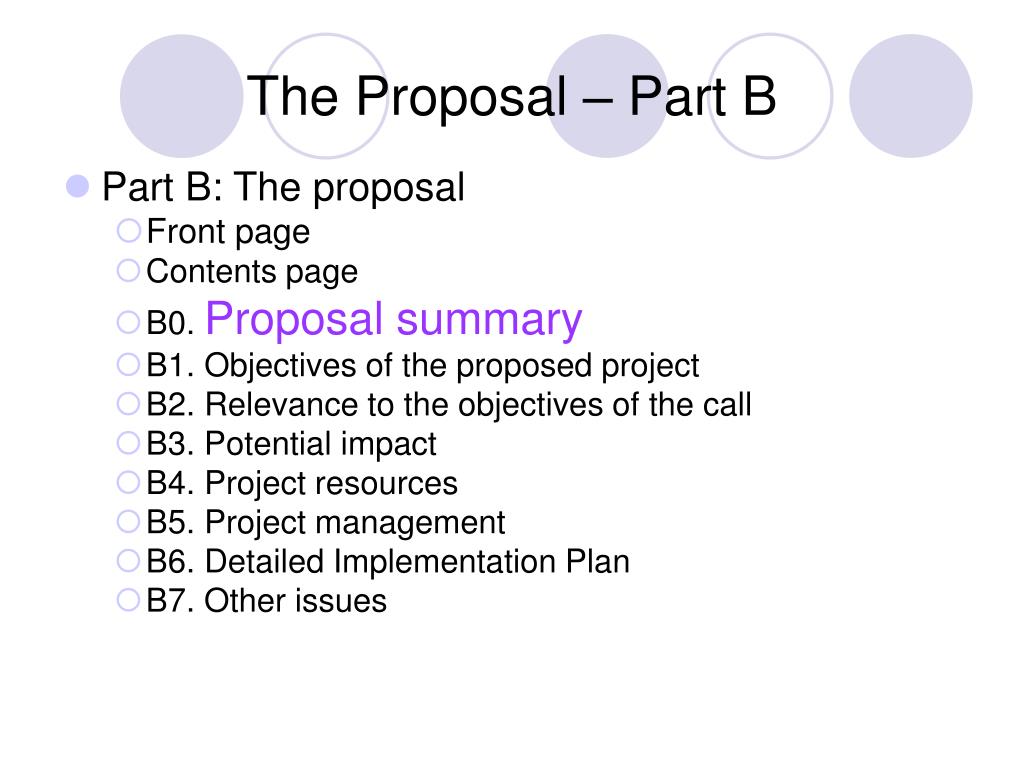

The Proposal – Part B • Part B: The proposal • Front page • Contents page • B0. Proposal summary • B1. Objectives of the proposed project • B2. Relevance to the objectives of the call • B3. Potential impact • B4. Project resources • B5. Project management • B6. Detailed Implementation Plan • B7. Other issues

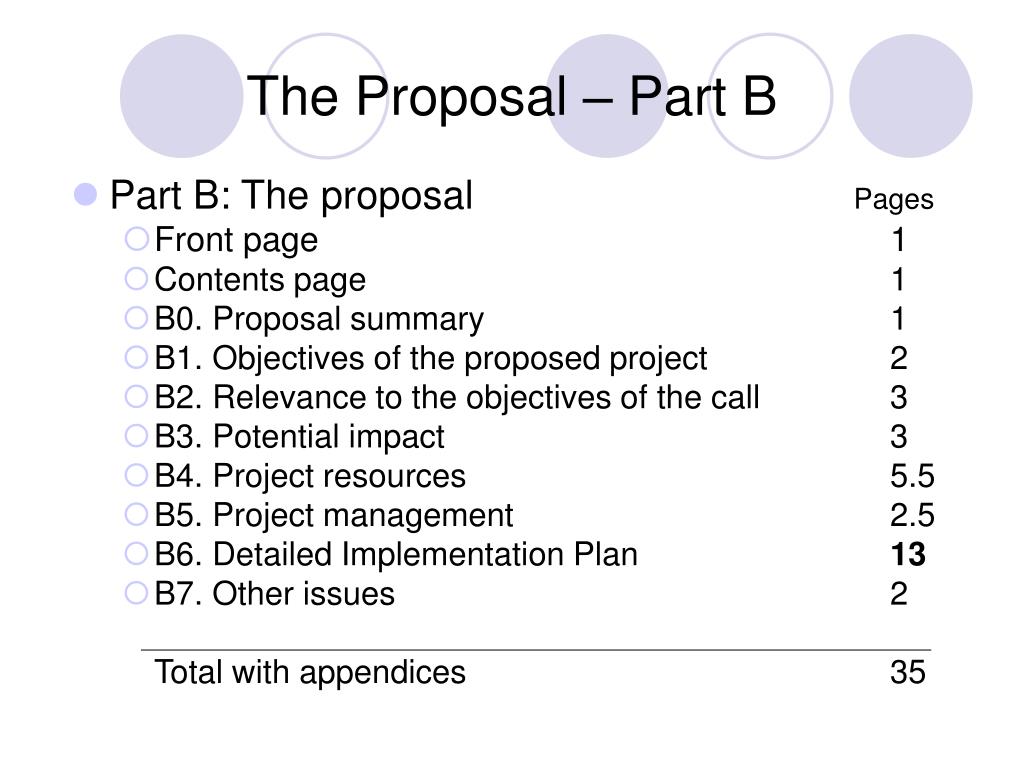

The Proposal – Part B • Part B: The proposalPages • Front page 1 • Contents page 1 • B0. Proposal summary 1 • B1. Objectives of the proposed project 2 • B2. Relevance to the objectives of the call 3 • B3. Potential impact 3 • B4. Project resources 5.5 • B5. Project management 2.5 • B6. Detailed Implementation Plan13 • B7. Other issues 2 Total with appendices 35

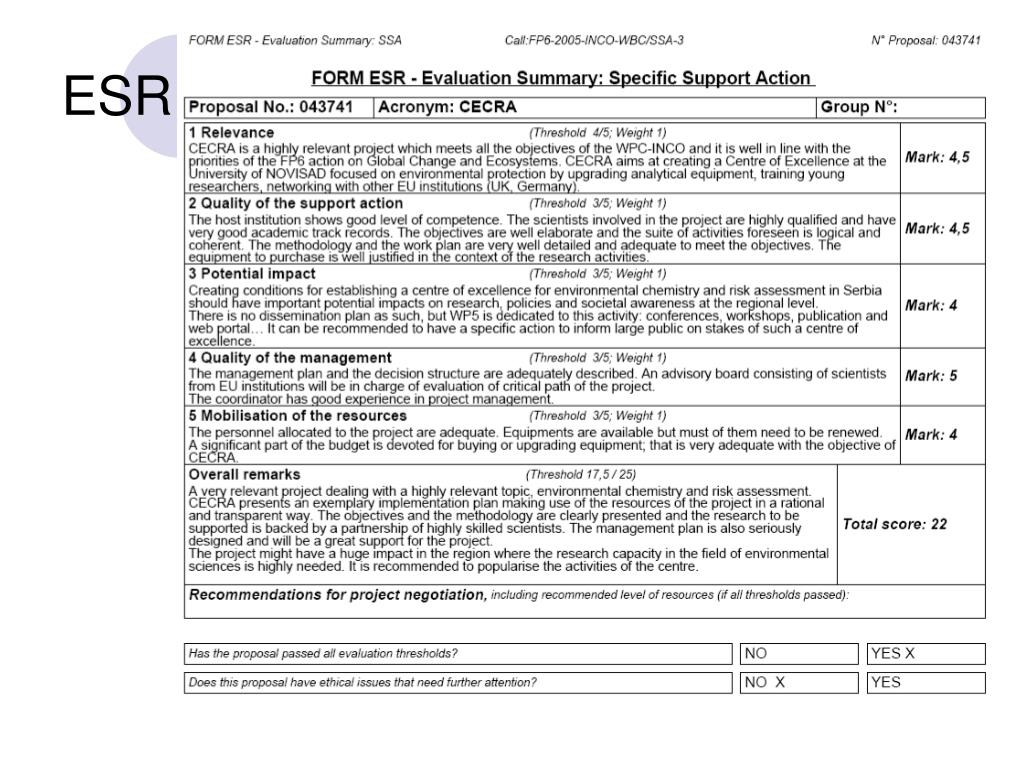

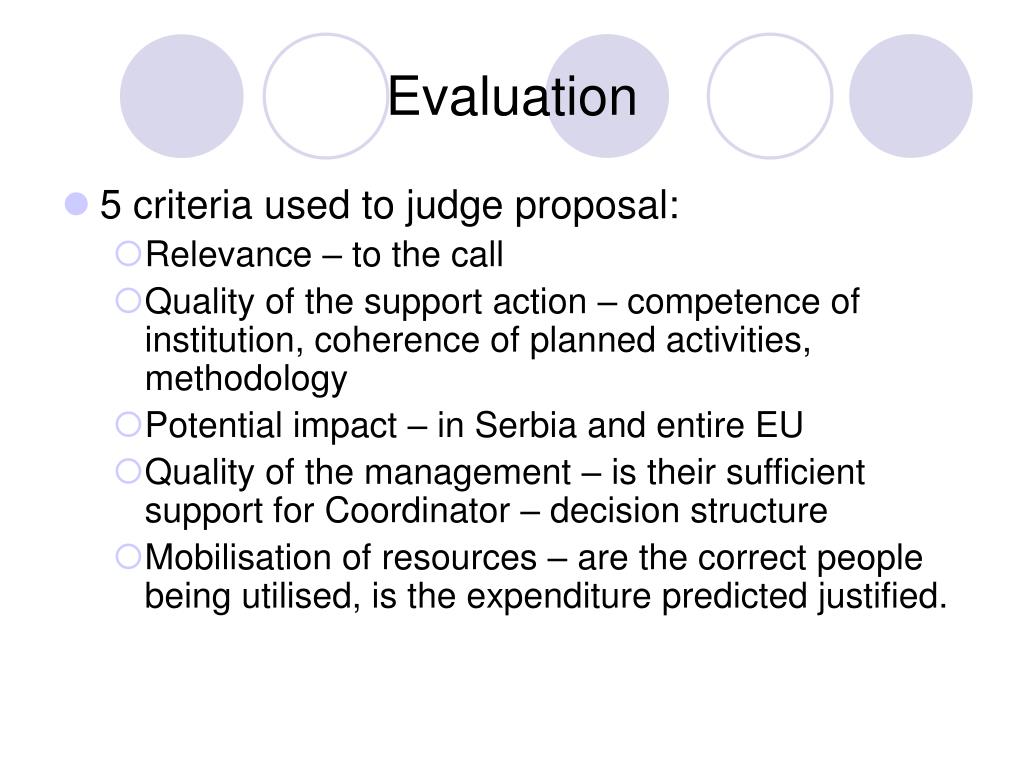

Evaluation • 5 criteria used to judge proposal: • Relevance – to the call • Quality of the support action – competence of institution, coherence of planned activities, methodology • Potential impact – in Serbia and entire EU • Quality of the management – is their sufficient support for Coordinator – decision structure • Mobilisation of resources – are the correct people being utilised, is the expenditure predicted justified.
Negotiation • Contract Preparation Forms (CPFs) • More detailed version of Part A from proposal – bank details, various legal declarations • Contract Technical Annex • Based on the proposal, restructured. • Any changes to your proposal suggested by the EC or the evaluators must be implemented
