1 / 20

SUBCONTRACT MANAGEMENT

SUBCONTRACT MANAGEMENT. Pamela McFarland. AGENDA. Statement of Work (SOW) Terms and Conditions Risk Assessment Site Visits Liability Records Disposition. STATEMENT OF WORK. Incorporate requirements into SOW as deliverable line items Physical Inventory Requirements

valin
Télécharger la présentation

SUBCONTRACT MANAGEMENT

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. SUBCONTRACTMANAGEMENT Pamela McFarland

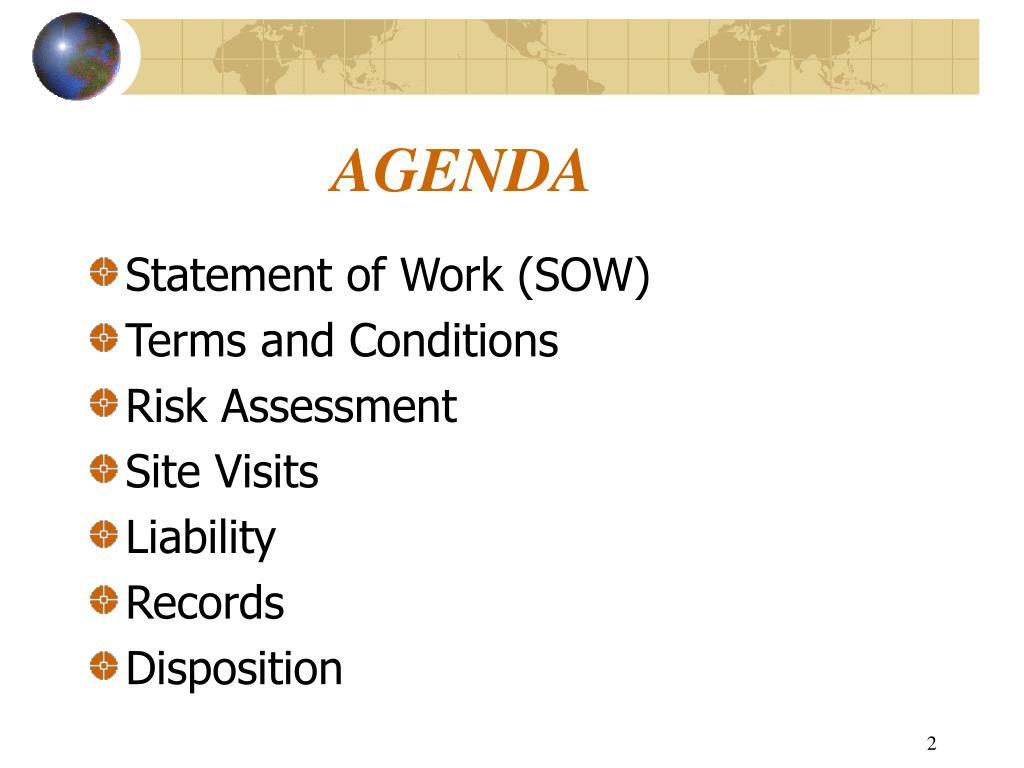

  2. AGENDA • Statement of Work (SOW) • Terms and Conditions • Risk Assessment • Site Visits • Liability • Records • Disposition

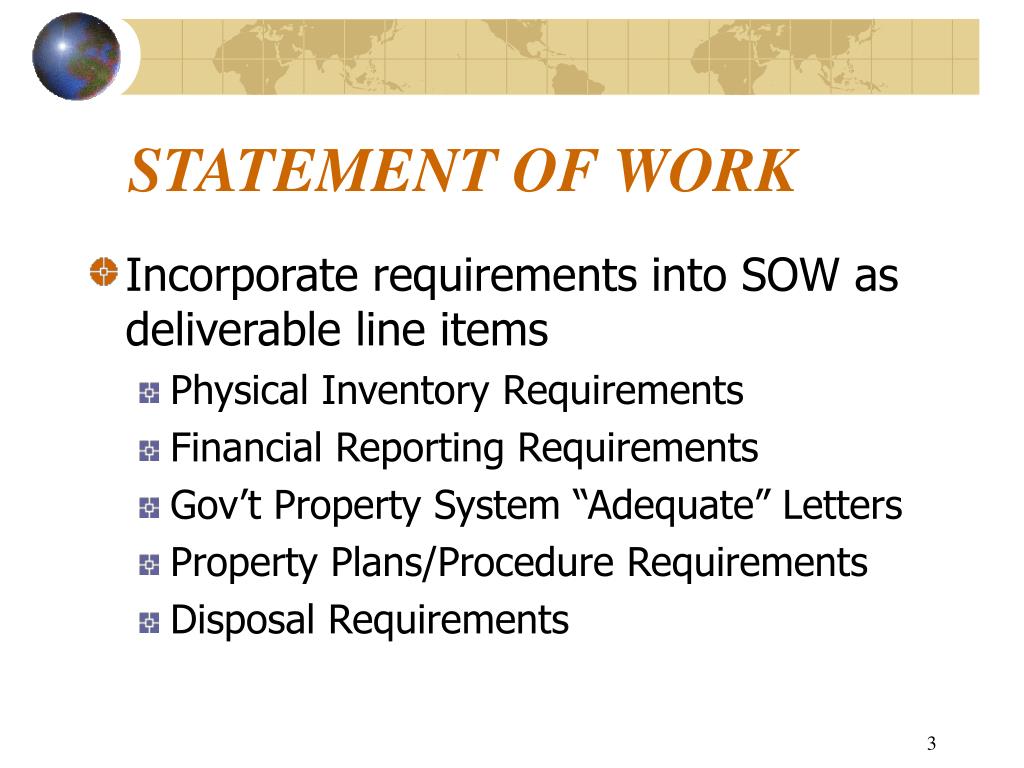

  3. STATEMENT OF WORK • Incorporate requirements into SOW as deliverable line items • Physical Inventory Requirements • Financial Reporting Requirements • Gov’t Property System “Adequate” Letters • Property Plans/Procedure Requirements • Disposal Requirements

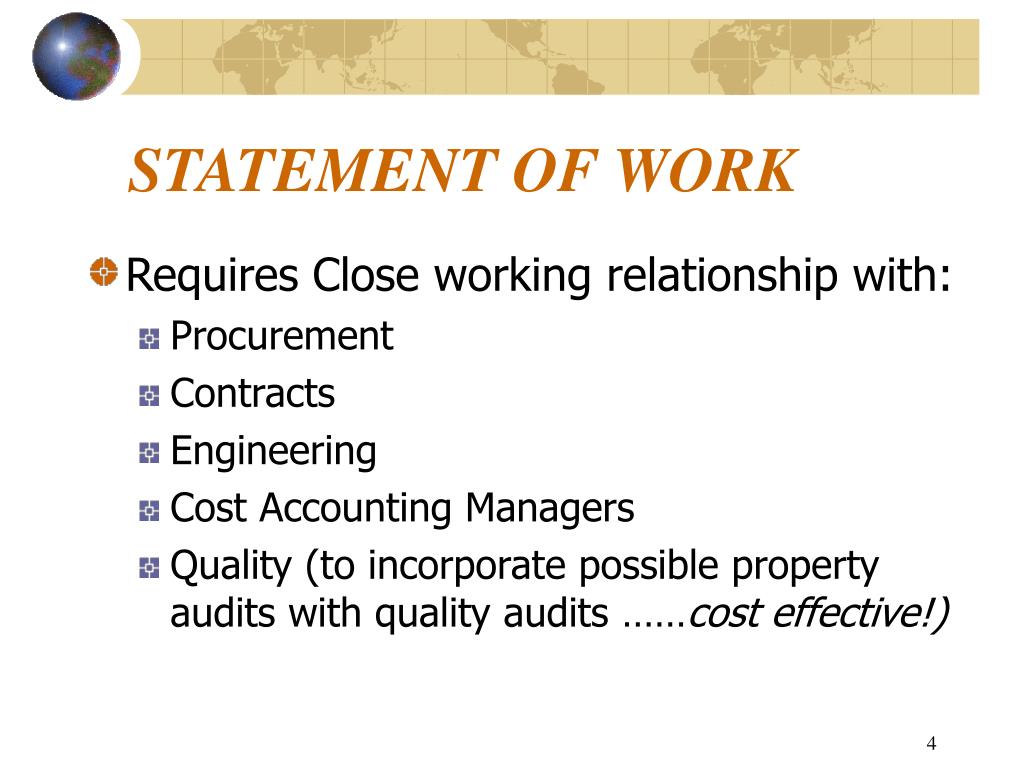

  4. STATEMENT OF WORK • Requires Close working relationship with: • Procurement • Contracts • Engineering • Cost Accounting Managers • Quality (to incorporate possible property audits with quality audits ……cost effective!)

  5. TERMS and CONDITIONS • Flow all property requirements (FAR 52.245, and NASA or DoD Supplements) into the Terms and Conditions of Every Contract • May seem redundant, but acquisition or furnishing GP/CP may not be known at time of SOW. • Be careful on flowing Limited Risk of Loss.

  6. RISK ASSESSMENT • Once the subcontract is in place and property is accountable. • Assessments should consider the following: • Total Dollar Value of property • Is there a Property Plan? • Does the sub have an “adequate” system? • Have they had LDD’s? • Do they have lower tier subs? • Have they implemented UID? (DoD) • Do they have procedures? • Does the sub use Metrics?

  7. RISK ASSESSMENT • Assessments should be completed annually: • To ascertain surveillance requirements (i.e., “on-site” versus desk surveillance) • Review for support property administration delegation • DCMA is NOT going to approve 99% of the requests for SPA delegation. Oversight is a requirement of the Prime.

  8. RISK ASSESSMENT • PURPOSE To provide an objective and disciplined risk assessment analysis of subcontractors • METHODOLOGY • Identify areas of vulnerability • Focus on optimal levels of risk • Efficient commitment of resources • KEY ATTRIBUTES The risk categories and the corresponding measurements have been identified in the following charts

  9. RISK ASSESSMENT DoD

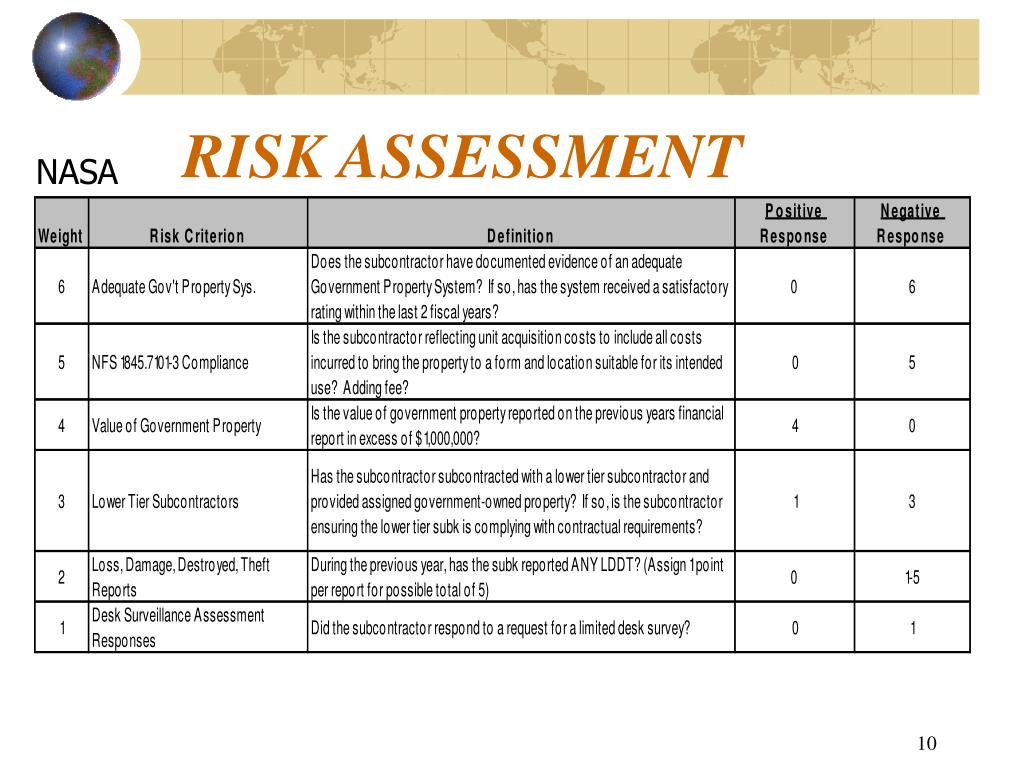

  10. RISK ASSESSMENT NASA

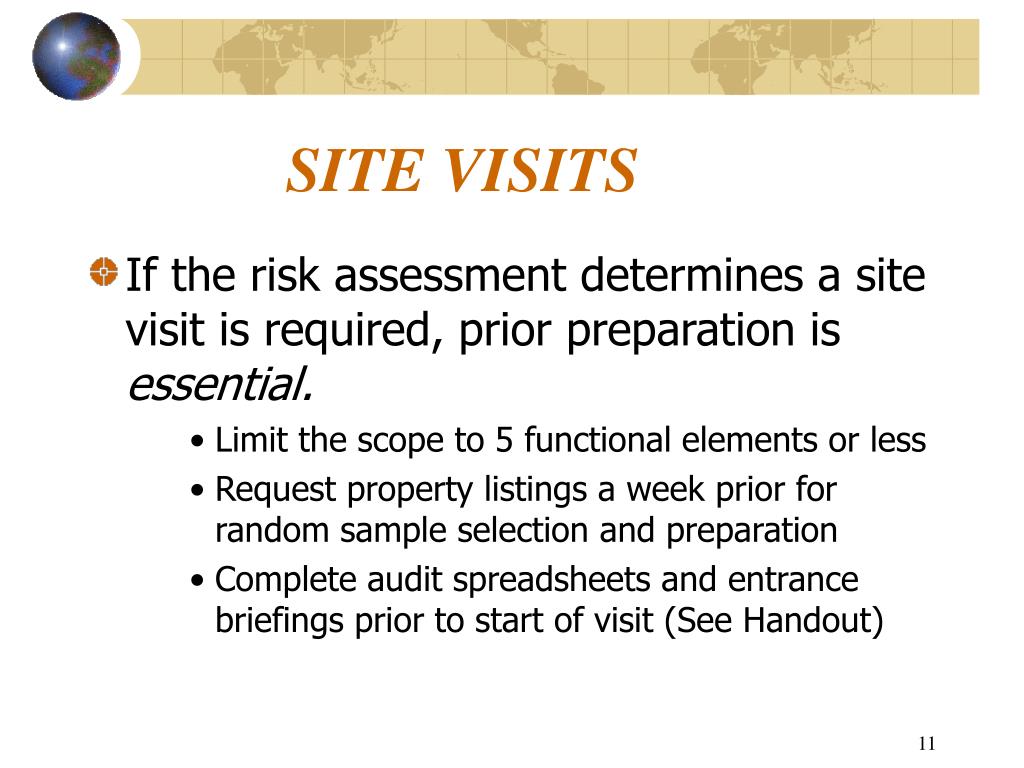

  11. SITE VISITS • If the risk assessment determines a site visit is required, prior preparation is essential. • Limit the scope to 5 functional elements or less • Request property listings a week prior for random sample selection and preparation • Complete audit spreadsheets and entrance briefings prior to start of visit (See Handout)

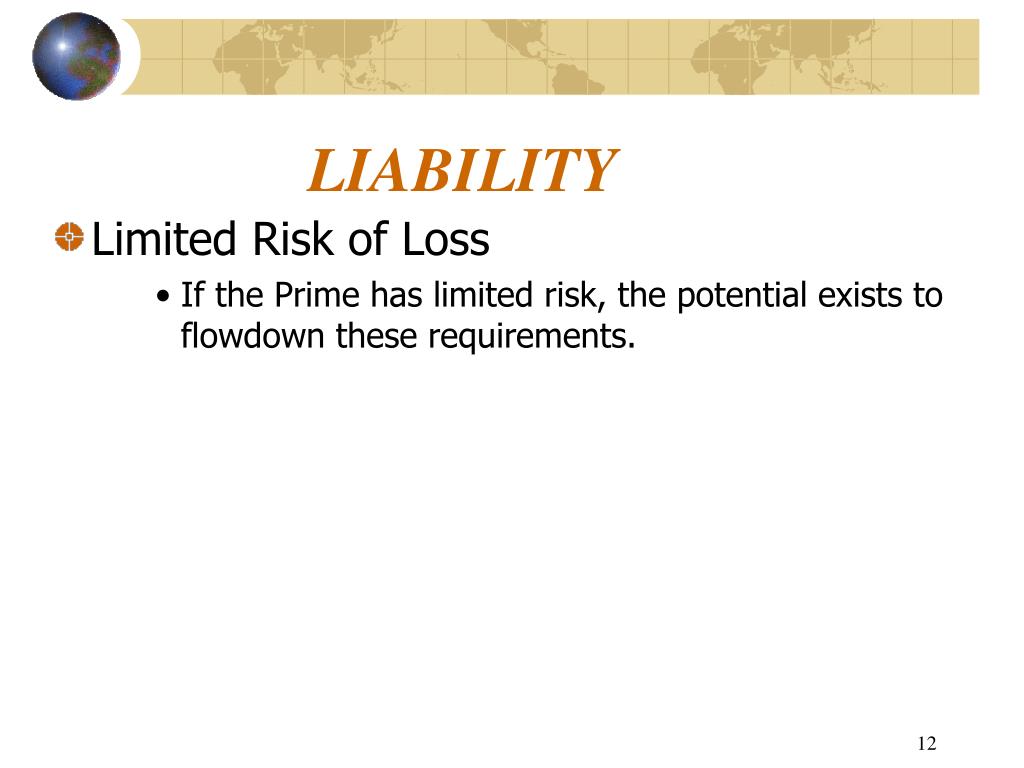

  12. LIABILITY • Limited Risk of Loss • If the Prime has limited risk, the potential exists to flowdown these requirements.

  13. Determining Risk Provision FIRST SIMPLE APPLICATION COST REIMBURSEMENT SUBCONTRACTOR Being awarded a subcontract Exceeding $650,000 AND Containing 52.215-12* AND Providing Government Property + GP Requirements FIXED PRICE SUBCONTRACTOR Being awarded a subcontract (Competitive or Negotiated) Exceeding $650,000 AND Containing 52.215-12* AND Providing Government Property + GP Requirements Automatically Flow Down The Limited Risk of Loss GP Provision COST REIMBURSEMENT or FIXED PRICE (NEGOTIATED) PRIME CONTRACT/CONTRACTOR EXCEEDING $650,000 (Requiring a Cert of Current Cost and Pricing Data) and FAR 52.215-12* and WITH GOVERNMENT PROPERTY CLAUSE of FAR 52.245-1 LIMITED RISK OF LOSS *NOTE: There are Exceptions at 15.403-1 where this clause is NOT required.

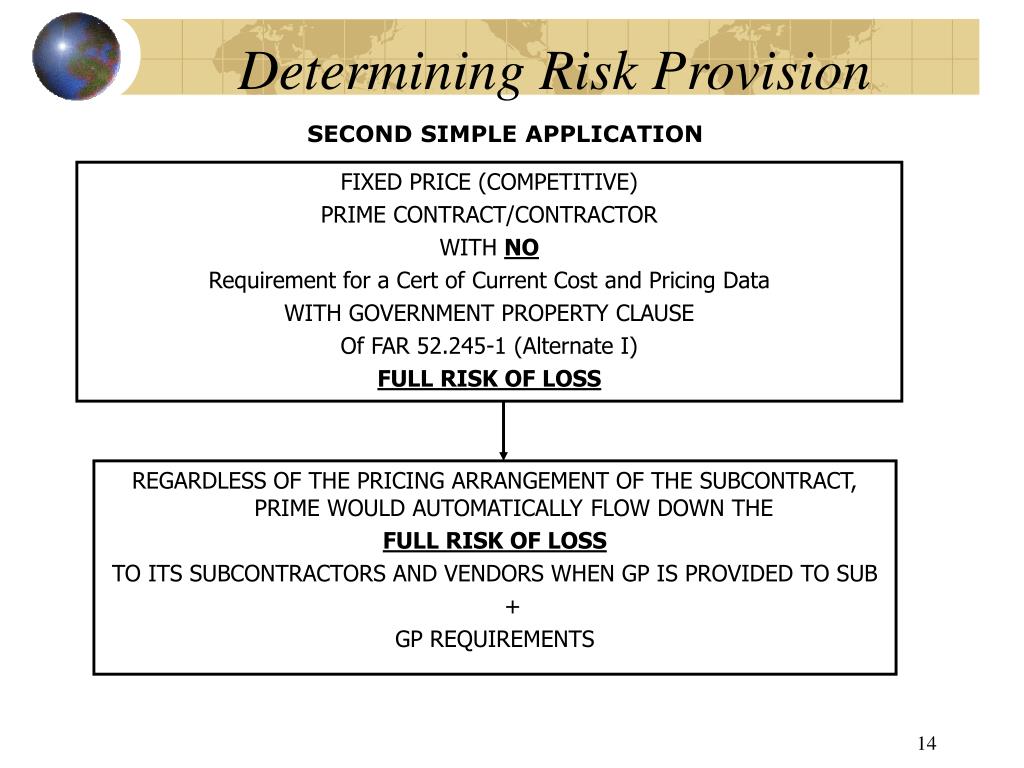

  14. Determining Risk Provision SECOND SIMPLE APPLICATION FIXED PRICE (COMPETITIVE) PRIME CONTRACT/CONTRACTOR WITH NO Requirement for a Cert of Current Cost and Pricing Data WITH GOVERNMENT PROPERTY CLAUSE Of FAR 52.245-1 (Alternate I) FULL RISK OF LOSS REGARDLESS OF THE PRICING ARRANGEMENT OF THE SUBCONTRACT, PRIME WOULD AUTOMATICALLY FLOW DOWN THE FULL RISK OF LOSS TO ITS SUBCONTRACTORS AND VENDORS WHEN GP IS PROVIDED TO SUB + GP REQUIREMENTS

  15. Determining Risk Provision REQUIRES SOME THOUGHT COST REIMBURSEMENT or FIXED PRICE (NEGOTIATED) PRIME CONTRACT/CONTRACTOR EXCEEDING $650,000 (Requiring a Cert of Current Cost and Pricing Data) AND FAR 52.215-12* AND WITH GOVERNMENT PROPERTY CLAUSE Of FAR 52.245-1 LIMITED RISK OF LOSS FIXED PRICE NEGOTIATEDSUBCONTRACT Being Awarded to a Subcontractor UNDER $650,000 AND NOT Containing 52.215-12 AND Providing Government Property + GP REQUIREMENTS FIXED PRICE COMPETITIVE SUBCONTRACT/ SUBCONTRACTOR AND Providing Government Property + GP Requirements PRIME FLOWS DOWN FULL RISK PRIME MAY FLOW DOWN LIMITED RISK OF LOSS IF….PRIME REQUIRES SUB TO EXCLUDE INSURANCE FOR GP. IF UNABLE/UNWILLING TO EXCLUDE INSURANCE – FLOW DOWN FULL! *NOTE: There are exceptions at 15.403-1 where this clause is NOT required.

  16. LIABILITY Remember…………….. If the subcontractor does NOT have the limited risk clause, then YOU, as the prime, are responsible for obtaining payment.

  17. RECORDS • Subcontractor Records • Two methods exist pertaining to records • The subcontractor maintains the record, or …… • YOU, the prime, maintain the record • Pros and Cons for both methods • You must rely on the subcontractor for everything, when the sub keeps the records. • If you keep the records, are they “up to date”? How do you get notified when the property moves, gets issued, or ships?

  18. DISPOSITION • Program Screening MUST be completed first. • Several Methods of Disposal • PCARSS (Plant Clearance Reutilization Screening System) • Ship back to Prime for retention/reutilization • Ship back to Prime for disposal (Yikes!)

  19. MANAGING SUBCONTRACTORS • REMEMBER …………We must reflect the value that property management adds to the company “bottom line”. We must be resourceful and flexible, and we can NOT do it alone. Creating and maintaining a good working rapport with your subcontractor is ……. ESSENTIAL !!

  20. QUESTIONS • QUESTIONS ? • CONCERNS ? • COMMENTS ? Thank You Pamela McFarland, Raytheon Technical Services Co., LLC Work: 260-486-5237 Cell: 260-446-7190

More Related
