Walking the Tight-Rope. Software Project Management in Real Life Urbán Zoltán, Várszegi György 2 004. Introduction. There are well established theories about project management. In practice they are easiest to follow for small-sized independent (demo) projects
Walking the Tight-Rope
E N D
Presentation Transcript
Walking the Tight-Rope Software Project Managementin Real Life Urbán Zoltán, Várszegi György2004

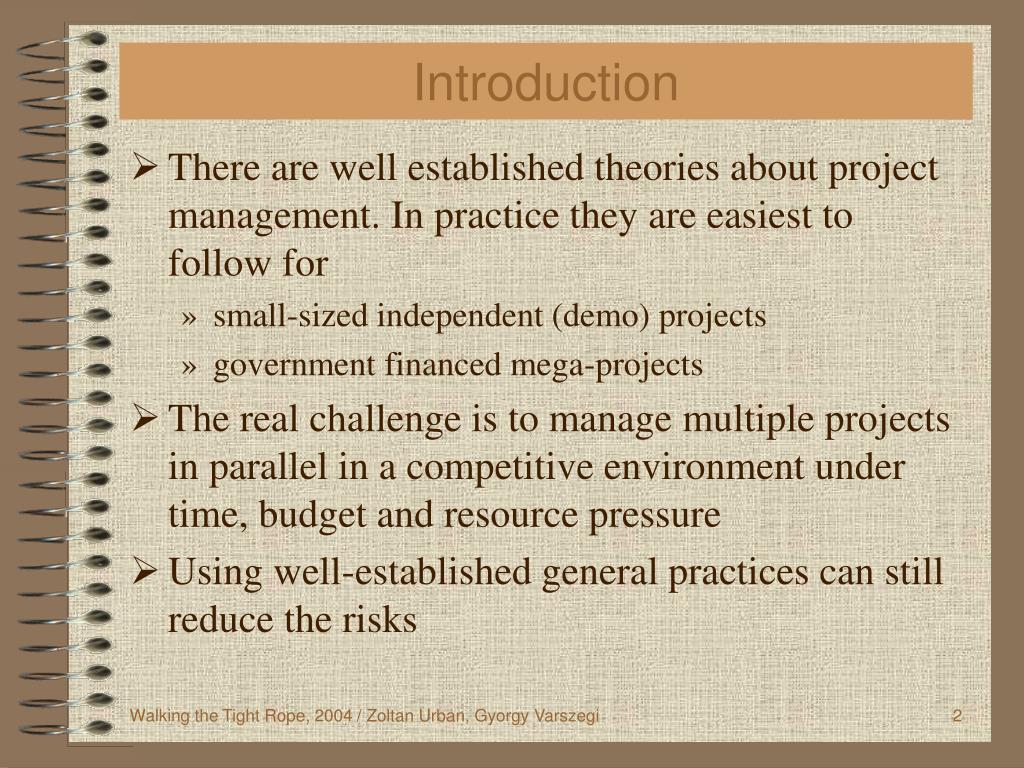

Introduction • There are well established theories about project management. In practice they are easiest to follow for • small-sized independent (demo) projects • government financed mega-projects • The real challenge is to manage multiple projects in parallel in a competitive environment under time, budget and resource pressure • Using well-established general practices can still reduce the risks Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Who we are • ScanSoft, Inc. is a public company based in Boston, MA. With nearly 800 employees worldwide, it is the market-leading supplier of speech and imaging solutions. • ScanSoft-Recognita Rt. in Budapest is its only imaging development hub. Size of its engineering is about 90 heads • The ratio between development and QA is close to 2:1 Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Who we are • Our product portfolio is: • OmniPage: stand-alone OCR • PDF Converter Pro: opening and creating PDF files • PaperPort: document management system • OmniPage SDK: imaging development toolkit • OmniForm: form designer and data acquisition solution Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi

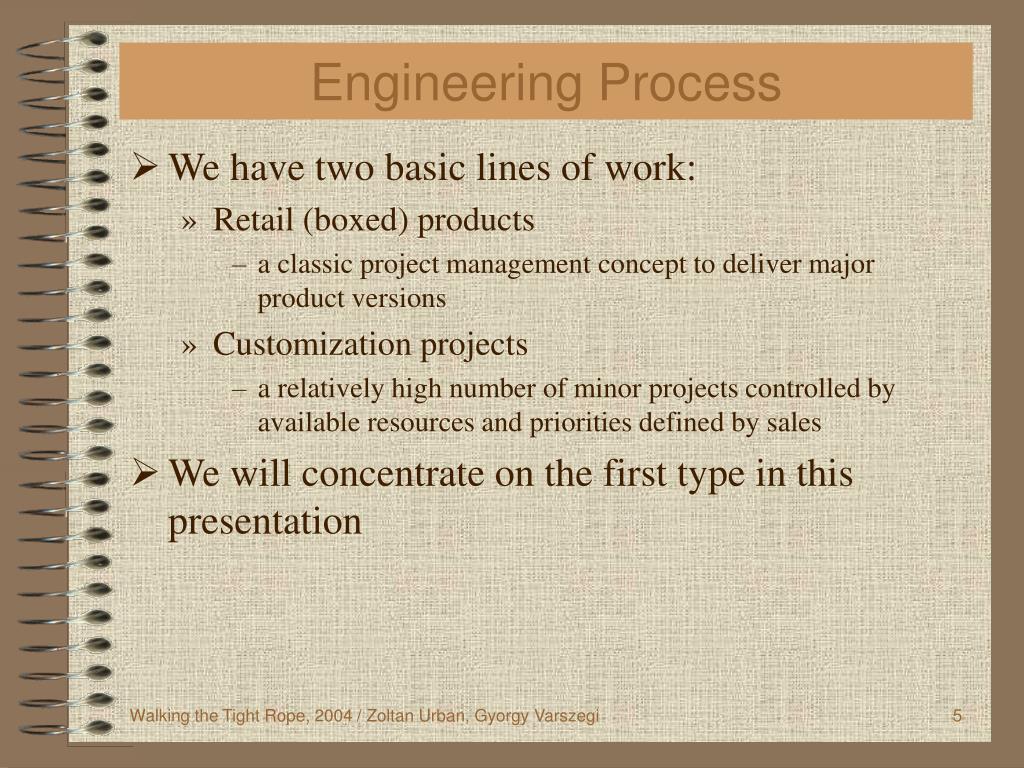

Engineering Process • We have two basic lines of work: • Retail (boxed) products • a classic project management concept to deliver major product versions • Customization projects • a relatively high number of minor projects controlled by available resources and priorities defined by sales • We will concentrate on the first type in this presentation Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Roles • For retail product projects the customer is not the contracting party for the development • Product Delivery Team (PDT) • Defines and delivers the product • A cross-functional group of area representatives • Program manager: the coordinator to drive toward team consensus • Product manager, marketing, international • Project manager, QA Lead, documentation, engineering • Technical support • Manufacturing • Product Approval Committee (PAC) • Approves, finances and supervises the project • Senior management of the company Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi

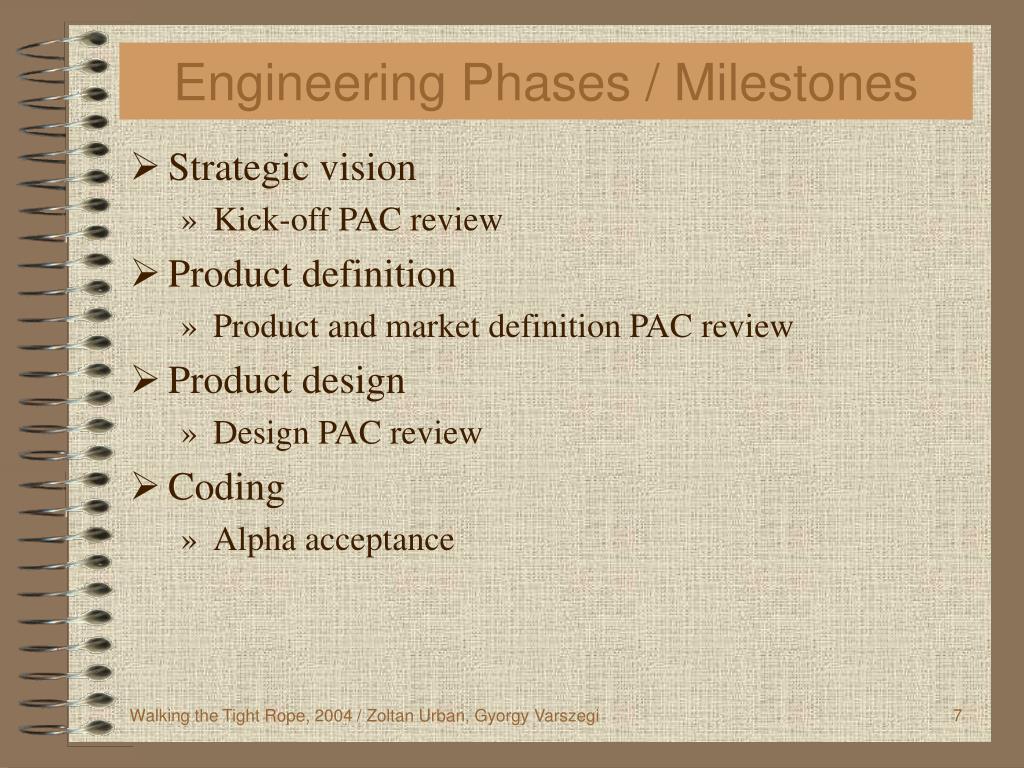

Engineering Phases / Milestones • Strategic vision • Kick-off PAC review • Product definition • Product and market definition PAC review • Product design • Design PAC review • Coding • Alpha acceptance Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Engineering Phases / Milestones • Alpha • UI freeze • Beta readiness PAC review • Beta acceptance • Beta • First release candidate (RC0) • Launch PAC review • Release to manufacturing (RTM) • Sustaining • RTM of localized versions, patches, point releases Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
PAC reviews • Regular PAC reviews • Planned delimiters of the phases • PDT demonstrates the current state and the successful termination of the previous phase • PDT presents a detailed plan for the rest of the project • Engineering: deliverables (25 varieties), schedule (100 date points), resource plan, technical overview, quality plan, documentation, localization, 3rd party components, risks • PAC decision can be • GO (contract for the next phase) • Redirect (major change in the course of the project) • Retry the review (inadequate input from PDT) • Cancel the project Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
PAC reviews • Exception reviews • Any material change in the course of the project that affects the “contract” for the current phase should prompt an exception review • Unexpected major market changes • Missed milestones • Budget overrun • Usually PDT (Program Manager) initiates them • The review materials and the PAC decision criteria are basically the same as at the regular reviews Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Life Cycle / Definition, Design • Our approach to these phases is iterative • Initial Marketing Requirements Document • Product marketing creates it. MRD0 for a 60 man-year project is typically less than 10 pages with about 60 new product features with very few details. • Functional Specification • Engineering has pretty wide freedom in implementation details • Feature-based (short and comprehensive descriptions, technical details, licensed components, test methodology, benchmarking, use cases, risks) • Incremental for existing product lines Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi

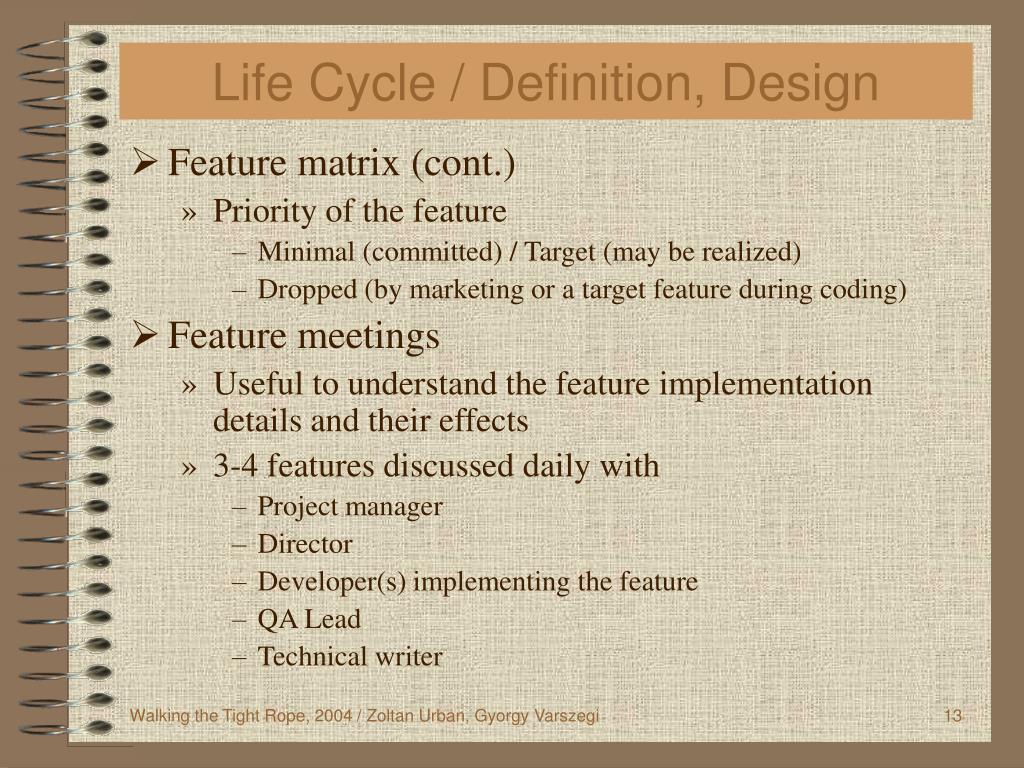

Life Cycle / Definition, Design • Feature matrix • Important communication and decision-making tool • To set realistic project goals (feedback to MRD) • To follow the coding progress until Alpha (weekly updates) • Required resources for each feature • Rows: features with owners and links to the feature descriptions • Columns: resource names • Cells: necessary man weeks (special skills considered) • Available resources • Considering holidays, other projects, project management • Padding 25-50% • for target features, unforeseen events, underestimated features Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Life Cycle / Definition, Design • Feature matrix (cont.) • Priority of the feature • Minimal (committed) / Target (may be realized) • Dropped (by marketing or a target feature during coding) • Feature meetings • Useful to understand the feature implementation details and their effects • 3-4 features discussed daily with • Project manager • Director • Developer(s) implementing the feature • QA Lead • Technical writer Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Life Cycle / Coding • Coding (Implementation) • High risk items first • New 3rd party items or new versions of them should be definitely taken care of first • Experts with unique knowledge • Very effective and very vulnerable • Technology test group within development • But unit tests are not a general rule • No obligatory coding standard • Currently code review only for new hires • Extension under preparation • Planned after Alpha, based on bug statistics Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Life Cycle / Coding • Coding (cont.) • Unified installer configurations • Avoid sharing components run-time between separate products • It increases complexity a lot • Version control • Using unified folder structures • Build process • In-house automated nightly build process with labeling, binary versioning and error reporting (including automated test script resultsafter Alpha) Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi

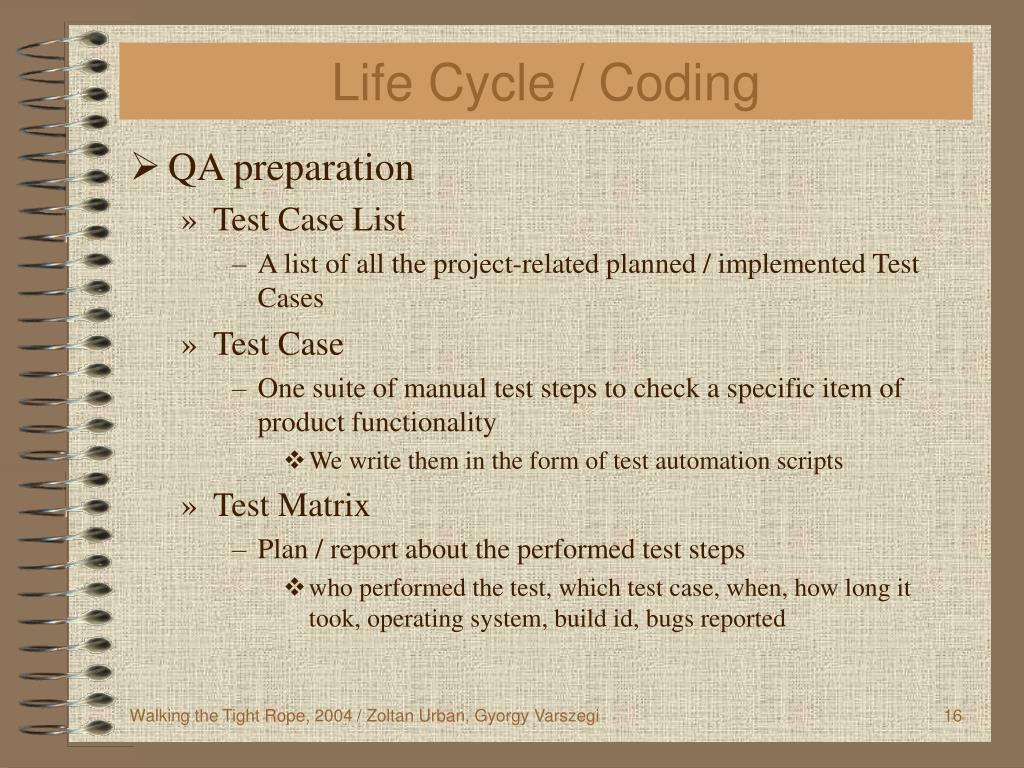

Life Cycle / Coding • QA preparation • Test Case List • A list of all the project-related planned / implemented Test Cases • Test Case • One suite of manual test steps to check a specific item of product functionality • We write them in the form of test automation scripts • Test Matrix • Plan / report about the performed test steps • who performed the test, which test case, when, how long it took, operating system, build id, bugs reported Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi

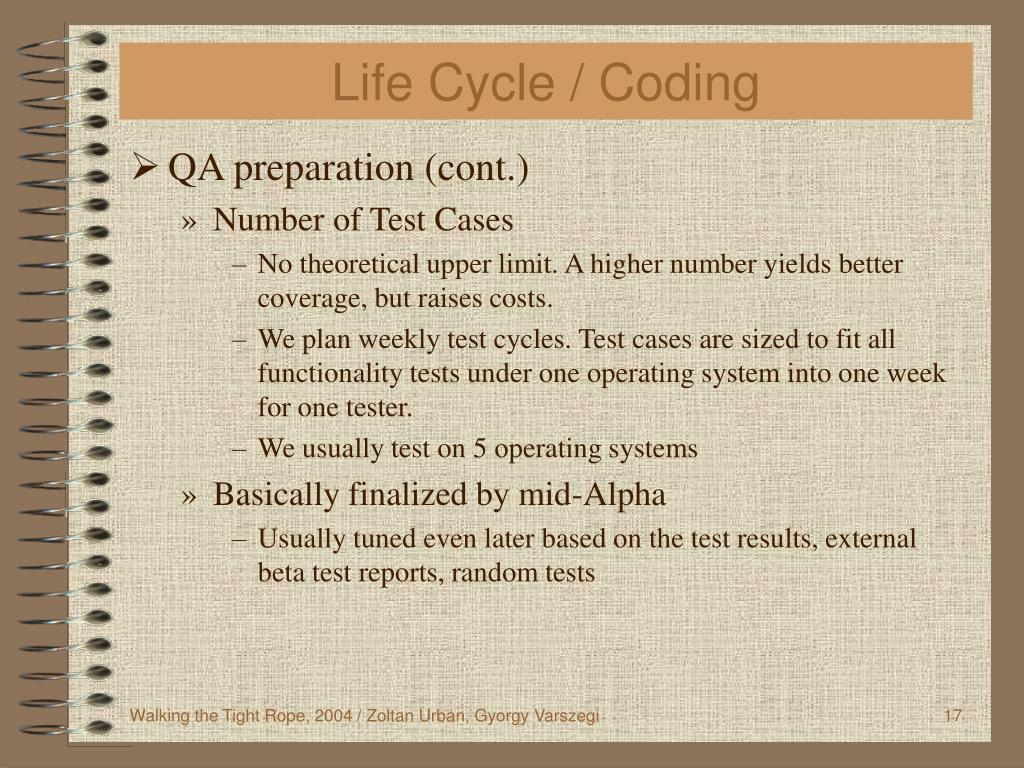

Life Cycle / Coding • QA preparation (cont.) • Number of Test Cases • No theoretical upper limit. A higher number yields better coverage, but raises costs. • We plan weekly test cycles. Test cases are sized to fit all functionality tests under one operating system into one week for one tester. • We usually test on 5 operating systems • Basically finalized by mid-Alpha • Usually tuned even later based on the test results, external beta test reports, random tests Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Life Cycle / Coding • The trend of the number of man-weeks necessary to implement the minimum and target features predicts Alpha date Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi

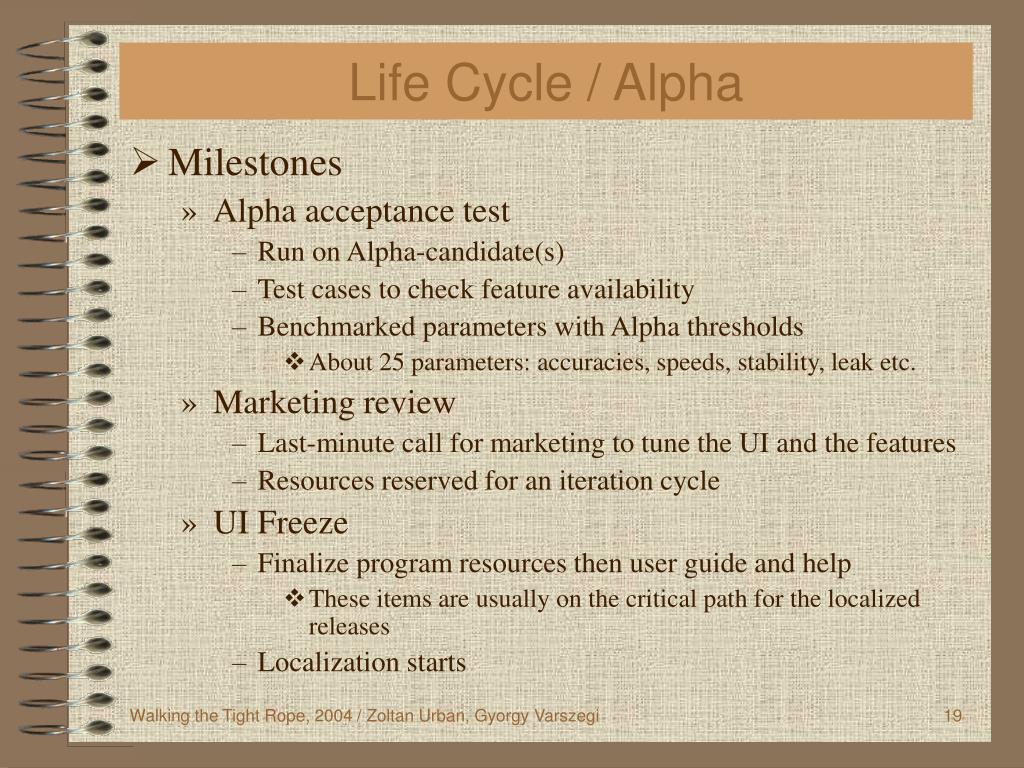

Life Cycle / Alpha • Milestones • Alpha acceptance test • Run on Alpha-candidate(s) • Test cases to check feature availability • Benchmarked parameters with Alpha thresholds • About 25 parameters: accuracies, speeds, stability, leak etc. • Marketing review • Last-minute call for marketing to tune the UI and the features • Resources reserved for an iteration cycle • UI Freeze • Finalize program resources then user guide and help • These items are usually on the critical path for the localized releases • Localization starts Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Life Cycle / Alpha, Beta • The primary goal is to detect and fix bugs • Based on years of experience in three different companies, both the Alpha and the Beta phase should be 10 weeks long • Compression disorganizes the process and finally results in at least the same amount of time • Bug track database is used with a bug fixing workflow • Allowed state transitions per role, change history, on-line reports on the intranet Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Life Cycle / Alpha, Beta • Tools / QA • Usually 3 computers for each tester • Disk images for each platform and hardware • Test automation • It has become more relevant recently • Tests are run on about 20 machines 24 by 7 • Script development • Starts only in Alpha because it is very sensitive to structural changes • Implemented test steps are commented out from the test cases so manual testers do not perform them • Pretty expensive to prepare them for all kinds of failure situations and to give a meaningful test report • During script development a high portion of bugs is detected • Scripts pay off in the regression tests of thesustaining phase Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Life Cycle / Alpha, Beta • Tools / Developers • Test machines with disk images and multi-OS emulators are used to reproduce bugs without disturbing QA • Special software tools to fix hard-to-isolate problems • Memory over- and underwrites • Memory leaks • Threading problems • Using common components for • Logging (run-time selectable level) • Setting debug variables run-time • Letting system-level exceptions be caught in JIT debugger Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Life Cycle / Beta • Beta acceptance test • Run on Beta candidate(s) • Using all test cases • Benchmarked parameters with Beta thresholds • External Beta cycles • Managed by technical support • Base test scripts prepared by QA • We usually have 2-3 external beta cycles • Important to get test results from • Real-life, non-clean software environments • Machines with software and hardware components not available inhouse Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi

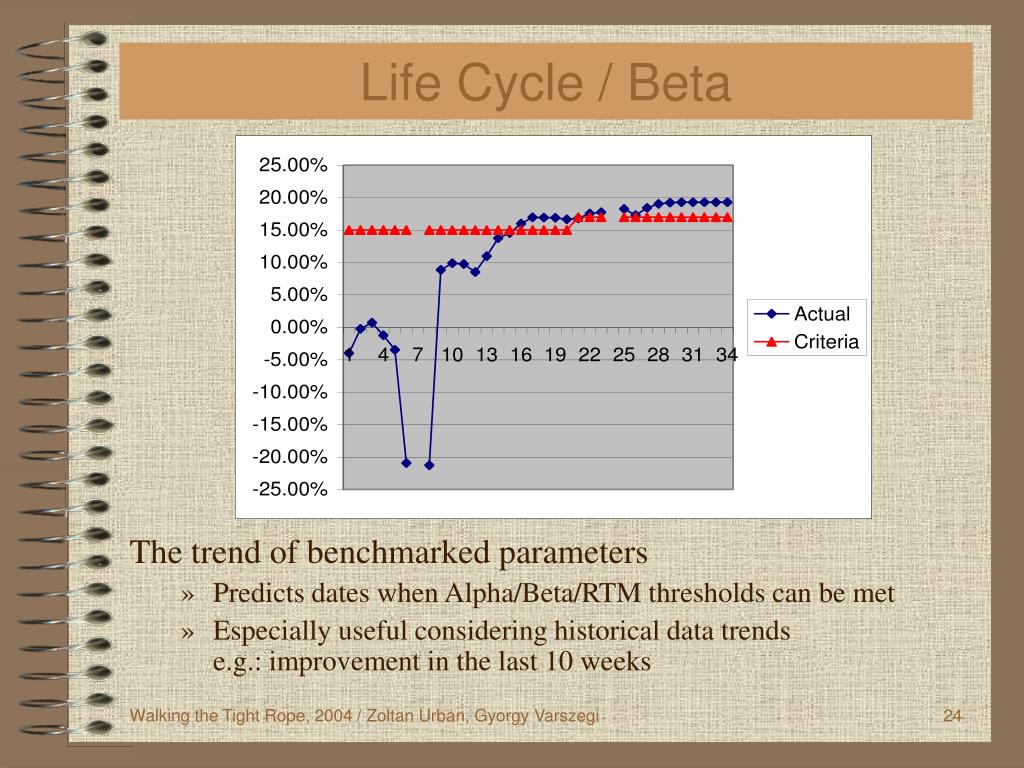

Life Cycle / Beta The trend of benchmarked parameters • Predicts dates when Alpha/Beta/RTM thresholds can be met • Especially useful considering historical data trends e.g.: improvement in the last 10 weeks Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi

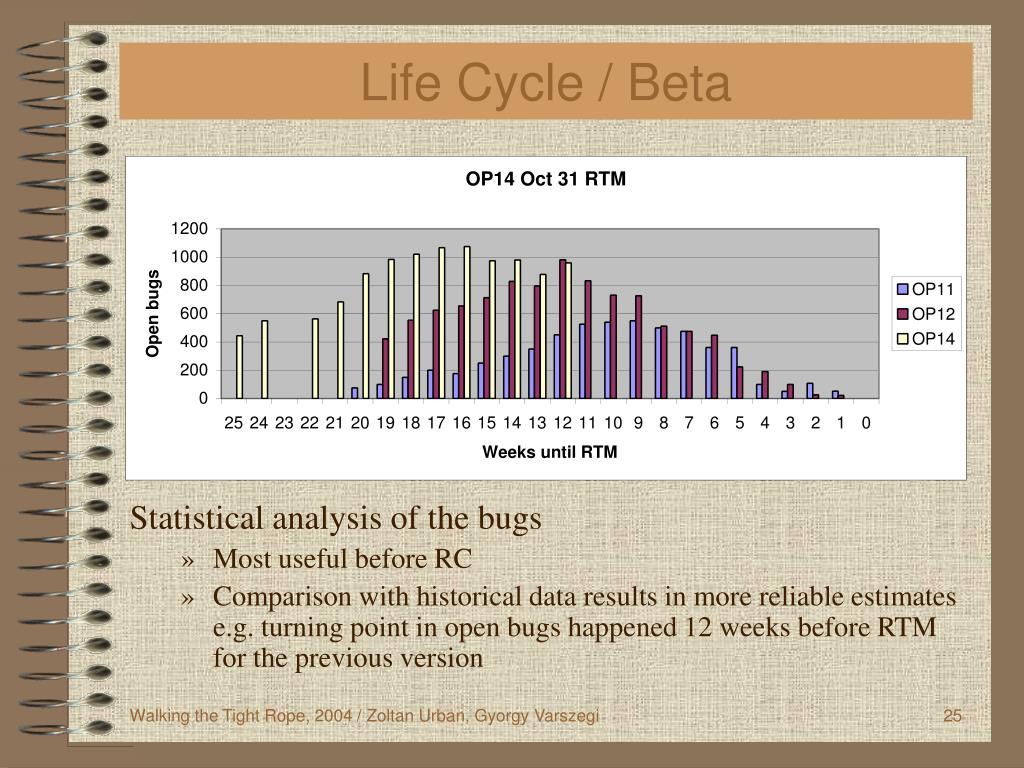

Life Cycle / Beta Statistical analysis of the bugs • Most useful before RC • Comparison with historical data results in more reliable estimatese.g. turning point in open bugs happened 12 weeks before RTM for the previous version Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Life Cycle / Beta • Bug meetings • Low-priority bugs are requested to be deferred to reduce the number of changes and the associated risk • The PDT (mainly technical support) decides to accept or refuse the request • Daily meetings in the last test cycle(s) • Release candidate • Very important milestone • Does every participant believe that the build, with all its known problems, could be released, if the next test cycle does not detect any new bug? • Check-in only through the project manager • Tests performed from the final media Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Life Cycle / Sustaining • Deliverables • Localized versions, trials, point releases, patches • Team • Separate small team of 2-3 developers • Very QA-intensive period. Typically 5 operating systems and max. 2-3 languages tested in parallel. • Archival • Seems to be simple so long as no-one tries to recreate the build (tools, instructions, environment) • Current version control system is not reliable enough • Sources on DVD and masters on CD kept safe in 2 copies geographically separated Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Project control • ISO 9001:2000 and Tick’IT certification • External audits twice a year • Internal audits 2-3 times a year • Control documents on the intranet • Software Development Handbook • Describes the development process • Specifies locations for tools, documents, source code, defect database etc. • Very useful for new hires • Our project quality plan is expressed in a life- cycle form on the intranet with all the milestones and the placeholders for the required documents Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi

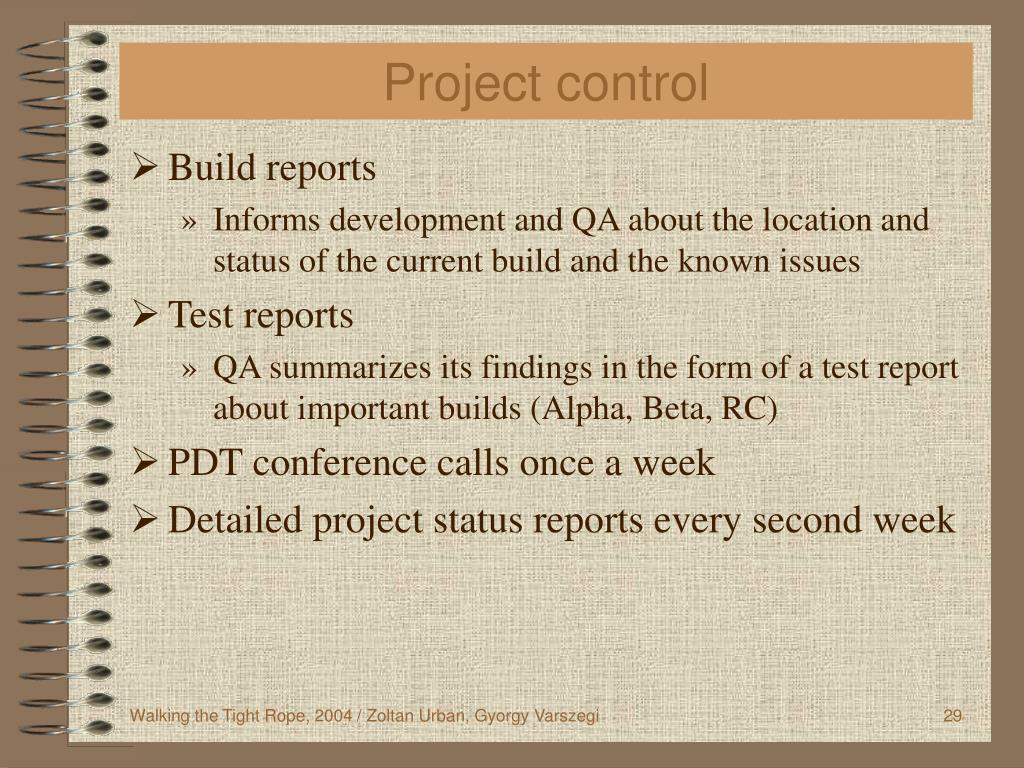

Project control • Build reports • Informs development and QA about the location and status of the current build and the known issues • Test reports • QA summarizes its findings in the form of a test report about important builds (Alpha, Beta, RC) • PDT conference calls once a week • Detailed project status reports every second week Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
Deviations • Schedule compression • Usually a time-to-market requirement • Losing resources • Mainly to a higher priority project • Creeping features • Changes in market conditions or late discoveries about cross-effects may cause features to creep • 3rdparties andoutsourcing • For economical reasons suppliers with much inferior quality systems may be selected Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi

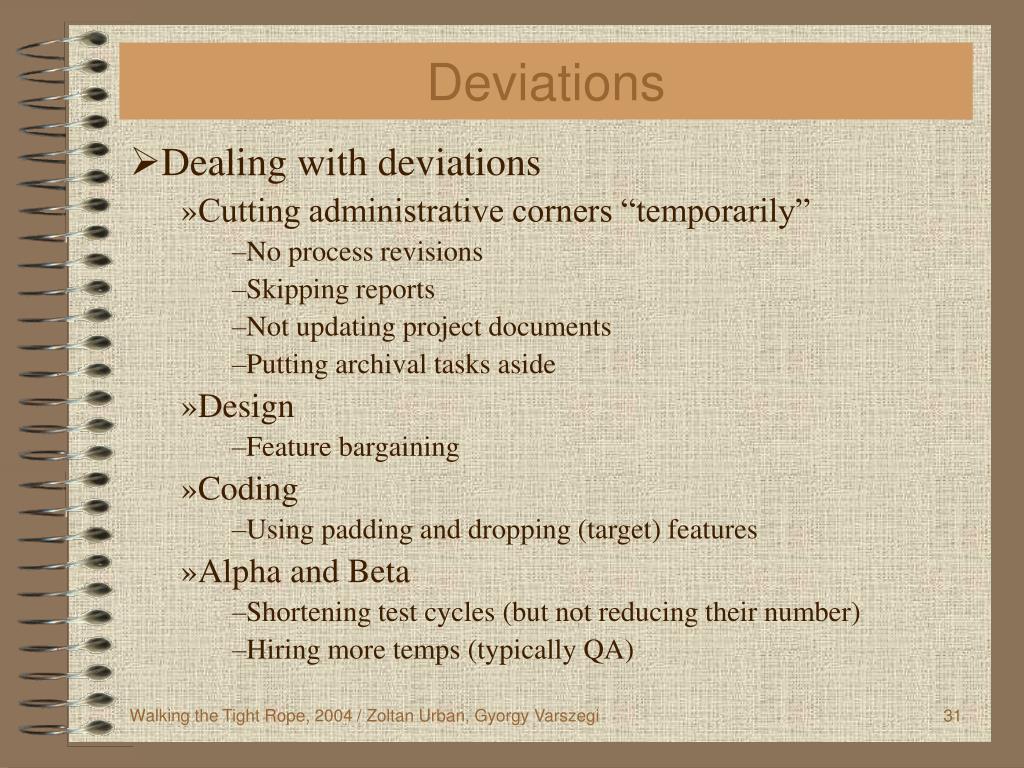

Deviations • Dealing with deviations • Cutting administrative corners “temporarily” • No process revisions • Skipping reports • Not updating project documents • Putting archival tasks aside • Design • Feature bargaining • Coding • Using padding and dropping (target) features • Alpha and Beta • Shortening test cycles (but not reducing their number) • Hiring more temps (typically QA) Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi

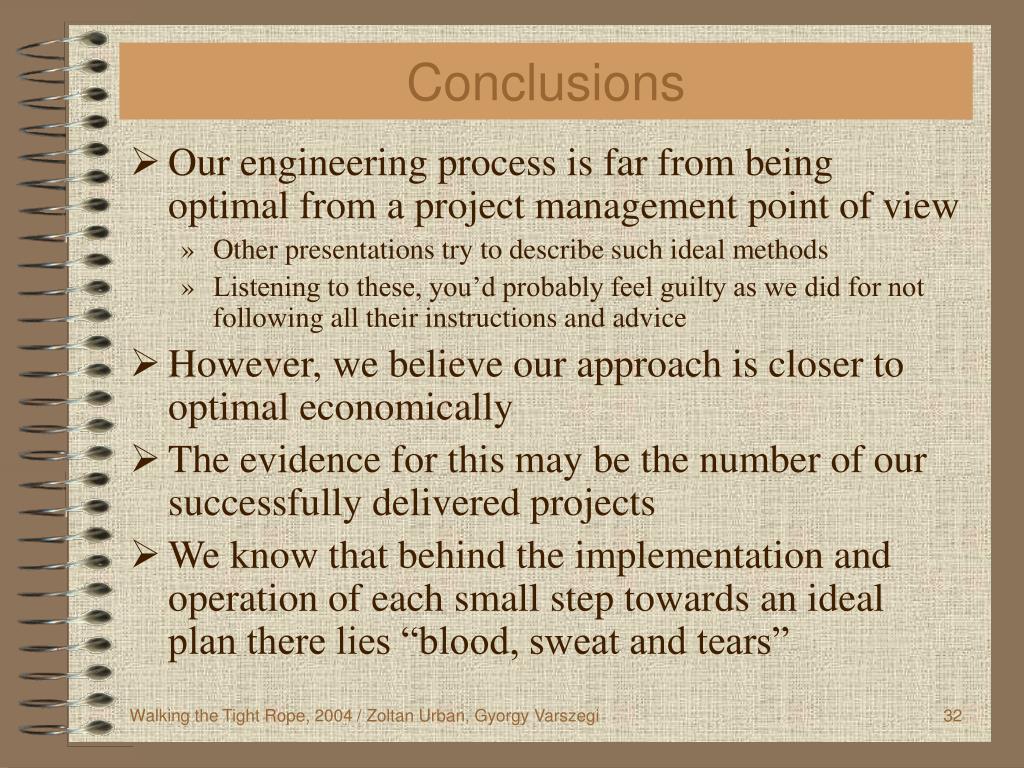

Conclusions • Our engineering process is far from being optimal from a project management point of view • Other presentations try to describe such ideal methods • Listening to these, you’d probably feel guilty as we did for not following all their instructions and advice • However, we believe our approach is closer to optimal economically • The evidence for this may be the number of our successfully delivered projects • We know that behind the implementation and operation of each small step towards an ideal plan there lies “blood, sweat and tears” Walking the Tight Rope, 2004 / Zoltan Urban, Gyorgy Varszegi
