Project Crashing and Time-Cost Trade-Off: Comprehensive Guide
330 likes | 430 Vues
Learn about project crashing concepts, LP formulation, and how to balance time and cost in project management. Tutorial and examples included.
Project Crashing and Time-Cost Trade-Off: Comprehensive Guide
E N D
Presentation Transcript
Lecture 2 Today’s lecture covers the followings: • To study “project crashing” concept • LP formulation for project management problem • The use of QM (Try it yourself!) Tutorial: Chapter 8: 8th Ed:Q26 and Q30 9tj Ed: Q21 and Q23 (to p2) (to p26) Chapter 8 - Project Management
Project Crashing Basic Concept In last lecture, we studied on how to use CPM to determine solution for a project problem There, we determine its critical path and completion time. Question: Can we cut short its project completion time? If so, how! (to p3) Chapter 8 - Project Management
Project CrashingSolution! Yes, the project duration can be reduced by assigning more resources to project activities But, doing this would somehow increase our project cost! How do we strike a balance? (to p4) Chapter 8 - Project Management
Trade-off concept Here, we adopt the “Trade-off” concept • ie, we attempt to “crash” some “critical” events by allocating more sources to them, and also to maintain a balance that the shortening time is not less than the normal activities • How to do that: • Question: What criteria should it be based on when deciding to crashing critical times? (to p5) (to p11) Chapter 8 - Project Management
Example – crashing (1) Max weeks can be crashed Normal weeks The critical path is 1-2-3, the completion time =11 How? Path: 1-2-3 = 5+6=11 weeks Path: 1-3 = 5 weeks Now, how many days can we “crash” it? 2 6(3) 5 (1) 3 1 5(0) (to p6) Chapter 8 - Project Management
Example – crashing (1) 2 6(3) 5 (1) 3 1 5(0) The maximum time that can be crashed for: Path 1-2-3 = 1 + 3 = 4 Path 1-3 = 0 Total weeks can be crashed = 4 + 0 = 4 Are we to use up all these 4 weeks? (to p7) Chapter 8 - Project Management
Example – crashing (1) 3(0) 4(0) 2 6(3) 5 (1) 3 1 5(0) If we used all 4 days, then path 1-2-3 has (5-1) + (6-3) = 7 completion weeks Now, we need to check if the completion time for path 1-3 has lesser than 7 weeks (why?) Now, path 1-3 has (5-0) = 5 weeks Since path 1-3 still shorter than 7 weeks, we used up all 4 crashed weeks Question: What if path 1-2 has, say 8 week completion time? (to p8) Chapter 8 - Project Management
Example – crashing (1) Such as 2 6(3) 5 (1) 3 1 8(0) Now, we cannot use all 4 days (Why?) Because path 1-2-3 will not be critical path anymore as path 1-3 would now has longest hour to finish Rule: When a path is a critical path, it will stay as a critical path So, we can only reduce the path 1-2-3 completion time to the same time As path 1-2. (HOW?) Chapter 8 - Project Management (to p9)
Example – crashing (1) Solution: 2 6(3) 5 (1) 3 1 8(0) We can only reduce total time for path 1-2-3 = path 1-2, that is 8 weeks If the cost for path 1-2 and path 2-3 is the same then We can random pick them to crash so that its completion Time is 8 weeks (to p10) Chapter 8 - Project Management
Example – crashing (1) Solution: 4(0) 4(1) 2 6(3) 5 (1) 3 1 8(0) 3(0) OR 5 (1) 6(3) 2 1 3 8(0) (to p4) Now, paths 1-2-3 and 1-3 are both critical paths Chapter 8 - Project Management

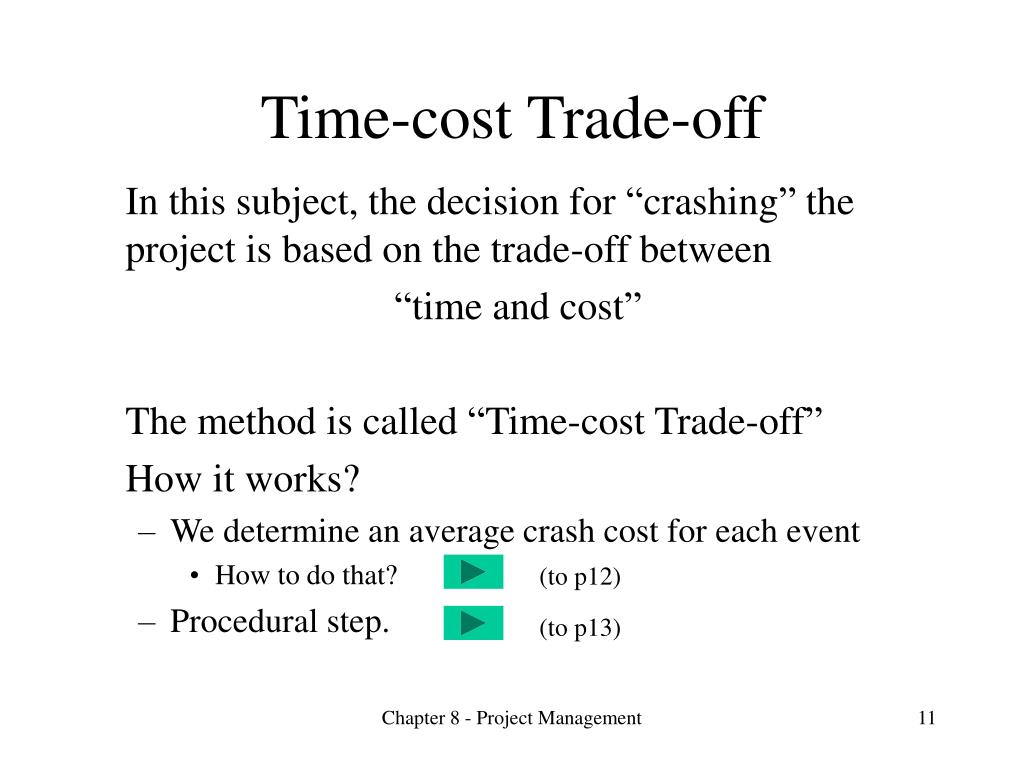

Time-cost Trade-off In this subject, the decision for “crashing” the project is based on the trade-off between “time and cost” The method is called “Time-cost Trade-off” How it works? • We determine an average crash cost for each event • How to do that? • Procedural step. (to p12) (to p13) Chapter 8 - Project Management
F= (D-C)/(A-B) Project Crashing and Time-Cost Trade-OffExample Problem (1 of 3) E=(A-B) A B D F C Table 8.5 Normal Activity and Crash Data for the Network in Figure 8.16 (to p11) Note: A,B,C,D are given Note: we will use F values to decide We need to compute E and F which path to crash!
Time-Cost Trade-Off Steps: 1. use “normal cost” to determine the critical path 2. for each event, compute their average crash cost 3. for each section of critical path, crash their maximum time by retaining this section be part of the “critical” path. 4. compute total crashing costs and completion time Example (to p14) Chapter 8 - Project Management
Example: trade-off (to p15) • Consider the same example as show in below • Step 1 determine it critical path • Step 2 determine all average unit crash cost • Step 3 crashing events with minimum costs • Step 4 compute crashed weeks and costs (to p16) (to p17) (to p20) More example! Chapter 8 - Project Management (to p21)
Step 1 • Using CPM, the critical path is 1-2-3-4-6-7 (to p14) Chapter 8 - Project Management
Step 2 (to p14) Chapter 8 - Project Management
Step 3: First, we cluster each segment of critical path into sections that can be crashed and to consider to crash them one section at a time Section1 Section 2 Section 3 Section 4 (to p18)
Step 3: We now add the normal and crashed time and cost to each segment 8(3) $500 12(3) $$7000 12(5) $400 4(1) $7000 4(1) $3000 4(3) $$200 4(3) $$200 Section1 Section 2 Section 3 Section 4 (to p19)

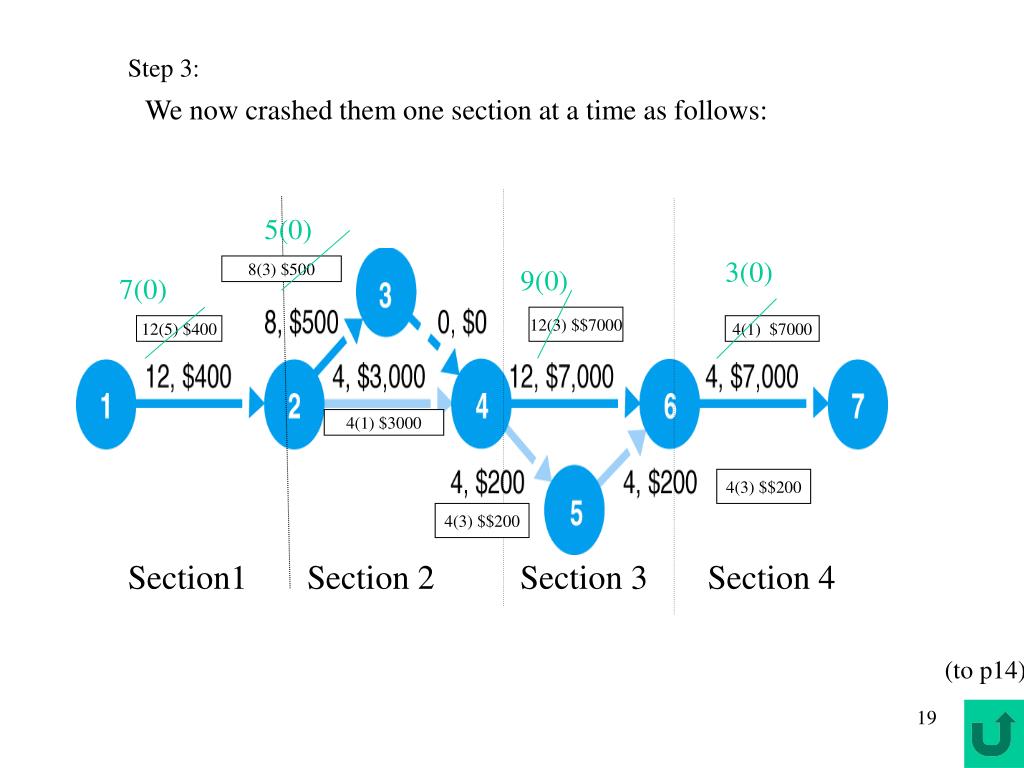

Step 3: We now crashed them one section at a time as follows: 5(0) 3(0) 8(3) $500 9(0) 7(0) 12(3) $$7000 12(5) $400 4(1) $7000 4(1) $3000 4(3) $$200 4(3) $$200 Section1 Section 2 Section 3 Section 4 (to p14)
Step 4: We now crashed them one section at a time as follows: 5(0) 3(0) 8(3) $500 9(0) 7(0) 12(3) $$7000 12(5) $400 4(1) $7000 4(1) $3000 4(3) $$200 4(3) $$200 Total crash cost =(5*$400)+(3*$500)+(3*$7000)+(1*$7000)= 31,000 Total crashed weeks= 5+3+3+1=12 Note: critical path is 1-2-3-4-6-7 Completion time = 7+5+0+9+3 = 24 (to p14)
Crashed cost 10(5) 5(4) 1 3 4 4(1) 4(2) 2 How to solve this problem? (to p22) Chapter 8 - Project Management
Further detail steps • Determine the critical path • Crash the critical path to the level where other non-critical paths become a critical one • Consider for further crashing until all possible crashing resources were consumed! (to p23) Chapter 8 - Project Management
Critical path 10(5) 5(4) 1 3 4 4(1) 4(2) 2 (to p24) The critical path is 1-3-4, completion time is 10+5 = 15 Chapter 8 - Project Management

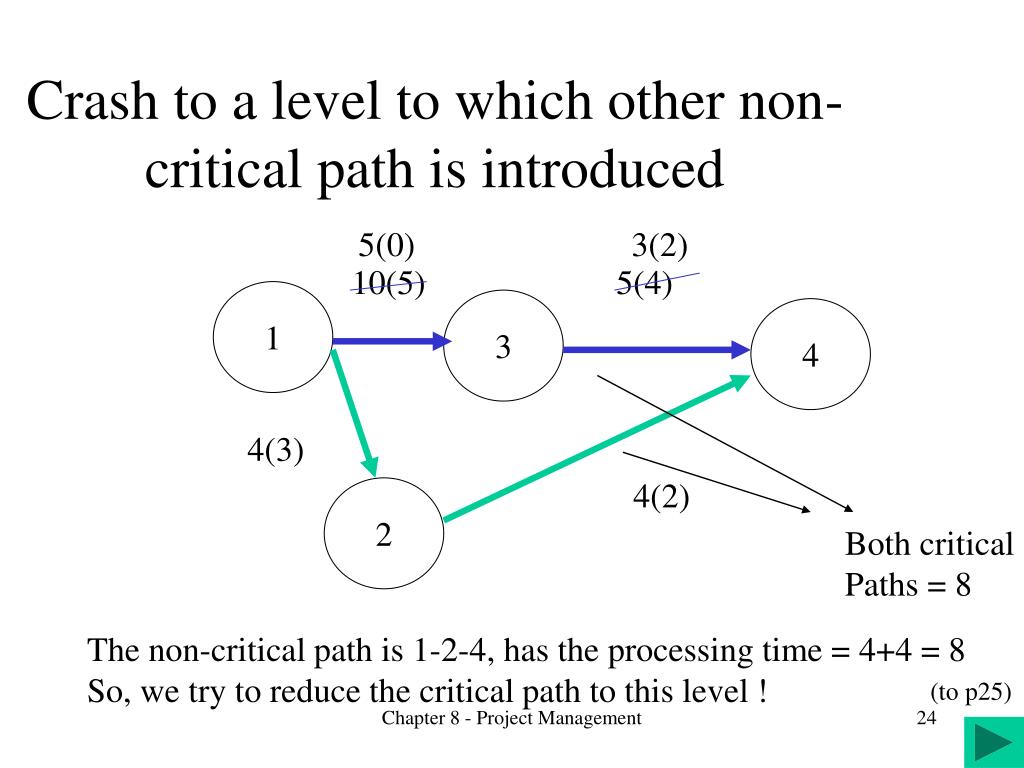

Crash to a level to which other non-critical path is introduced 5(0) 3(2) 10(5) 5(4) 1 3 4 4(3) 4(2) 2 Both critical Paths = 8 The non-critical path is 1-2-4, has the processing time = 4+4 = 8 So, we try to reduce the critical path to this level ! (to p25) Chapter 8 - Project Management
Crash all resources until no further can be reduced! 2(0) 5(0) 3(1) 10(5) 5(3) 1 3 4 4(3) 4(2) 3(2) 2 Both critical Paths = 7 Stop, since no more resources can be reduced in path 1-3-4 (to p1) Chapter 8 - Project Management
Formulating the CPM/PERT Network as a Linear Programming Model • - The objective is to determine the earliest time the project can be completed • (i.e., the critical path time). • normal CPM • crashing model (to p27) (to p30) (to p1) Chapter 8 - Project Management
LP formulation General linear programming model is: minimize Z = cixi subject to xj - xi tij for all activities i j xi, xj 0 where xi = earliest event time of node i xj = earliest event time of node j tij = time of activity i j • LP formulation for the project management (to p28) Chapter 8 - Project Management
LP for the CPM • Let consider a simple problem as outlined as follows: Let xi be denote as each node i And segment of say path 1-2 as x2-x1 Then (to p29) Chapter 8 - Project Management
Objective is Minimize Z = x1 + x2 + x3 + x4 + x5 + x6 + x7 Subject to x2 - x1 12 (for path 1-2) x3 - x2 8 (for path 2-3) x4 - x2 4 (for path 2-4) x4 - x3 0 (for path 3-4) x5 - x4 4 (for path 4-5) x6 - x4 12 (for path 4-6) x6 - x5 4 (for path 5-6) x7 - x6 4 (for path 6-7) xi, xj 0 (to p26) Do you know how to read the results from the LP output? Chapter 8 - Project Management
General concept • All formulation of CPM is used, except we need one more variable to represent the crashed cost per unit of each path • Example! (to p31) Chapter 8 - Project Management
Consider again the following crashed cost as an example - Objective is to reduce the project duration from 36 to 30 weeks at the minimum possible crash cost. Our objective is to min these We now y to represent these How? Chapter 8 - Project Management (to p32)
Min 400y12 + 500y23 + 3000y24 + 0y34 + 200y45 + 7000y46 + 200y56 + 7000y67 And all yij <= their total allowance crash time A complete model is shown in next slide (to p33) Chapter 8 - Project Management
The CPM/PERT Network as a Linear Programming ModelExample Problem Project Crashing - Model Formulation xi = earliest event time of node i xj = earliest event time of node j yij = amount of time by which activity i j is crashed (i.e., reduced) minimize Z = $400y12 + 500y23 + 3000y24 + 200y45 + 7000y46 + 200y56 + 7000y67 subject to y12 5 y12 + x2 - x1 12 y23 3 y23 + x3 - x2 8 y24 1 y24 + x4 - x2 4 y34 0 y34 + x4 - x3 0 y45 3 y45 + x5 - x4 4 y46 3 y46 + x6 - x4 12 y56 3 y56 + x6 - x5 4 y67 1 x67 + x7 - x6 4 x7 30 xj, yij 0 Max crashing time for critical path i.e. total allowable crashed time New set of equations (to p26) CPM value Chapter 8 - Project Management
