1 / 7

Mississippi River Sediment Management Concerns

Mississippi River Sediment Management Concerns. Kyle Graham Deputy Executive Director CPRA 8/22/2012. committed to our coast. committed to our coast. Place Title of Slide Here Secondary Title. Constructed Funded for Construction.

keegan
Télécharger la présentation

Mississippi River Sediment Management Concerns

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Mississippi River Sediment Management Concerns Kyle Graham Deputy Executive Director CPRA 8/22/2012 committed to our coast committed to our coast

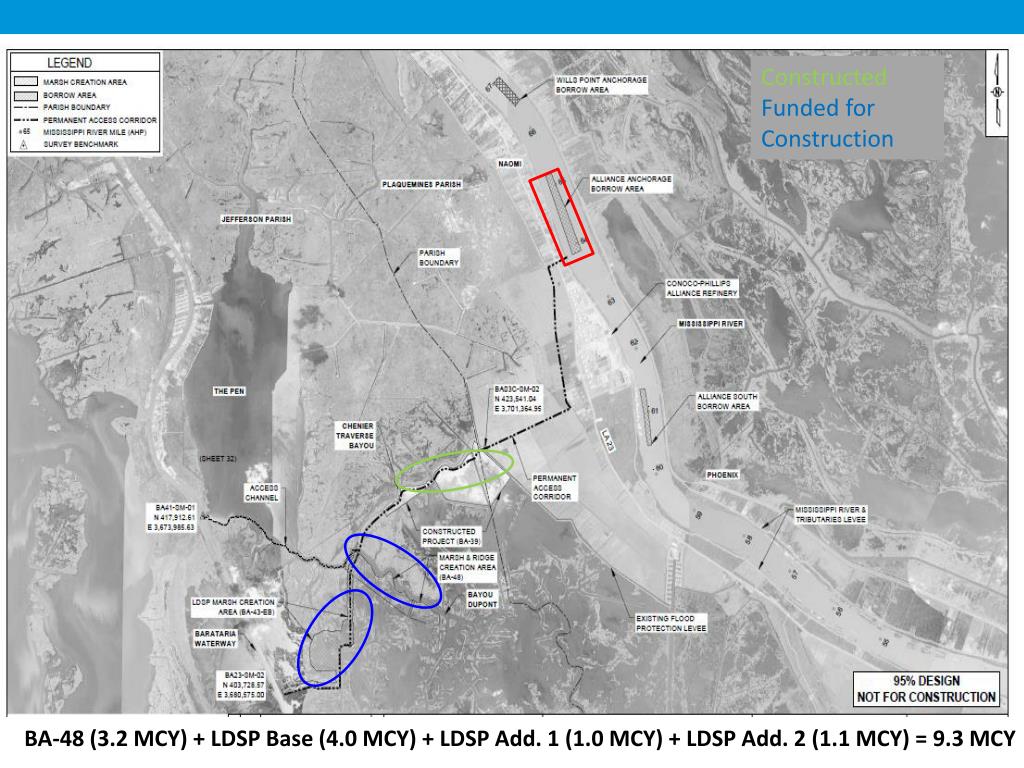

  2. Place Title of Slide Here Secondary Title Constructed Funded for Construction BA-48 (3.2 MCY) + LDSP Base (4.0 MCY) + LDSP Add. 1 (1.0 MCY) + LDSP Add. 2 (1.1 MCY) = 9.3 MCY

  3. ~1.7 MCY ~7.8 MCY (6.5 +1.3) ~800k CY ~2.4 MCY Sediment Available to State: 2.4 MCY+ 7.8 MCY + 1.7 MCY = 11.9 MCY Additional Corps Reserve: 0.8 MCY Total Available in Reach: 12.7 MCY

  4. Alliance Anchorage Borrow Area Available: 1.3 MCY + 6.5 MCY = 7.8 MCY Available to State with Corps Restrictions: 11.9 MCY – 7.8 MCY = 4.1 MCY Project Size Reduction: 9.3 MCY – 4.1 MCY = 5.2 MCY (56% reduction) Increased Project Cost: 1.7 MCY X $3 per CY = $5.1M 2.4 MCY X $5 per CY = $12M Estimated Total of New Project = $46.2 M 44% of original Project with 70% of the Funding

  5. Concerns • Coordination - According to Agreements between the State and Corps • “[the state] shall have the opportunity to be involved in the pre-award process for contracts, including the opportunity to review and comment on the type of contract and all plans and specifications, to inspect the construction work, and to provide other reviews and input in to the process.”  • “the [Corps] shall consider the recommendations of [the state] in all matters pertaining to the project and shall make every effort to accommodate the concerns of the State..” • “at the request of the state, the [Corps] shall advise the State within sixty (60) days of his reasons for rejecting or modifying any recommendations made by the State.”  Coastal Protection and Restoration Authority of Louisiana

  6. Concerns • 2. Consistency Determination - • The Office of Coastal Management issued a Coastal Zone Consistency to the Corps for the construction of the Sill on October 2, 2007. This determination is valid through 2018. • The action considered dredging approximately, 660,000 – 1,000,000 cubic yards of material from this reach. The Corps is now considering 1,500,000 -2,700,000 cubic yards. • Big Picture – • Corps decisions are placing a priority on Navigation over Restoration • The Sill is designed to mitigate the effects of increased saltwater intrusion upon municipal and industrial water supplies – yet it is above the Alliance Refinery. A shift a few miles downstream would protect the refinery as well. • The Master Plan has identified this reach of the river as a major borrow source for marsh creation in the Barataria Basin to be constructed over the next 30 years. Coastal Protection and Restoration Authority of Louisiana

  7. Concerns • Financial - • If the Corps proceeds on the path indicated our projects will be severely impacted. Tens of Millions of State Dollars will be lost by their decision. QUESTIONS? Coastal Protection and Restoration Authority of Louisiana
