An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. DJAC: PPD CMS ECAL Hardware Tasks • (i) The next 2.5 years • (ii) The following 2.5 years To March 2008 April 2008 – Oct 2010

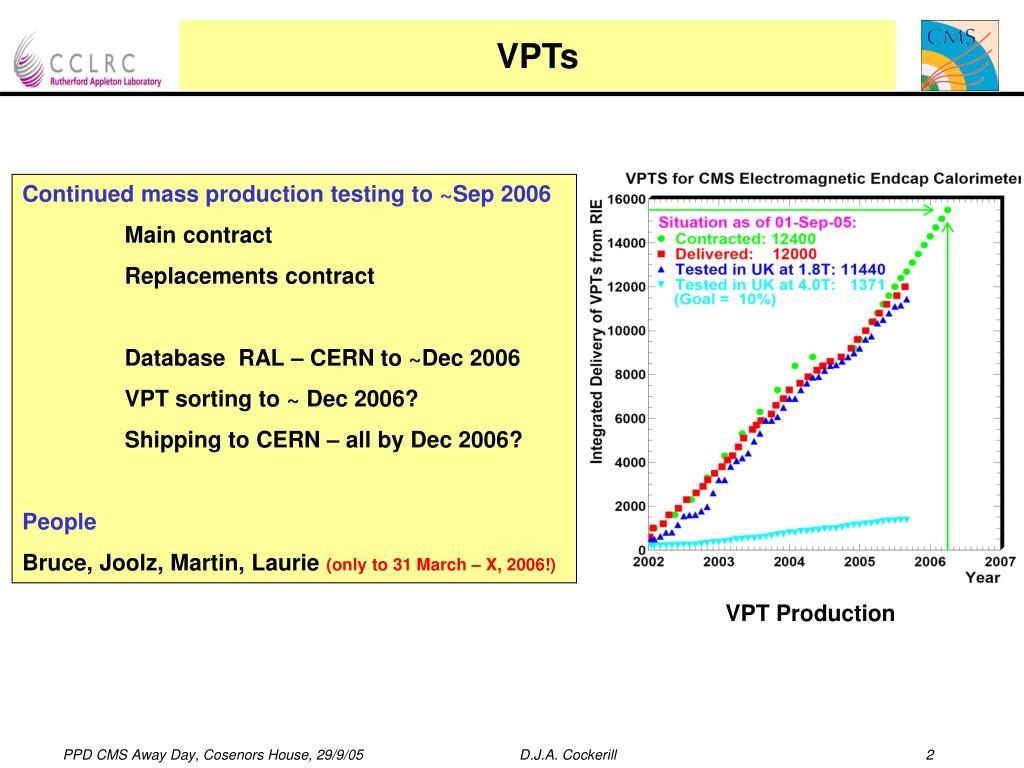

  2. VPTs • Continued mass production testing to ~Sep 2006 • Main contract • Replacements contract • Database RAL – CERN to ~Dec 2006 • VPT sorting to ~ Dec 2006? • Shipping to CERN – all by Dec 2006? • People • Bruce, Joolz, Martin, Laurie (only to 31 March – X, 2006!) VPT Production

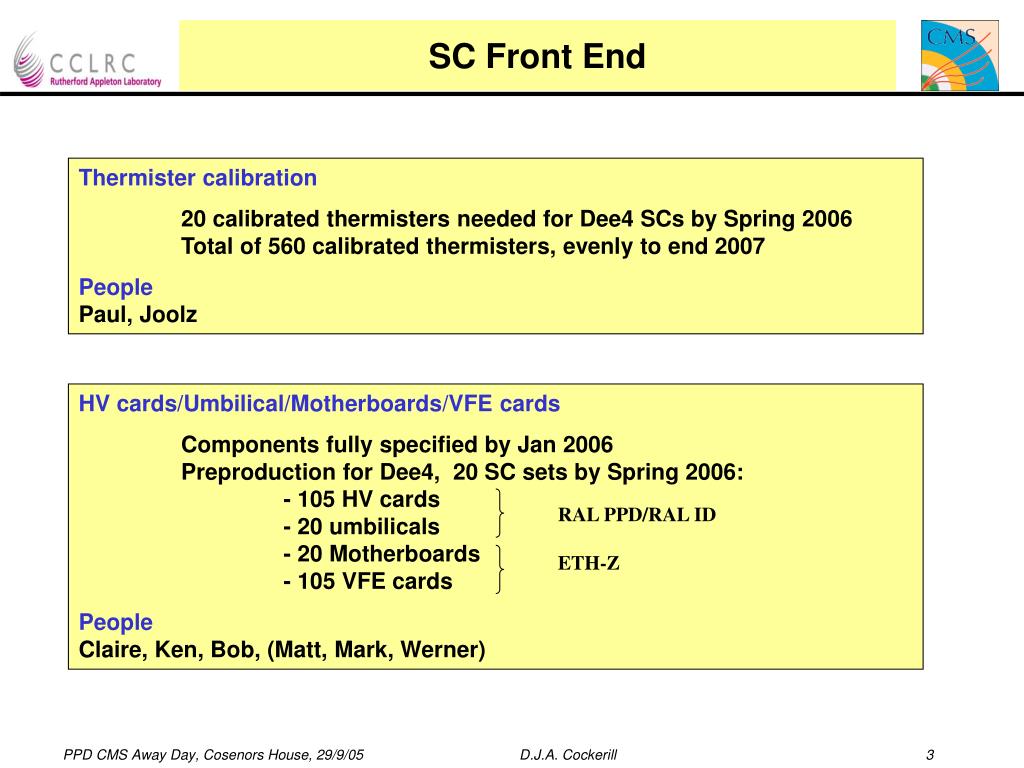

  3. SC Front End Thermister calibration 20 calibrated thermisters needed for Dee4 SCs by Spring 2006 Total of 560 calibrated thermisters, evenly to end 2007 PeoplePaul, Joolz HV cards/Umbilical/Motherboards/VFE cards Components fully specified by Jan 2006 Preproduction for Dee4, 20 SC sets by Spring 2006: - 105 HV cards - 20 umbilicals - 20 Motherboards - 105 VFE cards PeopleClaire, Ken, Bob, (Matt, Mark, Werner) RAL PPD/RAL ID ETH-Z

  4. VPT HV HV distributionPreparation for Dee4CAEN HV supply + prototype distribution box by April 2006HV software drivers tested with SC01 at RAL HV distribution method defined WITHIN a Dee, by April 2006 PeopleClaire, Ken, Bob, Philip, Barbara, (Tony)

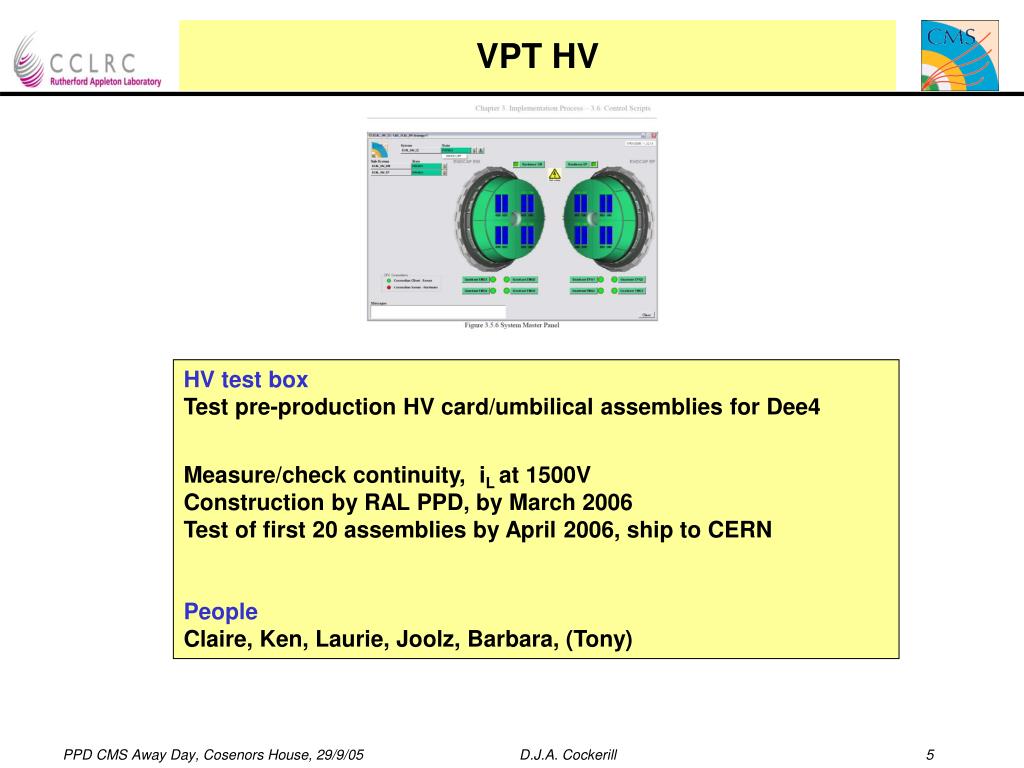

  5. VPT HV HV test boxTest pre-production HV card/umbilical assemblies for Dee4 Measure/check continuity, iL at 1500VConstruction by RAL PPD, by March 2006Test of first 20 assemblies by April 2006, ship to CERN PeopleClaire, Ken, Laurie, Joolz, Barbara, (Tony)

  6. VPT HV mass production Mass production of HV cards/umbilicals, summer 2006 – spring 2007Procurement RAL PPD Tests of HV cards/Umbilical assemblies with HV test box (Motherboards/VFE cards ETH-Z) Tests for correct trigger mapping to the motherboards,before mounting on DeesRAL PPD/Virginia ?? PeopleClaire, Ken, Laurie, Joolz, Barbara, Dave, (Tony)

  7. VPT LED Stability pulser Prototype LED firing box for Dee4 by April 2006Up to 5 fibre outlets needed for Dee4 PeoplePaul, Bob, (John Hill/Tony, fixing to patch panel, fibre routings) Collaboration with Virginia – decide who does what, by Jan 2006 - Newer/better LEDs/improved coupling - LED driver - Complete drive boxes - Interface to ECAL DAQ As an alternative monitoring system, by summer 2006- can we get to 50, 100 GeV equivalent?? PeoplePaul, Bob, Ken, Dave, (Tony)

  8. Dee4 at CERN Dee4 assembly/tests Spring/Summer/Autumn 2006 SC soak test stand by March 2006 Oversight of Dee assembly: SC assembly/mounting on Dee4 Dee4 test stand- collaboration with Virgina for front light injection tests- use prototype HV distribution system - tests of motherboard trigger configuration- learn to operate ‘mobile’ ECAL electronics test stand - analysis of data- VPT LED stability pulser People. Dave, Claire, Barbara, Joolz, Paul, (Matt, Tony) at CERN

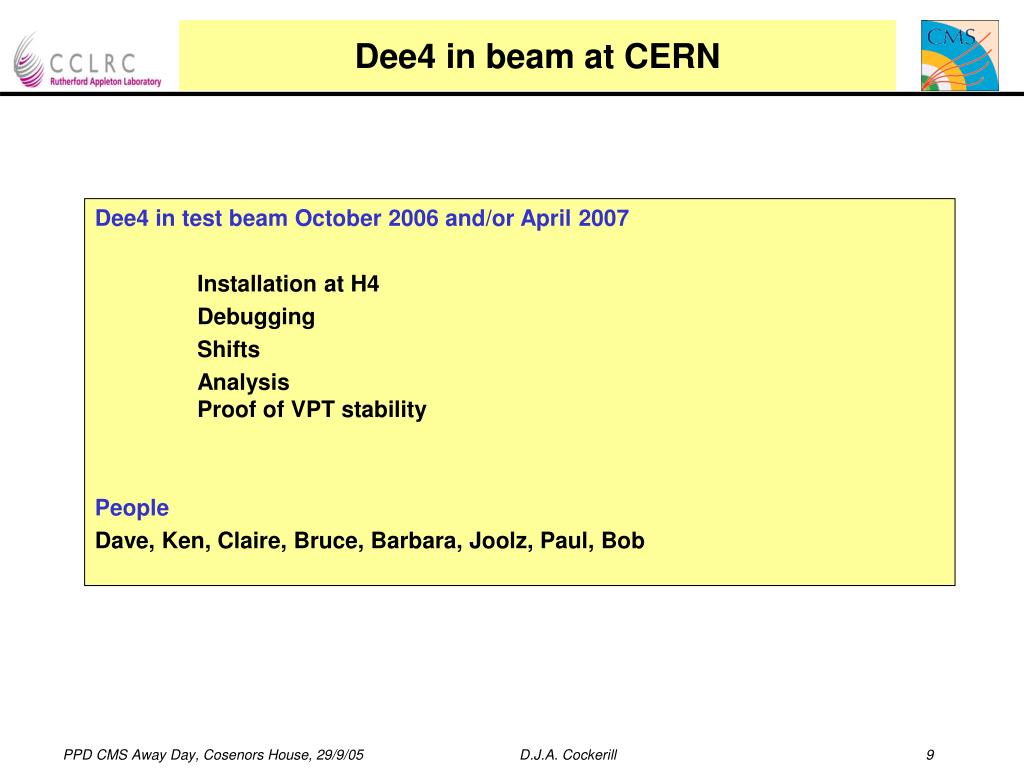

  9. Dee4 in beam at CERN Dee4 in test beam October 2006 and/or April 2007 Installation at H4 Debugging Shifts Analysis Proof of VPT stability People Dave, Ken, Claire, Bruce, Barbara, Joolz, Paul, Bob

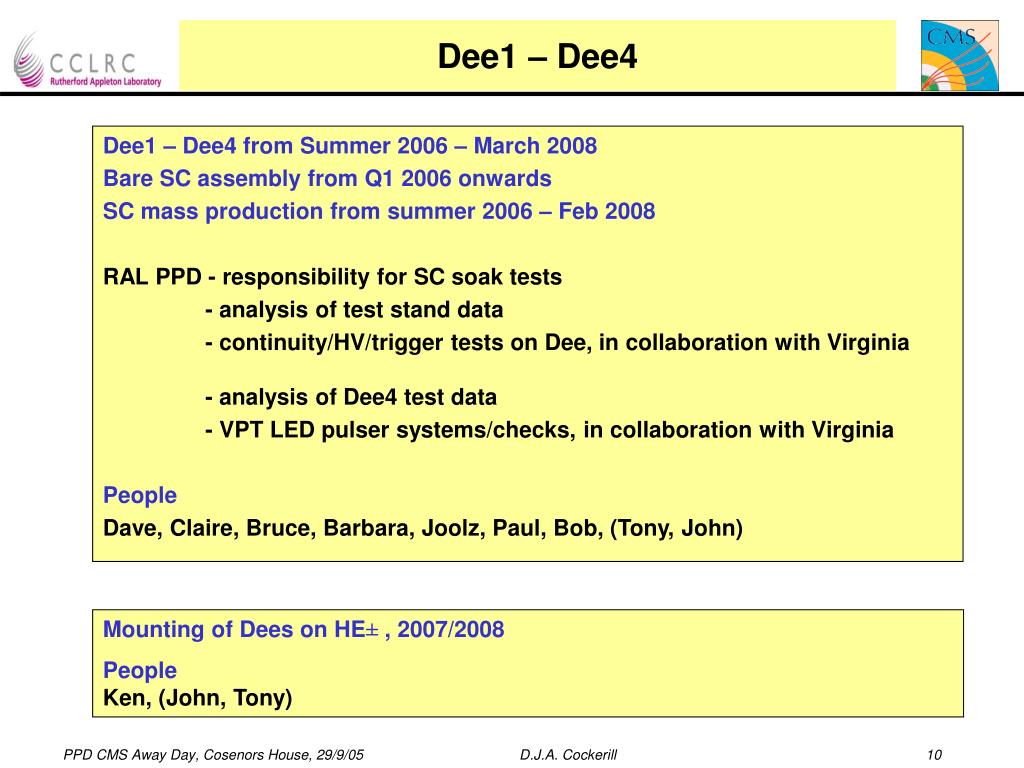

  10. Dee1 – Dee4 Dee1 – Dee4 from Summer 2006 – March 2008 Bare SC assembly from Q1 2006 onwards SC mass production from summer 2006 – Feb 2008 RAL PPD - responsibility for SC soak tests - analysis of test stand data - continuity/HV/trigger tests on Dee, in collaboration with Virginia - analysis of Dee4 test data - VPT LED pulser systems/checks, in collaboration with Virginia People Dave, Claire, Bruce, Barbara, Joolz, Paul, Bob, (Tony, John) Mounting of Dees on HE± , 2007/2008 PeopleKen, (John, Tony)

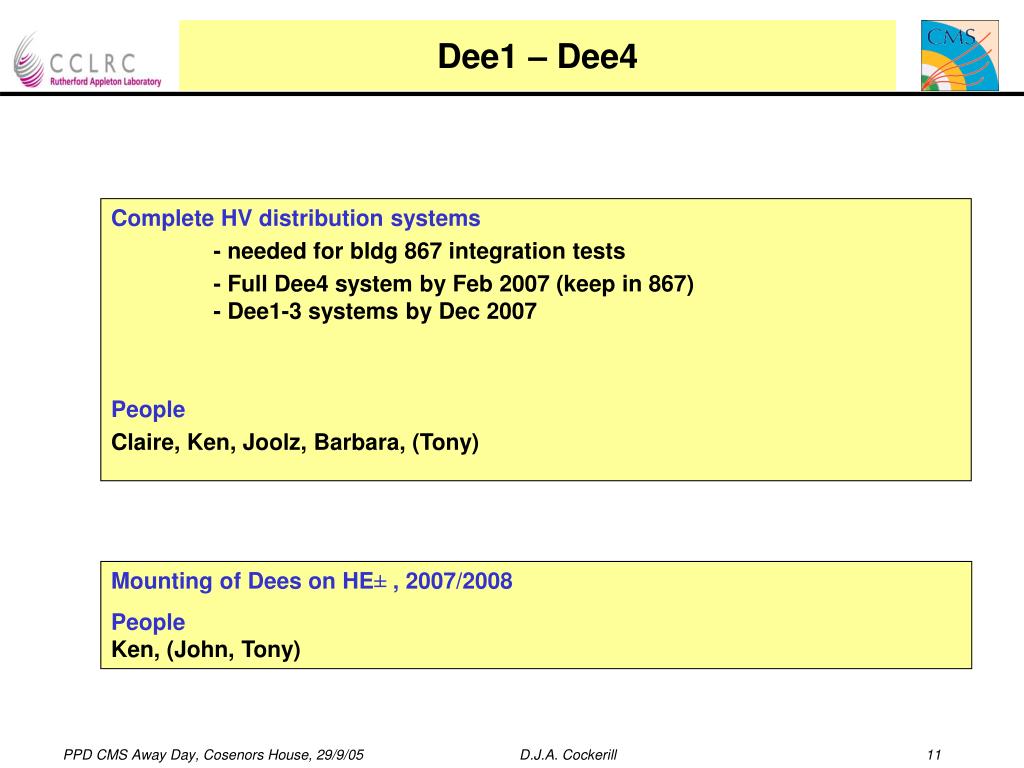

  11. Dee1 – Dee4 Complete HV distribution systems - needed for bldg 867 integration tests - Full Dee4 system by Feb 2007 (keep in 867) - Dee1-3 systems by Dec 2007 People Claire, Ken, Joolz, Barbara, (Tony) Mounting of Dees on HE± , 2007/2008 PeopleKen, (John, Tony)

  12. The Transition March 2008 4 Dees installed in CMS Need to Shepherdour resources as the group’s Brownian motion diminishes What do we do? My personal opinion, particularly for the first (EE) LHC run : PPD – duty to show EE working as expected duty to show VPTs are stable (does not necessarily imply continuous calibration responsibility) People Dave, Ken, Claire, Bruce, RA1, RA2

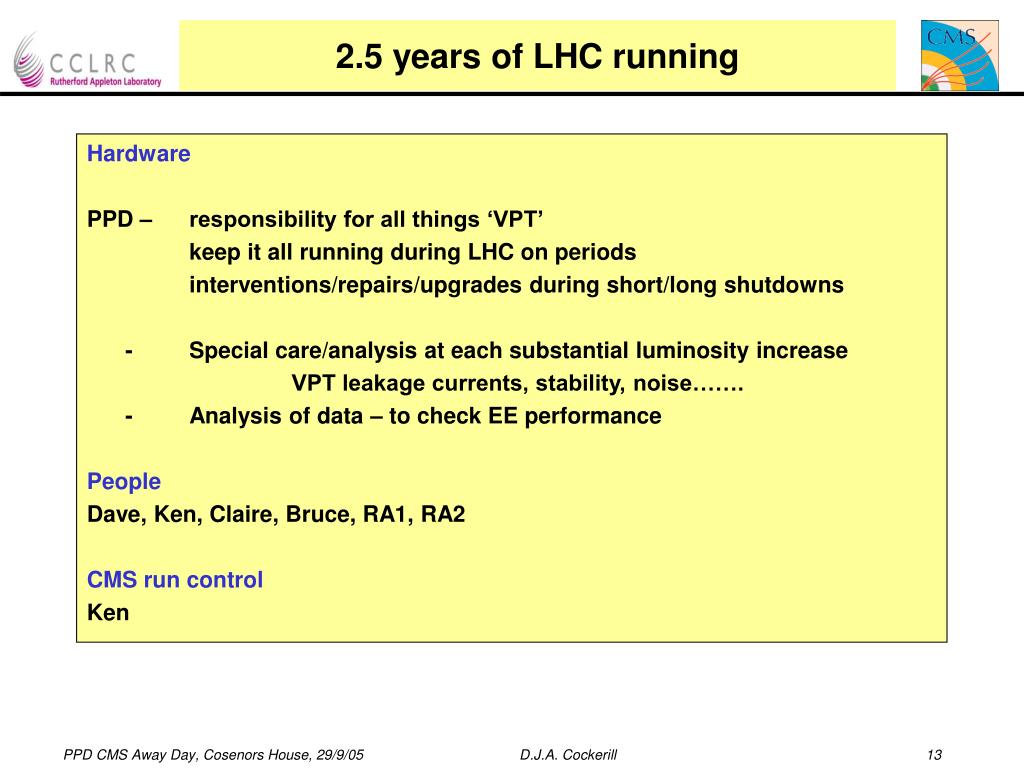

  13. 2.5 years of LHC running Hardware PPD – responsibility for all things ‘VPT’ keep it all running during LHC on periods interventions/repairs/upgrades during short/long shutdowns - Special care/analysis at each substantial luminosity increase VPT leakage currents, stability, noise……. - Analysis of data – to check EE performance People Dave, Ken, Claire, Bruce, RA1, RA2 CMS run control Ken

  14. Is that all ????? Rumours that the Great Bear in the East is Stirring !! We may be confronted with all this much sooner than expected !
