M40 J12-J14 – Data Analysis, Modelling and Scheme Development

M40 J12-J14 – Data Analysis, Modelling and Scheme Development. 20th March 2013. Existing Situation – M40 J14. Early 2011 WCC was approached by Warwickshire Police and HA regarding queuing on the southbound slip J14

rayya
Télécharger la présentation

M40 J12-J14 – Data Analysis, Modelling and Scheme Development

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. M40 J12-J14 – Data Analysis, Modelling and Scheme Development 20th March 2013

  2. Existing Situation – M40 J14 • Early 2011 WCC was approached by Warwickshire Police and HA regarding queuing on the southbound slip J14 • Surveys undertaken identified a significant flow from J14, turning right at Greys Mallory roundabout and heading south on the B4100 between 0700-0800 • Queuing at J14 is partly related to the high movement to the B4100 (i.e JLR and AML commuters) and also to capacity constraints on the A452 Europa Way corridor • 2011/12 a detailed modelling exercise was undertaken, schemes identified and funding secured. • WCC have now commenced with the detailed design of Europa Way corridor improvements. Work should commence on site June/July 2013

  3. Existing Situation – M40 J12 • Late 2011 queuing issues on SB slip at J12 were reported to WCC. • Traffic surveys and site observations identify an early peak hour for traffic arriving at the JLR/AML sites between 0700-0800. • Approx. 80% of employees originate from north of the sites and access them via M40 J12 or via the parallel B4100 route. • Commuters to the sites make up 90% of the traffic on the B4100 and other roads in the vicinity during 0700-0800 period.

  4. Existing Situation – M40 J12 • Significant safety risk commuters and other traffic on M40. • Extant planning permissions, JLR equivalent to 2,000 jobs and AML 600 jobs. • JLR/AML have no outstanding planning obligations to deliver highway mitigation related. • 20% car share, WCC/JLR in talks with Stagecoach.

  5. 1

  6. What immediate action was taken? Interim Measures • Temporary queue warning/ATM signs on M40. • Relocation of signs and vegetation removal at J12 to improve visibility. • Changes to lining and operation at JLR/AML roundabouts and at Gaydon roundabout. • Recommendation to HA for anti-skid surfacing at J12. • JLR commuter coaches from Leamington.

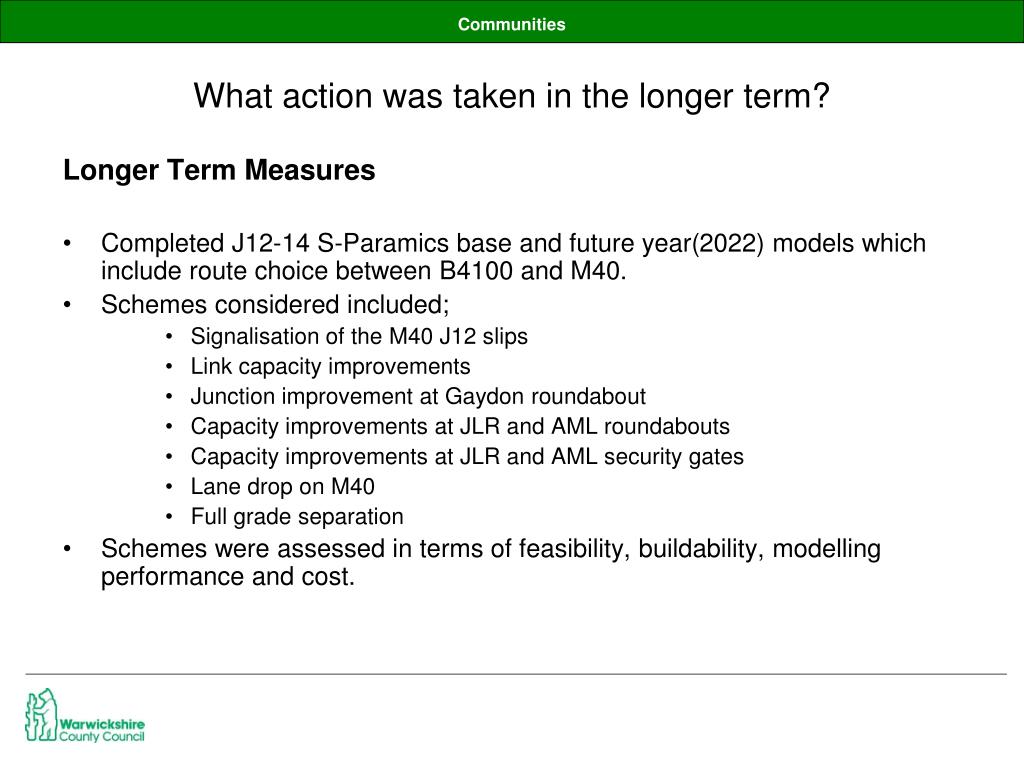

  7. What action was taken in the longer term? Longer Term Measures • Completed J12-14 S-Paramics base and future year(2022) models which include route choice between B4100 and M40. • Schemes considered included; • Signalisation of the M40 J12 slips • Link capacity improvements • Junction improvement at Gaydon roundabout • Capacity improvements at JLR and AML roundabouts • Capacity improvements at JLR and AML security gates • Lane drop on M40 • Full grade separation • Schemes were assessed in terms of feasibility, buildability, modelling performance and cost.

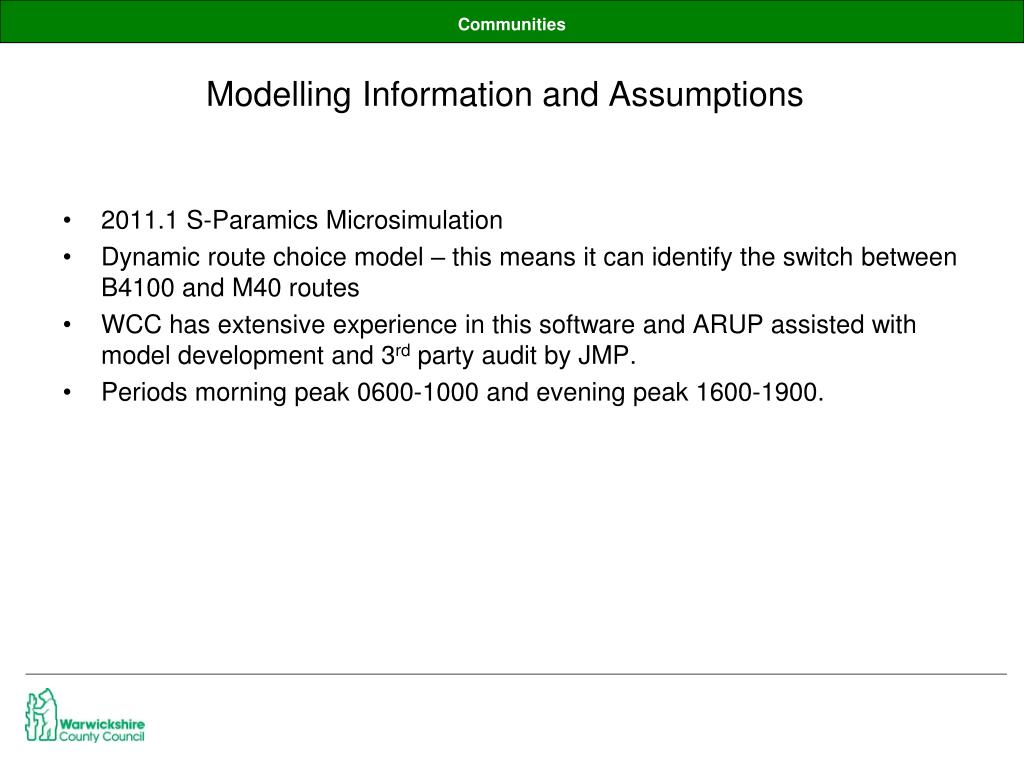

  8. Modelling Information and Assumptions • 2011.1 S-ParamicsMicrosimulation • Dynamic route choice model – this means it can identify the switch between B4100 and M40 routes • WCC has extensive experience in this software and ARUP assisted with model development and 3rd party audit by JMP. • Periods morning peak 0600-1000 and evening peak 1600-1900.

  9. Metres

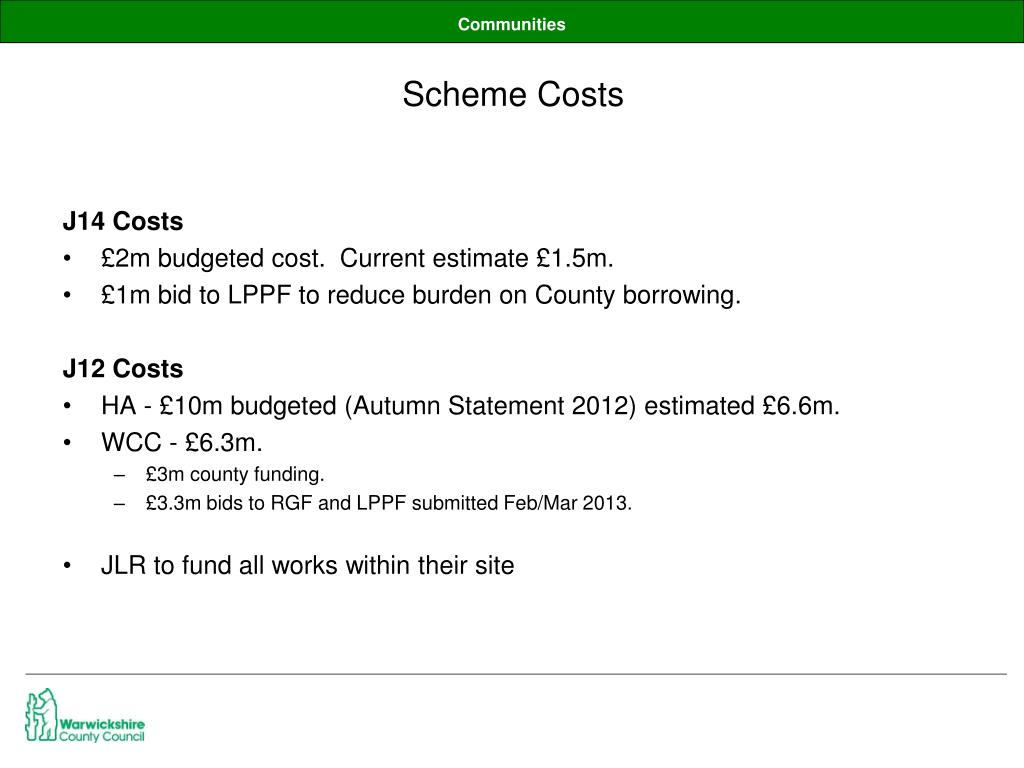

  10. Scheme Costs J14 Costs • £2m budgeted cost. Current estimate £1.5m. • £1m bid to LPPF to reduce burden on County borrowing. J12 Costs • HA - £10m budgeted (Autumn Statement 2012) estimated £6.6m. • WCC - £6.3m. • £3m county funding. • £3.3m bids to RGF and LPPF submitted Feb/Mar 2013. • JLR to fund all works within their site

  11. Risks • HA element of the scheme now out of WCC control. • Disruption during construction period. • Ecological. • Unchartered services and emergency utility works.

  12. Further Work J14 • Tendering of construction works. • Construction commence June/July 2013 (approximately 6 months) J12 • Detailed design and tender. • Secure final element of funding. • Model traffic management options. • Commence works on site Spring/Summer 2014.

  13. Contact Details Alan Law Principal Transport Planner & Modeller alanlaw@warwickshire.gov.uk

  14. Questions/Discussion
