ARMY CLEANUP PROGRAM – Status Update –

ARMY CLEANUP PROGRAM – Status Update – . Bob Mashburn Army Regional Environmental Office Atlanta, Georgia . BRIEFING OUTLINE . General Overview Summary Status Further Assessments Investigations FY10/11 Projects Contract 2010 .

acton
Télécharger la présentation

ARMY CLEANUP PROGRAM – Status Update –

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

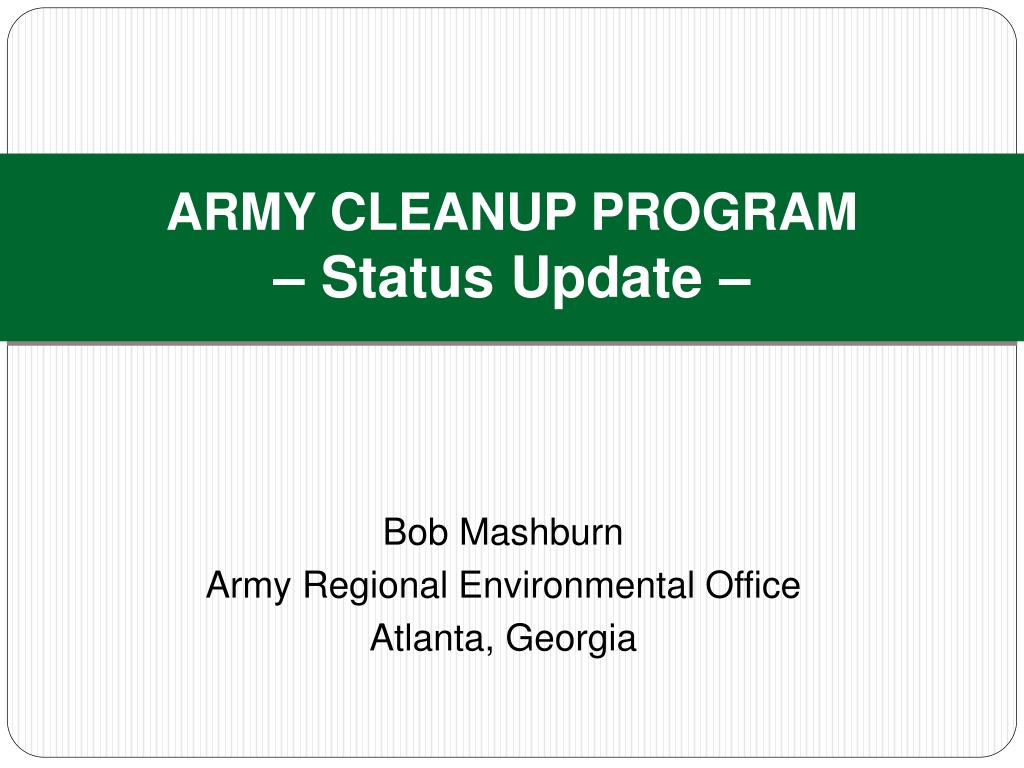

  1. ARMY CLEANUP PROGRAM – Status Update – Bob Mashburn Army Regional Environmental Office Atlanta, Georgia

  2. BRIEFING OUTLINE • General Overview • Summary Status • Further Assessments • Investigations • FY10/11 Projects • Contract 2010

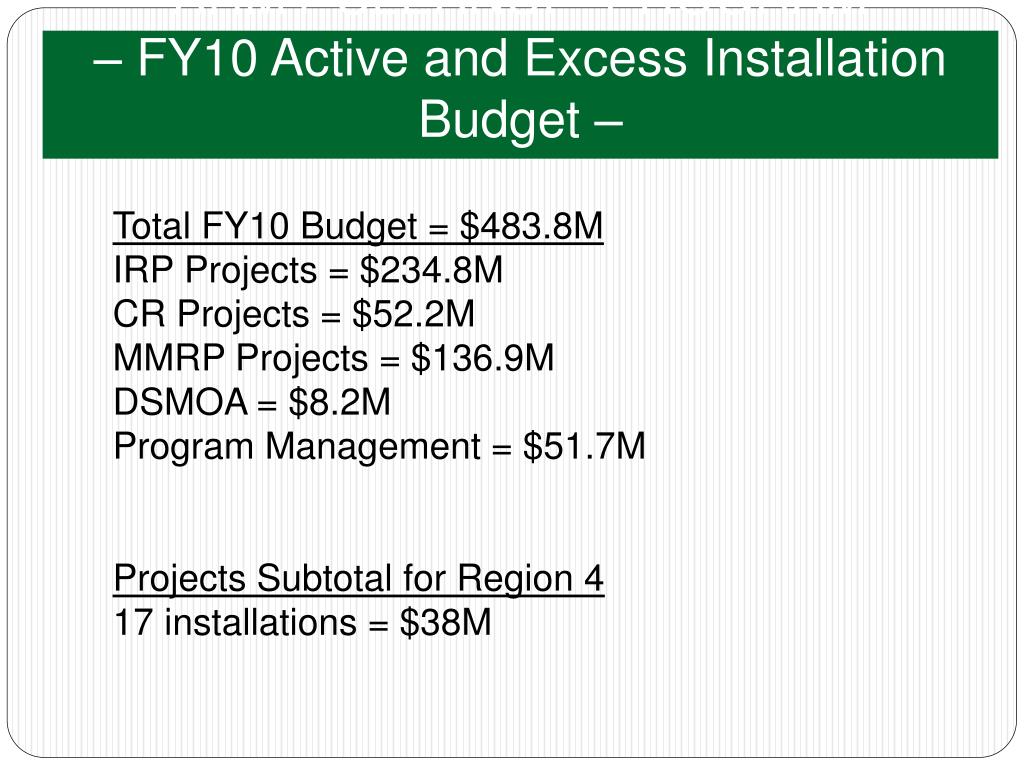

  3. ARMY CLEANUP PROGRAM – FY10 Active and Excess Installation Budget – Total FY10 Budget = $483.8M IRP Projects = $234.8M CR Projects = $52.2M MMRP Projects = $136.9M DSMOA = $8.2M Program Management = $51.7M Projects Subtotal for Region 4 17 installations = $38M

  4. MSAAP – GENERAL OVERVIEW • First and only ammunition plant built by the U.S. Army in 30 years (since 1953) • July 7, 1978 – Army obtained a 50 year irrevocable permit from NASA to construct and operate MSAAP • 1981 – RCRA Part A Permit application submitted for treatment of explosive waste • March 31, 1983 – MSAAP Dedicated • May 1983 – First production projectile metal parts assembly • September 9, 1983 – RCRA operating permit was issued jointly to the U.S. Army (MSAAP) and Mason Chamberlain, Inc. • May 1984 – Live loading began • 1990 – DoD placed MSAAP on inactive status/layaway • August 6, 1992 – Last munitions/explosive contaminated sump sludges processed • 1992 – MSAAP became an industrial park

  5. MSAAP – GENERAL OVERVIEW – Cont’d • September 9, 1993 - Explosive Waste Incinerator (EWI) operating permit expired - not renewed • 1993 – EWI and associated sumps decontaminated in accordance with the closure plan • September 6, 1994 – EWI closed under RCRA Subpart G, Part 264 • September 27, 1994 – MDEQ-OPC approves Closure Plan • October 7, 1994 – Verification plan was implemented • November 1994 – EWI Closure Certification Report was submitted to MDEQ. The Closure Certification Report was reviewed by MDEQ and closure was verified • March 4, 2009 – MSAAP was deactivated on as part of the Base Realignment and Closure, 2005 • July 29, 2009 - Official deactivation ceremony

  6. MS AAP - Summary Status • July 2009 – Army completed decon/demolition of Industrial Wastewater Treatment Plant – ECC Draft Closure Report dated July 16, 2009 – “Final” Closure – MDEQ Approval letter dated August 5, 2009 • MSAAP – April 2008 Final SI Report – NFA 9100 Area Water Tower Deionized Water Cooling Tower Motor Pool and Maintenance Mechanical Plant Parcel 13 [7] Sandblasting/Painting Area

  7. MSAAP – FURTHER ASSESSMENTS • 9100 Area Central Flammable Storage Drainage Canals Projectile metal Parts Tank Farm/Freon Recovery Building Forge Lube SAA/ESP Separator •  9400 All of this area • Parcel 12 [7] Explosives Waste Incinerator HR (Additional Reports/Records – Closure 1994)

  8. FURTHER GW INVESTIGATIONS • 9100 Area Overhead Waste Transfer Piping Scrap metal Storage Inert Waste Processor Cargo Metal Parts Vehicle Wash Rack/FGD Bldg Industrial WWTP • Parcel 11[7] Contaminated Waste Processor HRPR

  9. MSAAP – FY10/11 Projects • MSAAP-014 - Plume associated with the old Projectile Metal Parts operations. Project involves installation of monitoring wells, sampling over 8 quarters/vapor intrusion study. • MMRP project at the Spin Launch site. • Additional analysis and site activities at the following areas: -9100 Area (Groundwater, Vapor Intrusion, Drainage Canals) -9400 Area (Spin Launch Site) -Forge Lube Satellite Accumulation Area

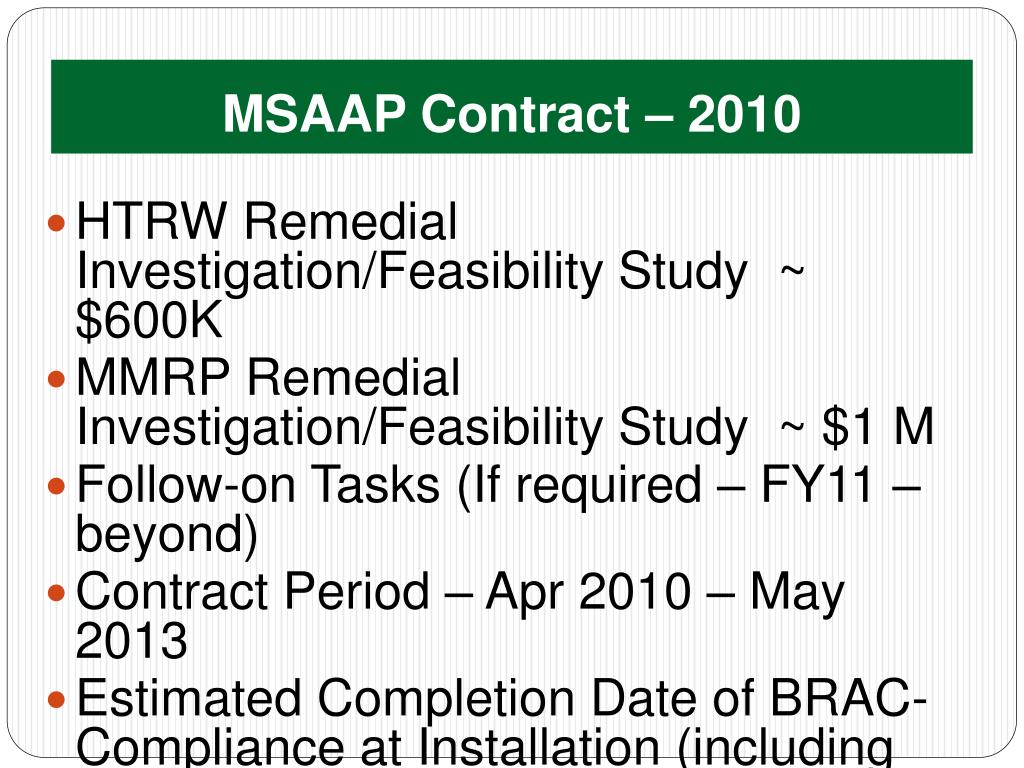

  10. MSAAP Contract – 2010 • HTRW Remedial Investigation/Feasibility Study ~ $600K • MMRP Remedial Investigation/Feasibility Study ~ $1 M • Follow-on Tasks (If required – FY11 – beyond) • Contract Period – Apr 2010 – May 2013 • Estimated Completion Date of BRAC-Compliance at Installation (including LTM phase): Dec 2012

  11. CONTACT INFORMATION Bob Mashburn Regional Project Manager Deputy Assistant Secretary of the Army (Environment, Safety & Occupational Health) - DASA (ESOH) 101 Marietta Street, NW, Suite 3120 Atlanta, GA 30303-5711 404.460.3134 bob.mashburn@us.army.mil
