Small or medium-scale focused research project (STREP) proposal ICT Call 7 FP7-ICT-2011-7 FP7 : Accessible Computer Vision (ACCOV) Small or medium scale focused research project (STREP) Date of preparation: 01.01.2011. Work programme topic addressed: ICT 2011.2.1 Cognitive Systems and Robotics (a) Name of the coordinating person: Radović Petar, Nikola Ranković Department of Computer Science Faculty of Mathematics University of Belgrade Petar Radović petar.radovic@gmail.com Nikola Ranković nikola.s.rankovic@gmail.com

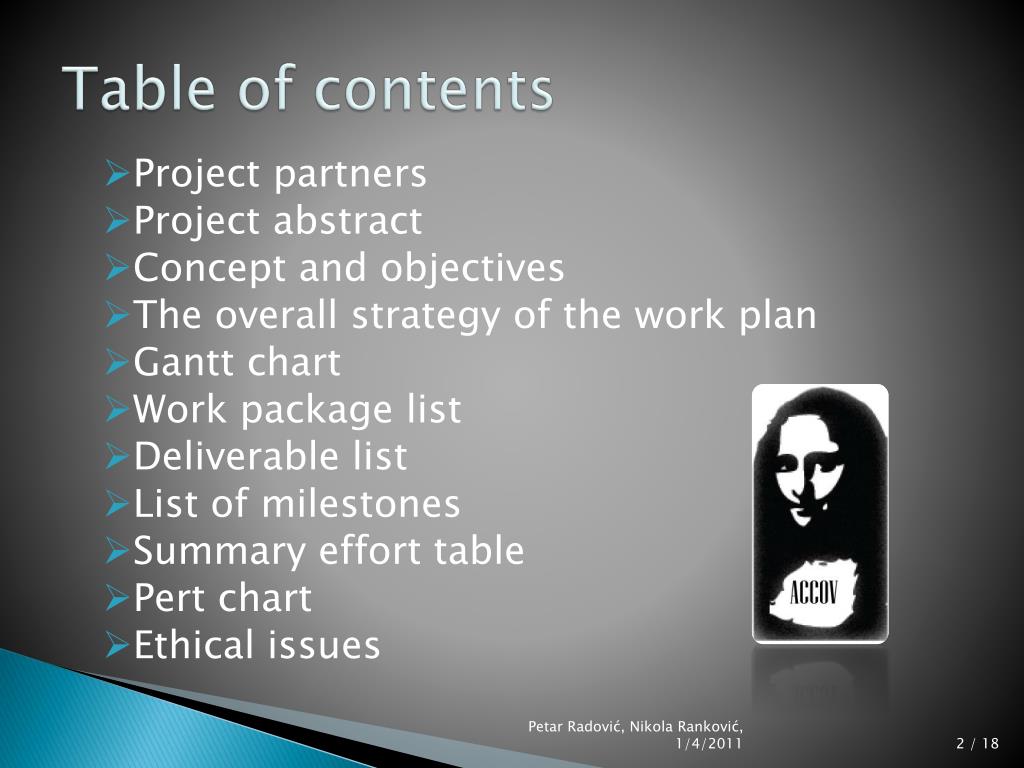

Table of contents • Project partners • Project abstract • Concept and objectives • The overall strategy of the work plan • Gantt chart • Work package list • Deliverable list • List of milestones • Summary effort table • Pert chart • Ethical issues Petar Radović, Nikola Ranković, 1/4/2011

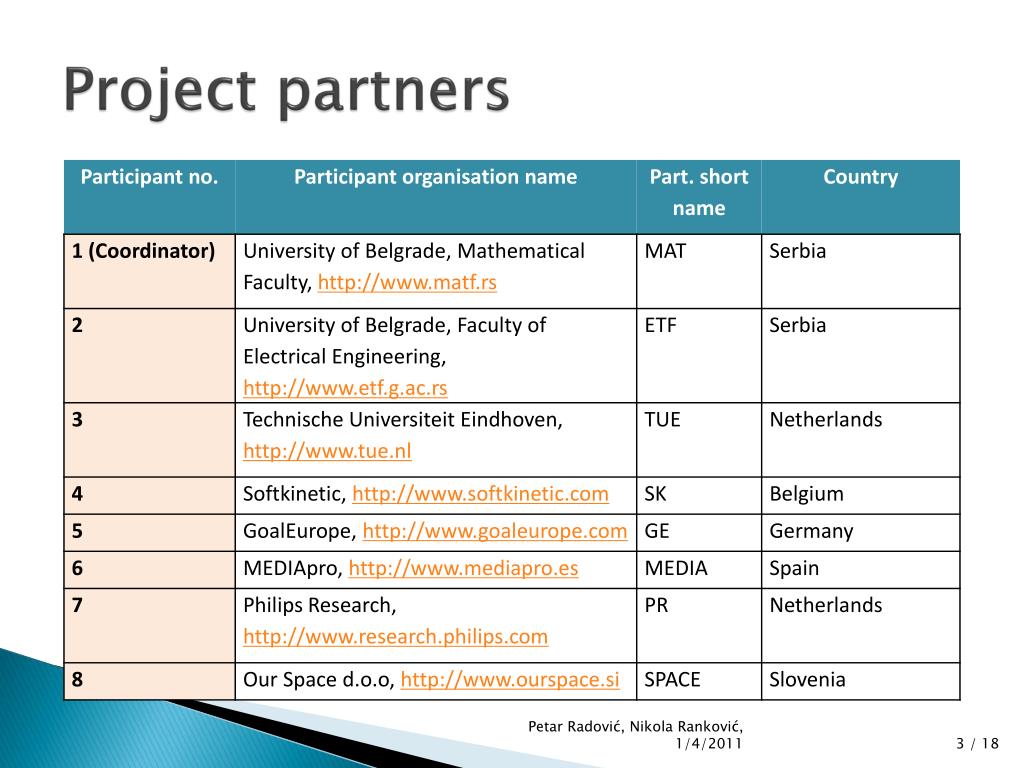

Project partners Petar Radović, Nikola Ranković, 1/4/2011
Project abstract • Latest advances in Computer Vision • Goal: • Affordable • Easily accessible • Potential to transform • Open access is the key • Final product: • HW Prototype of a standard • SDK Petar Radović, Nikola Ranković, 1/4/2011
Concept and objectives • Developing a computer vision system • Along with software development kit • A new standard • Possibly mass-produced at a low cost Petar Radović, Nikola Ranković, 1/4/2011

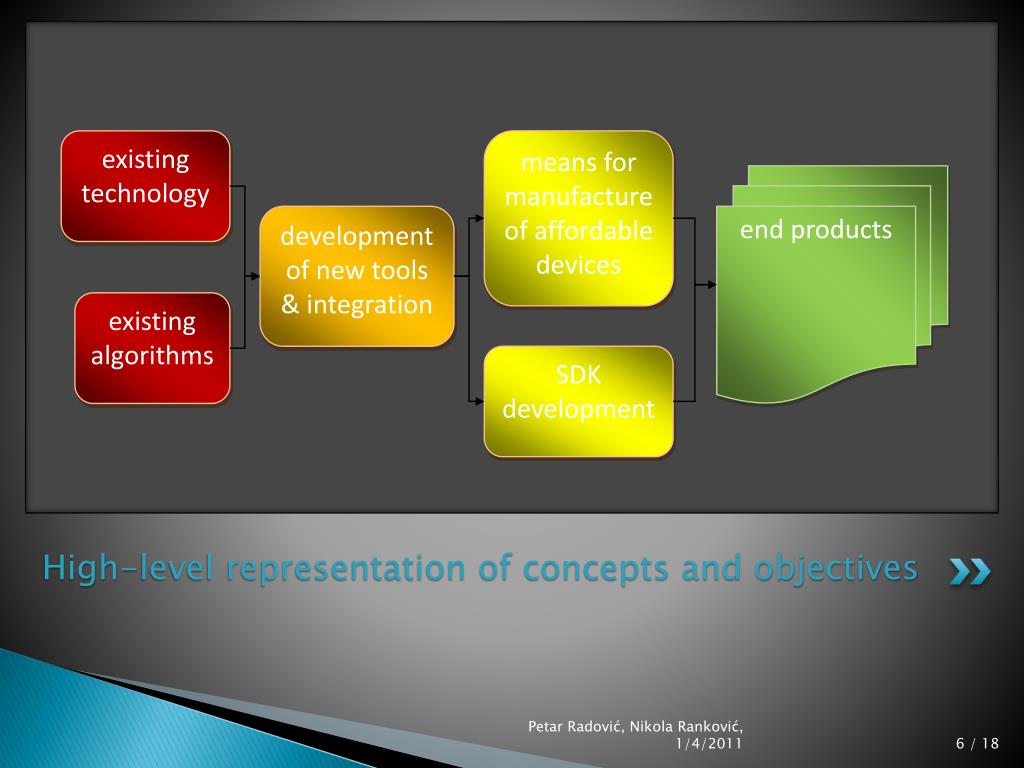

existing technology means for manufacture of affordable devices end products development of new tools & integration existing algorithms SDK development High-level representation of concepts and objectives Petar Radović, Nikola Ranković, 1/4/2011
The overall strategy of the work plan • The project is organized in 9 work packages: • WPO Project management • WP1 Development of Use Cases • WP2 Development of System Architecture • WP3 Hardware Details • WP4 Software Details • WP5 Proof of Concept Implementation • WP6 Testing • WP7 Dissemination • WP8 SDK release to third-parties Petar Radović, Nikola Ranković, 1/4/2011

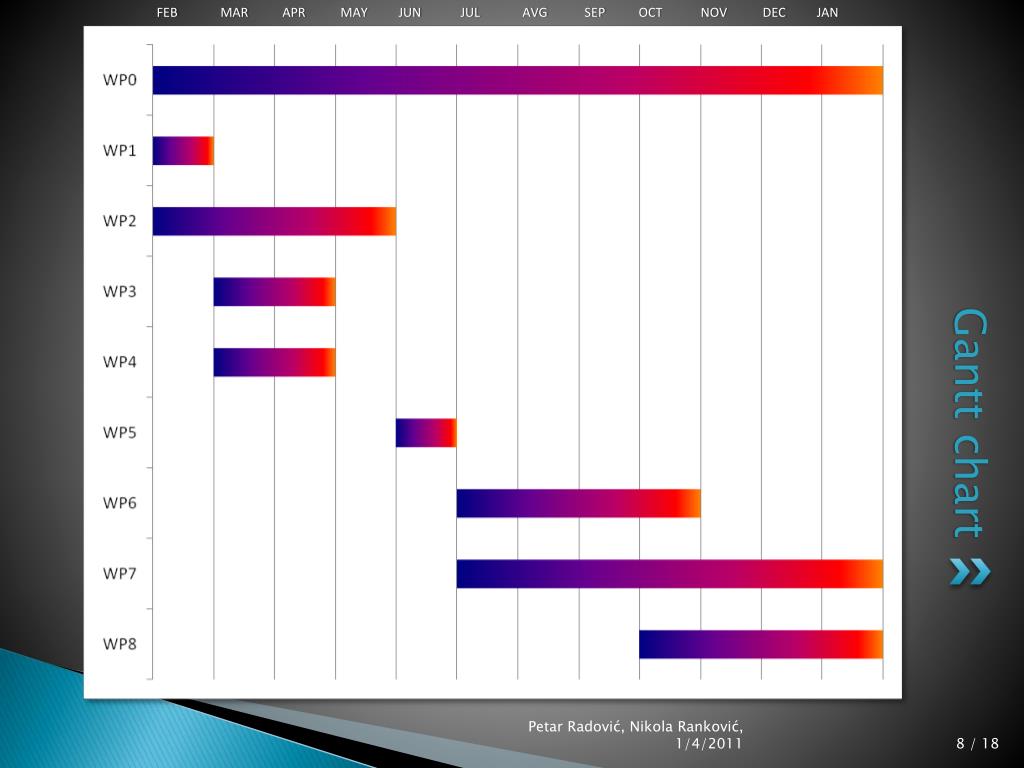

Gantt chart Petar Radović, Nikola Ranković, 1/4/2011

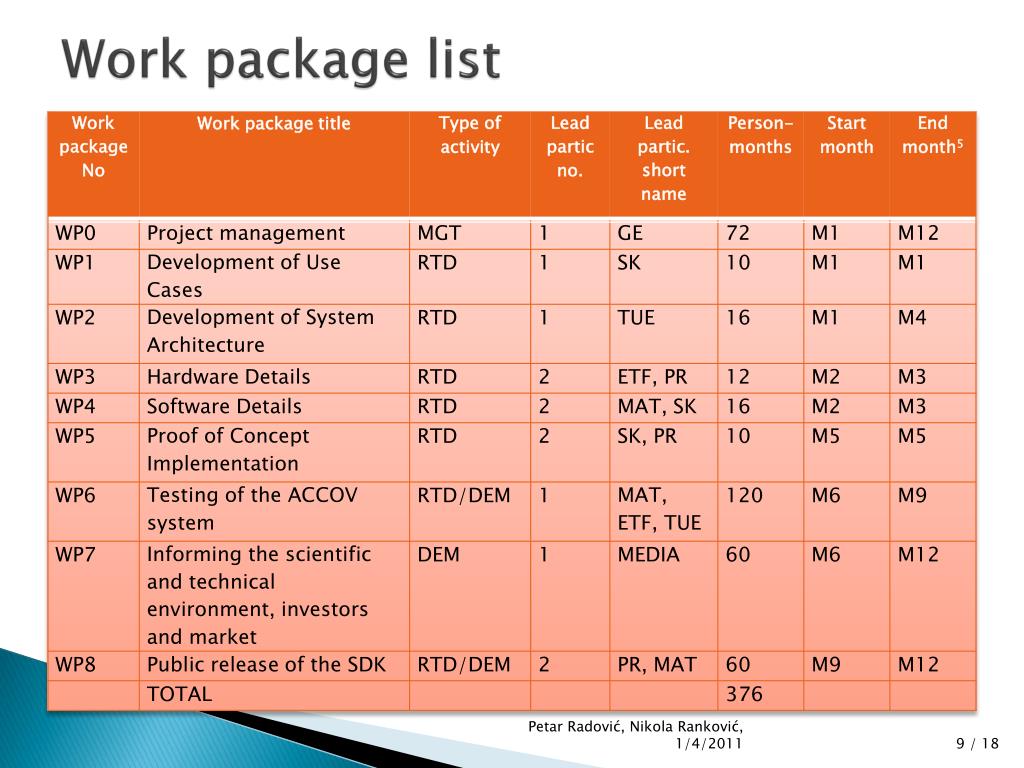

Work package list Petar Radović, Nikola Ranković, 1/4/2011
Deliverable list (WP0) Petar Radović, Nikola Ranković, 1/4/2011
Deliverable list (WP1 – WP6) Petar Radović, Nikola Ranković, 1/4/2011
Deliverable list (WP7 – WP8) Petar Radović, Nikola Ranković, 1/4/2011
List of milestones Petar Radović, Nikola Ranković, 1/4/2011

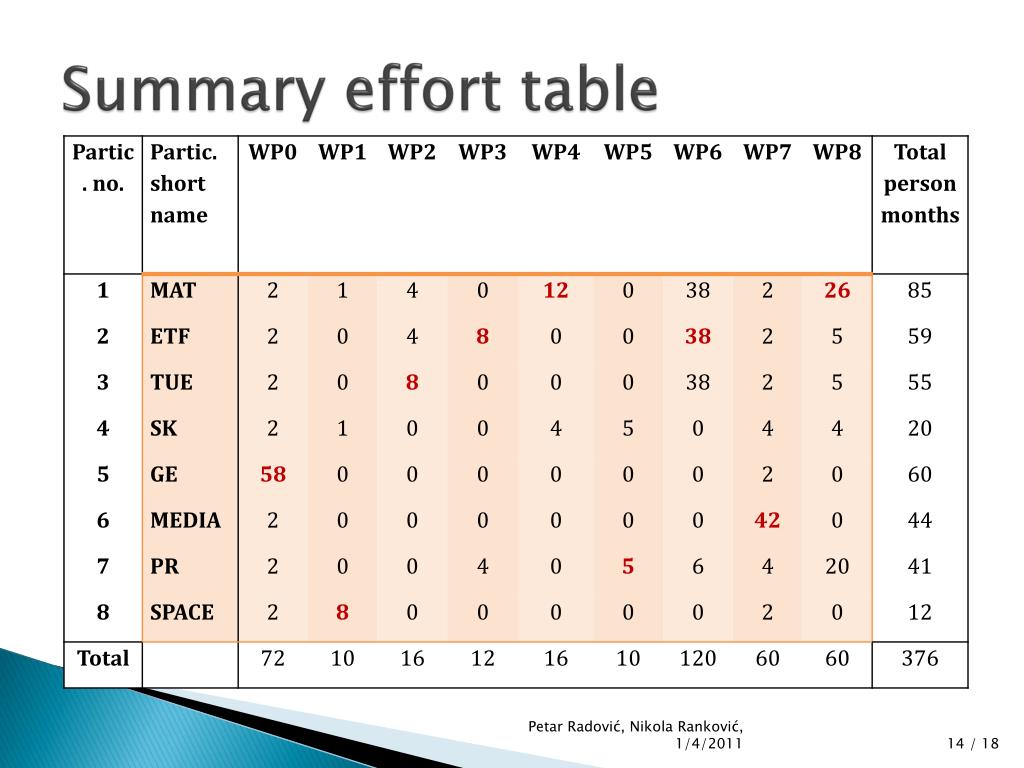

Summary effort table Petar Radović, Nikola Ranković, 1/4/2011

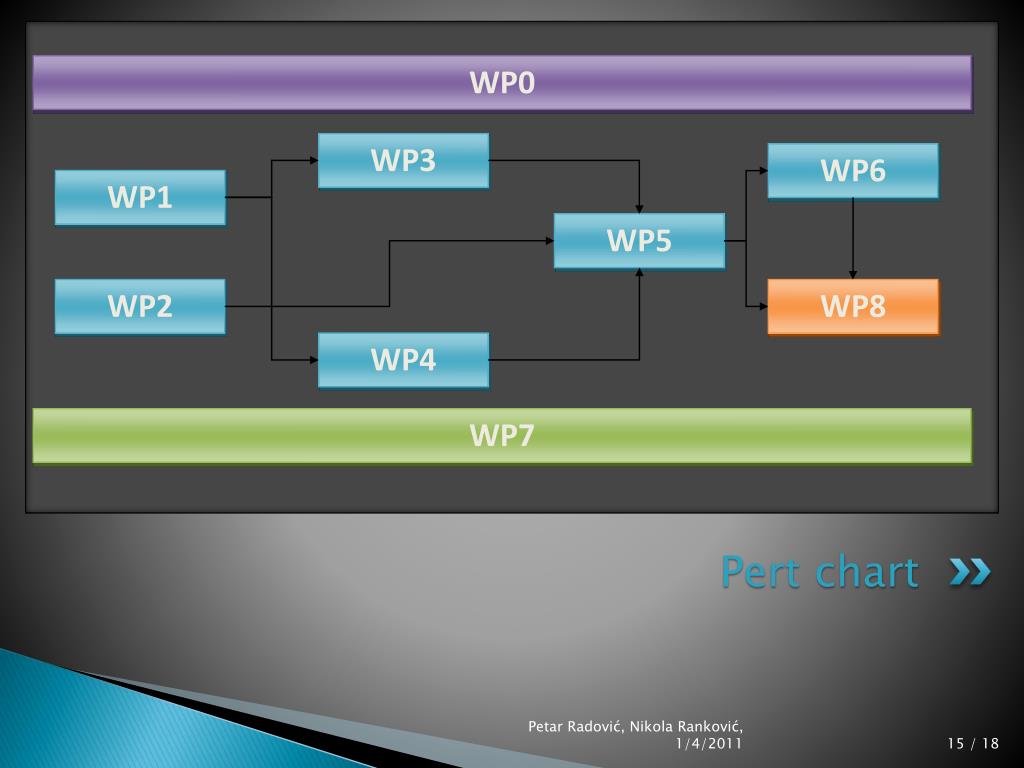

WP0 WP3 WP6 WP1 WP5 WP2 WP8 WP4 WP7 Pert chart Petar Radović, Nikola Ranković, 1/4/2011

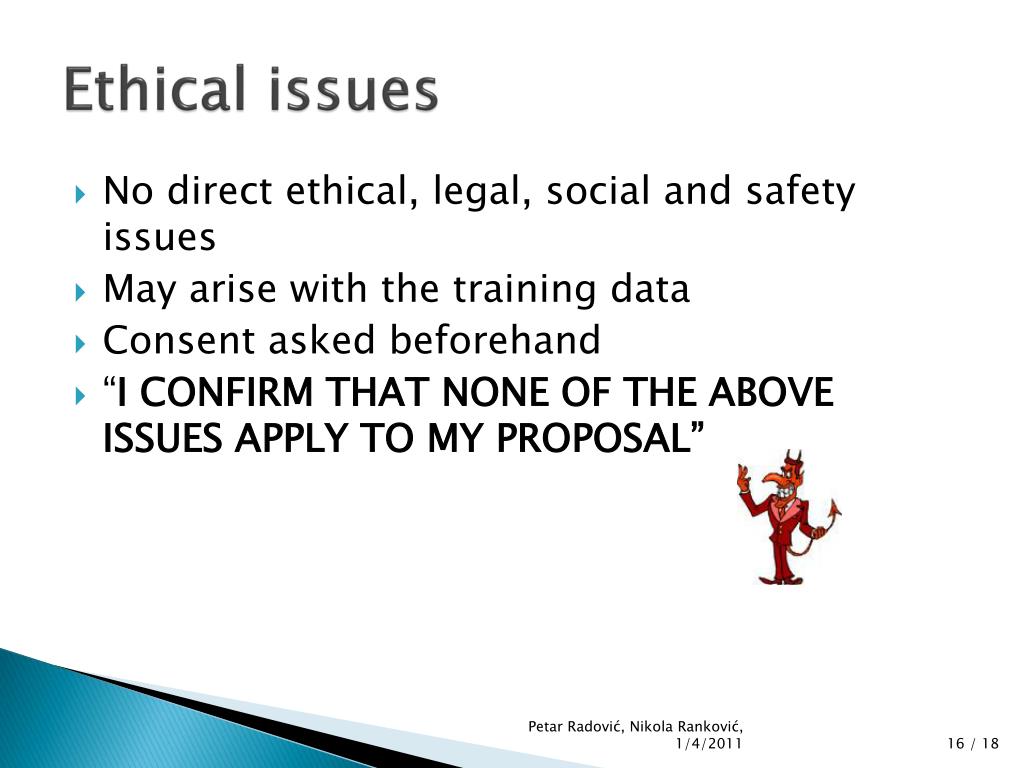

Ethical issues • No direct ethical, legal, social and safety issues • May arise with the training data • Consent asked beforehand • “I CONFIRM THAT NONE OF THE ABOVE ISSUES APPLY TO MY PROPOSAL” Petar Radović, Nikola Ranković, 1/4/2011
Questions? Petar Radović, Nikola Ranković, 1/4/2011
