SMC Change Control

Status Report and Discussion, 3/27/2013. SMC Change Control. Future Outlook 3/2012. Current and near-term change projects 13 180-day escapes 249 SPSs open About 1,800 change requests remain: 1,040 for KQ2 refresh if done pn-by-pn 153 for J147 KQ guide seat change (SNF?)

august
Télécharger la présentation

SMC Change Control

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Status Report and Discussion, 3/27/2013 SMCChange Control

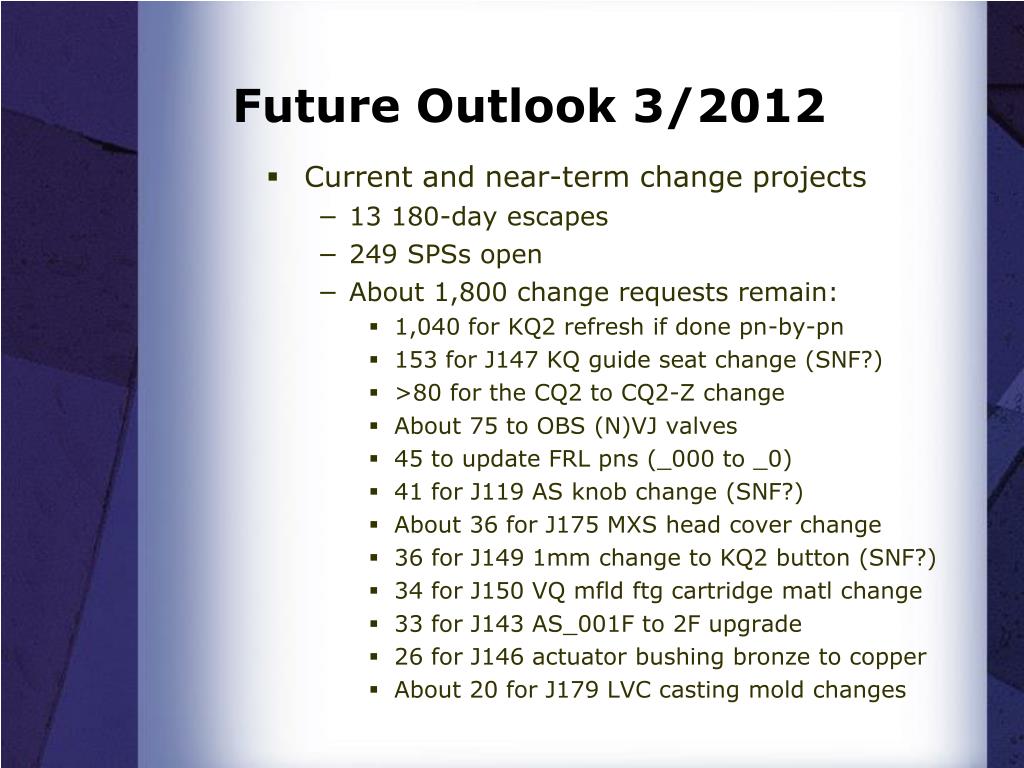

  2. Future Outlook 3/2012 Current and near-term change projects 13 180-day escapes 249 SPSs open About 1,800 change requests remain: 1,040 for KQ2 refresh if done pn-by-pn 153 for J147 KQ guide seat change (SNF?) >80 for the CQ2 to CQ2-Z change About 75 to OBS (N)VJ valves 45 to update FRL pns (_000 to _0) 41 for J119 AS knob change (SNF?) About 36 for J175 MXS head cover change 36 for J149 1mm change to KQ2 button (SNF?) 34 for J150 VQ mfld ftg cartridge matl change 33 for J143 AS_001F to 2F upgrade 26 for J146 actuator bushing bronze to copper About 20 for J179 LVC casting mold changes

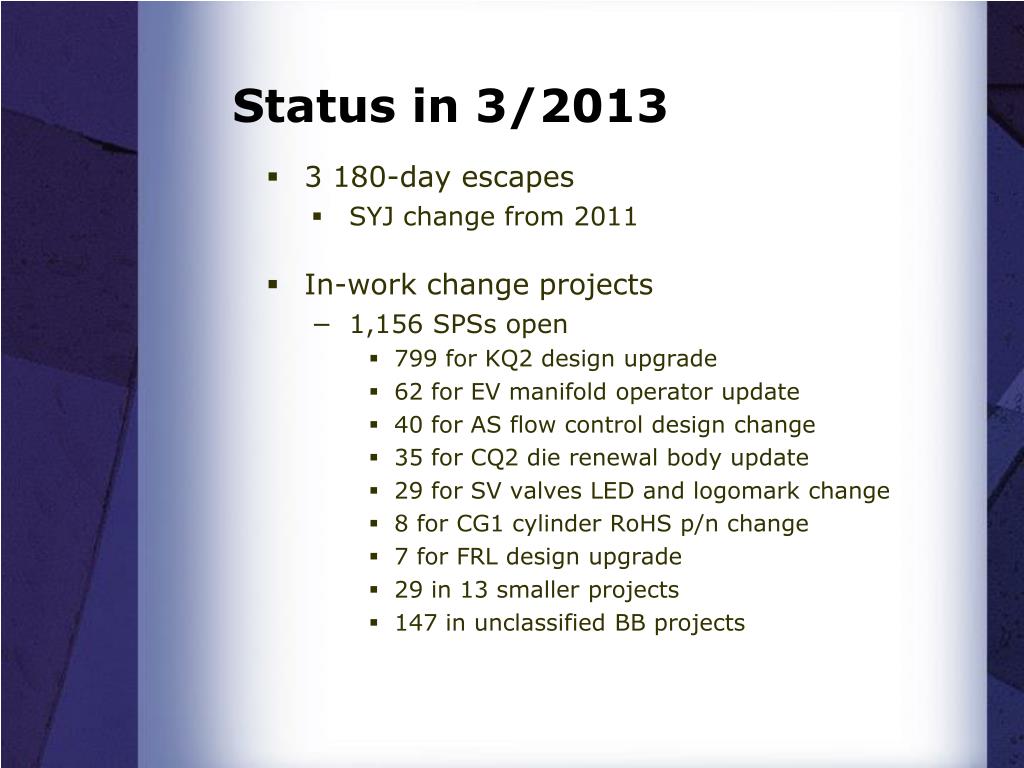

  3. Status in 3/2013 3 180-day escapes SYJ change from 2011 In-work change projects 1,156 SPSs open 799 for KQ2 design upgrade 62 for EV manifold operator update 40 for AS flow control design change 35 for CQ2 die renewal body update 29 for SV valves LED and logomark change 8 for CG1 cylinder RoHS p/n change 7 for FRL design upgrade 29 in 13 smaller projects 147 in unclassified BB projects

  4. Number of notifications

  5. Future Outlook 3/2013 Current and near-term change projects FRL refresh in-work, 120pns remain VQZ series coil upgrade About 15pns VJ obsolescence Ongoing, about 50pns near-term CE! parts list clean-up, ongoing Around 500pns Mostly PN changes such as dropping the initial N or changing to a modern replacement MPN Mid-range change projects Additional CQ2/CQS pns body changes Roughly 55pns Considering 5-year reserve stock

  6. Future Outlook 3/2013 Long-range change projects SY series coil upgrade Superior operator similar to VQs Ultimate plan is to replace other series as the flagship SMC valve Possibly 30-36 months from now Transition to Applied Materials timeline Sync with technology node changes Reduce or eliminate mid-run changes Showcase modern products for new nodes Eliminate EOL product from the CE! index

  7. A Couple Questions Varian, Semitool Change notification process is very different to SPS & SNF GMOX and the SPS sytem E-supplier replacing GMOX Will change the SPS or SNF process? Flagging EOL product in reserve Some future changes we can set aside reserve stock until strategic time to change Is there a method to flag product as EOL so it doesn’t go on a new design BOM? ECO Is there an ECO library similar to FAIs?
