Real-time Monitoring and Diagnostic Solution for an HVAC System ECE Team 169 Anthony Bellantoni (EE) Greg Carmichael (EPhys) Joe Grassi (EE) Sponsored by: Qualtech Systems Inc. Advisor: John Chandy

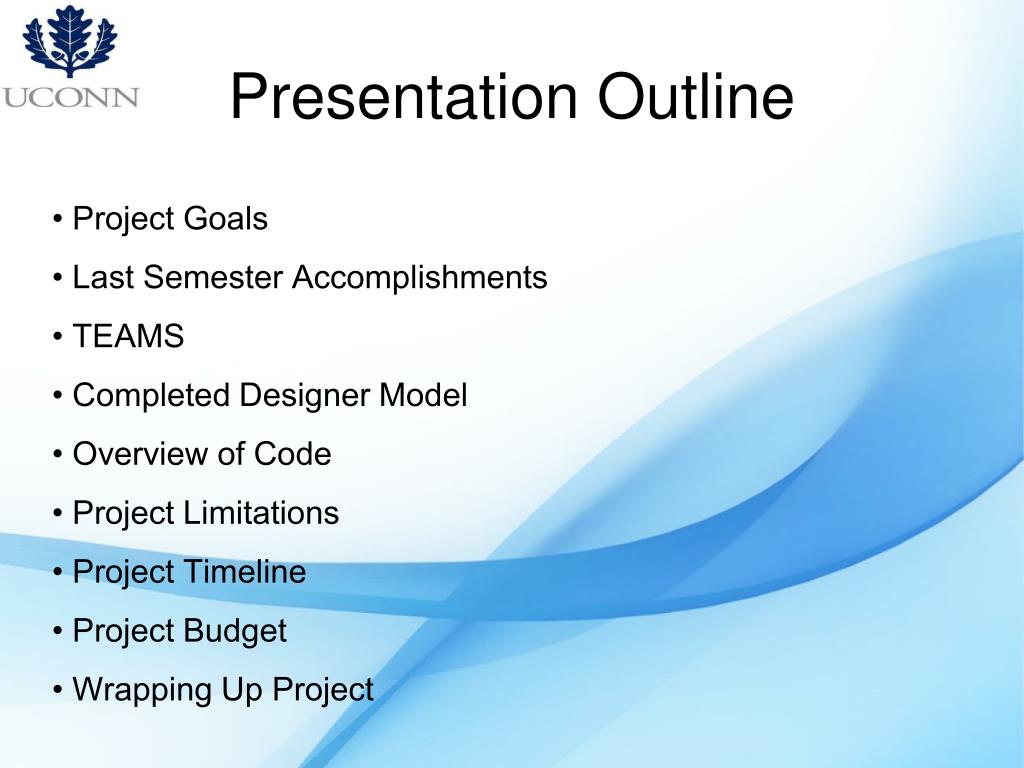

Presentation Outline • Project Goals • Last Semester Accomplishments • TEAMS • Completed Designer Model • Overview of Code • Project Limitations • Project Timeline • Project Budget • Wrapping Up Project
Overall Project Goals • Update and complete HVAC Model - Previous Senior Design Project –Developed Partial Diagnostic Model of the ITEB HVAC System • Develop C++ program, extract and analyze real-time data from the building sensors • Combine model and code to detect for faults in real-time.
Fall 2012 • Completed and fixed HVAC model • Met with facilities to ensure model was correct • Main Limitation • No Real-time data • Hard to develop code
TEAMS • Testability Engineering and Maintenance system • Designer • RDS • Remote Diagnostic Server • SDK • Combines client to RDS http://tomgpalmer.com/wp-content/uploads/legacy-images/FLASH%20LIGHT.jpg
Picture for RDS using mike (maintenance group) most likely 3 slides

C++ Coding Goals • Extract sensor values from text file and determine whether or not a failure is occurring • Save results to a text file • Import results file into TEAMS-RT • TEAMS-RT will combine code with our model and determine most probable failure point and associated test cost

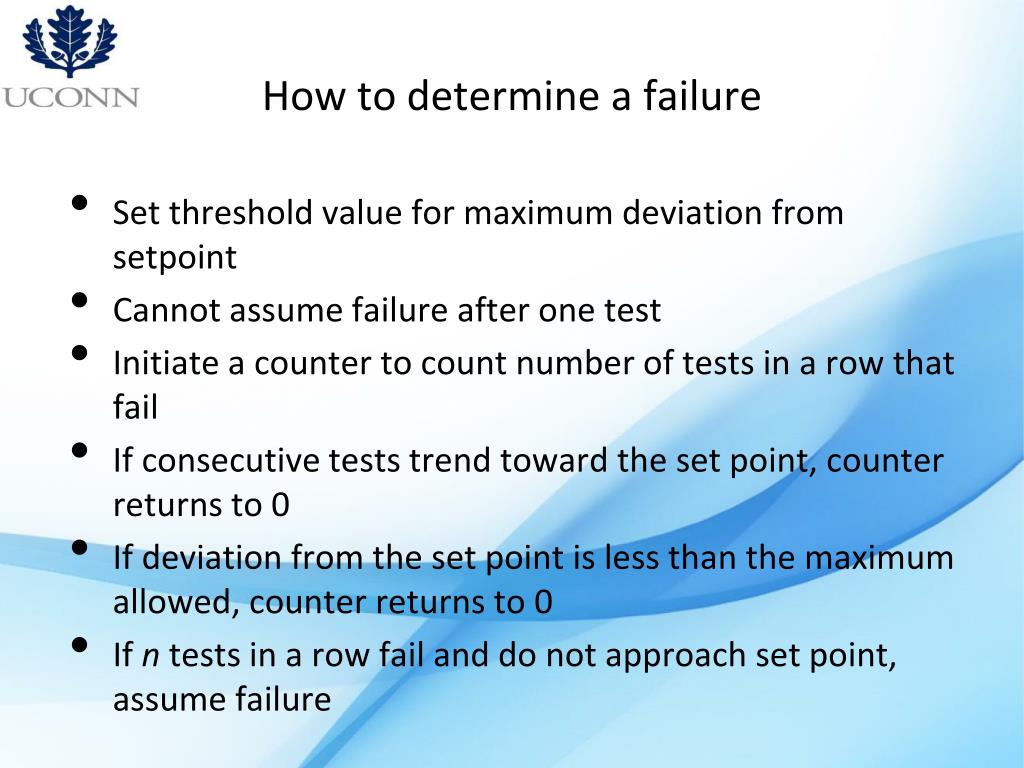

How to determine a failure • Set threshold value for maximum deviation from setpoint • Cannot assume failure after one test • Initiate a counter to count number of tests in a row that fail • If consecutive tests trend toward the set point, counter returns to 0 • If deviation from the set point is less than the maximum allowed, counter returns to 0 • If n tests in a row fail and do not approach set point, assume failure

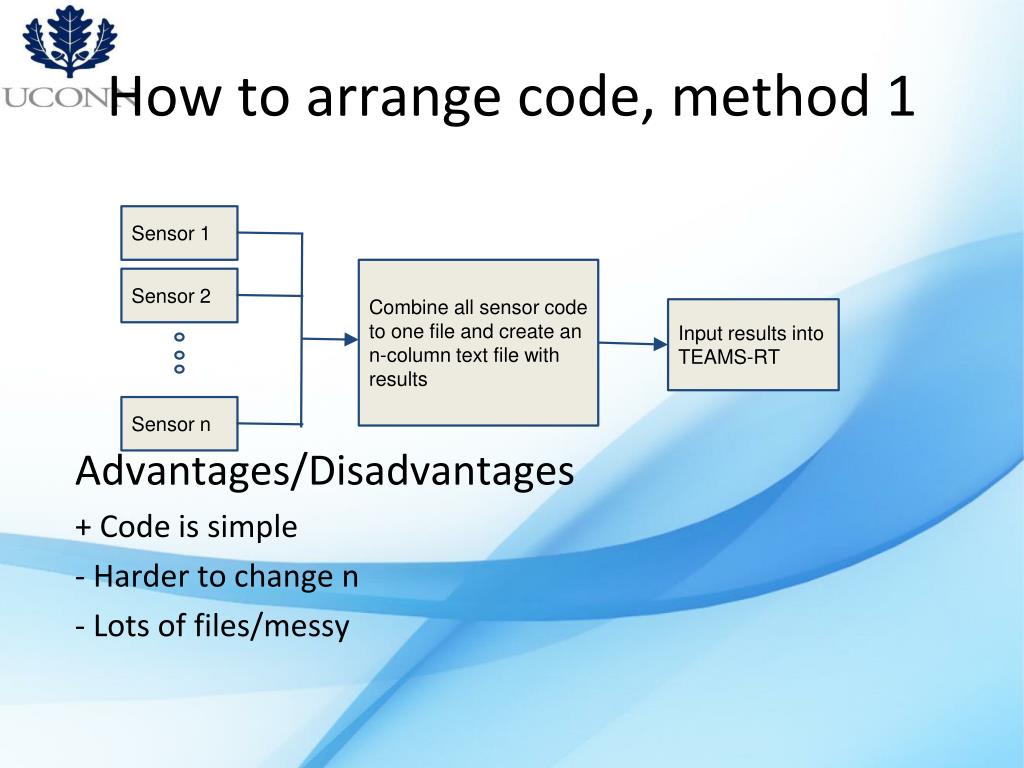

How to arrange code, method 1 Advantages/Disadvantages + Code is simple - Harder to change n - Lots of files/messy Sensor 1 Combine all sensor code to one file and create an n-column text file with results Sensor 2 Input results into TEAMS-RT Sensor n
Advantages/Disadvantages + Code is neat and easy to debug + Easy to change number of sensors - Coding is difficult Method 2 One code file to extract results from n sensor files and output results into an n-column text file Temperature Input results into TEAMS-RT Humidity
Project Limitations • Cost and time of each failure • Talked to facilities: do not have information • Obtaining access to actual VAV sensor values
Project Budget http://static.seekingalpha.com/uploads/2009/3/4/saupload_mar04_09_bm.jpg http://www.rosemarierealty.com/wp-content/uploads/2012/03/dreamstime_xs_17999966-300x300.jpg http://blog.outreach.com/wp-content/uploads/2011/09/Church-events-on-no-Budget.jpg http://i.crn.com/images/free_cloud_400.jpg

Next Steps: Weekly Goals March 10 - March 16 • Multiply our code to work for multiple VAVs • Learn and Read TEAMS-SDK Manual • Label possible reasons of failure for maintenance checks in TEAMS Designer March 17 - March 23(Spring Break) • Research associated pricing for each component (including maintenance) March 24 - March 31 • Continue to debug and implement code • Continue step-by-step instructions for maintenance fixes • Add any found costs/maintenance pricing found into TEAMS • Wrap up model + code April • Contact Moises to check if model is complete • Begin final presentation & report preparation • Wrap up Entire project and present it
