Engineers in Action. Joe Alvarez EIA Engineer. Building a better future for tomorrow. Kumurana Project status: Limestone Channels and abandoned mine sealing. Limestone Delivery. Channels:~358m tons Abandoned Mine:~135m tons. Limestone Channels. Limestone delivery

bedros
Télécharger la présentation

Joe Alvarez EIA Engineer

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Engineers in Action Joe AlvarezEIA Engineer Building a better future for tomorrow Kumurana Project status: Limestone Channels and abandoned mine sealing

  2. Limestone Delivery Channels:~358m tons Abandoned Mine:~135m tons

  3. Limestone Channels • Limestone delivery • Required Volume for channles:2027m3 • Amount of Limestone Delivered:~358 Metric tons for the channels [About 14% of the total limestone delivery]

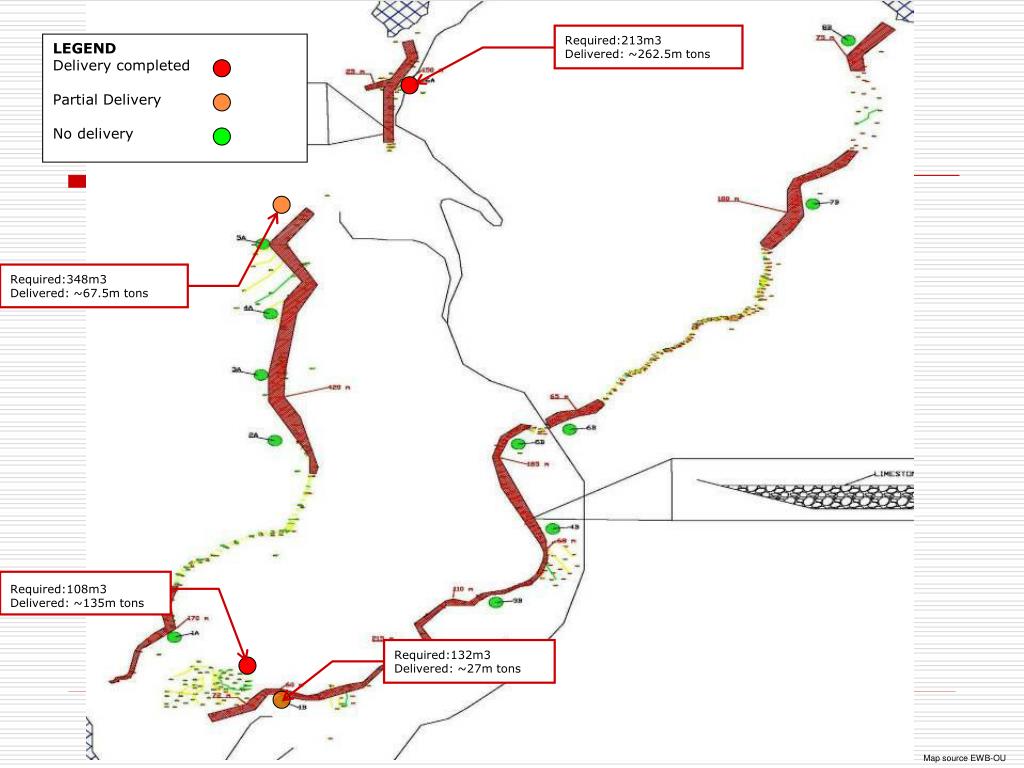

  4. Required:213m3Delivered: ~262.5m tons LEGENDDelivery completedPartial DeliveryNo delivery Required:108m3Delivered: ~135m tons Required:348m3Delivered: ~67.5m tons Required:132m3Delivered: ~27m tons Map source EWB-OU

  5. Limestone Channels Cont’d • Installation • The installation of limestone into the channels is pending • Taking advantage of trucks • Community support to install the limestone • Water analysis coordination with CIMA and Universidad Tomas Frias

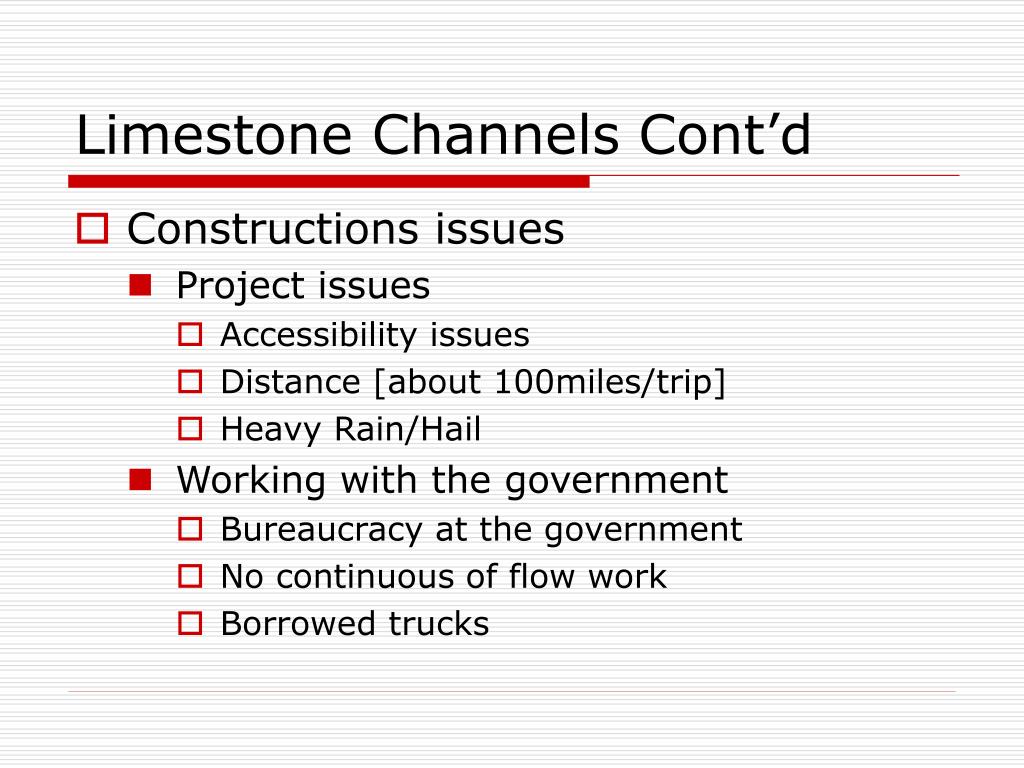

  6. Limestone Channels Cont’d • Constructions issues • Project issues • Accessibility issues • Distance [about 100miles/trip] • Heavy Rain/Hail • Working with the government • Bureaucracy at the government • No continuous of flow work • Borrowed trucks

  7. Accessibility issues

  8. Rain

  9. Bureaucracy

  10. Abandoned Mine sealing • Limestone • Delivered 108m3 of limestone delivery-complete • Limestone installation is pending • Oxidation pond • 90% completed • Some improvements needed to finish • Inaccessible with a heavy equipment to continue digging and finish. [wetlands] • Wall sealing • Construction starts when the worksite area becomes accessible • Estimated length of conclusion of the wall about 2-3 weeks
