International Linear Collider (ILC) Program Overview

Explore the program overview of the International Linear Collider (ILC) and the Global Design Effort (GDE) in collaboration with Cornell University and DOE/NSF. Discover the ILC baseline configuration, R&D program highlights, challenges, and future outlook. Learn about the formation, goals, and key members of the Global Design Effort.

Télécharger la présentation

International Linear Collider (ILC) Program Overview

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. ILC-Americas Program Overview G. Dugan ILC/GDE and Cornell University DOE/NSF ILC Program Review Apr. 4-6, 2006

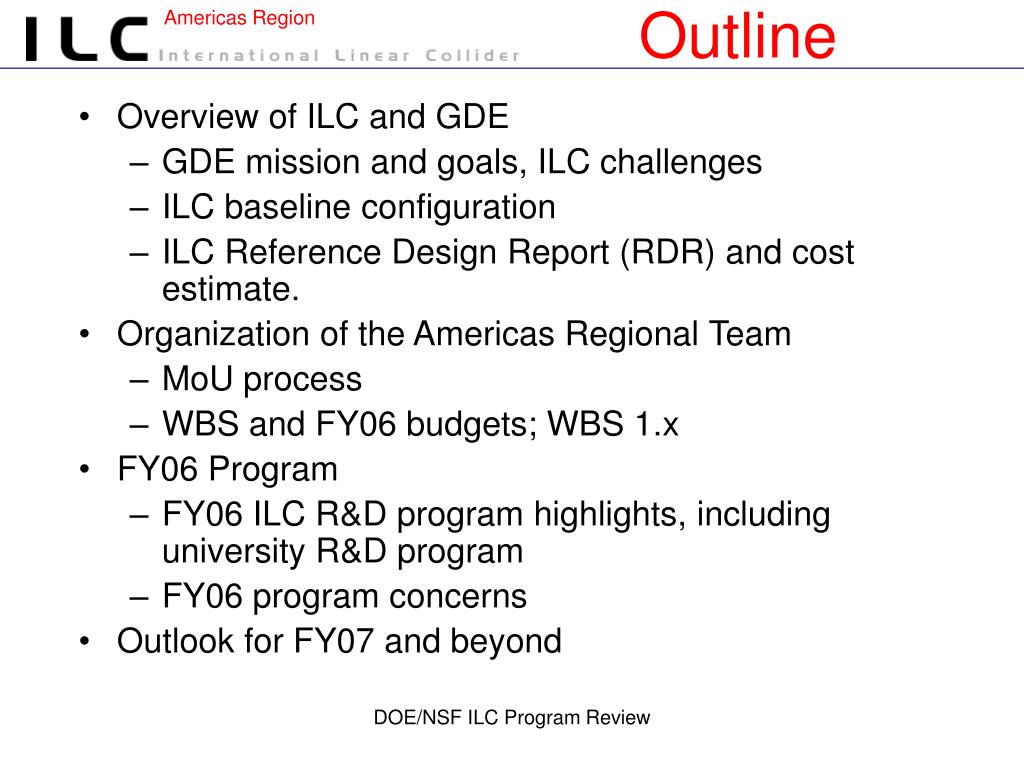

  2. Outline • Overview of ILC and GDE • GDE mission and goals, ILC challenges • ILC baseline configuration • ILC Reference Design Report (RDR) and cost estimate. • Organization of the Americas Regional Team • MoU process • WBS and FY06 budgets; WBS 1.x • FY06 Program • FY06 ILC R&D program highlights, including university R&D program • FY06 program concerns • Outlook for FY07 and beyond DOE/NSF ILC Program Review

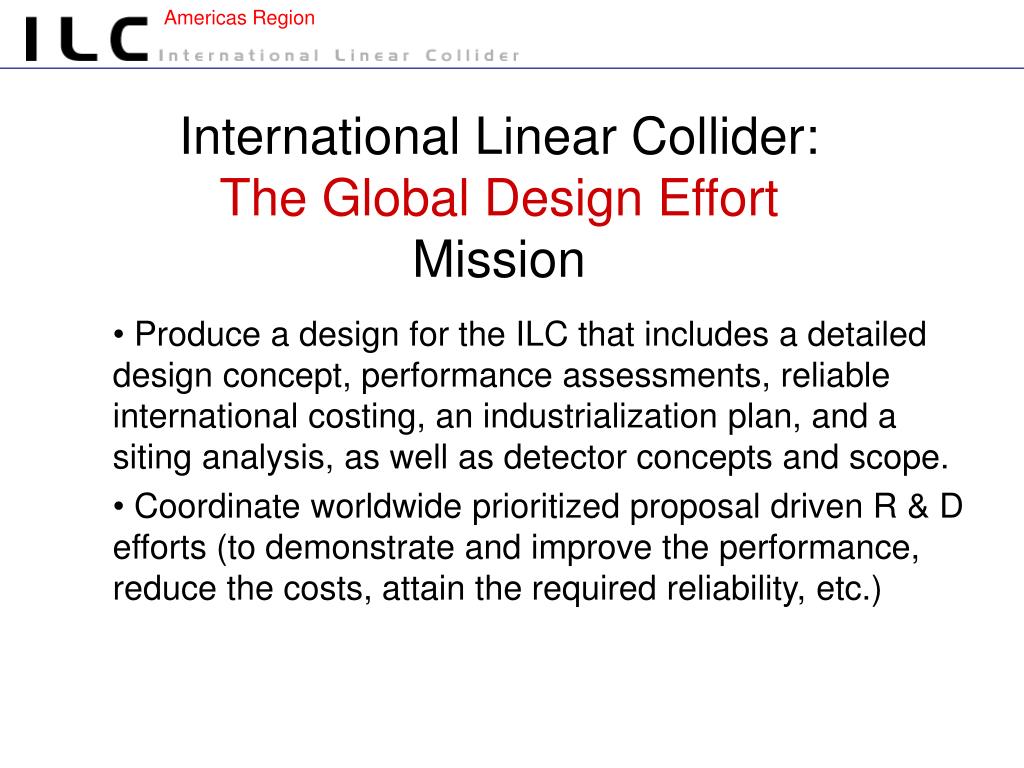

  3. International Linear Collider: The Global Design EffortMission Produce a design for the ILC that includes a detailed design concept, performance assessments, reliable international costing, an industrialization plan, and a siting analysis, as well as detector concepts and scope. Coordinate worldwide prioritized proposal driven R & D efforts (to demonstrate and improve the performance, reduce the costs, attain the required reliability, etc.)

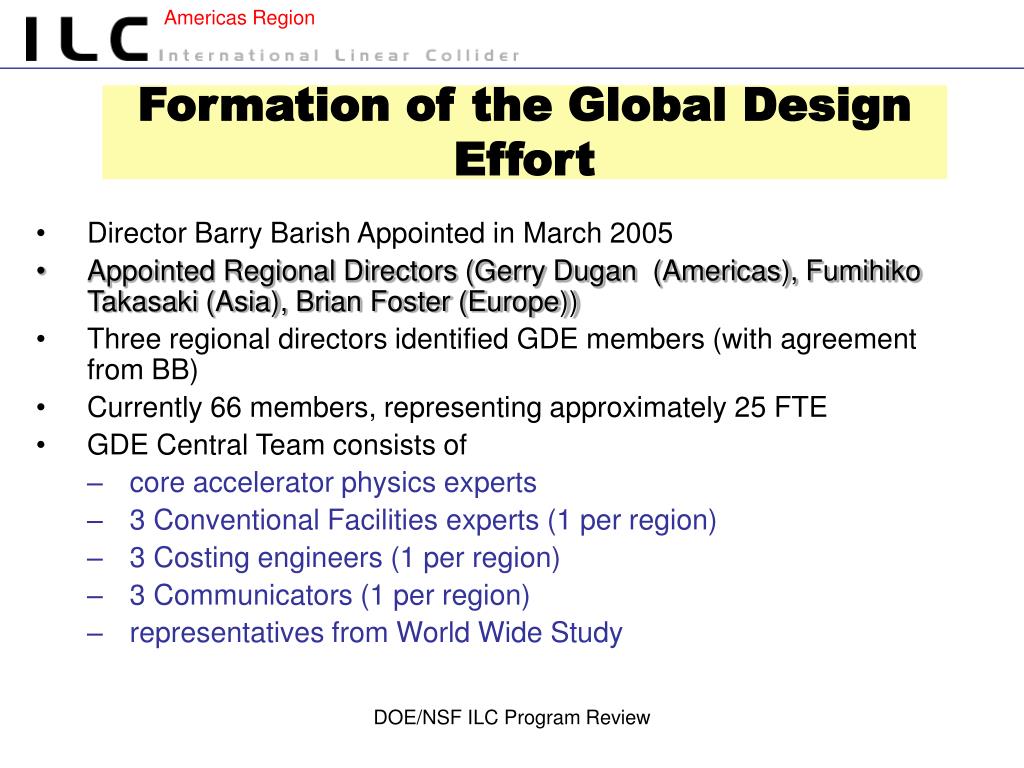

  4. Formation of the Global Design Effort • Director Barry Barish Appointed in March 2005 • Appointed Regional Directors (Gerry Dugan (Americas), Fumihiko Takasaki (Asia), Brian Foster (Europe)) • Three regional directors identified GDE members (with agreement from BB) • Currently 66 members, representing approximately 25 FTE • GDE Central Team consists of • core accelerator physics experts • 3 Conventional Facilities experts (1 per region) • 3 Costing engineers (1 per region) • 3 Communicators (1 per region) • representatives from World Wide Study DOE/NSF ILC Program Review

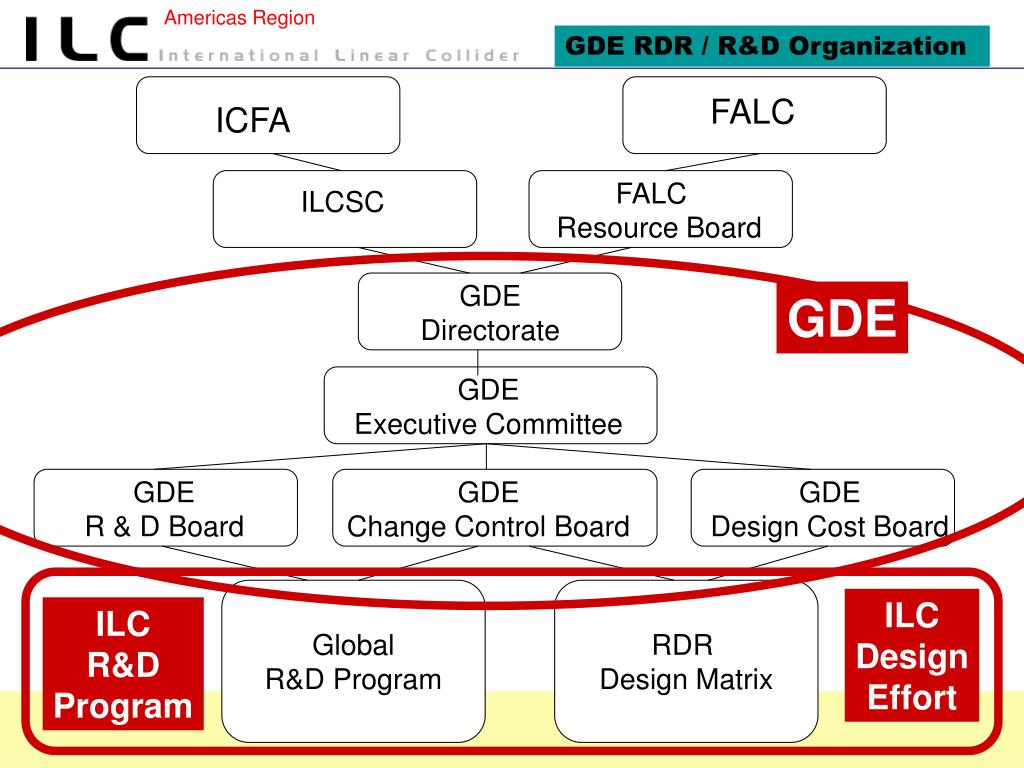

  5. GDE RDR / R&D Organization FALC ICFA FALC Resource Board ILCSC GDE Directorate GDE GDE Executive Committee GDE R & D Board GDE Change Control Board GDE Design Cost Board Global R&D Program RDR Design Matrix ILC Design Effort ILC R&D Program DOE/NSF ILC Program Review

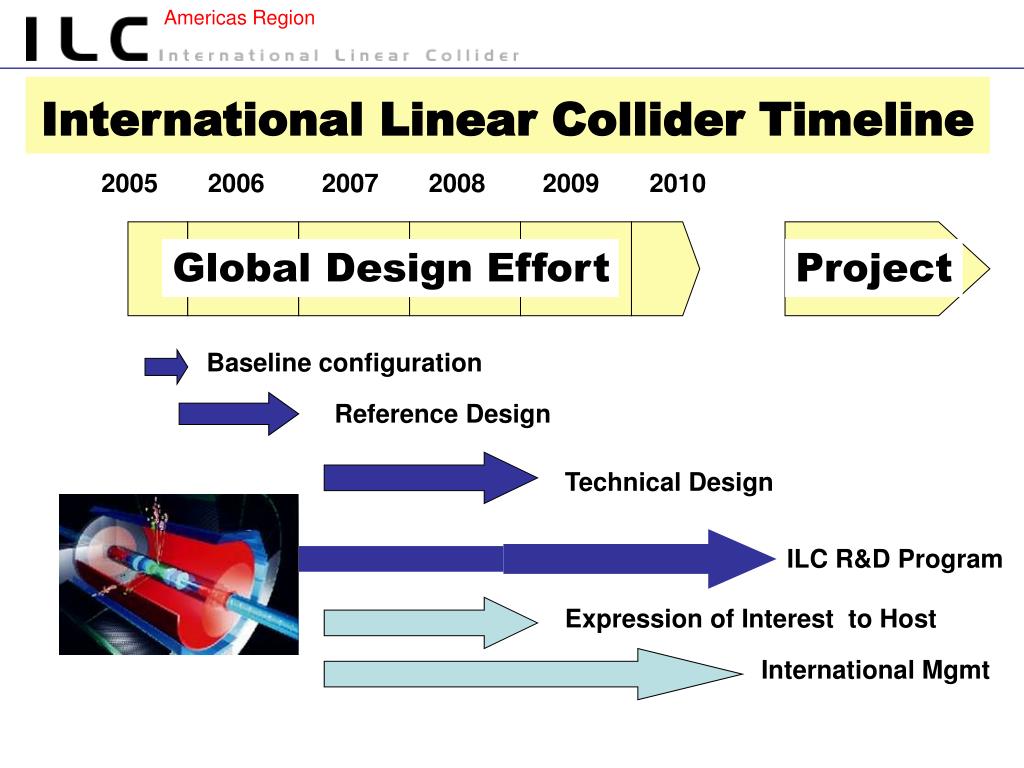

  6. 2005 2006 2007 2008 2009 2010 Global Design Effort Project Baseline configuration Reference Design International Linear Collider Timeline Technical Design ILC R&D Program Expression of Interest to Host International Mgmt

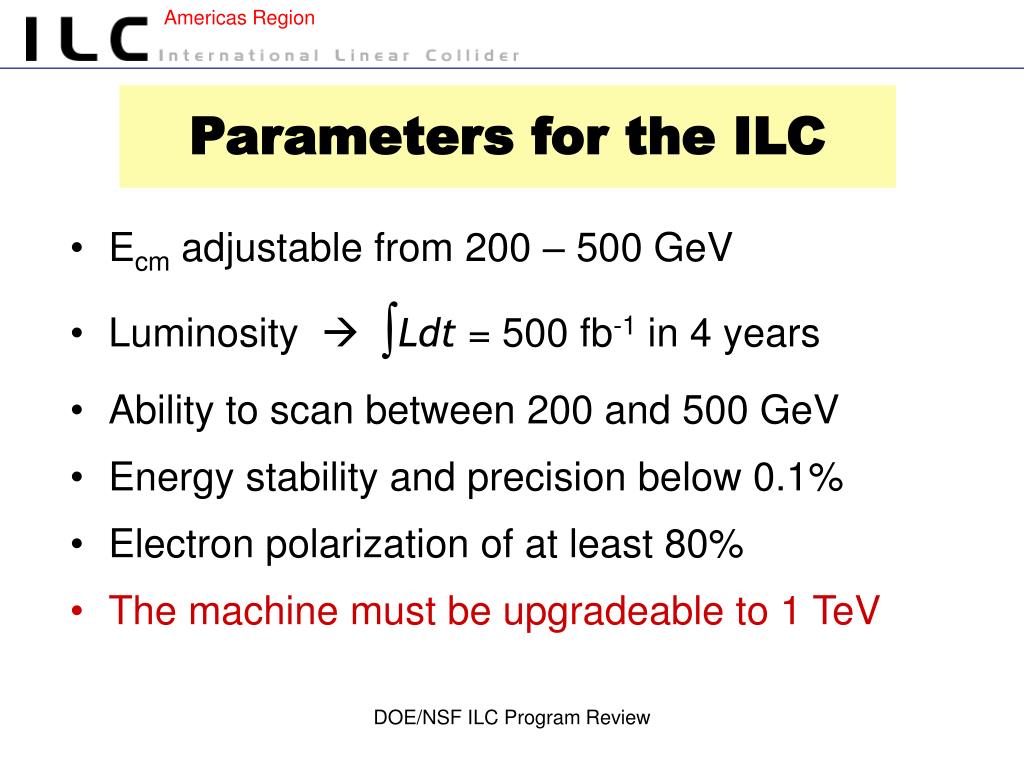

  7. Parameters for the ILC • Ecm adjustable from 200 – 500 GeV • Luminosity ∫Ldt = 500 fb-1 in 4 years • Ability to scan between 200 and 500 GeV • Energy stability and precision below 0.1% • Electron polarization of at least 80% • The machine must be upgradeable to 1 TeV DOE/NSF ILC Program Review

  8. Scope of the 500 GeV machine • Main linacs length ~ 21 km, 16,000 RF cavities (total) • RF power ~ 640 10-MW klystrons and modulators (total) • Cryoplants ~ 11 plants, cooling power 24 kW (@4K) each • Beam delivery length ~ 5 km, ~ 500 magnets (per IR) • Damping ring circumference ~ 6.6 km, ~400 magnets (each) • Beam power ~ 22 MW total • Site power ~ 200 MW total • Site footprint length ~ 47 km (for option to future upgrade to 1 TeV) • Bunch profile at IP ~ 500 x 6 nm, 300 microns long DOE/NSF ILC Program Review

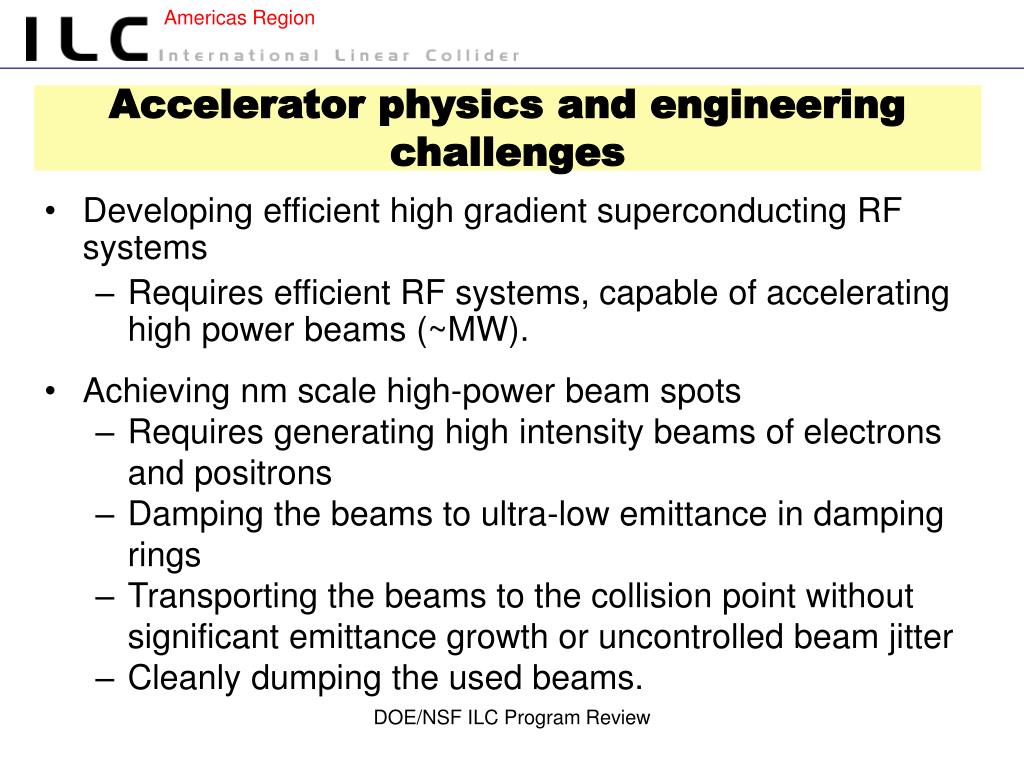

  9. Accelerator physics and engineering challenges • Developing efficient high gradient superconducting RF systems • Requires efficient RF systems, capable of accelerating high power beams (~MW). • Achieving nm scale high-power beam spots • Requires generating high intensity beams of electrons and positrons • Damping the beams to ultra-low emittance in damping rings • Transporting the beams to the collision point without significant emittance growth or uncontrolled beam jitter • Cleanly dumping the used beams. DOE/NSF ILC Program Review

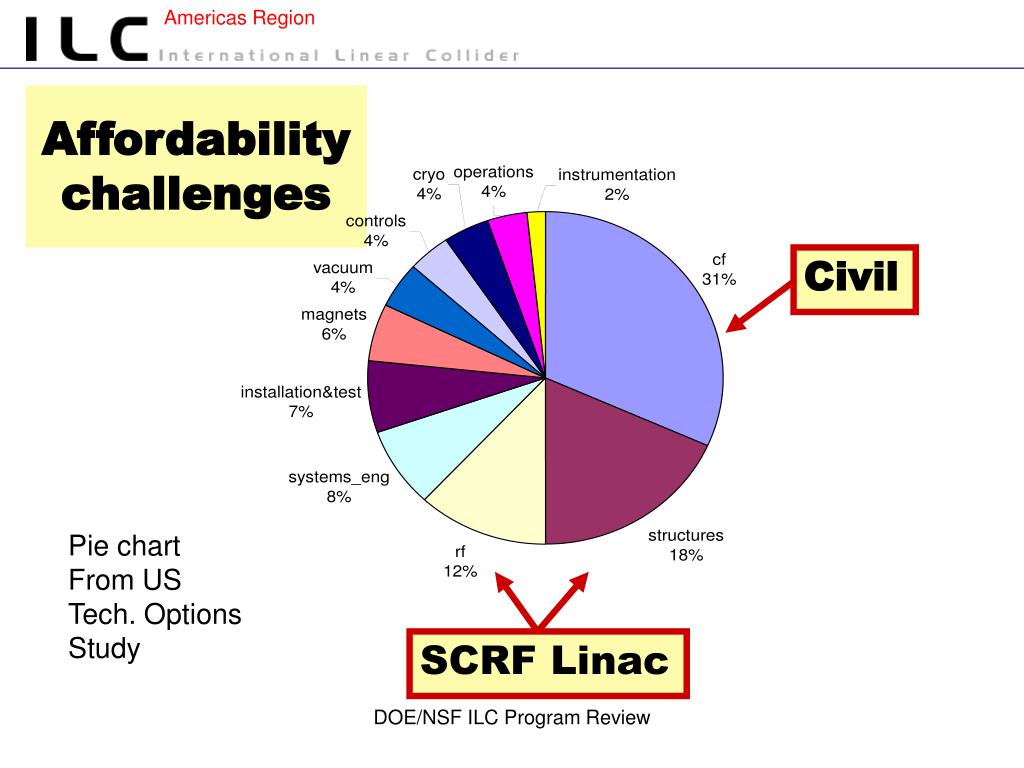

  10. Affordability challenges Civil Pie chart From US Tech. Options Study SCRF Linac DOE/NSF ILC Program Review

  11. ILC Baseline configuration Document (BCD) • – A baseline configuration for the ILC machine, with a conceptual layout, and beam parameters, was defined at end of 2005. • The baseline made forward looking choices, consistent with attaining performance goals. The choices were understood well enough to do a conceptual design and reliable costing by end of 2006. • “Alternate” configurations were established, which may have cost and or performance benefits, but which need further R&D for validation. • - The baseline is under “configuration control,”with a defined process for changes to the baseline. DOE/NSF ILC Program Review

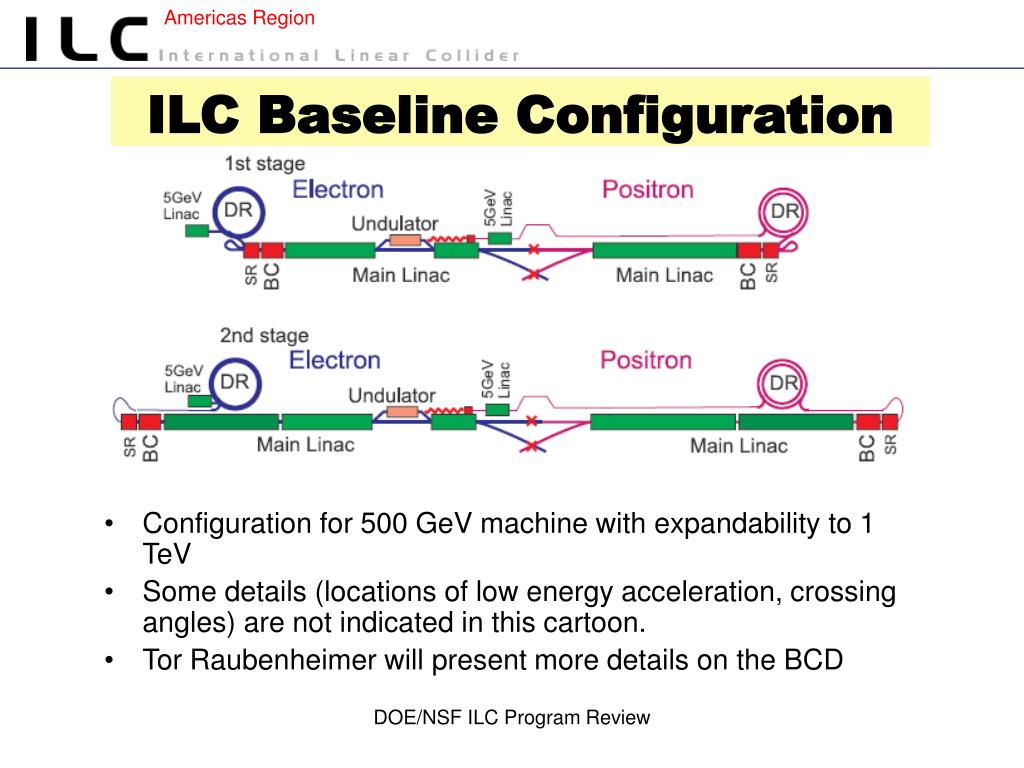

  12. ILC Baseline Configuration • Configuration for 500 GeV machine with expandability to 1 TeV • Some details (locations of low energy acceleration, crossing angles) are not indicated in this cartoon. • Tor Raubenheimer will present more details on the BCD DOE/NSF ILC Program Review

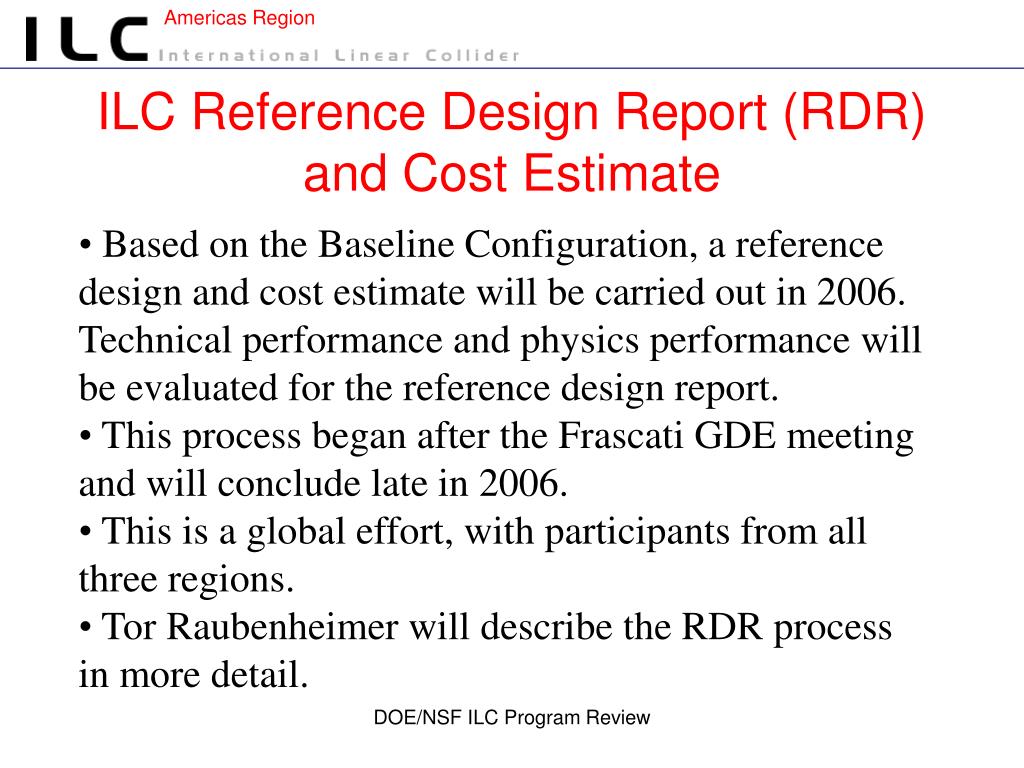

  13. ILC Reference Design Report (RDR) and Cost Estimate • Based on the Baseline Configuration, a reference design and cost estimate will be carried out in 2006. Technical performance and physics performance will be evaluated for the reference design report. • This process began after the Frascati GDE meeting and will conclude late in 2006. • This is a global effort, with participants from all three regions. • Tor Raubenheimer will describe the RDR process in more detail. DOE/NSF ILC Program Review

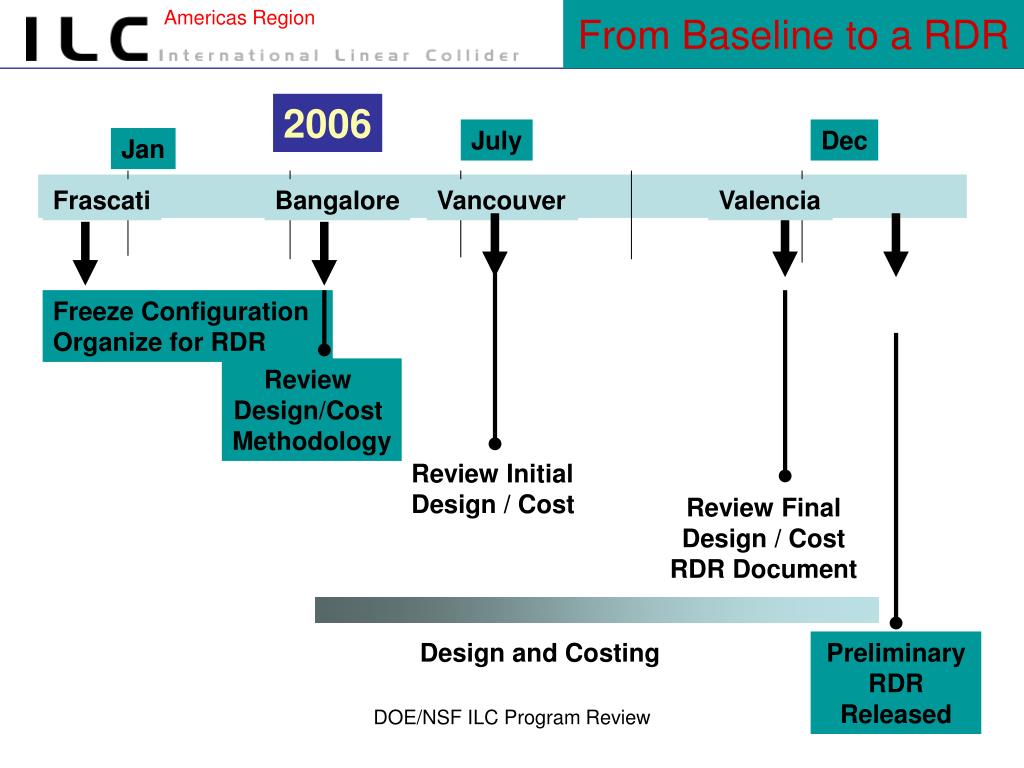

  14. From Baseline to a RDR 2006 July Dec Jan Frascati Bangalore Vancouver Valencia Freeze Configuration Organize for RDR Review Design/Cost Methodology Review Initial Design / Cost Review Final Design / Cost RDR Document Design and Costing Preliminary RDR Released DOE/NSF ILC Program Review

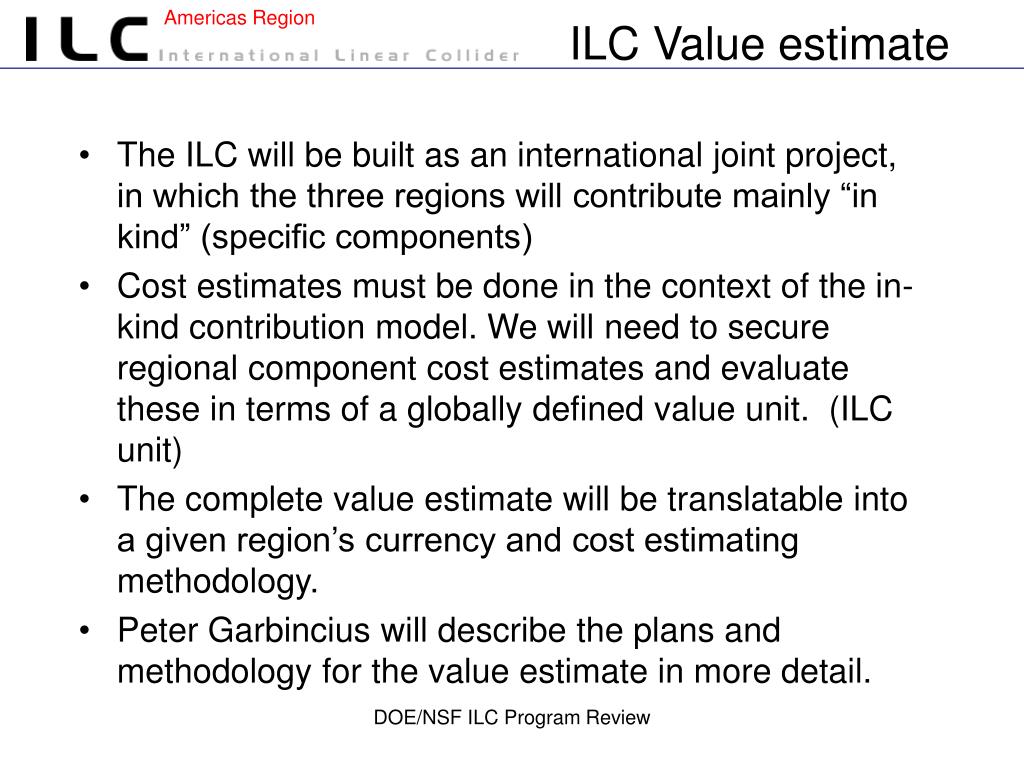

  15. ILC Value estimate • The ILC will be built as an international joint project, in which the three regions will contribute mainly “in kind” (specific components) • Cost estimates must be done in the context of the in-kind contribution model. We will need to secure regional component cost estimates and evaluate these in terms of a globally defined value unit. (ILC unit) • The complete value estimate will be translatable into a given region’s currency and cost estimating methodology. • Peter Garbincius will describe the plans and methodology for the value estimate in more detail. DOE/NSF ILC Program Review

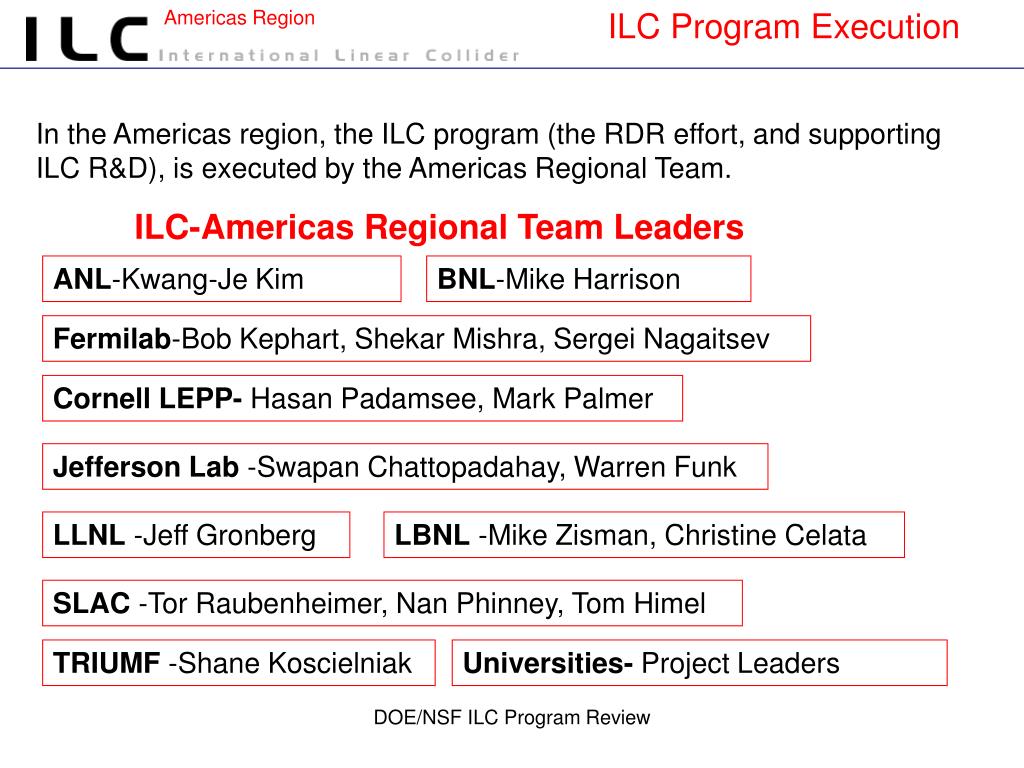

  16. ILC Program Execution In the Americas region, the ILC program (the RDR effort, and supporting ILC R&D), is executed by the Americas Regional Team. ILC-Americas Regional Team Leaders ANL-Kwang-Je Kim BNL-Mike Harrison Fermilab-Bob Kephart, Shekar Mishra, Sergei Nagaitsev CornellLEPP- Hasan Padamsee, Mark Palmer JeffersonLab -Swapan Chattopadahay, Warren Funk LLNL -Jeff Gronberg LBNL -Mike Zisman, Christine Celata SLAC -Tor Raubenheimer, Nan Phinney, Tom Himel TRIUMF -Shane Koscielniak Universities- Project Leaders DOE/NSF ILC Program Review

  17. Organization of the ILC-Americas Program • The work is broken down into a series of technically-based work packages. • GDE and each DoE lab sign MoU’s detailing the co-operative arrangement for the execution of work packages at each lab. • Yearly scope of work is spelled out in Addenda to the MoU, which detail the work packages. • For university R&D work, each university project is a work package. • Labs report financial status at the work package level quarterly, and technical status semi-annually. (Actuals not yet available for FY06 for all work packages. Some actuals will be covered in presentations) • About 100 work packages for FY06 are organized into a WBS. • The list of work packages, and associated resources, as well as the MOU Addenda, are posted on the ILC-Americas web site: https://wiki.lepp.cornell.edu/ilc/bin/view/Public/Americas/WebHome DOE/NSF ILC Program Review

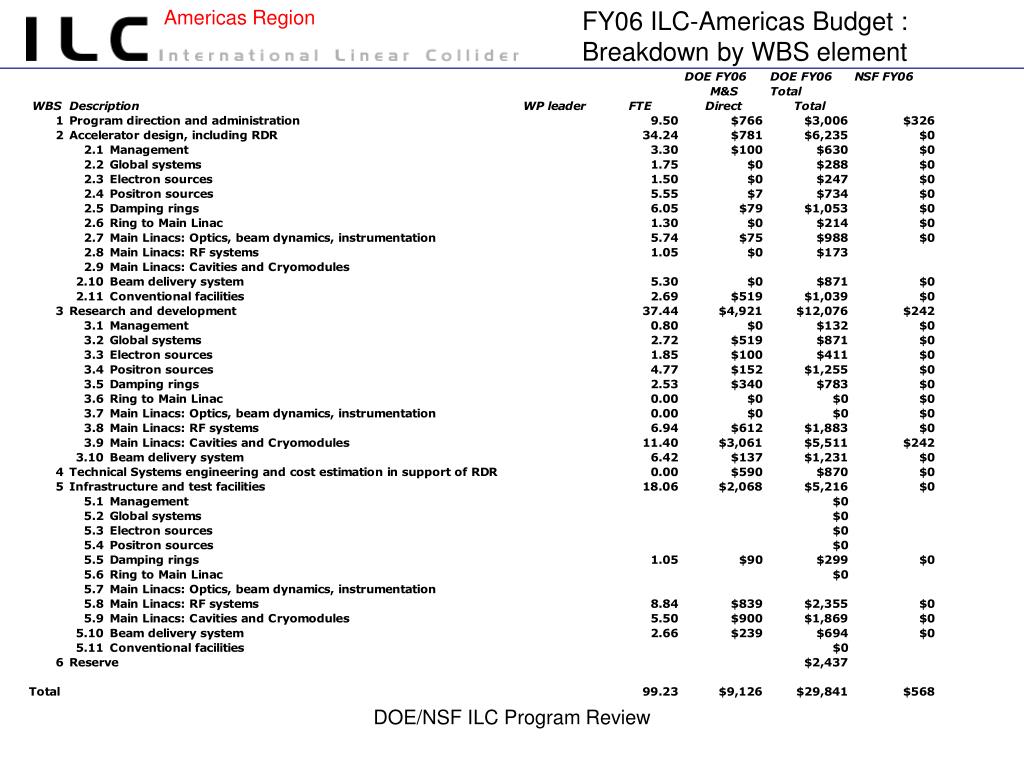

  18. FY06 ILC-Americas Budget : Breakdown by WBS element DOE/NSF ILC Program Review

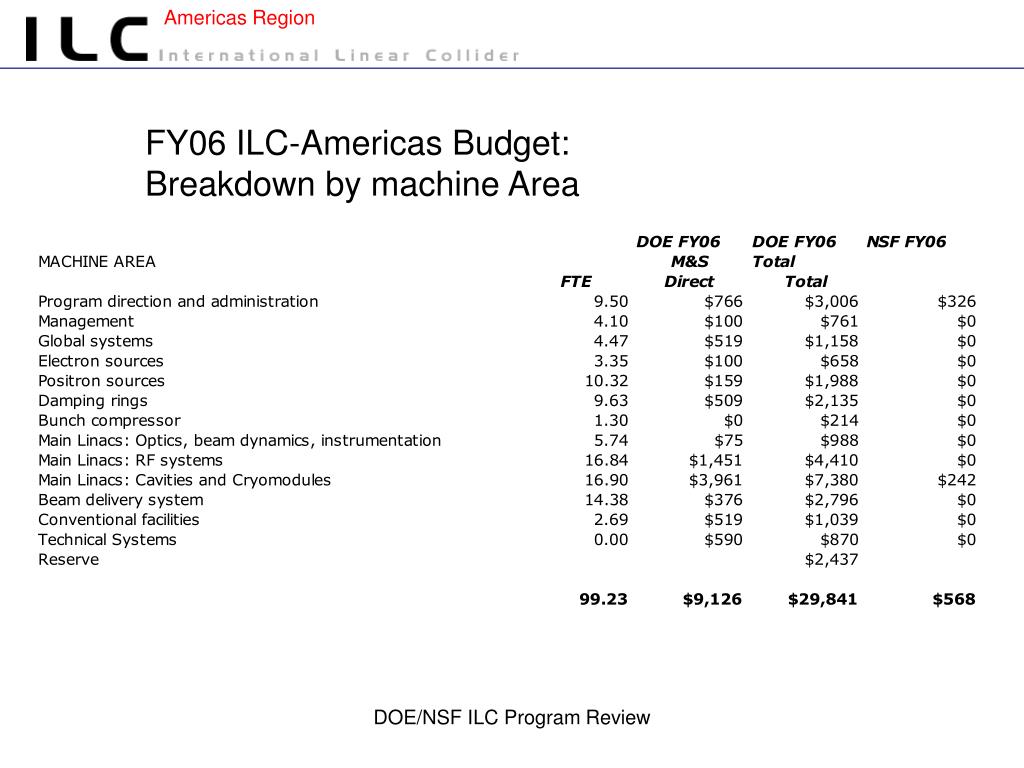

  19. FY06 ILC-Americas Budget: Breakdown by machine Area DOE/NSF ILC Program Review

  20. FY06 lab budgets FY06 ILC-Americas Budget: Breakdown by Laboratory Most labs are also putting additional funds into ILC R&D. For example, Fermilab is devoting an additional ~$12 M to developing SCRF infrastructure.

  21. ILC-Americas University FY05 R&D Program • SCRF materials and surface preparation: Wisconsin ($64K), Northwestern($40K), Old Dominion ($58K) • RF power sources: Yale ($60K), MIT($30K) • Polarized electron source: Wisconsin ($35K) • Polarized positron source: Tennessee ($40K), Princeton • Damping rings: Illinois ($17K), Cornell ($75K, $46K) [NSF] • Instrumentation, diagnostics: Berkeley ($35K), Cornell ($24K) [NSF] • Mover systems: Colorado State ($49K) [NSF] • Radiation hard electronics: UC Davis ($38K), Ohio State ($75K) • Ground motion: Northwestern ($28K) • Linac beam dynamics design-Cornell ($21K) • High-gradient SCRF R&D- Cornell ($140K) [DOE] DOE/NSF ILC Program Review

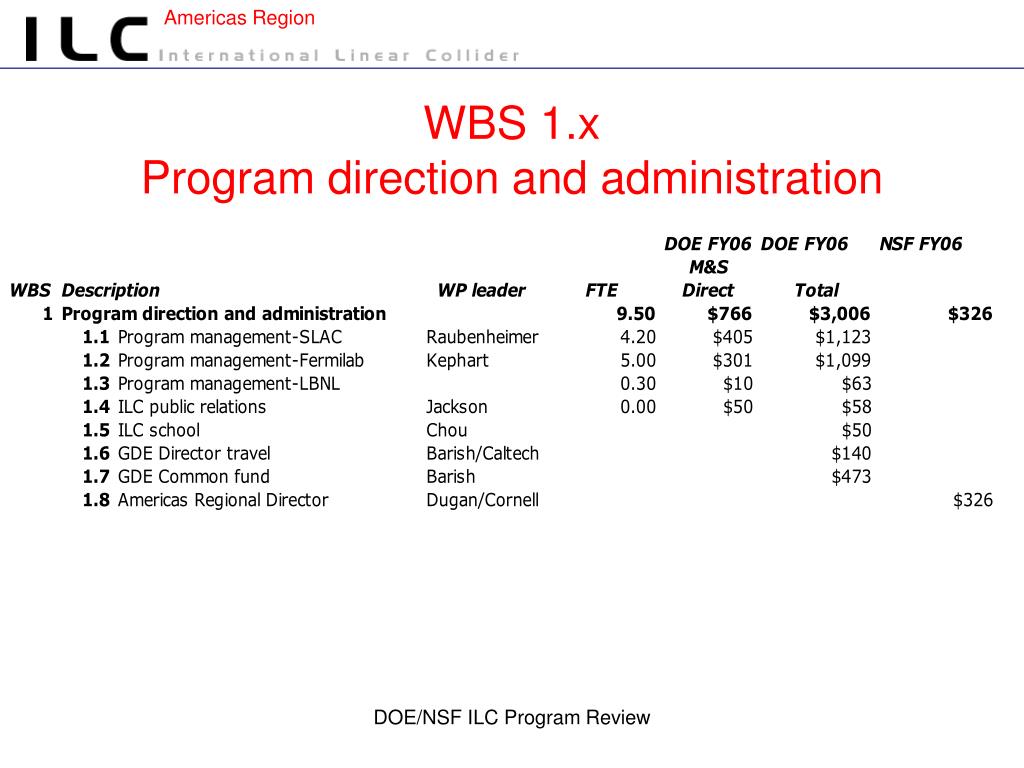

  22. WBS 1.xProgram direction and administration DOE/NSF ILC Program Review

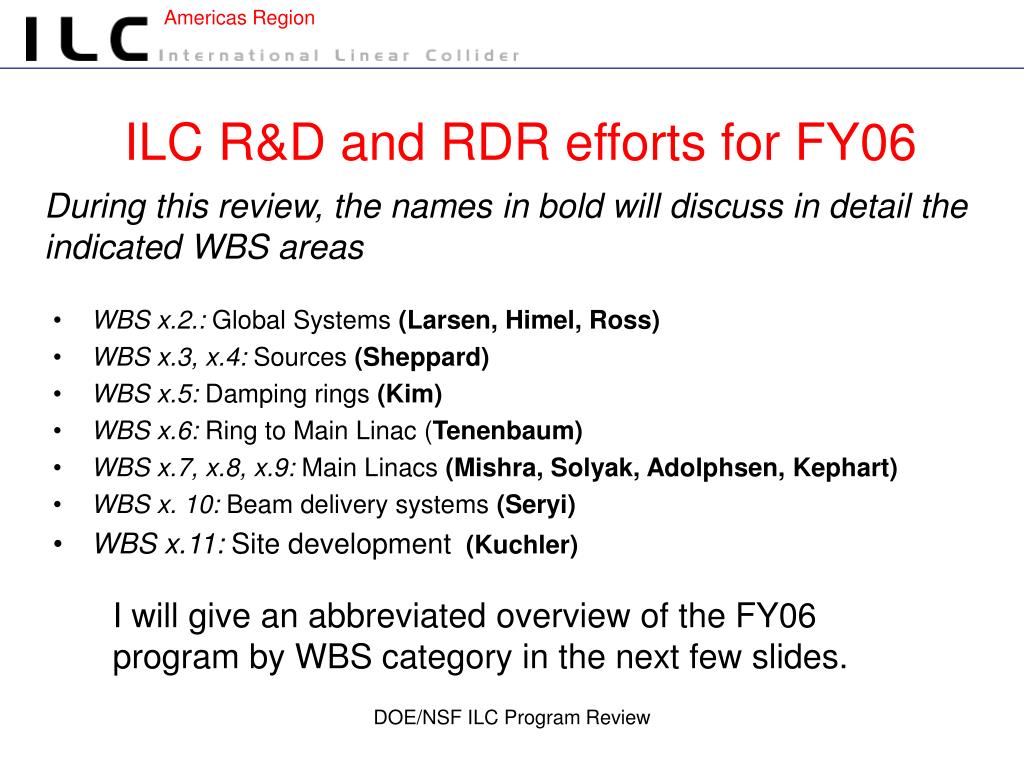

  23. ILC R&D and RDR efforts for FY06 During this review, the names in bold will discuss in detail the indicated WBS areas • WBS x.2.: Global Systems (Larsen, Himel, Ross) • WBS x.3, x.4: Sources (Sheppard) • WBS x.5: Damping rings (Kim) • WBS x.6: Ring to Main Linac (Tenenbaum) • WBS x.7, x.8, x.9: Main Linacs (Mishra, Solyak, Adolphsen, Kephart) • WBS x. 10: Beam delivery systems (Seryi) • WBS x.11: Site development (Kuchler) I will give an abbreviated overview of the FY06 program by WBS category in the next few slides. DOE/NSF ILC Program Review

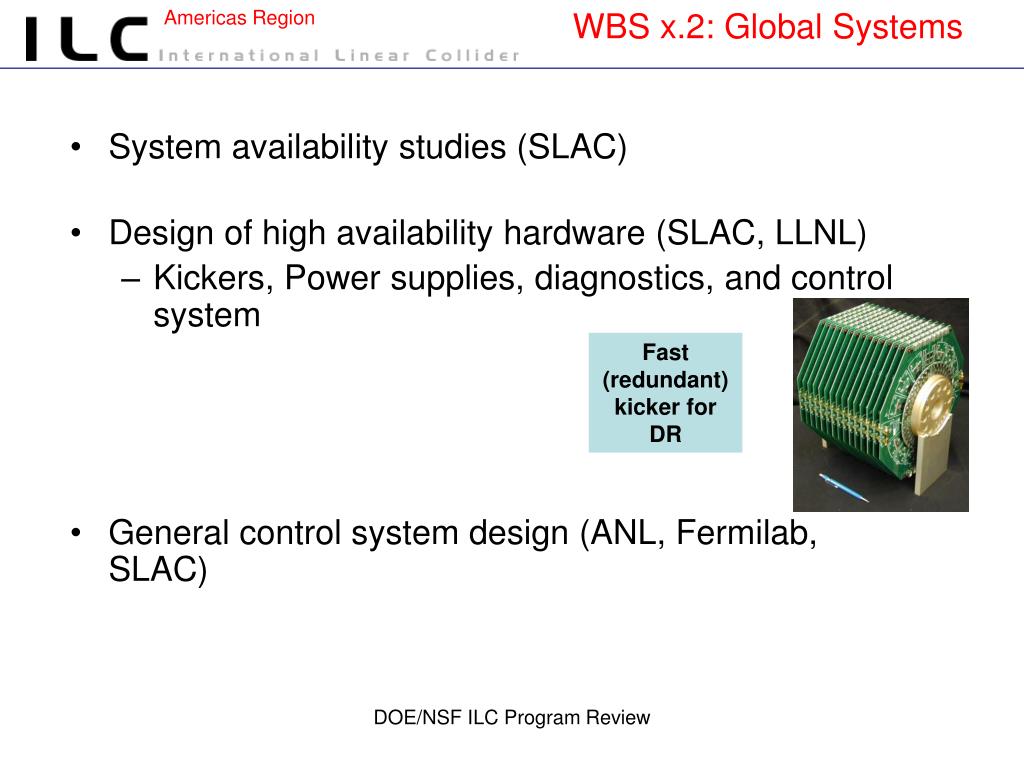

  24. WBS x.2: Global Systems • System availability studies (SLAC) • Design of high availability hardware (SLAC, LLNL) • Kickers, Power supplies, diagnostics, and control system • General control system design (ANL, Fermilab, SLAC) Fast (redundant) kicker for DR DOE/NSF ILC Program Review

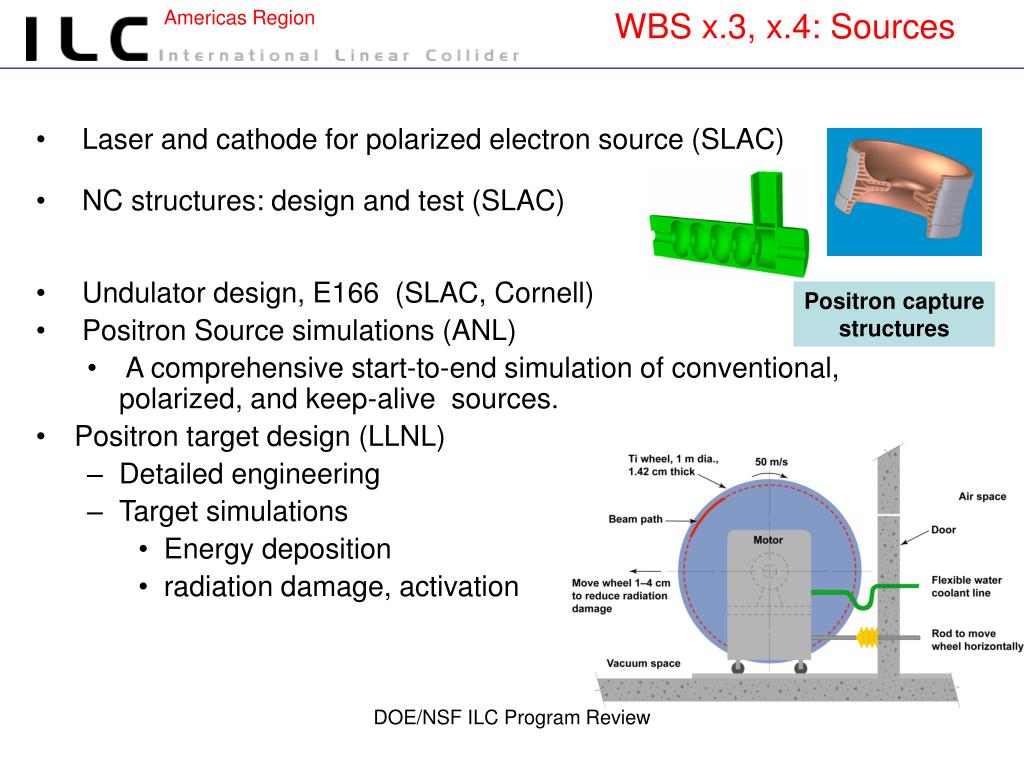

  25. WBS x.3, x.4: Sources • Laser and cathode for polarized electron source (SLAC) • NC structures: design and test (SLAC) • Undulator design, E166 (SLAC, Cornell) • Positron Source simulations (ANL) • A comprehensive start-to-end simulation of conventional, polarized, and keep-alive sources. • Positron target design (LLNL) • Detailed engineering • Target simulations • Energy deposition • radiation damage, activation Positron capturestructures DOE/NSF ILC Program Review

  26. WBS x.5: Damping rings • Damping ring component optimization: wigglers, fast kickers; s of the use of CESR as an ILC positron damping ring test facility (in 2008) (Cornell) • Damping Ring Design and Optimization (ANL) • Lattice design and optimization; particle tracking for single-bunch instabilities with 3-D wakefield; studies of ion instability in the APS ring; design of a hybrid wiggler satisfying the field quality tolerance • SEY studies in PEP-II (SLAC) • ATF damping ring experiments (SLAC, LBNL, Cornell) • Lattice designs for damping rings and injection/extraction lines; characterization of some collective effects, including space-charge, IBS and microwave instability; physics design of stripline kickers for single-bunch extraction at KEK-ATF (LBNL) DOE/NSF ILC Program Review

  27. WBS x.6, x.7: RTML and Main Linac Optics, beam dynamics, instrumentation • RTML design (SLAC, Cornell) • Main linac optics design (SLAC, Fermilab) • Low emittance transport simulations and BBA design (SLAC, Fermilab, Cornell) • Wakefield calculations (SLAC) • Linac beamline Instrumentation (SLAC) TTF HOM Signal800 monitors installed RF BPM for linac DOE/NSF ILC Program Review

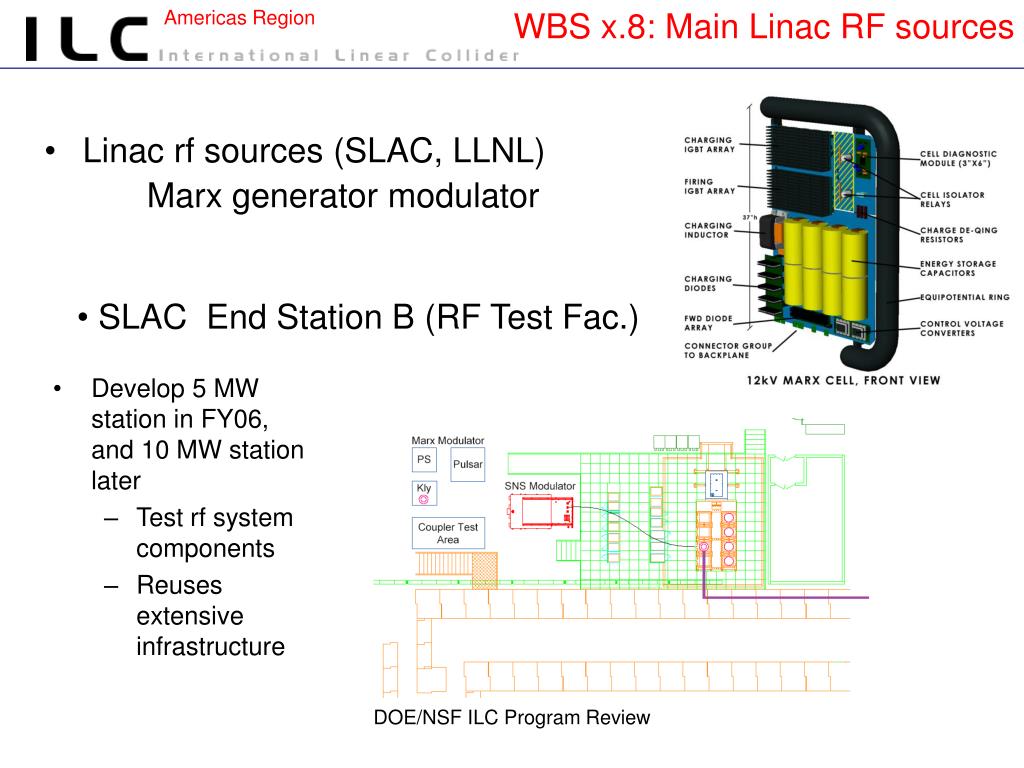

  28. WBS x.8: Main Linac RF sources SLAC End Station B (RF Test Fac.) • Linac rf sources (SLAC, LLNL) Marx generator modulator • Develop 5 MW station in FY06, and 10 MW station later • Test rf system components • Reuses extensive infrastructure DOE/NSF ILC Program Review

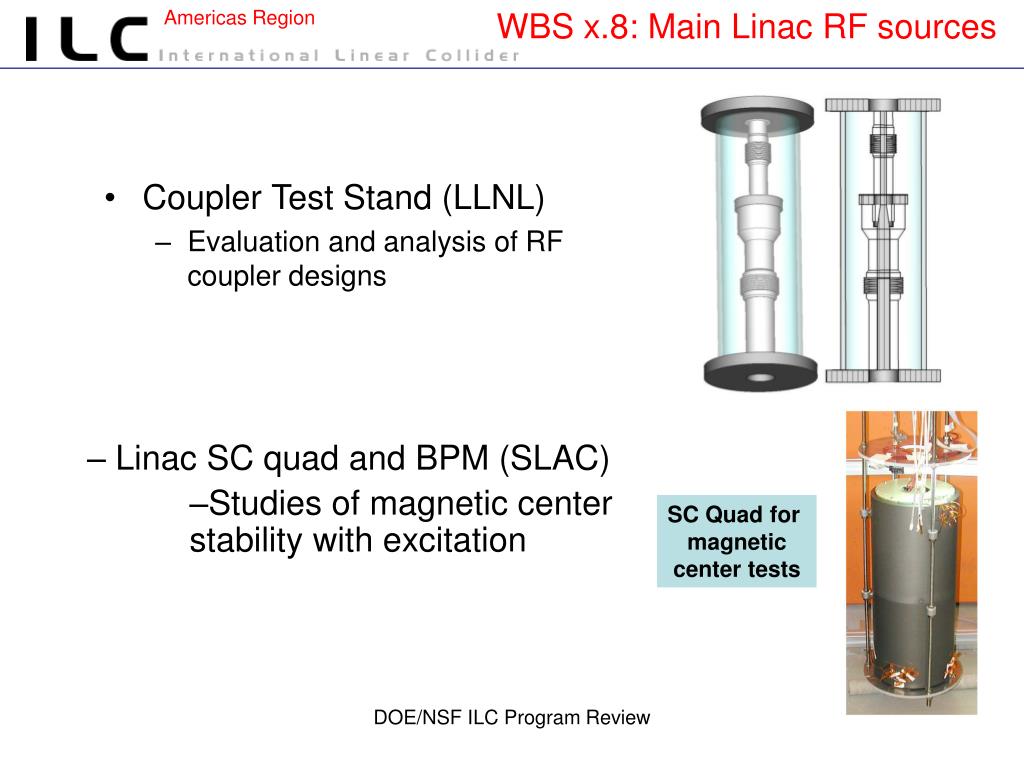

  29. WBS x.8: Main Linac RF sources • Coupler Test Stand (LLNL) • Evaluation and analysis of RF coupler designs • Linac SC quad and BPM (SLAC) • Studies of magnetic center stability with excitation SC Quad for magnetic center tests DOE/NSF ILC Program Review

  30. WBS x.8: Cavities and Cryomodules ILC Cavities and test facilities Bead pull RF Testing @ FNAL • Industrial fabrication of cavities (12 cavities in FY06) (FNAL) • BCP and vertical testing (FNAL, Cornell) • EP process development and vertical testing (FNAL, Jlab). • Joint BCP/EP facility being developed at ANL (late 06) • Horizontal test facility @ FNAL (ILCTA-MDB) (complete Fall 06) • Vertical test facility under development @ FNAL (ILCTA-IB1) (complete 07) • Single/large grain Crystal cavity development (FNAL,Jlab). Joint ANL/FNAL BCP/EP Facility DOE/NSF ILC Program Review

  31. WBS x.8: Cavities and Cryomodules Cryomodule assembly and test infrastructure at Fermilab PPD Machine shop (MAB) Meson Detector Building (MDB) ILCTA-MDB Cryogenics Installation 60 W @ 1.8 K TD MP9 Cryomodule Assembly Facility (CAF) First 1.3 GHz TESLA Cavity in MDB Cold and RF power in Dec AD Cryo Dept. DOE/NSF ILC Program Review

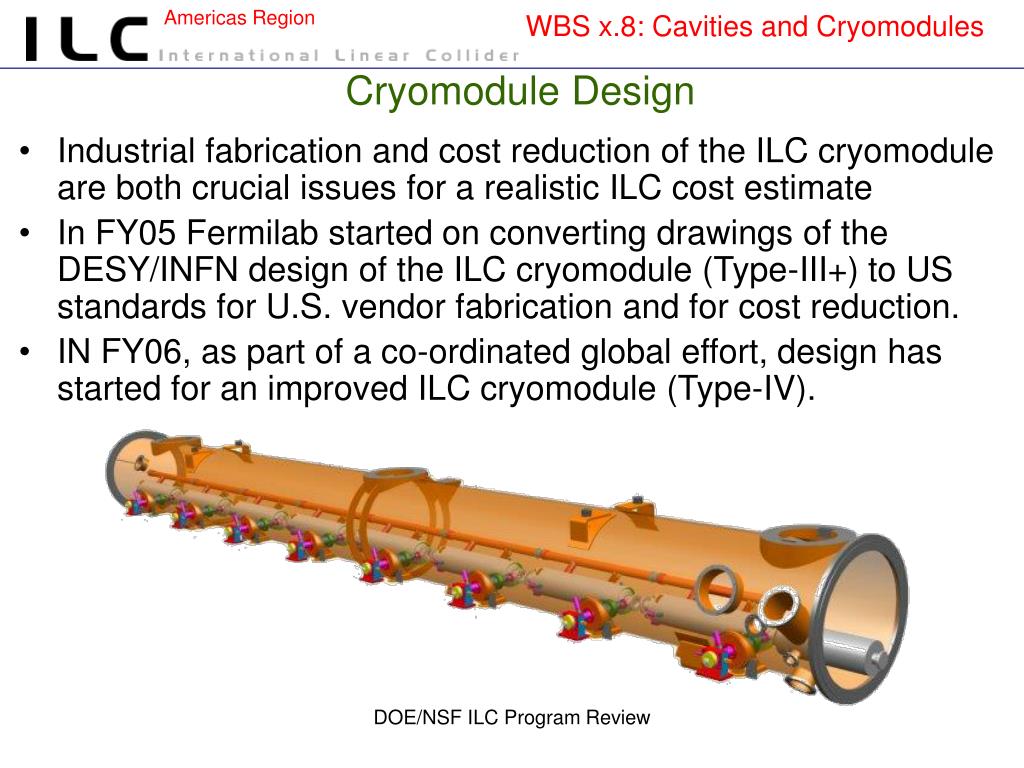

  32. WBS x.8: Cavities and Cryomodules Cryomodule Design • Industrial fabrication and cost reduction of the ILC cryomodule are both crucial issues for a realistic ILC cost estimate • In FY05 Fermilab started on converting drawings of the DESY/INFN design of the ILC cryomodule (Type-III+) to US standards for U.S. vendor fabrication and for cost reduction. • IN FY06, as part of a co-ordinated global effort, design has started for an improved ILC cryomodule (Type-IV). DOE/NSF ILC Program Review

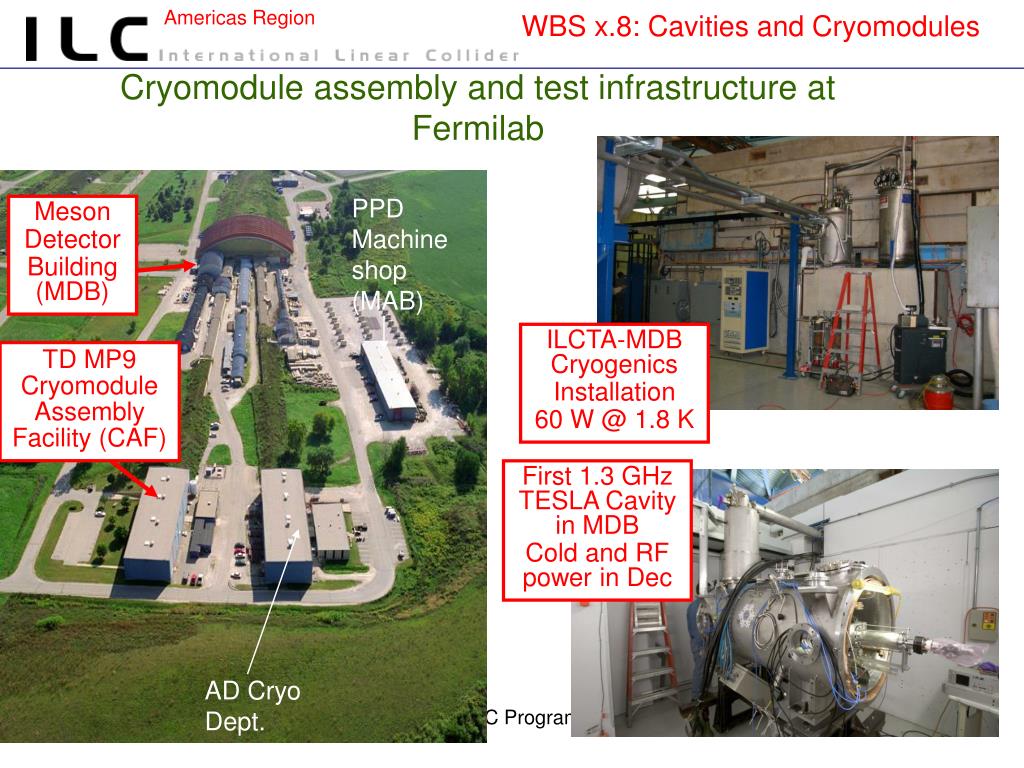

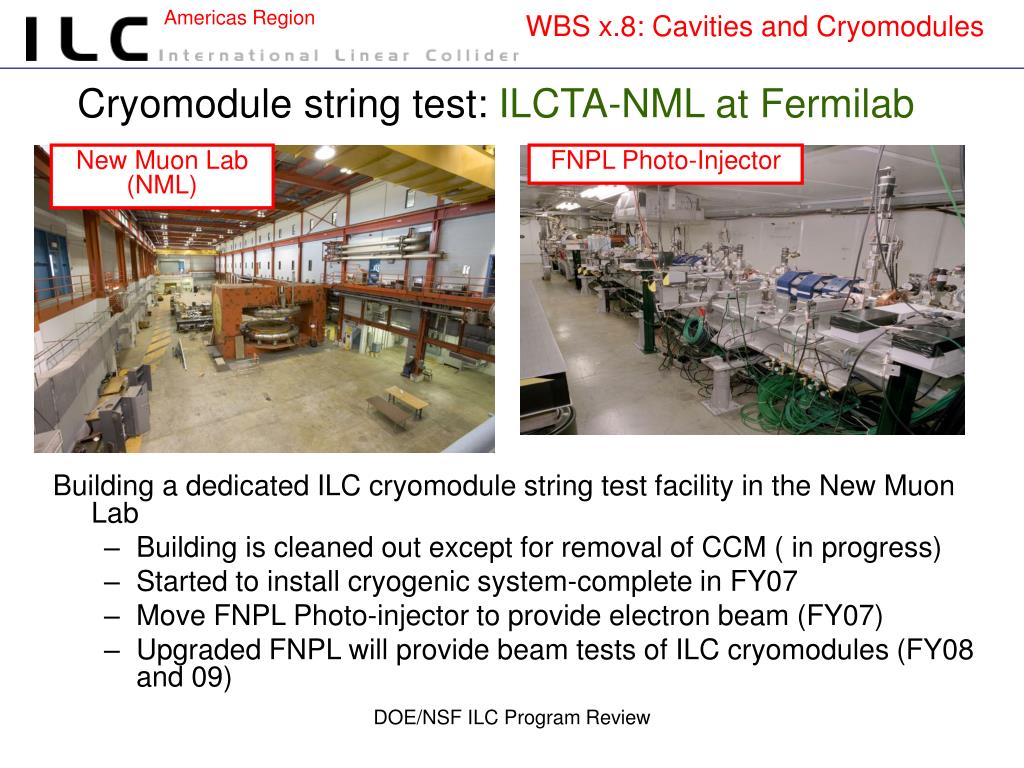

  33. WBS x.8: Cavities and Cryomodules Cryomodule string test: ILCTA-NML at Fermilab New Muon Lab (NML) FNPL Photo-Injector Building a dedicated ILC cryomodule string test facility in the New Muon Lab • Building is cleaned out except for removal of CCM ( in progress) • Started to install cryogenic system-complete in FY07 • Move FNPL Photo-injector to provide electron beam (FY07) • Upgraded FNPL will provide beam tests of ILC cryomodules (FY08 and 09) DOE/NSF ILC Program Review

  34. WBS x.8: Cavities and Cryomodules Fabricate, process and test cavities from large-grain/single-crystal material (JLab) • Objectives: • Several single cell and at least one multi-cell cavity made from large grain/single crystal niobium • Improved BCP system for producing very smooth rf surfaces on large grain/single crystal material • Test cavity for superconducting rf joint investigations • Optimization studies of superstructure configuration based on superconducting joint • Two cavities suitable to be combined into a superstructure • Engineering package for the completion of a superstructure assembly ready for cold tests DOE/NSF ILC Program Review

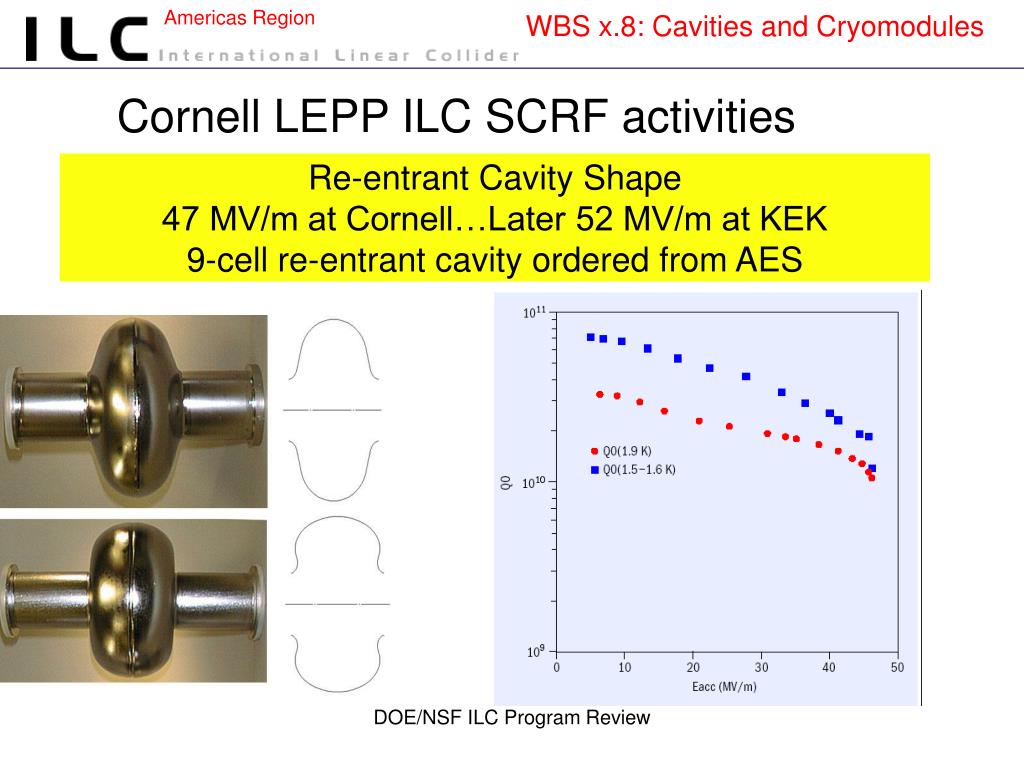

  35. WBS x.8: Cavities and Cryomodules Cornell LEPP ILC SCRF activities Re-entrant Cavity Shape47 MV/m at Cornell…Later 52 MV/m at KEK9-cell re-entrant cavity ordered from AES DOE/NSF ILC Program Review

  36. WBS x.10: Beam Delivery System • Beam delivery system design (SLAC) • ATF-2 (SLAC) • Construction of magnets, PS, and instrumentation • ESA MDI Test Facility (SLAC) ATF2 Optics ESA Energy Spectrometer - NanoBPM for ATF2 (LLNL) DOE/NSF ILC Program Review

  37. WBS x.10: Beam Delivery System ILC Final Focus Magnet Development (BNL) FY06 goals: Continue to support the baseline design efforts Support the development of the Conceptual Design/Cost Estimate for the Beam Delivery System Fabricate and test a short proof of principle shielded final-focus-like quadrupole coil Fabricate and test a short proof of principle sextupole/octupole corrector-like coil Winding tests, octupole coil - how small can you go ? Shielded quadrupole proof of principle coil fabrication

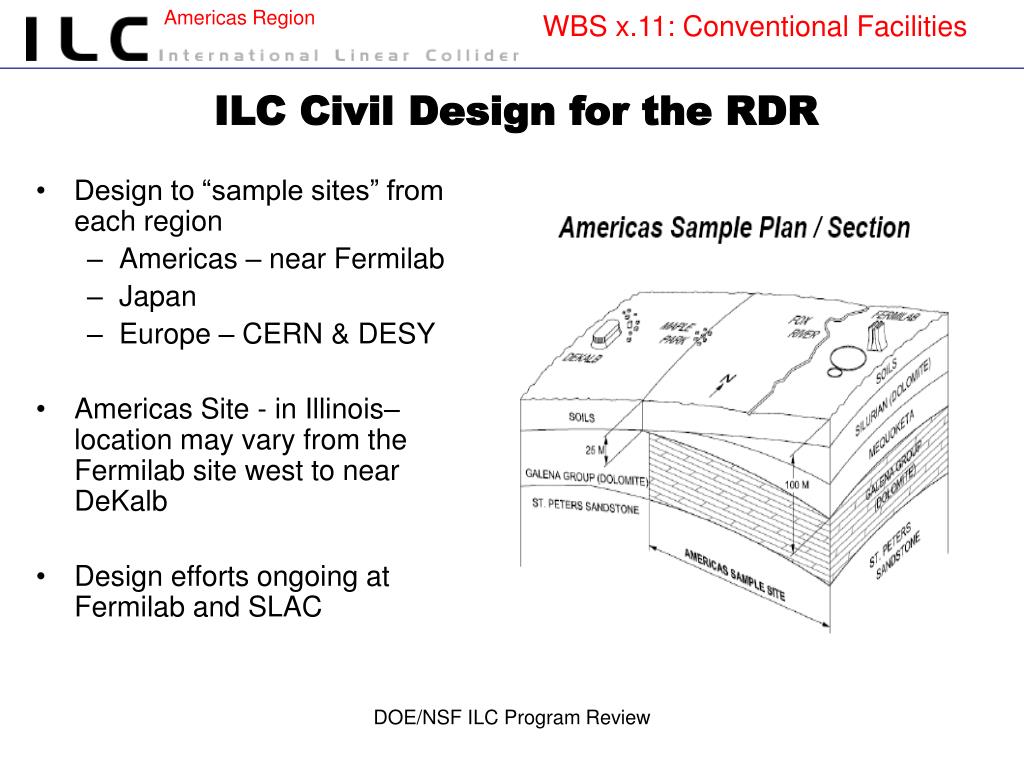

  38. WBS x.11: Conventional Facilities ILC Civil Design for the RDR • Design to “sample sites” from each region • Americas – near Fermilab • Japan • Europe – CERN & DESY • Americas Site - in Illinois– location may vary from the Fermilab site west to near DeKalb • Design efforts ongoing at Fermilab and SLAC DOE/NSF ILC Program Review

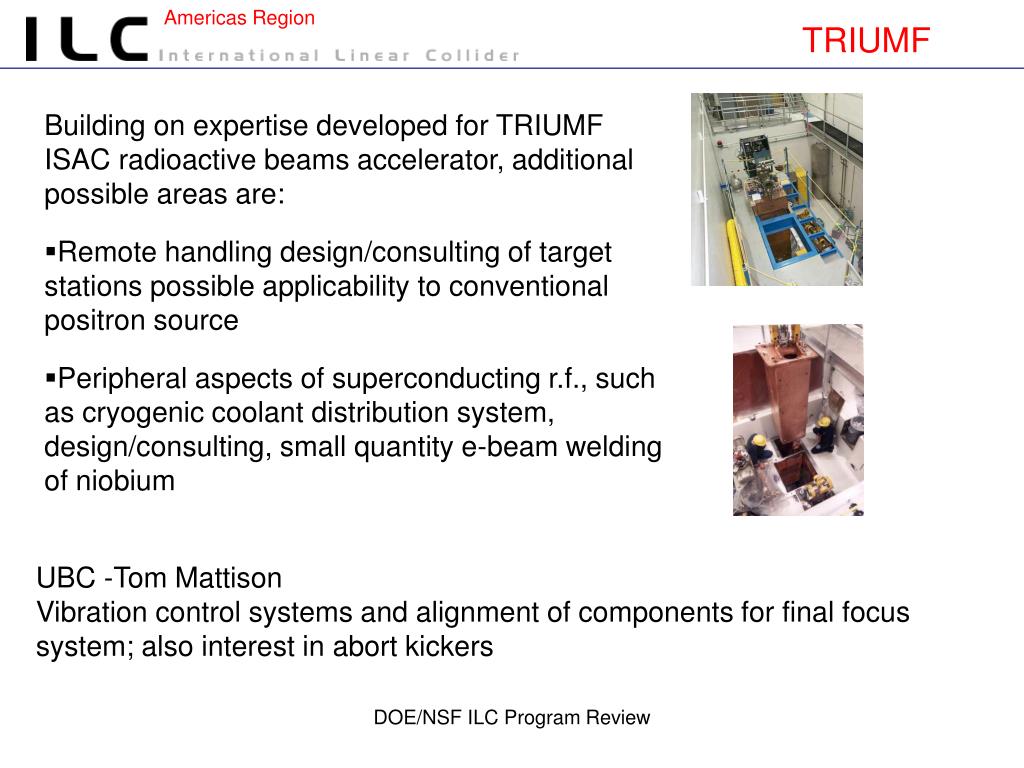

  39. TRIUMF Potential TRIUMF Accelerator R&D Resources for ILC The specific nature of Canadian involvement is under development. Some potential collaboration areas have been identified, along with relevant LHC experience: • The design of kicker magnets and the construction of associated pulse-forming networks and fast switches using power semiconductors • Precision room temperature magnet systems e.g. 52 twin-aperture quadrupoles built at Alstom Canada • Beam instrumentation and readout systems e.g. 2000 matched-pair 70MHz low pass filters e.g. VME64x compliant Digital Aquisition Board (DAB) • Contributions to beam dynamics & lattice calculations for damping rings.

  40. TRIUMF • Building on expertise developed for TRIUMF ISAC radioactive beams accelerator, additional possible areas are: • Remote handling design/consulting of target stations possible applicability to conventional positron source • Peripheral aspects of superconducting r.f., such as cryogenic coolant distribution system, design/consulting, small quantity e-beam welding of niobium UBC -Tom Mattison Vibration control systems and alignment of components for final focus system; also interest in abort kickers DOE/NSF ILC Program Review

  41. FY06 program concerns • Do we have sufficient resources available to complete the RDR and cost estimate? Some funds have been held in reserve to pay for additional help, but also we will need to divert some effort from R&D program. • Key R&D concerns: • Development of reliable high-yield processes for the production of high-gradient ILC cavities remains a critical item. Cavity fabrication and studies of processing are high priority parts of the program. • Thales klystron problems emphasize need to put more effort into klystron development. Difficult to do this before FY07. • Additional efforts are needed to co-ordinate Americas R&D program and to plan for the future, both within the region, and with programs in other regions. DOE/NSF ILC Program Review

  42. FY07 outlook • PB doubles ILC program budget to $60M (This includes ILC detector R&D at labs and universities) • However, the requested (“technically limited”) program exceeds the available funding. A process of prioritization will be required. • This process should look to GDE for guidance on priorities. Advice will be sought from GDE R&D Board for general ILC R&D efforts, and from Linear Collider Steering Group for the Americas (LCSGA) for region-specific Americas bid-to-host related activities. • First steps: document FY07 lab program requests (April 26); Regional team meeting to discuss FY07 requests and future plans (May 3-4, SLAC) DOE/NSF ILC Program Review

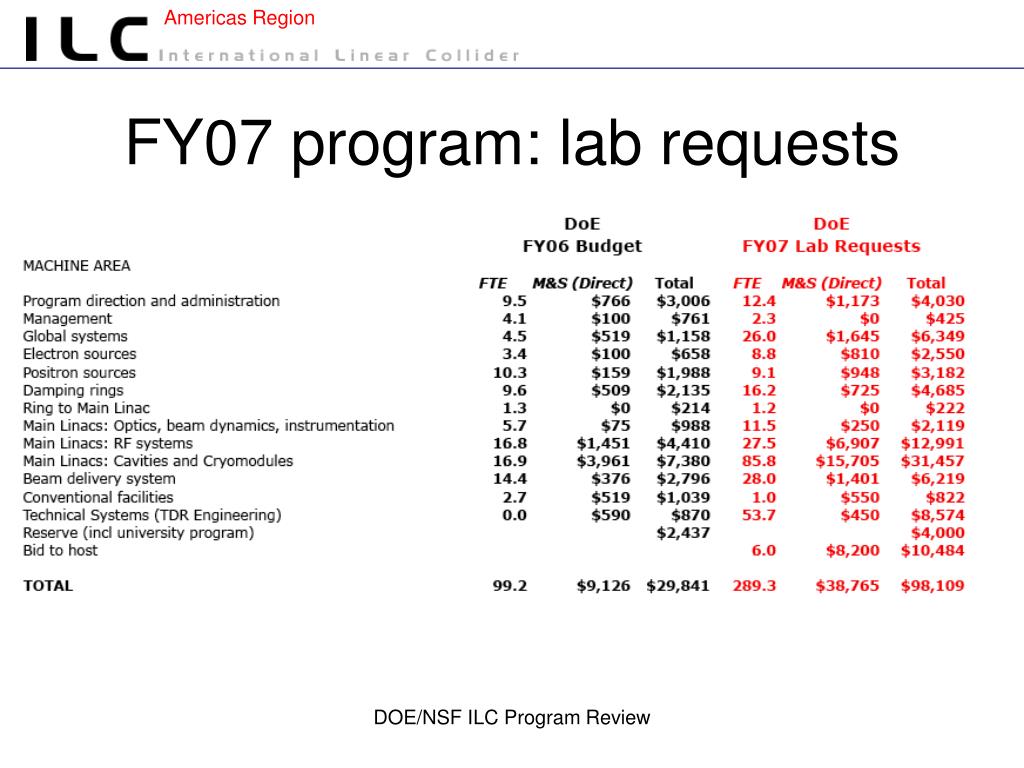

  43. FY07 program: lab requests DOE/NSF ILC Program Review

  44. FY07 ILC program request: details • TDR engineering efforts (~50 FTE) • Cavity and cryomodule work • RF system development • Sources, Damping rings, beam delivery • Global systems • Americas region bid to host DOE/NSF ILC Program Review

  45. FY07 Lab requests Cavities, cryomodules and test infrastructure • Fabricate (in industry) and process (at labs) 12 more ILC high-gradient cavities. • Continue R&D on large-grain and high-gradient cavities. • Continue R&D on EP processing, field emission/dark current issues, thin film systems. • Develop EP facility at ANL. • Horizontally test 10 cavities at Fermilab. • Build first US-built cryomodule and receive parts for 2nd cryomodule (to be built in FY08). • Complete design of Type IV (ILC-style) cryomodule. • Complete vertical test facility, and second horizontal test facility, at Fermilab (IB1). • Install cryogenic systems support for cryomodule tests in Fermilab’s ILCTA-NML. • Upgrade and move Fermilab photoinjector to ILCTA-NML. • Purchase 10 MW klystron and another bouncer modulator for ILCTA-NML at Fermilab DOE/NSF ILC Program Review

  46. FY07 Lab requests Linac RF systems • Continue development of Marx modulator, and evaluation of DTI and SNS modulators: downselect modulator choice by end of FY07. • Purchase two 10 MW klystrons from CPI and Toshiba. Contract with CPI to develop a high-efficiency 5 MW klystron. Fabricate two sheet-beam klystron prototypes, following SLAC design (split funding in FY07 and FY08). Goal is klystron choice by end of FY08. • Investigate cost reduction options for RF distribution system and couplers. • Continue development of LLRF systems DOE/NSF ILC Program Review

  47. FY07 Lab requests Sources • Electron source: develop improved photocathodes, more robust materials, laser system for polarized gun (using SLAC infrastructure), and investigate polarized RF guns. • Positron source: • Optics and system design; study image current heating of target in AMD field • Begin detailed design of undulators • Continue positron source simulations; construct prototype AMD • Both: Design and build 4.3 m NC traveling wave structure DOE/NSF ILC Program Review

  48. FY07 Lab requests Damping rings • Continue detailed development of ring design and simulations for the TDR • Pursue experimental and theoretical studies of electron cloud effects • Begin detailed calculations of other collective effects in the rings • Begin detailed engineering design of vacuum systems, feedback systems • Continue and refine designs of fast damping ring kickers and pulser systems • Conduct damping ring studies at ATF and ALS • Develop detailed plans for CESR conversion to a damping ring test facility DOE/NSF ILC Program Review

  49. FY07 Lab requests Optics and beam dynamics for RTML and Main Linac • Continue and expand tuning and BBA studies of LET. • Continue SC quad magnetic stability and alignment/vibration studies. • Continue wakefield calculations for candidate structures. Beam Delivery System • Continue detailed development of optics design, collimators, etc. • Continue magnet fabrication for ATF2. • Continue experimental program at ESA. • Begin 3 year program to prototype and test QD0 (IR FF quad) at BNL. • Begin engineering design of the FF region • Continue experimental vibration studies for FF quads. DOE/NSF ILC Program Review

  50. FY07 Lab requests Global systems • Continue development of high availability programs in power supplies, damping ring kicker systems, diagnostic processors. • Begin installation planning for TDR. Investigate new alignment techniques based on X-rays. • Controls and instrumentation: continue development of ATCA hardware platform. Plan timing/rf phase demonstration. • Diagnostics: develop laser system for laser wires, time resolved photon diagnostics; continue development of linac BPM system. DOE/NSF ILC Program Review
