An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. CMS schedule draft v33.1:surface

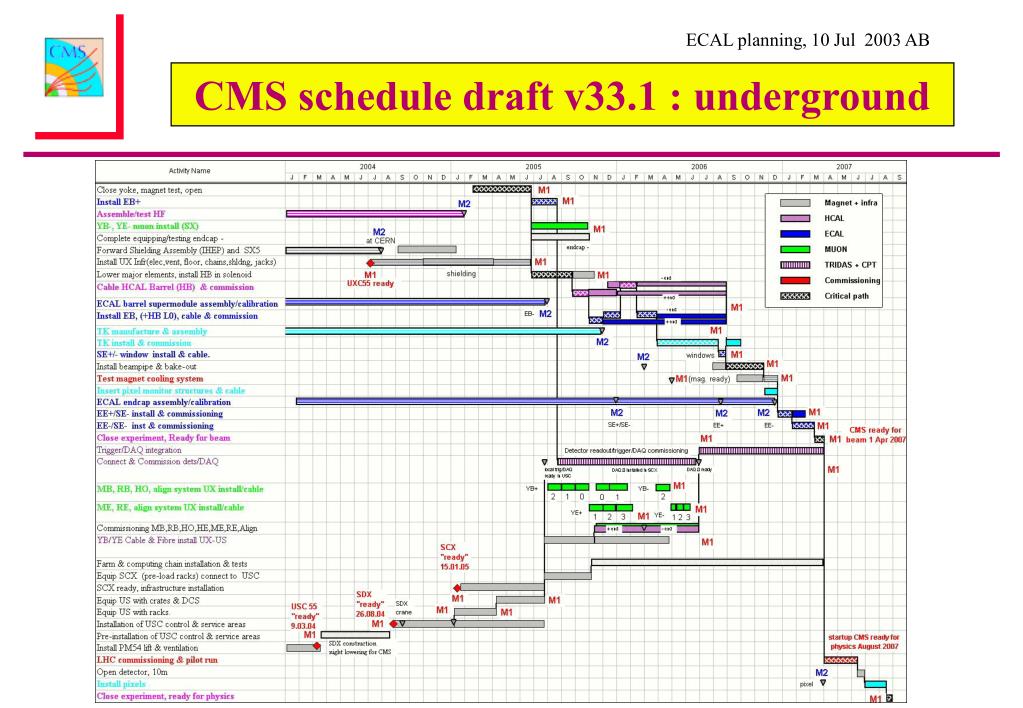

  2. CMS schedule draft v33.1 : underground

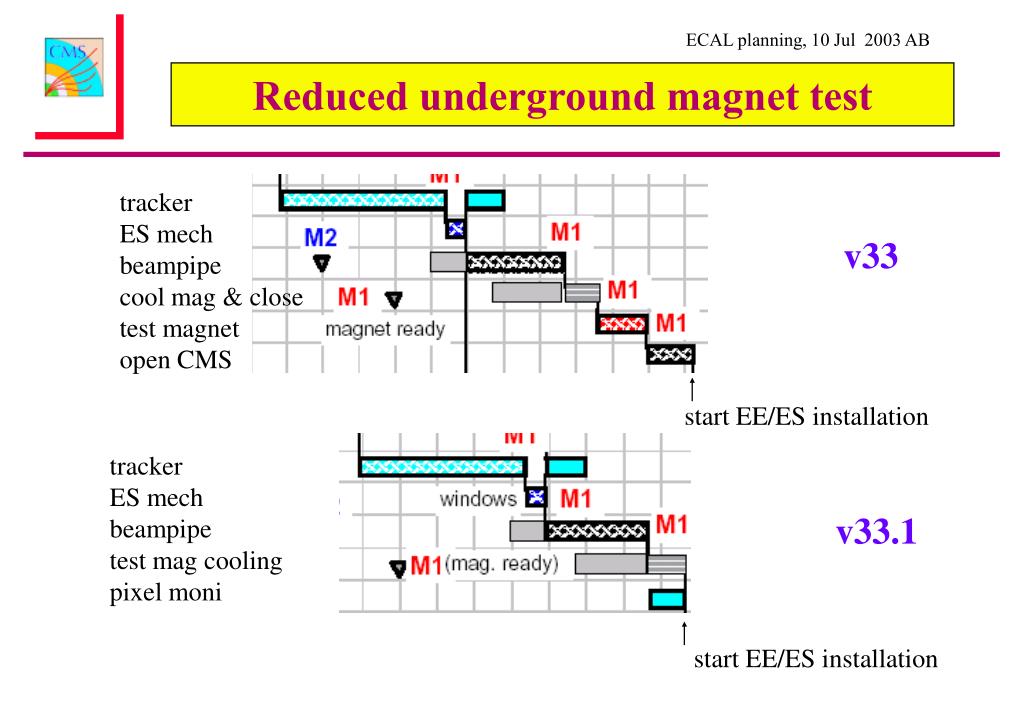

  3. Reduced underground magnet test tracker ES mech beampipe cool mag & close test magnet open CMS v33 start EE/ES installation tracker ES mech beampipe test mag cooling pixel moni v33.1 start EE/ES installation

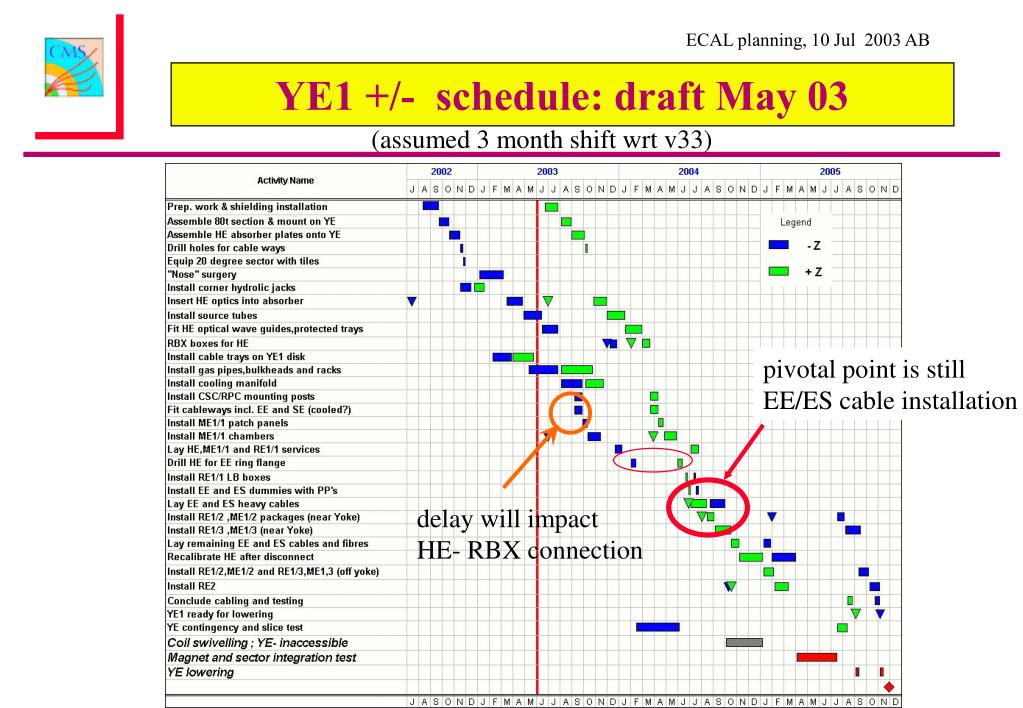

  4. YE1 +/- schedule: draft May 03 (assumed 3 month shift wrt v33) pivotal point is still EE/ES cable installation delay will impact HE- RBX connection

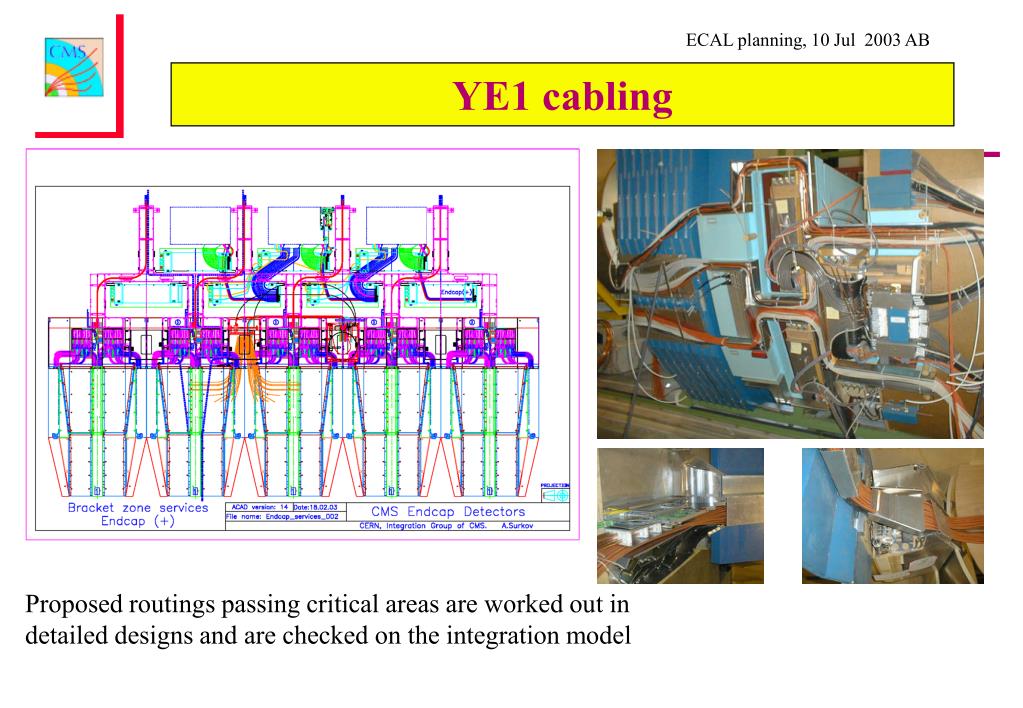

  5. YE1 cabling Proposed routings passing critical areas are worked out in detailed designs and are checked on the integration model

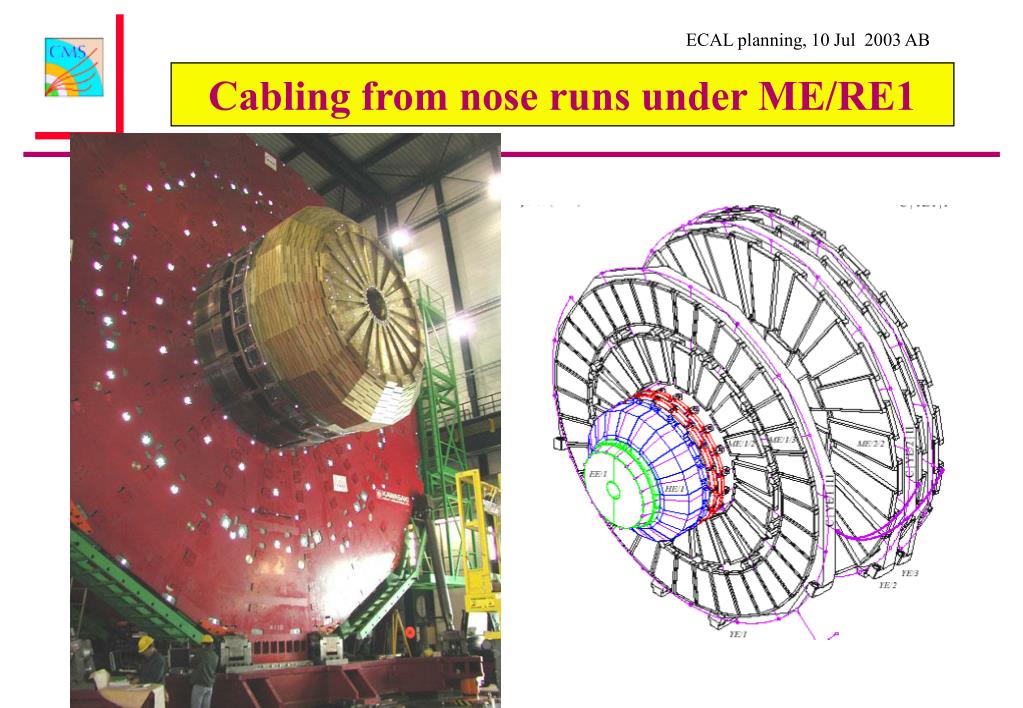

  6. Cabling from nose runs under ME/RE1

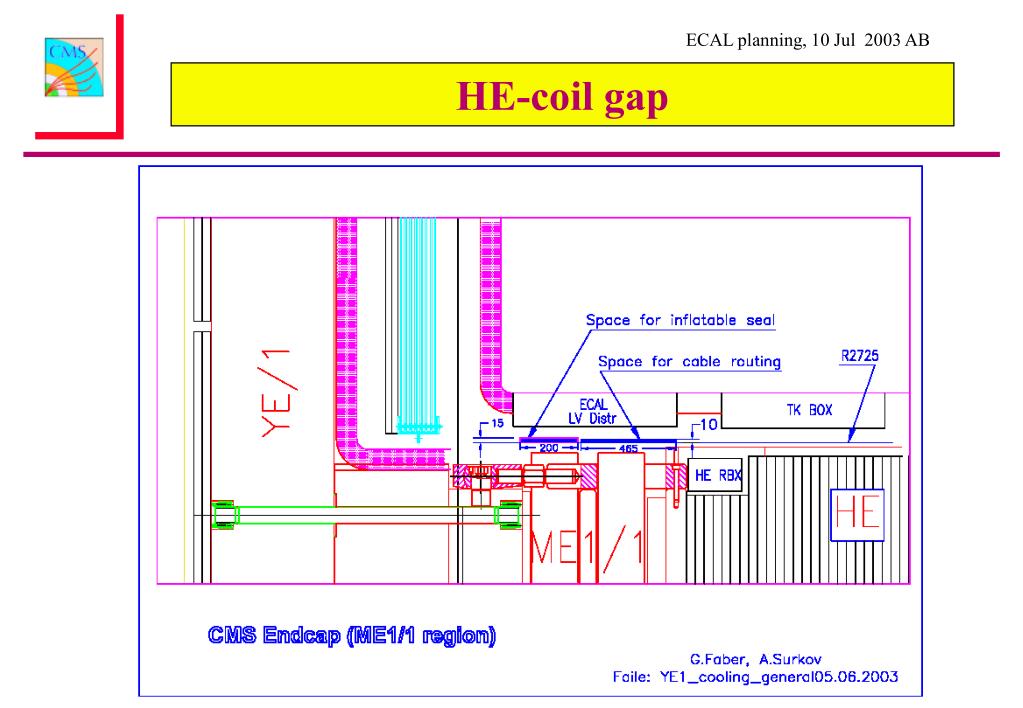

  7. HE-coil gap

  8. Installation Schedule of HE and ME 1/1 2002 2003 2004 2005 HE- HE+ 2 2 HE Delivery to CERN HE-1002 HE-1004 1 HE- HE+ 1 HE Assembly 2 2 HE-005 HE-006 HE Cabling&Test 1 HE-012 ME1/1 Ready for Installation ME1/1- ME1/1+ ME1/1 Assembly ME1/1- ME1/1+ MF-1014 2 MF-1010 MF-1015 1 1 ME1/1 Cabling&Test MF-071 MF-1017

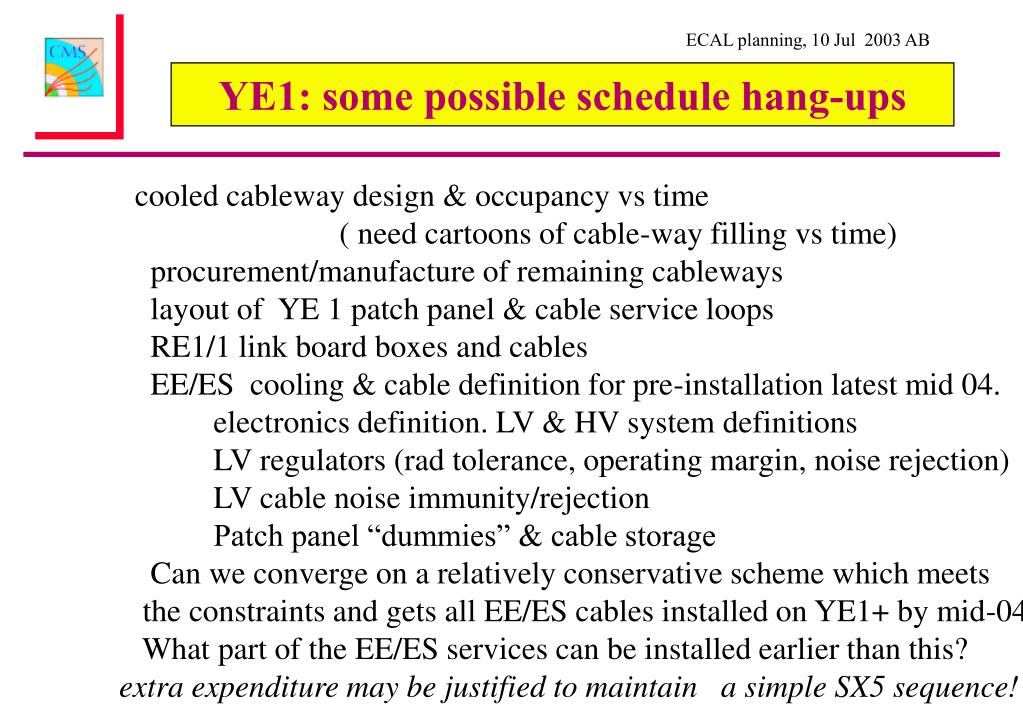

  9. YE1: some possible schedule hang-ups cooled cableway design & occupancy vs time ( need cartoons of cable-way filling vs time) procurement/manufacture of remaining cableways layout of YE 1 patch panel & cable service loops RE1/1 link board boxes and cables EE/ES cooling & cable definition for pre-installation latest mid 04. electronics definition. LV & HV system definitions LV regulators (rad tolerance, operating margin, noise rejection) LV cable noise immunity/rejection Patch panel “dummies” & cable storage Can we converge on a relatively conservative scheme which meets the constraints and gets all EE/ES cables installed on YE1+ by mid-04? What part of the EE/ES services can be installed earlier than this? extra expenditure may be justified to maintain a simple SX5 sequence!

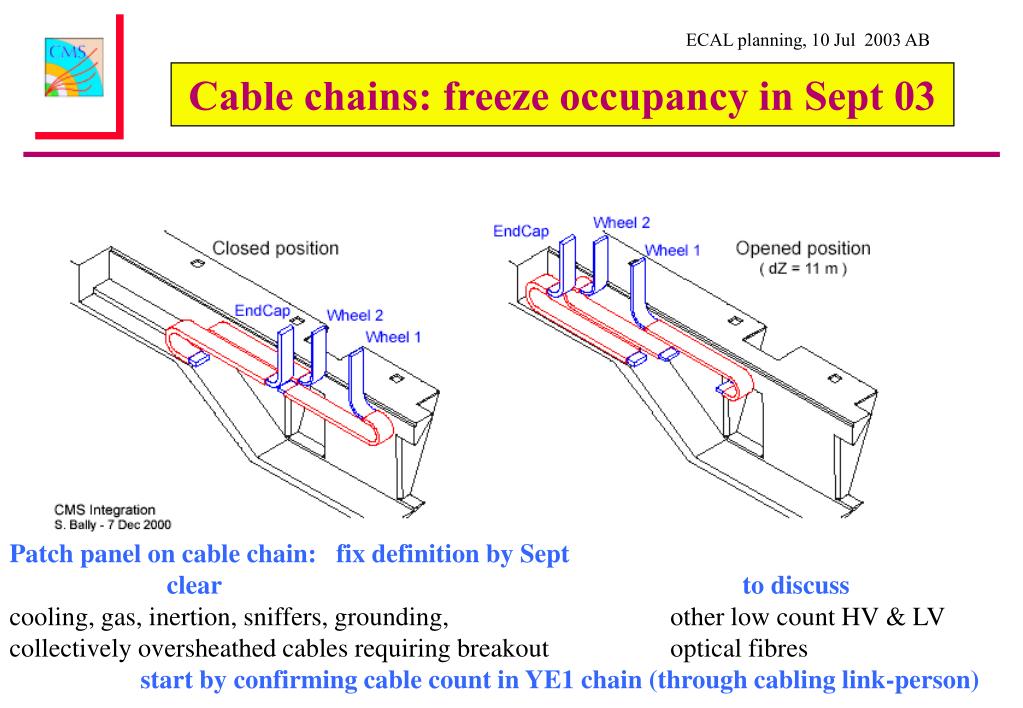

  10. Cable chains: freeze occupancy in Sept 03 Patch panel on cable chain: fix definition by Sept clear to discuss cooling, gas, inertion, sniffers, grounding, other low count HV & LV collectively oversheathed cables requiring breakout optical fibres start by confirming cable count in YE1 chain (through cabling link-person)

  11. Precabling of endcap detectors Muon Endcap 1/1 Hadron Endcap (dummy) EM endcap (dummy) Preshower who is responsible for PP definition and dummy fabrication?

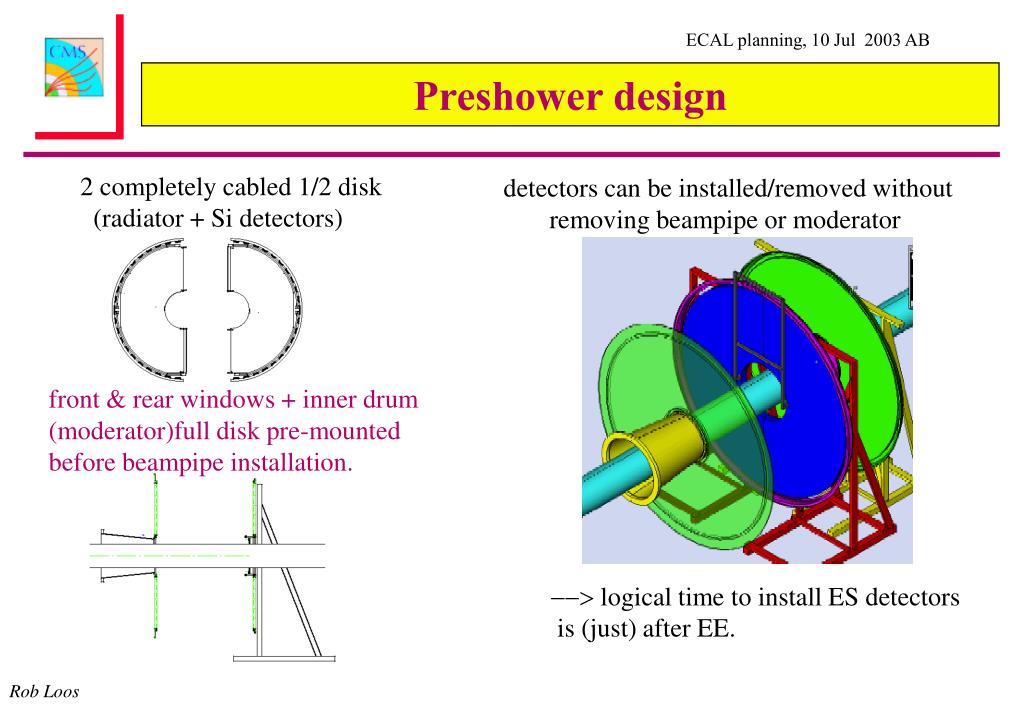

  12. Preshower design 2 completely cabled 1/2 disk (radiator + Si detectors) detectors can be installed/removed without removing beampipe or moderator front & rear windows + inner drum (moderator)full disk pre-mounted before beampipe installation. --> logical time to install ES detectors is (just) after EE. Rob Loos

  13. EE/ES cable duct occupancy Studies & CTF reports by W.Funk. EMC, forces due to B-field, integration of HE & RE cables in duct?
