1 / 18

Transition to Operations

Transition to Operations. Erik D. Johnson, Deputy ALD for Programs NSLS-II Project Advisory Committee February 8-9, 2011. Outline. Transition to Operations Planning Challenges for NSLS-II Facilities TOP (FTOP) Photon Sciences Approach to Transition to Operations Planning

ciqala
Télécharger la présentation

Transition to Operations

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Transition to Operations Erik D. Johnson, Deputy ALD for Programs NSLS-II Project Advisory Committee February 8-9, 2011

  2. Outline Transition to Operations Planning Challenges for NSLS-II Facilities TOP (FTOP) Photon Sciences Approach to Transition to Operations Planning Project TOP (PTOP) Some NSLS-II PTOP elements Summary

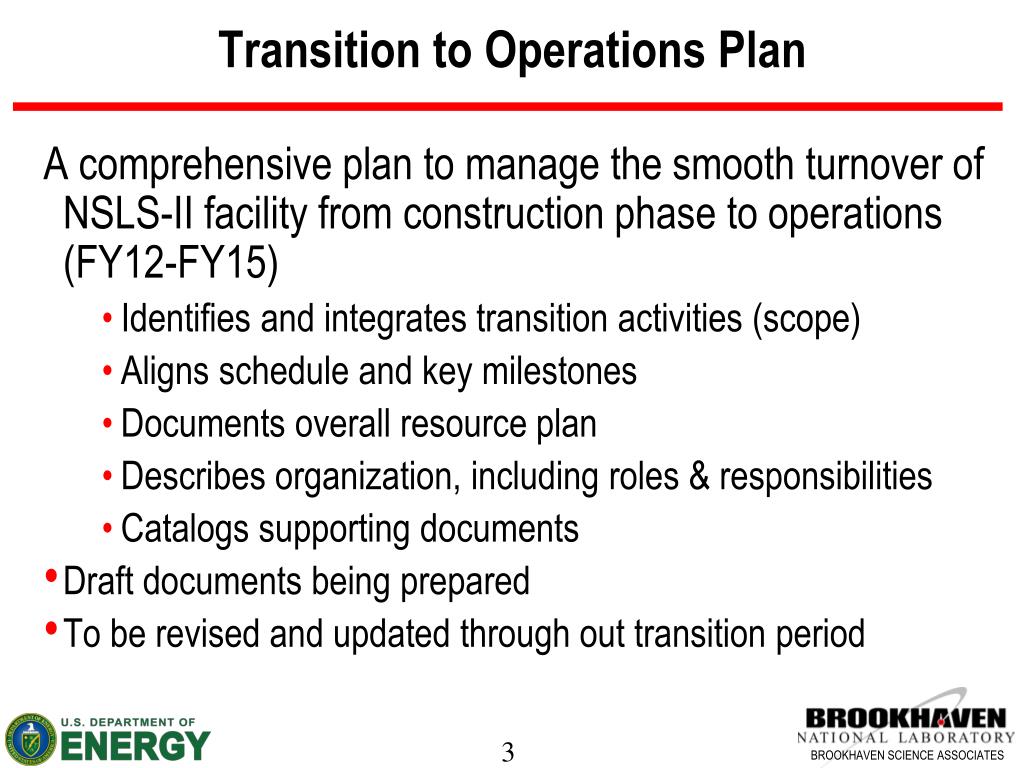

  3. Transition to Operations Plan A comprehensive plan to manage the smooth turnover of NSLS-II facility from construction phase to operations (FY12-FY15) • Identifies and integrates transition activities (scope) • Aligns schedule and key milestones • Documents overall resource plan • Describes organization, including roles & responsibilities • Catalogs supporting documents • Draft documents being prepared • To be revised and updated through out transition period

  4. Key questions for Transition to Operations From several different perspectives ask: • What do you have? • Validation of attainment of project scope • Analysis of safety performance/ hazards • Who is responsible for operating it? • What organization accepts responsibility for operations • What is the span of their responsibility • What will it take to operate it? • Operating procedures, training, documentation • Financial planning (Operation, Maintenance, Improvement)

  5. Special Challenges for NSLS-II Must consider broader context for PSD operations • Currently Operate NSLS (Until sometime FY14) • 59 beamlines currently in operation • Active user community (~2200/yr) • Hosted on a mix of facility and PRT beamlines • NSLS-II even with additional ‘off-project’ beamlines will not have the capacity of NSLS at CD-4 • Need to plan for transition of user community as well as facility - a bit outside of the ‘usual’ TOP issues Coordinate disposition of project scope with Portfolio

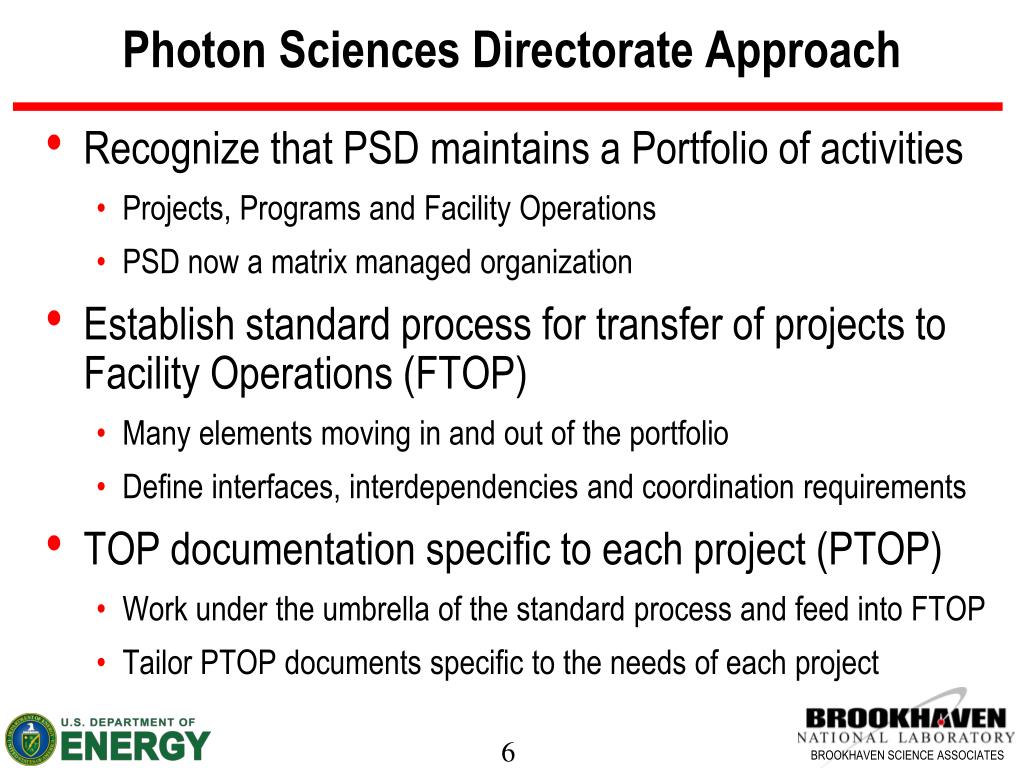

  6. Photon Sciences Directorate Approach • Recognize that PSD maintains a Portfolio of activities • Projects, Programs and Facility Operations • PSD now a matrix managed organization • Establish standard process for transfer of projects to Facility Operations (FTOP) • Many elements moving in and out of the portfolio • Define interfaces, interdependencies and coordination requirements • TOP documentation specific to each project (PTOP) • Work under the umbrella of the standard process and feed into FTOP • Tailor PTOP documents specific to the needs of each project

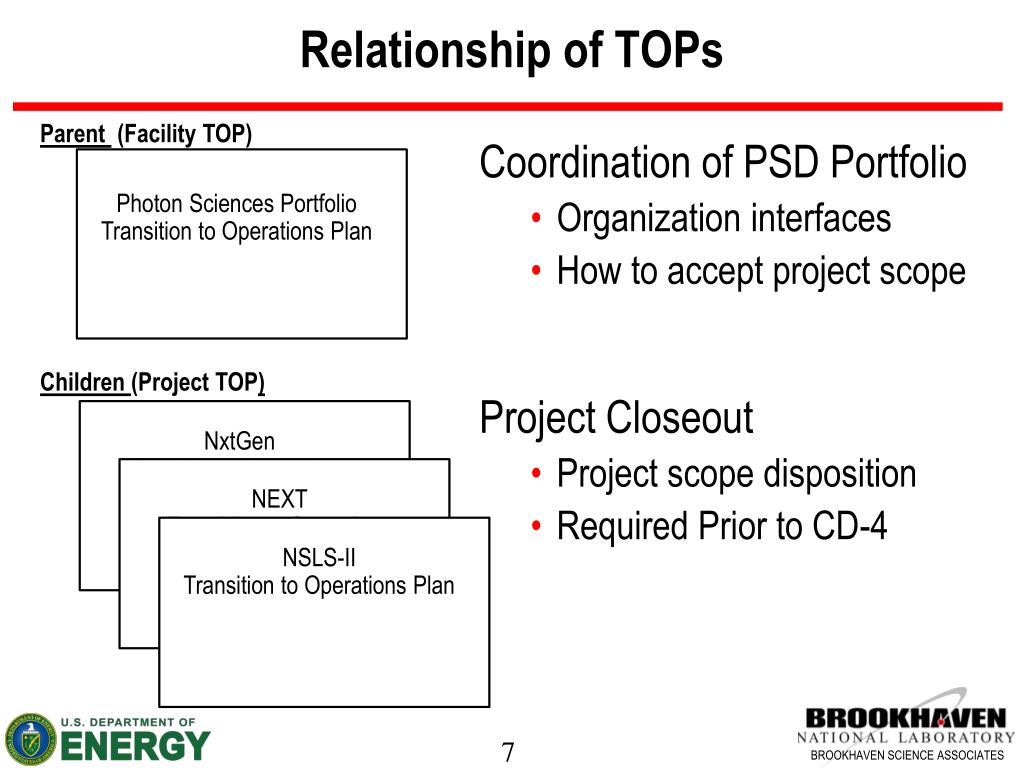

  7. Relationship of TOPs Parent (Facility TOP) Coordination of PSD Portfolio • Organization interfaces • How to accept project scope Project Closeout • Project scope disposition • Required Prior to CD-4 Photon Sciences Portfolio Transition to Operations Plan NEXT Transition to Operations Children (Project TOP) NxtGen Transition to Operations NSLS-II Transition to Operations Plan

  8. Content of FTOP • FTOP Goals • PSD Portfolio & Planning • Including planning assumptions and management strategy • Transition Scope, Phase, and Deliverables • Schedule and Key Milestones • Resource Planning • Management Organization • ESH & QA

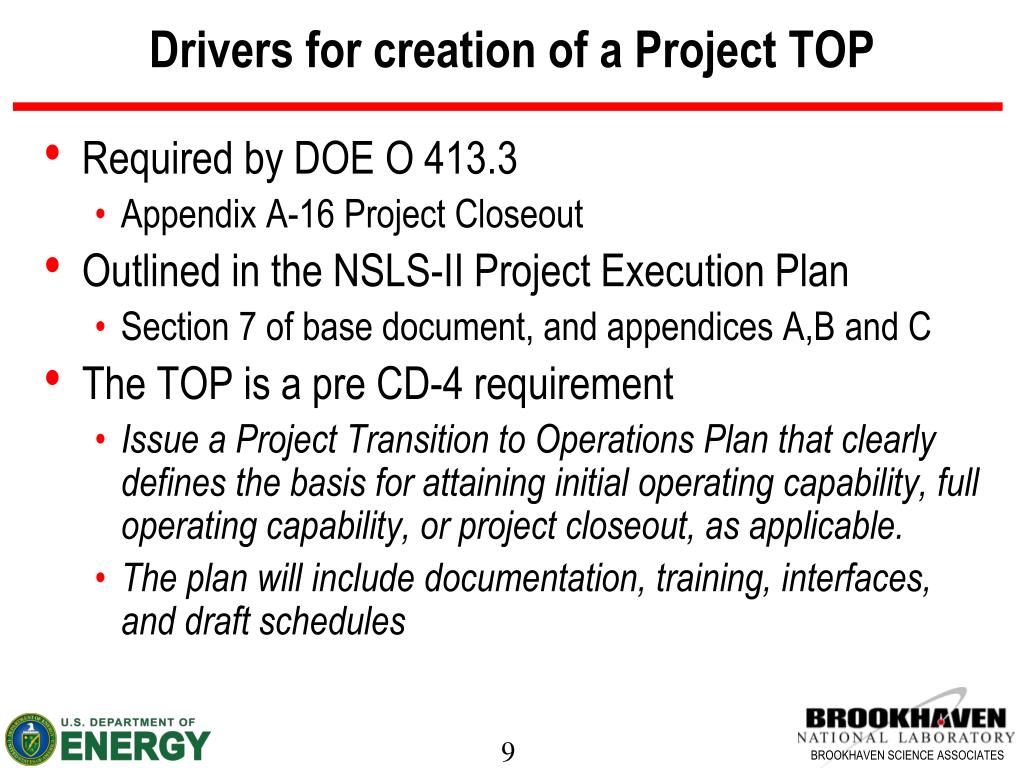

  9. Drivers for creation of a Project TOP • Required by DOE O 413.3 • Appendix A-16 Project Closeout • Outlined in the NSLS-II Project Execution Plan • Section 7 of base document, and appendices A,B and C • The TOP is a pre CD-4 requirement • Issue a Project Transition to Operations Plan that clearly defines the basis for attaining initial operating capability, full operating capability, or project closeout, as applicable. • The plan will include documentation, training, interfaces, and draft schedules

  10. DOE Guidance for TOP • TOP in the context of closeout (DOE G 413.3-16) Completion criteria (Verify KPP’s) Readiness assessment Commissioning Plan Transition to Operations Plan Quality Assurance Plan EMS System Revision Safeguards, Security and Safety Plans Post CD-4 Approval Requirements

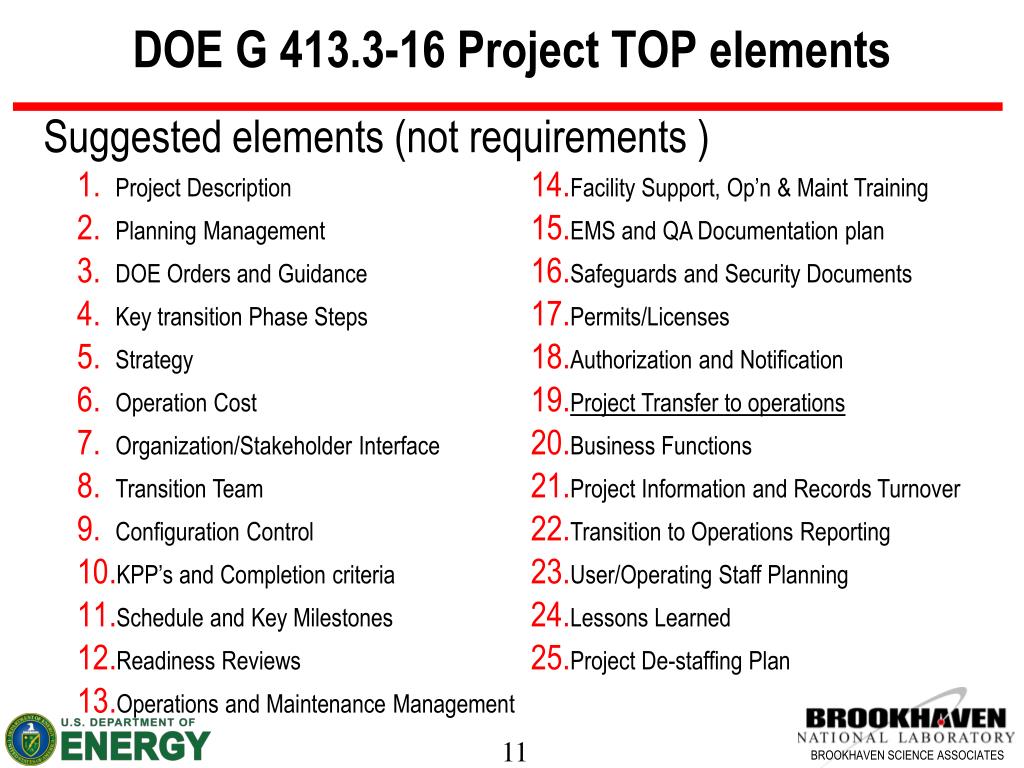

  11. DOE G 413.3-16 Project TOP elements Suggested elements (not requirements ) Project Description Planning Management DOE Orders and Guidance Key transition Phase Steps Strategy Operation Cost Organization/Stakeholder Interface Transition Team Configuration Control KPP’s and Completion criteria Schedule and Key Milestones Readiness Reviews Operations and Maintenance Management Facility Support, Op’n & Maint Training EMS and QA Documentation plan Safeguards and Security Documents Permits/Licenses Authorization and Notification Project Transfer to operations Business Functions Project Information and Records Turnover Transition to Operations Reporting User/Operating Staff Planning Lessons Learned Project De-staffing Plan

  12. Transition of NSLS-II Project Scope Project ScopeOperations Assignments Project Management DOE/BES, BNL, PSD Conventional Facilities PSD, BNL-F&O, ITD Accelerator Facilities PSD AS Ops, XF Ops Experimental Facilities PSD XF Ops R&D Facilities PSD/ BNL PTOP FTOP CD-4

  13. Project Performance and Completion Criteria • Defined in the Critical Decision Approvals and also refined in • Global requirements Document • Defined minimum goals for each stage of commissioning, prerequisite to starting next stage • Start-up Test Plan • Defined criteria for completion of commissioning stages • NSLS-II Project Key Performance Parameters

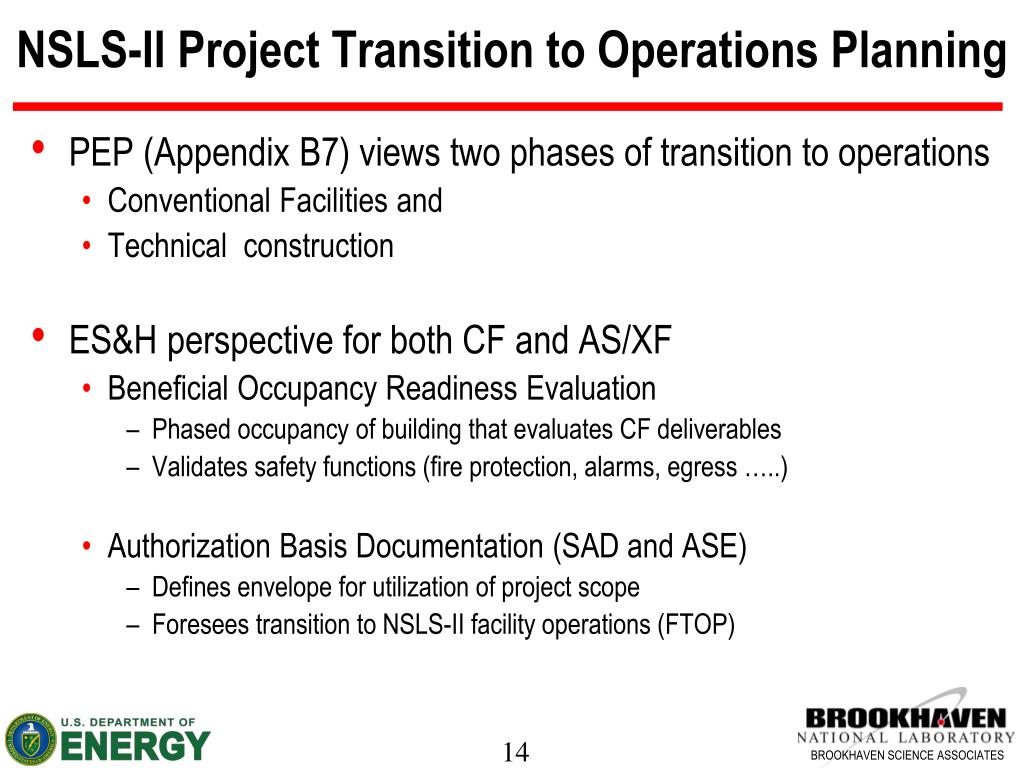

  14. NSLS-II Project Transition to Operations Planning • PEP (Appendix B7) views two phases of transition to operations • Conventional Facilities and • Technical construction • ES&H perspective for both CF and AS/XF • Beneficial Occupancy Readiness Evaluation • Phased occupancy of building that evaluates CF deliverables • Validates safety functions (fire protection, alarms, egress …..) • Authorization Basis Documentation (SAD and ASE) • Defines envelope for utilization of project scope • Foresees transition to NSLS-II facility operations (FTOP)

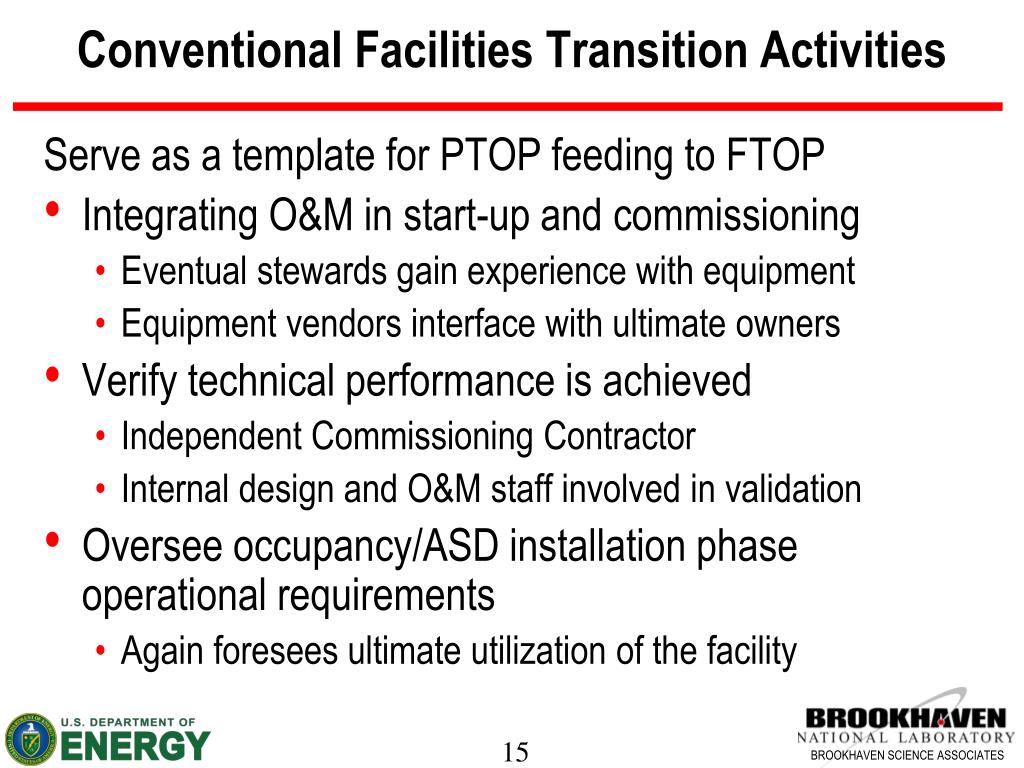

  15. Conventional Facilities Transition Activities Serve as a template for PTOP feeding to FTOP • Integrating O&M in start-up and commissioning • Eventual stewards gain experience with equipment • Equipment vendors interface with ultimate owners • Verify technical performance is achieved • Independent Commissioning Contractor • Internal design and O&M staff involved in validation • Oversee occupancy/ASD installation phase operational requirements • Again foresees ultimate utilization of the facility

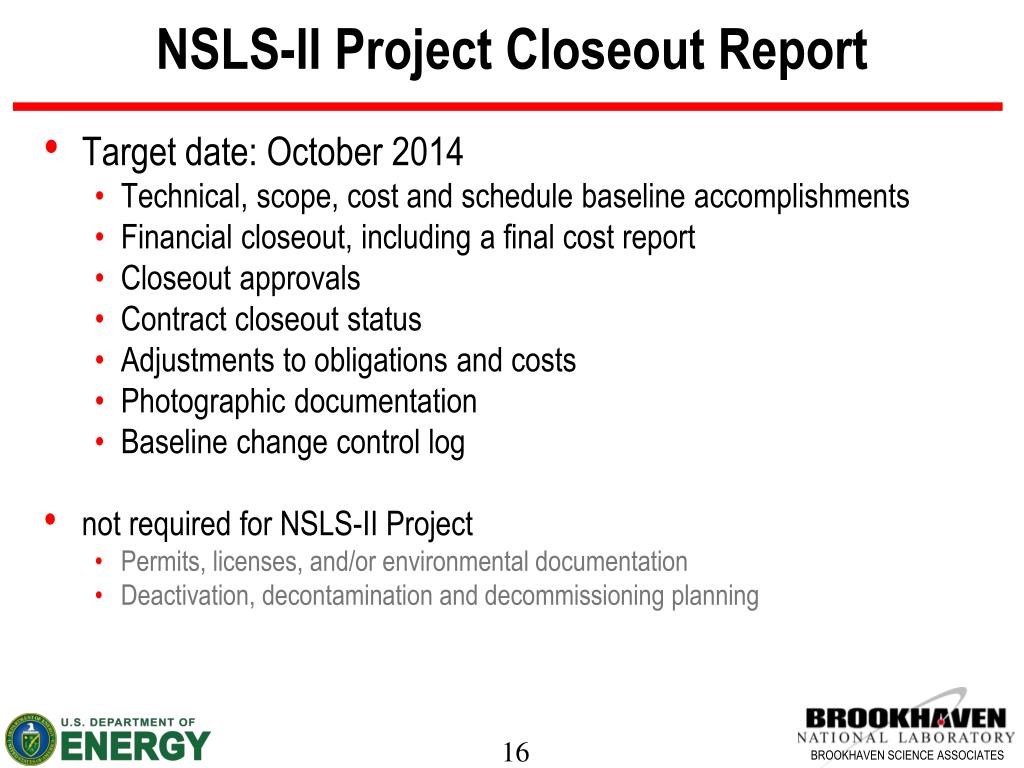

  16. NSLS-II Project Closeout Report • Target date: October 2014 • Technical, scope, cost and schedule baseline accomplishments • Financial closeout, including a final cost report • Closeout approvals • Contract closeout status • Adjustments to obligations and costs • Photographic documentation • Baseline change control log • not required for NSLS-II Project • Permits, licenses, and/or environmental documentation • Deactivation, decontamination and decommissioning planning

  17. Facility Transition to Operations Manager • Lead the integrated transition management team • Develop transition plans and documentation • Manage implementation and execution of the transition plans • Serve as the single point of contact for all matters relating to the implementation of transition plans • Ensure ES&H and QA goals are achieved for transition activities • Identify and manage transition related risks • Identify and ensure timely resolution of critical issues which impact transition activities • Hold regularly scheduled transition meetings • Participate in project closeouts and operational readiness assessments • Keep PSD management informed in timely manner

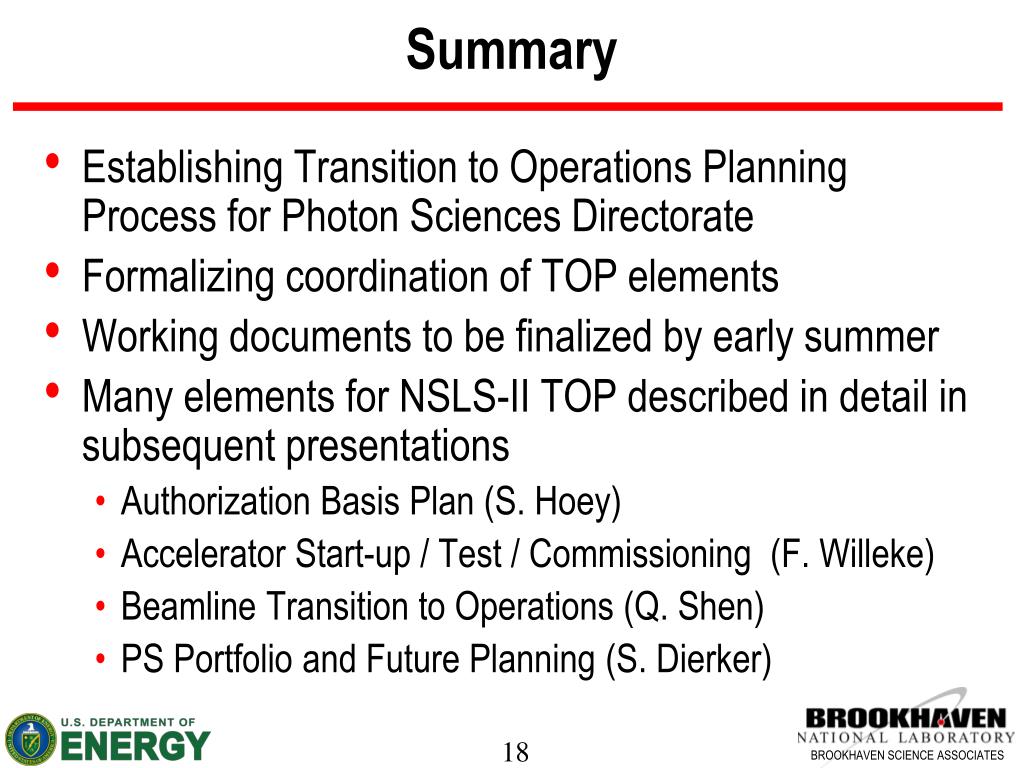

  18. Summary • Establishing Transition to Operations Planning Process for Photon Sciences Directorate • Formalizing coordination of TOP elements • Working documents to be finalized by early summer • Many elements for NSLS-II TOP described in detail in subsequent presentations • Authorization Basis Plan (S. Hoey) • Accelerator Start-up / Test / Commissioning (F. Willeke) • Beamline Transition to Operations (Q. Shen) • PS Portfolio and Future Planning (S. Dierker)
