  1. Wiimote/Kinect Lab Design Senior Design December 2011, Group 16 Adviser: Dr. Tom Daniels Brenton Hankins Rick Hanton Harsh Goel Jeff Kramer

  2. Outline • Problem/Solution • Requirements • Risks, Costs, and Schedule • Wii • Hardware • WiiWrap and Software • Kinect • Hardware • Software • Test Plan • Project Status • Work Distribution • Future Plans

  3. Problem Statement The Wii Wrap software used by freshmen Computer Engineering students is simple but needs improvement for installation and use by novice users such as a high school science teachers.  In addition, similar software should be developed that uses the Microsoft Kinect sensor as input to student-written programs.

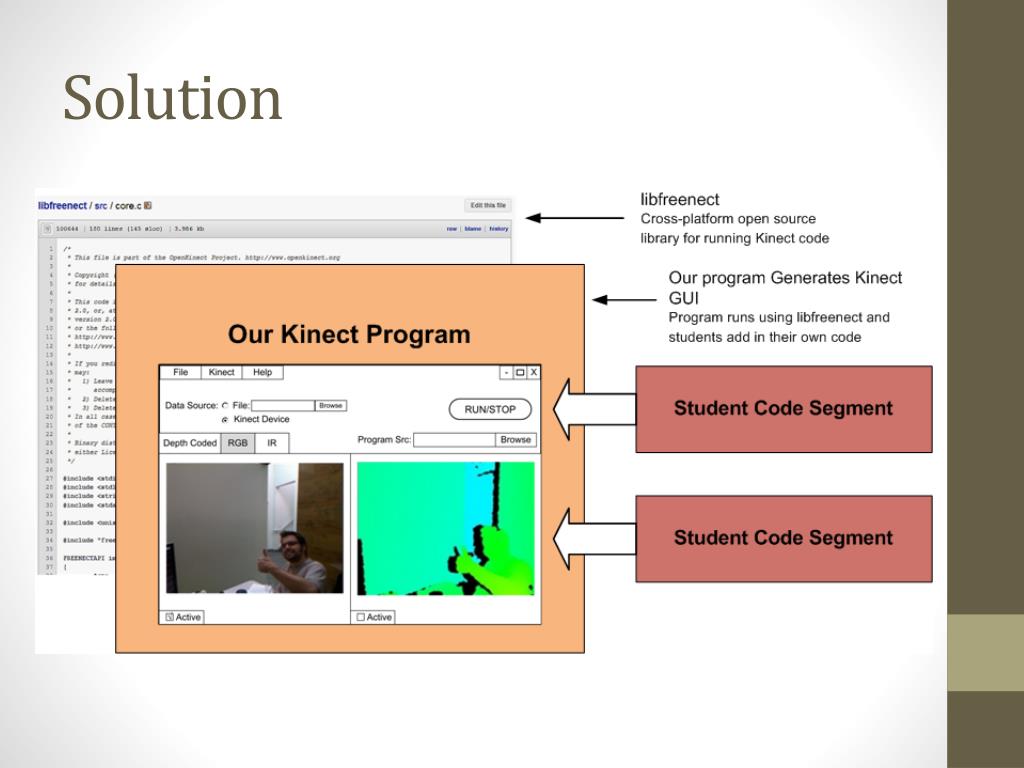

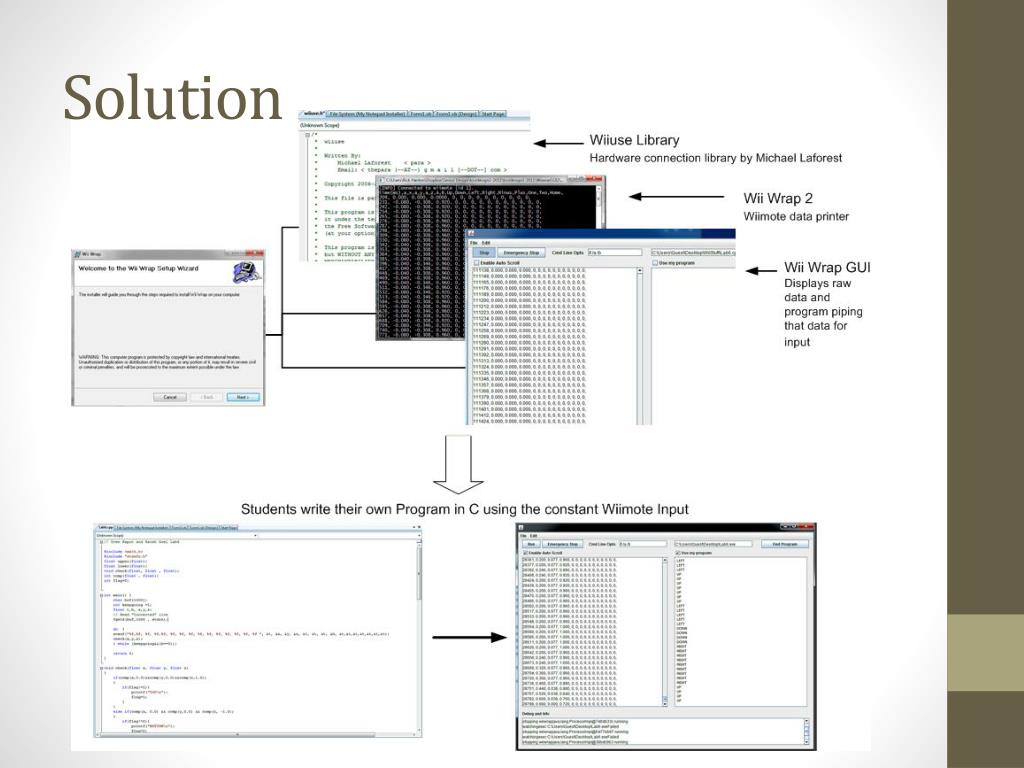

  4. Solution

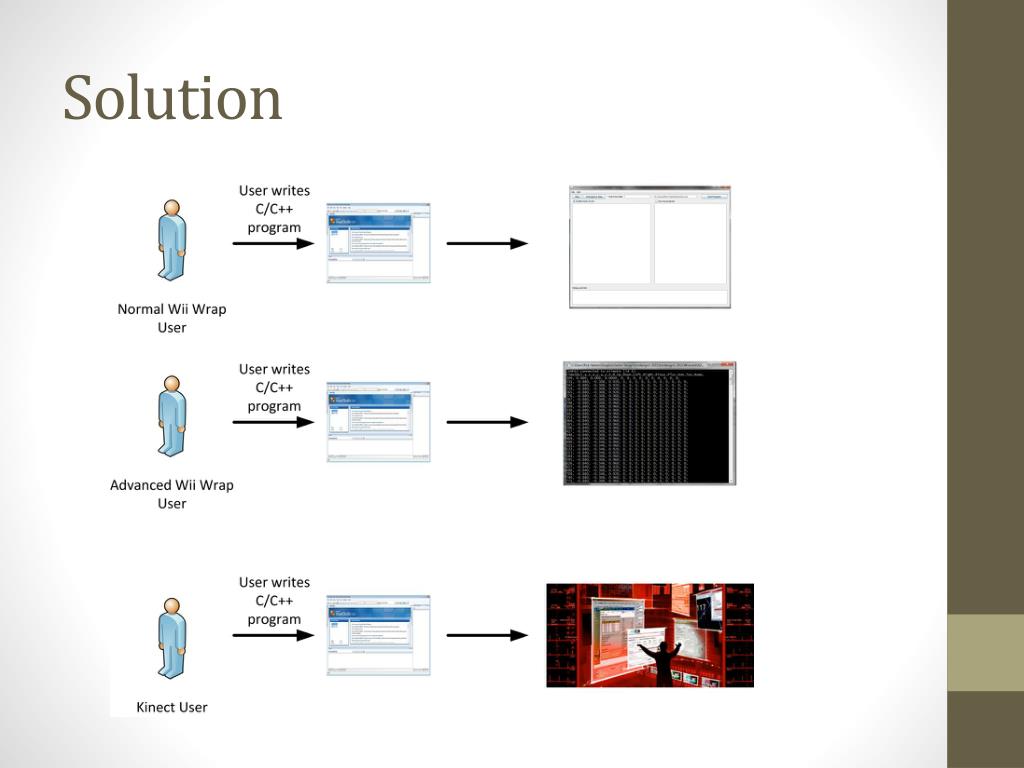

  5. Solution

  6. Solution

  7. Functional Requirements • Develop an installer for the Wiimote project. • Identify and Remove errors from the Wiimote lab software • Correct buffering problems and synchronize user program with the incoming data stream. • Make Kinect sensor data streams available to the user in an efficient and real-time manner • Provide an interactive application that students can program using the Kinect data. • Have an interface to write programs on the received Kinect data and run them.

  8. Non-Functional Requirements • Reliability: We will refine and package the software that is designed. This pertains to optimization of real-time processes such as data processing. A testing plan shall be developed for this purpose. • Portability: The project shall be portable between computers. We will cater mainly to windows, but will ensure that our libraries are extendable in case there is a need to adapt it to another system. Additionally, the software shall be easy to install and remove. • Usability: The project shall be easy to use, both for instructors and students. It shall simplify tasks to set up and run projects by means of intuitive GUIs so that students can focus on problem solving aspects as much as possible.

  9. Assumptions • The software is designed to be used in a Windows computer lab that has both a bluetooth dongle and a Wiimote or a Kinect sensor at each computer terminal. • We are currently assuming that the Microsoft SDK will be released in the coming months, otherwise development will continue based on the OpenKinect software on the Windows platform

  10. What makes us unique? • Using video game hardware for to teach programming in an educational setting • Designing software for students with little programming experience to work with 3D video capture & processing functions • Interactive API and GUI that makes it easy for students to program without worry about OO programming or managing system/hardware issues.

  11. Existing Developed Software • The Wii Wrap software was previously developed by a student at Iowa State • Similar software for the Wii Remote exists such as Wiimote Whiteboard, WiinRemote, or GlovePie • OpenKinect is a package of software created by enthusiasts to run Kinect programs on Linux, Mac, and Windows using a variety of languages • Within a few weeks Microsoft will release a Kinect SDK specifically for Windows

  12. Risks Risk 1: Temporarily lose a developer from our team for unforeseen reasons. Mitigation 1: The team will do our best to continue work without the developer while they are gone and rely on a detailed documentation trail. We will use technologies like Skype and email to keep in touch with the developer during their absence. Risk 2: Unable to keep tasks fully on schedule due to other projects and schoolwork. Mitigation 2: Set up minor deadlines to make progress on larger tasks. Risk 3: Important equipment becomes lost or nonfunctional (Wiimote, Kinects) Mitigation 3: Jeff has several personal Wiimotes available to him for use and there are one or two extra department-owned Kinects Dr. Daniels has for use. Risk 4: No individuals on the project team have experience programming with graphics APIs. Mitigation 4: We have built periods of time into our schedule for us to work on developing the necessary experience with OpenGL and SDL environments to allow us to design and develop software for the Kinect efficiently.

  13. Cost Estimates

  14. Cost Estimates

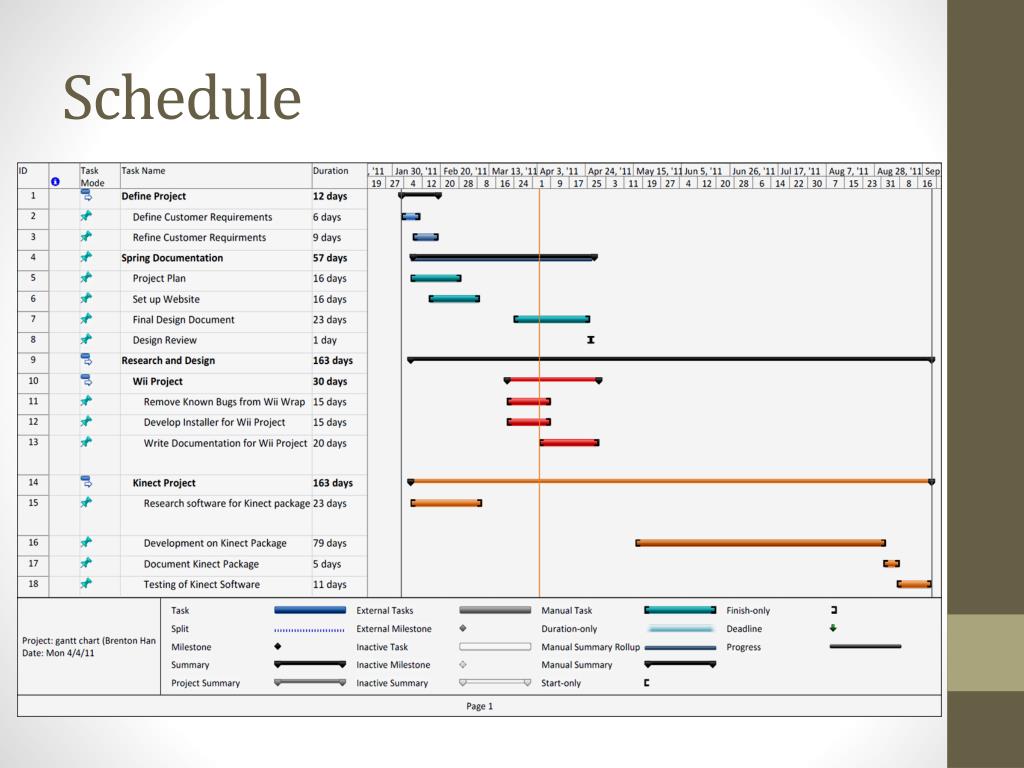

  15. Schedule

  16. Hardware - Wii • Wii Remote / Wiimote • 11 buttons + Power • Roll/Pitch/Yaw Gyro • Infrared Sensor • Speaker (unsupported) • Optional Nunchuck (unsupported)

  17. Software Dataflow Wii Lab

  18. Development Software Selection Wii Wrap • Written in C • GUI written in Java Kinect SDK • Written in C++ Wii Wrap installer • MSI

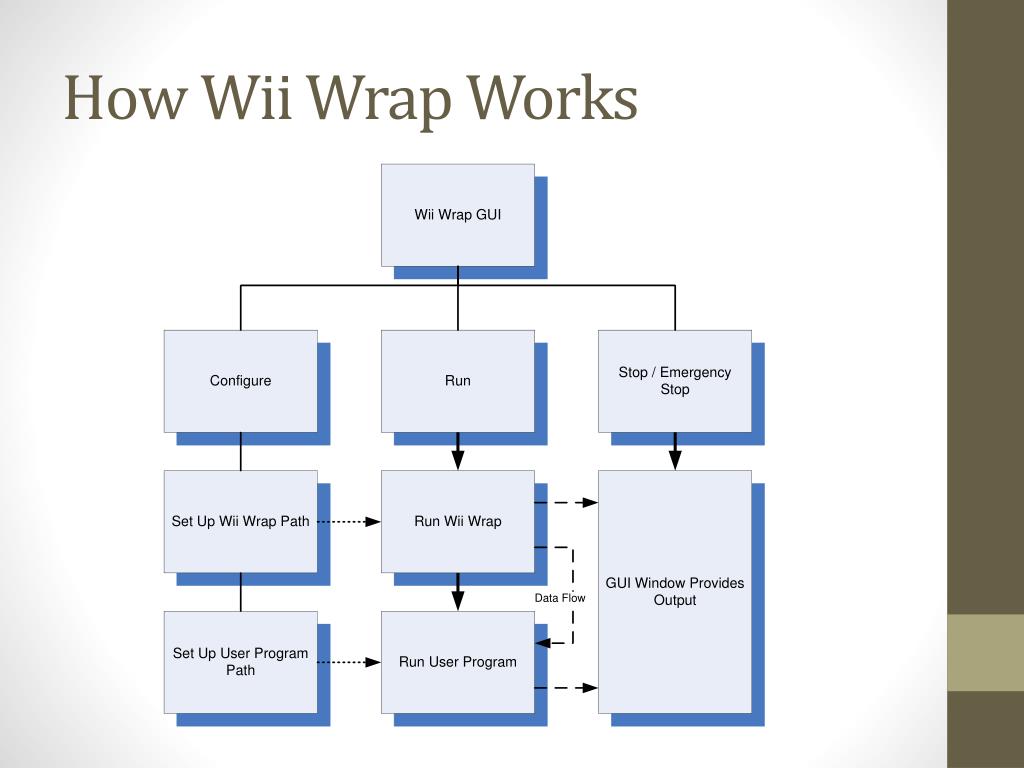

  19. How Wii Wrap Works

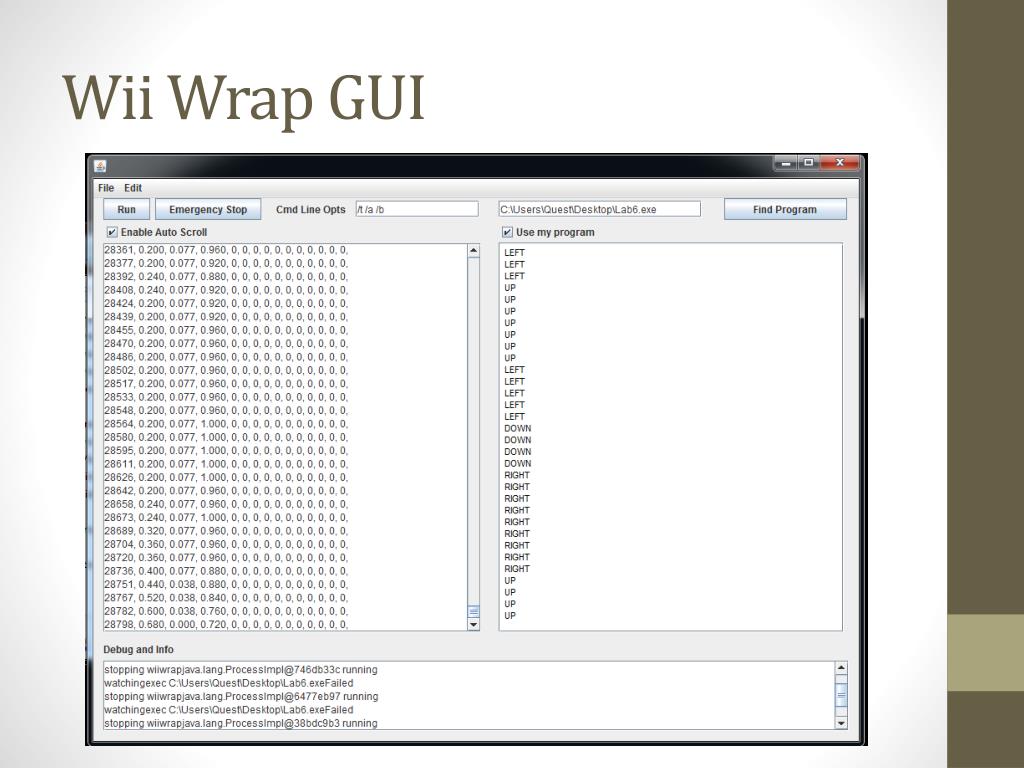

  20. Wii Wrap GUI

  21. Wii Wrap GUI • Fix Run/Stopped Errors in GUI when the Wii Wrap software doesn’t execute as planned. • Discover where the lag in display output is (Java Buffers, Windows I/O) • Integrate GUI into Wii Wrap installer

  22. Hardware - Kinect • RGB Webcam Camera 640x480 @ 30 Hz (center) • IR Projector Projects Grid for Depth Mapping • IR Camera at 640x480 @ 30 Hz collects depth data (right) • Microphones give room audio • Small Panning motor turns sensor bar from side to side • Onboard image preprocessing • Projector power draw requires extra AC power • Thanks to iFixit for some specs data

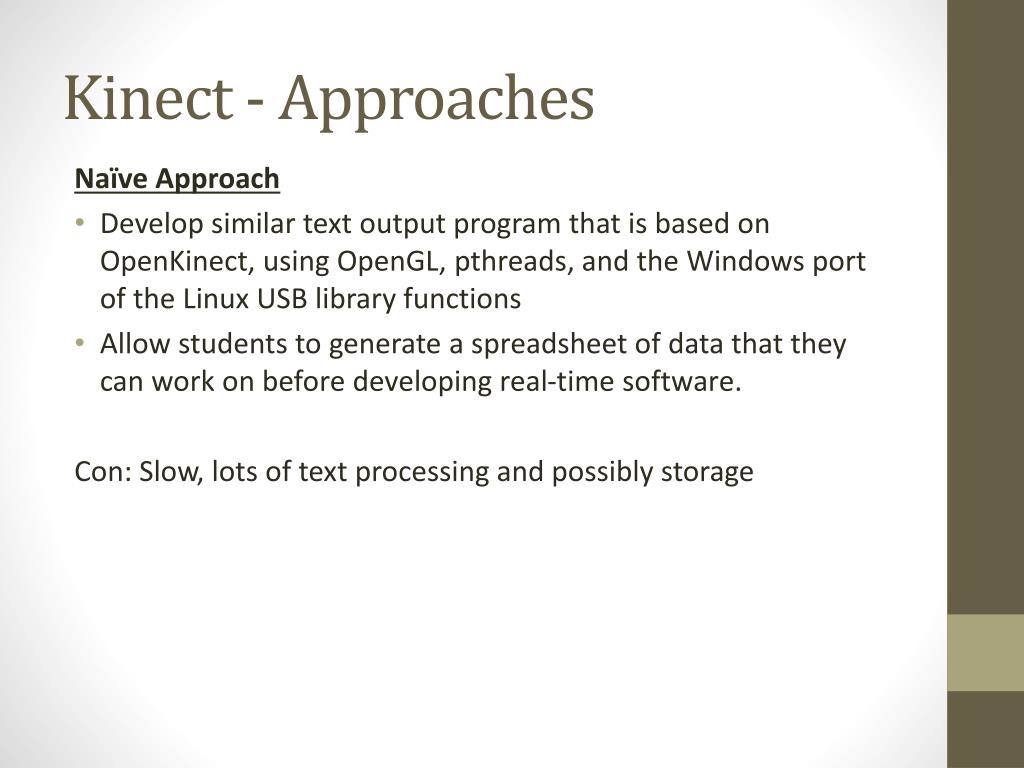

  23. Kinect - Approaches Naïve Approach • Develop similar text output program that is based on OpenKinect, using OpenGL, pthreads, and the Windows port of the Linux USB library functions • Allow students to generate a spreadsheet of data that they can work on before developing real-time software. Con: Slow, lots of text processing and possibly storage

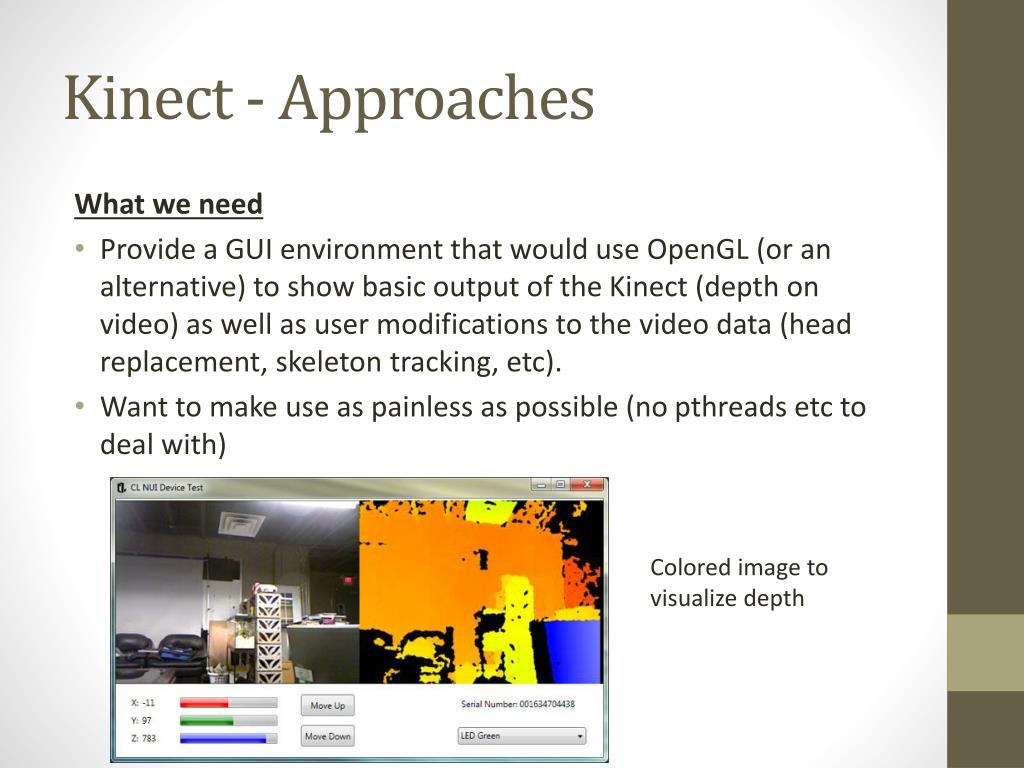

  24. Kinect - Approaches What we need • Provide a GUI environment that would use OpenGL (or an alternative) to show basic output of the Kinect (depth on video) as well as user modifications to the video data (head replacement, skeleton tracking, etc). • Want to make use as painless as possible (no pthreads etc to deal with) Colored image to visualize depth

  25. Kinect - Design • Need to evaluate how to best integrate student code • Concept A : Process-Update Model • Provide a framework of classes that students modify without needing to know how OO programming works User Models Process* API for the Student Update* Called when new frame data is available * -> function pointers Called to update the screen after processing

  26. Kinect • Anticipated User View • Backend: High-Level Sketch Acquire Moving Average of Frames Input Screen Output Screen Apply User-Defined Process* Function Apply User-Defined Update* Function Apply Changes to Output Screen

  27. Test Plan • We will use similar test plans for both the Wii and Kinect. • Initially we will use black box testing methods on individual modules of the program. • Testing boundary input values such as null, negative values, etc. • Randomizing input values in case edge case is missed • The second phase of testing will be integration testing. • Testing the entire system as a whole single unit • Making sure all the individual modules function when combined • GUI testing can be done alongside integration phase of the testing plan. • Consists of making sure GUI is responsive, functions properly (buttons do the correct actions)

  28. Test Plan (Part 2) • Once the functionality is tested, we will need to do performance testing especially on the GUI. • Use Eclipse TPTP to test performance. • Test GUI input buffering, load tests, etc. • Will have Dr. Daniels use the programs to see if they are satisfactory and what changes need to be made. • Make revisions to code based on Daniels’ feedback

  29. Current Project Status • Have been working on developing a software update for Wii Wrap • Finishing installer for Wii Wrap • Still need to write documentation for Wii Wrap and provide a distribution setup • Started experimenting with the OpenKinect software and communicating with OpenKinect founder about release of Microsoft SDK • Currently preparing a test plan for the Kinect

  30. Work Distribution / Fall ‘11 Plans • Now – May 6: Complete Wii Wrap Installer (Brenton) • Now – Sept. 1: Identify data stream from Kinect (Rick/Brenton) • Now – Sept. 1: Make the data streams accessible to user (Rick/Brenton) • Now – Sept. 1: Developer user engine/API, investigate graphics (Harsh/Jeff) • Sept. 1 – 7: Document Kinectpackage (Rick – Lead) • Sept. 7- 21: Testing of Kinect Software (Jeff – Lead) • Sept. 22-Dec: Fix Kinect Software Issues, Complete Documentation (All)

  31. Questions?
