1 / 29

Project Management C53PM

Session 8 Russell Taylor Lecturer in Computing & Business Studies E-mail: rtayl@borderscollege.ac.uk. Project Management C53PM. Session 8. Project Monitoring & Control Chapter 8 Earned Value Analysis Exam question. Summary - Session 8. Difference between monitoring and control

cleo
Télécharger la présentation

Project Management C53PM

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Session 8 Russell Taylor Lecturer in Computing & Business Studies E-mail: rtayl@borderscollege.ac.uk Project Management C53PM

  2. Session 8 • Project Monitoring & Control • Chapter 8 • Earned Value Analysis • Exam question

  3. Summary - Session 8 • Difference between monitoring and control • Discussed processes for change management • Considered appropriate project control systems • Discussed two different methods of project control • Milestone & EVA • Identified three most important variables to measure in project control • ACWP, BCWP & BCWS • Explained EVA spreadsheet

  4. Major Budgeting Processes • Resource Planning • People, Equipment, Materials, Overheads • Cost Estimating • Developing approximate cost for each resource • Cost Budgeting • Relating cost estimates to schedule • Producing time-phased cost & cash-flow predictions • Cost Control • Controlling cost in relation to project schedule

  5. Project Monitoring & Control • Monitoring • Comparison of actual costs & schedule with planned cost & schedule. • Control • Setting control limits • Deviation outside limits • Corrective action • Effectiveness of project control systems • Response time • Traceability

  6. Project Monitoring & Control Systems • What control measures to select • What data to collect to estimate the current value of each control measure • How to collect the data • What analysis to perform on data collected to detect deviations • Who needs it, in what format and how often

  7. Project monitoring & control Areas • Critical tasks not started or finished on time • Schedule • Non-critical tasks becoming critical • Schedule • Milestones / key dates missed • Schedule • Price changes, cost over-runs, cash flows • Costs

  8. Project monitoring & control Areas • Long supply lead times • Resources, Schedule • Resource availability problems • Resources, Schedule, Costs, • Insufficient technical information • Resources, Schedule, Costs, • Changes in project scope • Performance, Resources, Schedule, Costs,

  9. Typical types of change • Scope creep • Increase level of effort • Quality creep • New technologies or tools • Personnel changes • Schedule improvement • Client discretion

  10. Change Management • Identify the change • Analyse the effects of change • Develop a response strategy • Communicate the strategy and gain endorsement for the change • Revise the work plan and monitor the effects of change

  11. Cost Control • Two methods • Milestone Monitoring • Earned Value Analysis • Exam Question

  12. Milestone Monitoring • A milestone is a key event in a project • Clear and well defined (Concrete) • Related to deliverables in the Gantt chart • Milestones mark progress • Either achieved or not achieved • Have a target completion date • Have a budgeted cost • Milestone monitoring • Simple & effective method • Plotted Deliverables on graph

  13. Milestone Monitoring

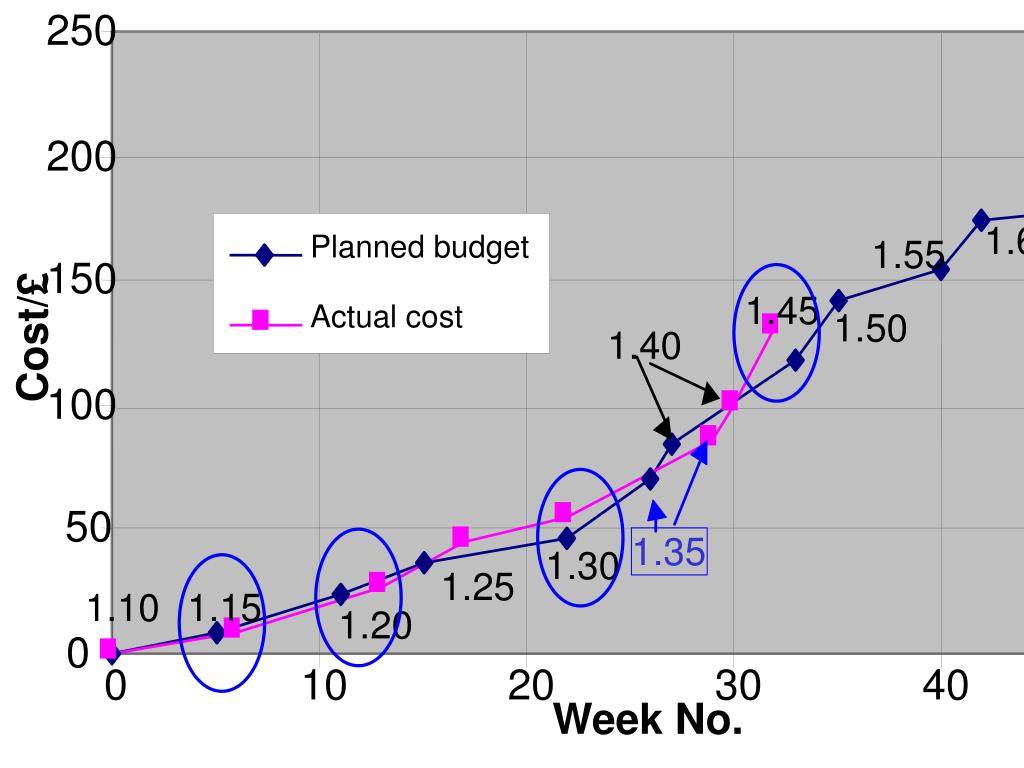

  14. Figure 8.1: Milestone monitoring 250 Example 1.70 200 1.65 1.60 Planned budget 1.55 150 1.45 Actual cost 1.50 Cost/£ 1.40 100 50 1.35 1.30 1.25 1.10 1.15 1.20 0 0 10 20 30 40 50 60 Week No.

  15. Earned Value Analysis (EVA) • Earned Value Analysis (EVA) • also called Cost/Schedule Control System (C/SCS) • or Baseline Performance Measurement (BPM) • or Integrated Baseline Review (IBR) • Comparison of the value actual work completed (earned value) against planned progress & actual expenditure of each activity • Time-phased plan

  16. Earned Value Analysis (EVA) • Actual cost of work performed (ACWP) • Actual costs incurred & recorded • Progress reports • Budget costs of work scheduled (BCWS) • The value of the work scheduled to be accomplished at a given period in time. • Budget cost of work performed (BCWP) • Earned Value (EV) • Budgeted value of work completed to date

  17. BCWS & BCWP Total Activity Budget = £1000,000 Actual progress 70% Scheduled progress 60% 6 0 10 weeks • Budget costs of work scheduled: • BCWS = £1000,000 x 60% = £600,000 • Budget costs of work Performed: • BCWP = £1000,000 x 70% = £700,000

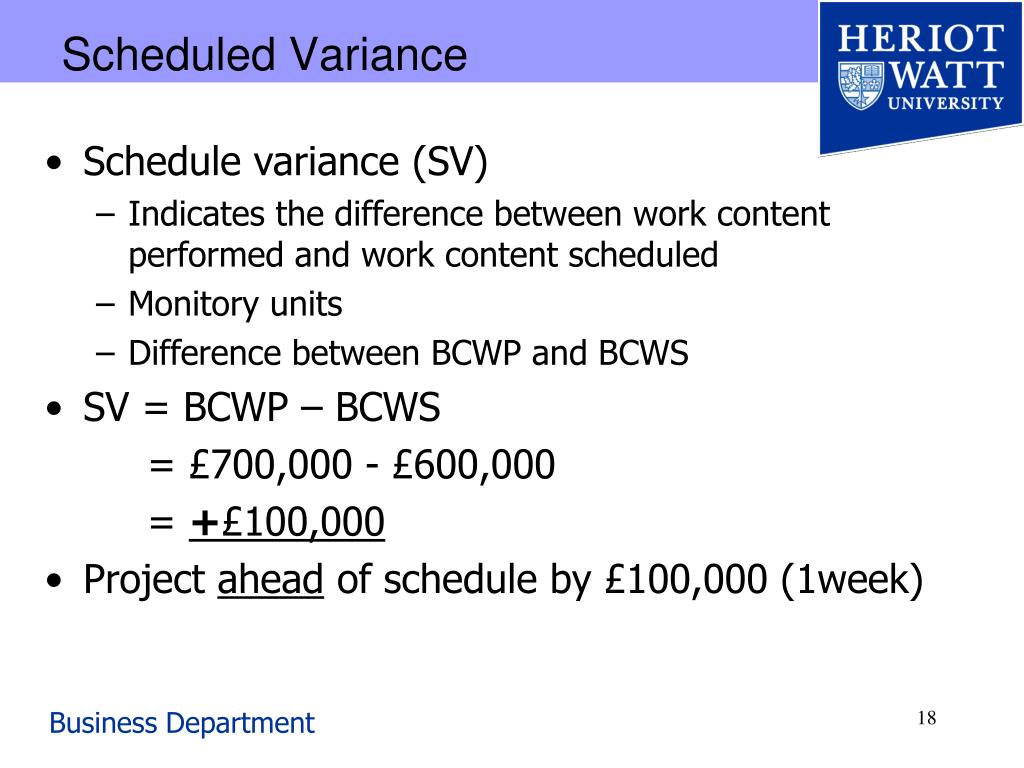

  18. Scheduled Variance • Schedule variance (SV) • Indicates the difference between work content performed and work content scheduled • Monitory units • Difference between BCWP and BCWS • SV = BCWP – BCWS • = £700,000 - £600,000 • = +£100,000 • Project ahead of schedule by £100,000 (1week)

  19. ACWP Total Activity Budget = £1000,000 Actual progress 70% ACWP = £750,000 Scheduled progress 60% 6 0 10 weeks • Budget costs of work scheduled: • BCWS = £1000,000 x 60% = £600,000 • Budget costs of work Performed: • BCWP = £1000,000 x 70% = £700,000

  20. Cost Variance • Cost variance (CV) • Identifies deviations in costs on work content actually performed • Difference between BCWP and ACWP • CV = BCWP – ACWP • = £700,000 - £750,000 • = -£50,000 • Project has a cost overrun of £50,000

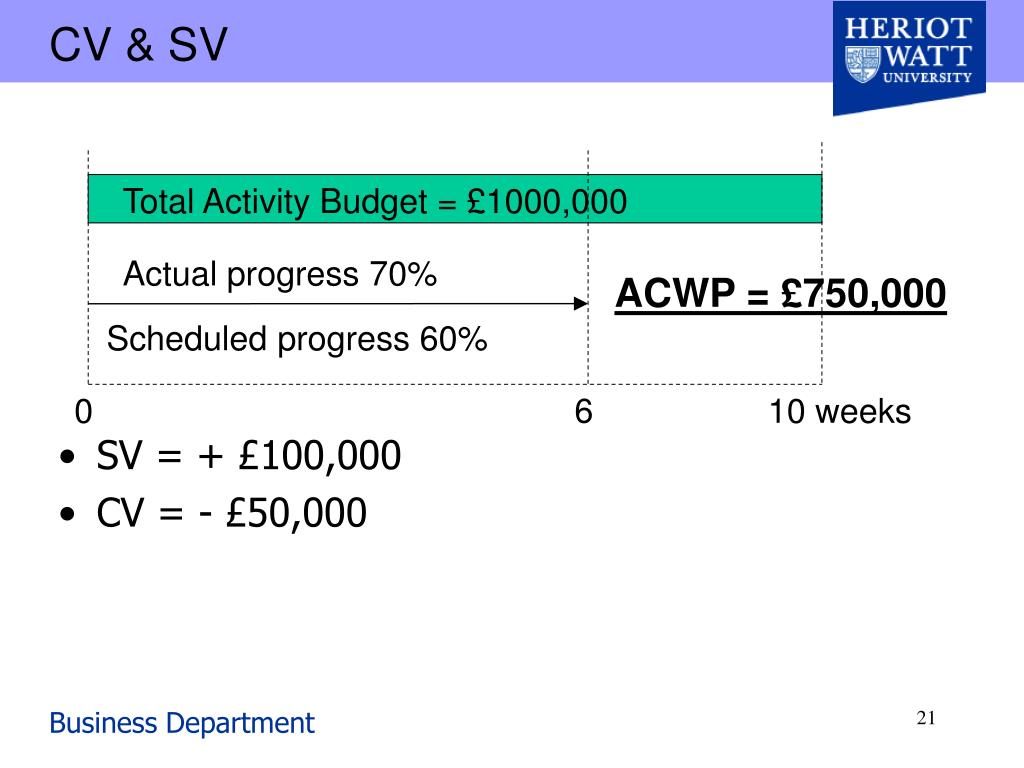

  21. CV & SV Total Activity Budget = £1000,000 Actual progress 70% ACWP = £750,000 Scheduled progress 60% 6 0 10 weeks • SV = + £100,000 • CV = - £50,000

  22. Performance Indices • Schedule Variance (SV) & Cost Variance (CV) • Absolute measures in monitory units • Schedule Performance Index (SPI) • Cost Performance Index (CPI)

  23. BCWP SPI = BCWS £700,000 SPI = = +1.16 £600,000 Schedule Performance Index (SPI) • SPI defined as the ratio between BCWP & BCWS • SPI value = 1 indicates activity is on schedule • SPI value >1 indicates activity ahead of schedule • SPI value <1 indicates schedule overrun

  24. BCWP CPI = ACWP £700,000 CPI = = 0.93 £750,000 Cost Performance Index (CPI) • CPI defined as the ratio between BCWP & ACWP • CPI value = 1 indicates activity is on budget • CPI value > 1 indicates better than planned cost performance • CPI value <1 indicates cost overrun

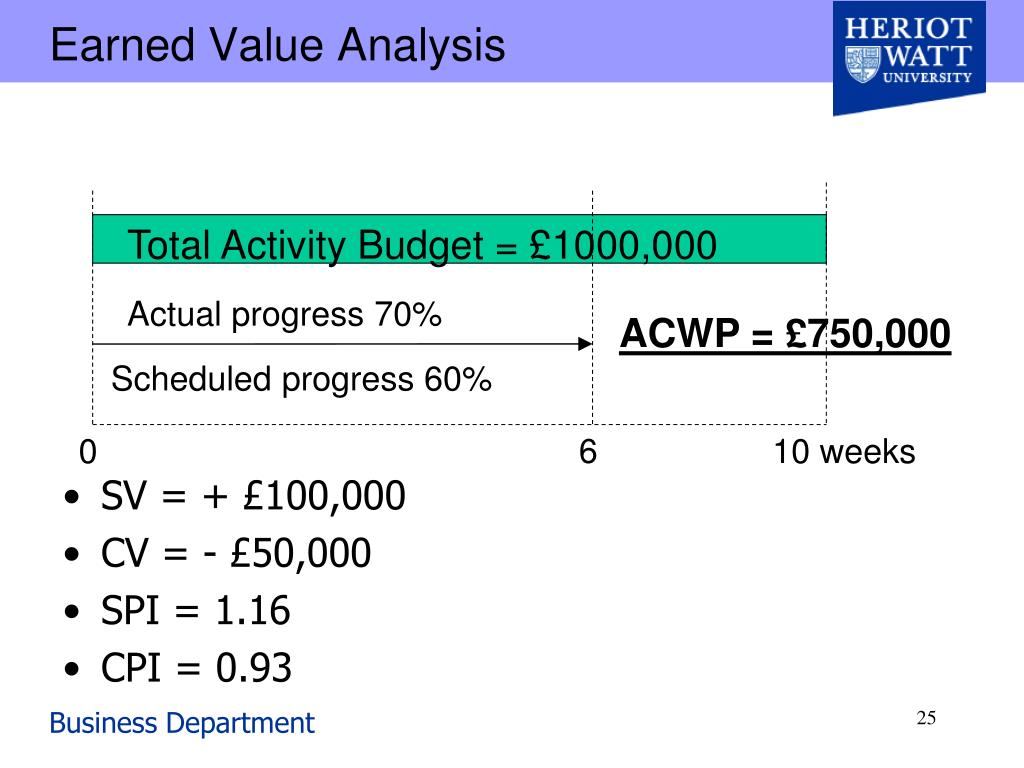

  25. Earned Value Analysis Total Activity Budget = £1000,000 Actual progress 70% ACWP = £750,000 Scheduled progress 60% 6 0 10 weeks • SV = + £100,000 • CV = - £50,000 • SPI = 1.16 • CPI = 0.93

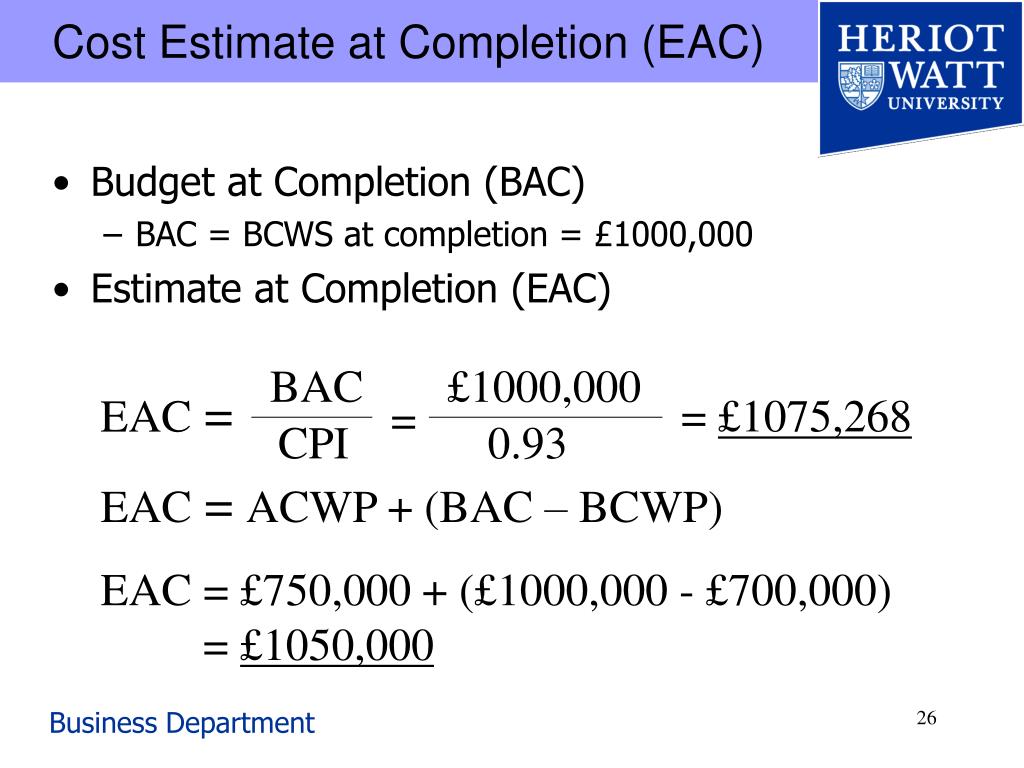

  26. £1000,000 BAC = £1075,268 = EAC = 0.93 CPI Cost Estimate at Completion (EAC) • Budget at Completion (BAC) • BAC = BCWS at completion = £1000,000 • Estimate at Completion (EAC) EAC = ACWP + (BAC – BCWP) EAC = £750,000 + (£1000,000 - £700,000) = £1050,000

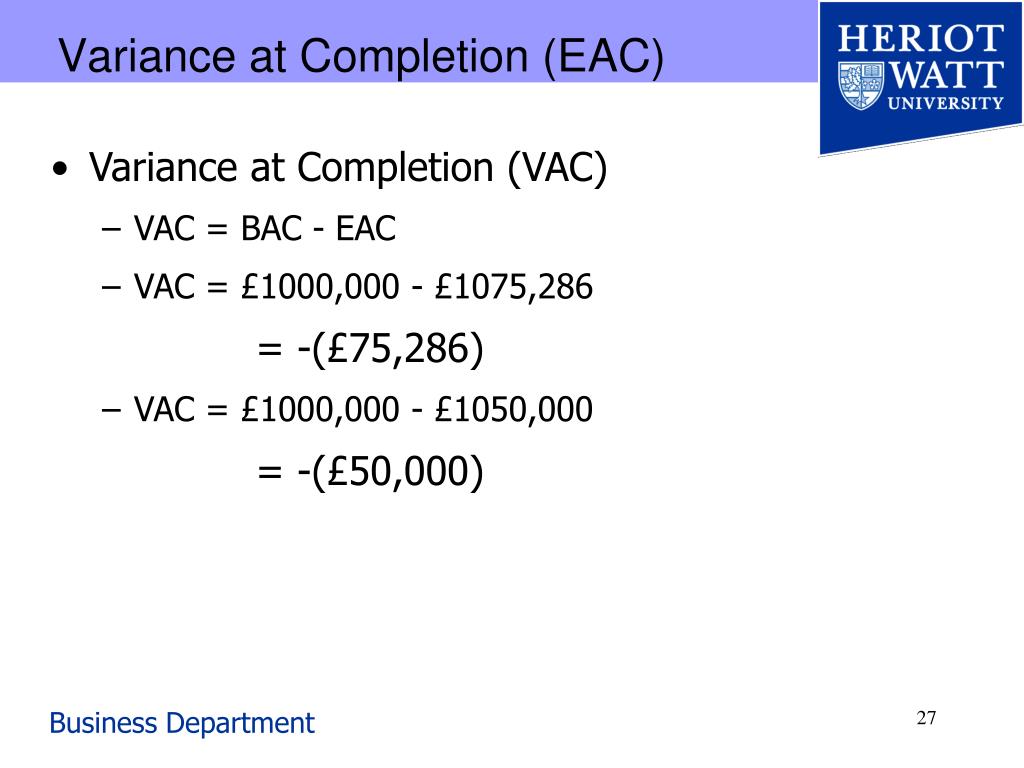

  27. Variance at Completion (EAC) • Variance at Completion (VAC) • VAC = BAC - EAC • VAC = £1000,000 - £1075,286 • = -(£75,286) • VAC = £1000,000 - £1050,000 • = -(£50,000)

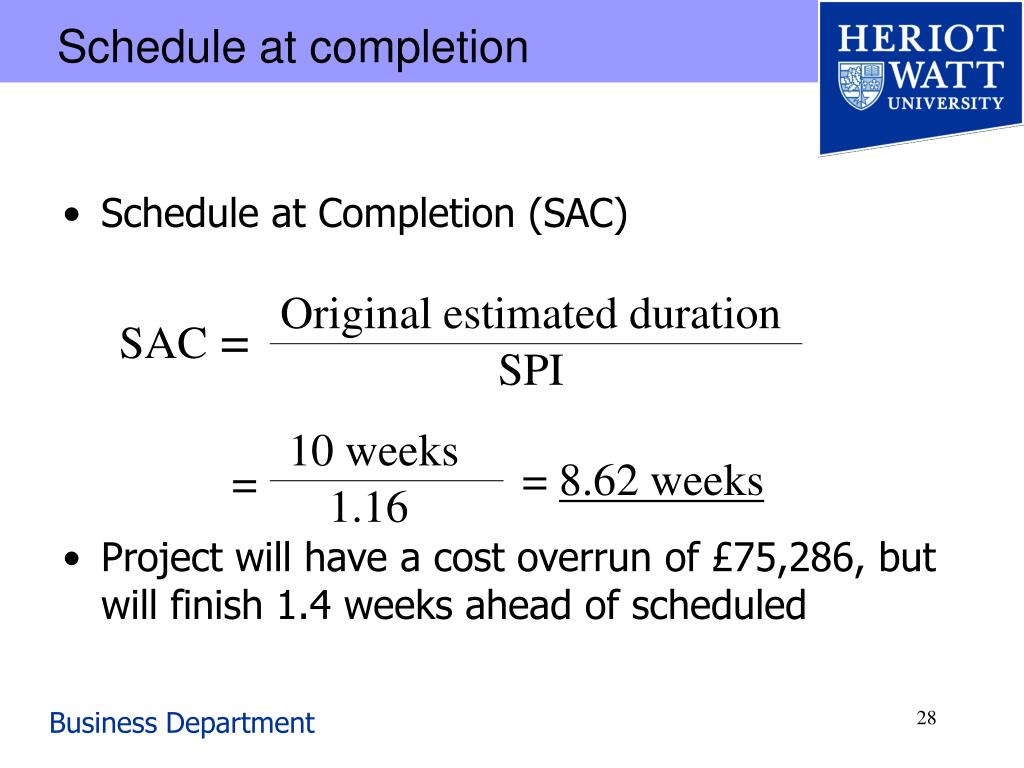

  28. Original estimated duration SAC = SPI 10 weeks = 8.62 weeks = 1.16 Schedule at completion • Schedule at Completion (SAC) • Project will have a cost overrun of £75,286, but will finish 1.4 weeks ahead of scheduled

  29. Summary - Session 8 • Difference between monitoring and control • Discussed processes for change management • Considered appropriate project control systems • Discussed two different methods of project control • Milestone & EVA • Identified three most important variables to measure in project control • ACWP, BCWP & BCWS • Explained EVA spreadsheet
