PROJECT MANAGEMENT USING EARNED VALUE (and the Problems & Lessons Learned from it)

PROJECT MANAGEMENT USING EARNED VALUE (and the Problems & Lessons Learned from it). Jim Pennington – Business Operations Director jim.pennington@lmco.com Dated November 2007. AGENDA OMB objections and requirements for EVMS What is EVMS? Implementing Directives

connor
Télécharger la présentation

PROJECT MANAGEMENT USING EARNED VALUE (and the Problems & Lessons Learned from it)

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. PROJECT MANAGEMENT USING EARNED VALUE (and the Problems & Lessons Learned from it) Jim Pennington – Business Operations Director jim.pennington@lmco.com Dated November 2007

  2. AGENDA • OMB objections and requirements for EVMS • What is EVMS? • Implementing Directives • Traditional versus Earned Value Accounting • How does EV fit into the Program Management Life Cycle • Problems and Lessons Learned over the PM EVM Life Cycle • Comments • Backup Charts • Essential Elements of EVM • Tailored Earned Value Management

  3. What is Earned Value and when does OMB want it implemented • According to the Third Edition of Earned Value Project Management by Fleming and Koppelman, • "Earned Value is a technique to better manage projects. It is not intended for use on continuing business processes, operations that have no unique deliverables. Earned Value is for the management of one-time-only projects, and portfolios of projects within an organization". • In alignment with this statement OMB mandates the use of EVMS within OMB Circular A-11 for major development/ modernization/enhancement (DME) projects, but not all DME projects. • OMB Circular A-11 defines a major project as: • A system or project requiring special management attention because of its importance to the mission or function of the Agency, a component of the Agency, or another organization; • Is for financial management and obligates more than $500,000 annually; • Has significant program or policy implications; • Has high executive visibility; • Has high development, operating, or maintenance costs; or • Is defined as major by the Agency’s capital planning and investment control process • In addition, OMB memorandum M-05-23 asked each agency to work with OMB to identify “high risk” projects by August 15, 2005. Circular A-11 defines high-risk projects as those requiring special attention from oversight authorities and the highest levels of agency management.

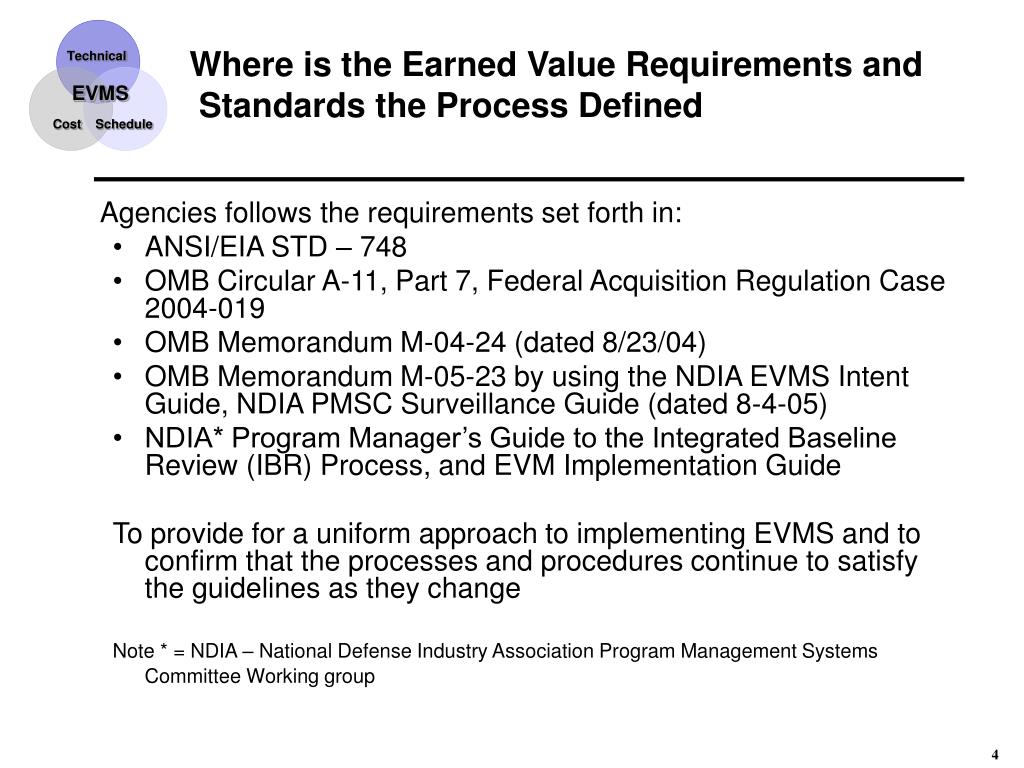

  4. Where is the Earned Value Requirements and Standards the Process Defined • Agencies follows the requirements set forth in: • ANSI/EIA STD – 748 • OMB Circular A-11, Part 7, Federal Acquisition Regulation Case 2004-019 • OMB Memorandum M-04-24 (dated 8/23/04) • OMB Memorandum M-05-23 by using the NDIA EVMS Intent Guide, NDIA PMSC Surveillance Guide (dated 8-4-05) • NDIA* Program Manager’s Guide to the Integrated Baseline Review (IBR) Process, and EVM Implementation Guide To provide for a uniform approach to implementing EVMS and to confirm that the processes and procedures continue to satisfy the guidelines as they change Note * = NDIA – National Defense Industry Association Program Management Systems Committee Working group

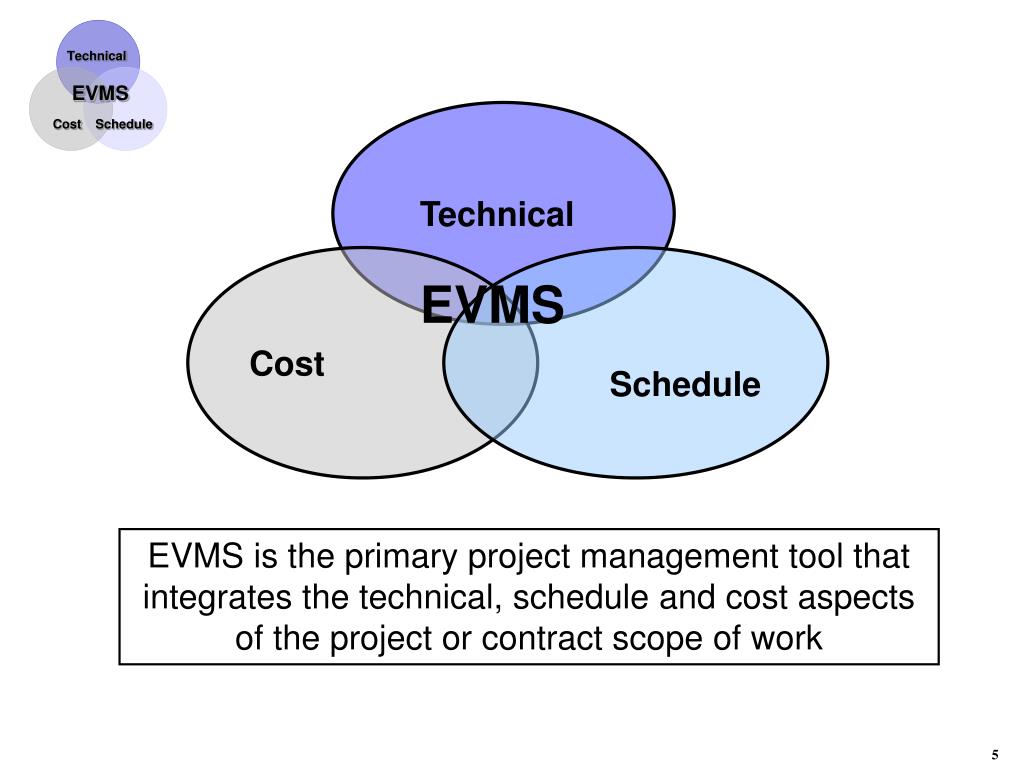

  5. Technical Cost Schedule EVMS EVMS is the primary project management tool that integrates the technical, schedule and cost aspects of the project or contract scope of work

  6. Why is Earned Value Information important to the Program Manager • A Program or Project’s Technical, cost and schedule performance are interrelated • Problems in one area can, and usually will, cause problems in the other areas • You can design and build the fastest, toughest and lightest widget in the world, but if it costs too much, or is late: • It may adversely affect the total funding required to complete • Could impact ability to get funding for future projects or may required greater effort to obtain enough funding for programs later in the future

  7. Earned Value(EV) • ...is a predetermined amount of value that is claimed, orearned, when the corresponding work is accomplished. Work Accomplished # of Pages # of Sys Reqmts Lines of Code # of Widgets Unit of Measure

  8. Earned Value Management provides • Objective rather than subjective project status information • Cost and Schedule impact of known problems • Identification of problems not previously recognized • Capability to trace the problem to the source • Quantitative measure of schedule deviation in dollars • Performance measured against a program oriented baseline EARNED VALUE DOES NOT GUARANTEE SUCCESS

  9. Some Implementing Directives • GOVERNMENT • Mandatory procedures for major defense acquisition programs (DoDI 5000.2-R) • Defines policies governing earned value • Earned Value Management Information Guide (EVMIG) • Provides detailed discussions of the EV criteria • Written for the Government program offices • OMB Directives to Agencies: • OMB Circular A-11, Part 7, Federal Acquisition Regulation Case 2004-019 • OMB Memorandum M-04-24 (dated 8/23/04) • OMB Memorandum M-05-23 by using the NDIA EVMS Intent Guide, NDIA PMSC Surveillance Guide (dated 8-4-05) INDUSTRY • Industry guidelines for Earned Value Management Systems (ANSI-ESI 748) • Industry Standard for Earned Value • Incorporated in DoDI 5000.2R

  10. Earned Value Management Terms ACWP = Actual cost of work performed (Basically costs extracted from work in process) BCWP = Budgeted cost of work performed (Earned Value) BCWS = Budgeted cost of work scheduled (Budget spread to time) BAC = Budget at completion (Total budget for a given task) CVAR = Cost variance (BCWP-ACWP) EAC = Estimate at completion SVAR = Schedule variance (BCWP-BCWS)

  11. TRADITIONAL VS EARNED VALUE ACCOUNTING Budget versus Actuals TimeNow Time All we really know is that we spent more than we planned

  12. TRADITIONAL VS EARNED VALUE ACCOUNTING (Using EVM approach) TimeNow Time Earned value provides an objective measure of work accomplished. It tells you what you got for what you spent

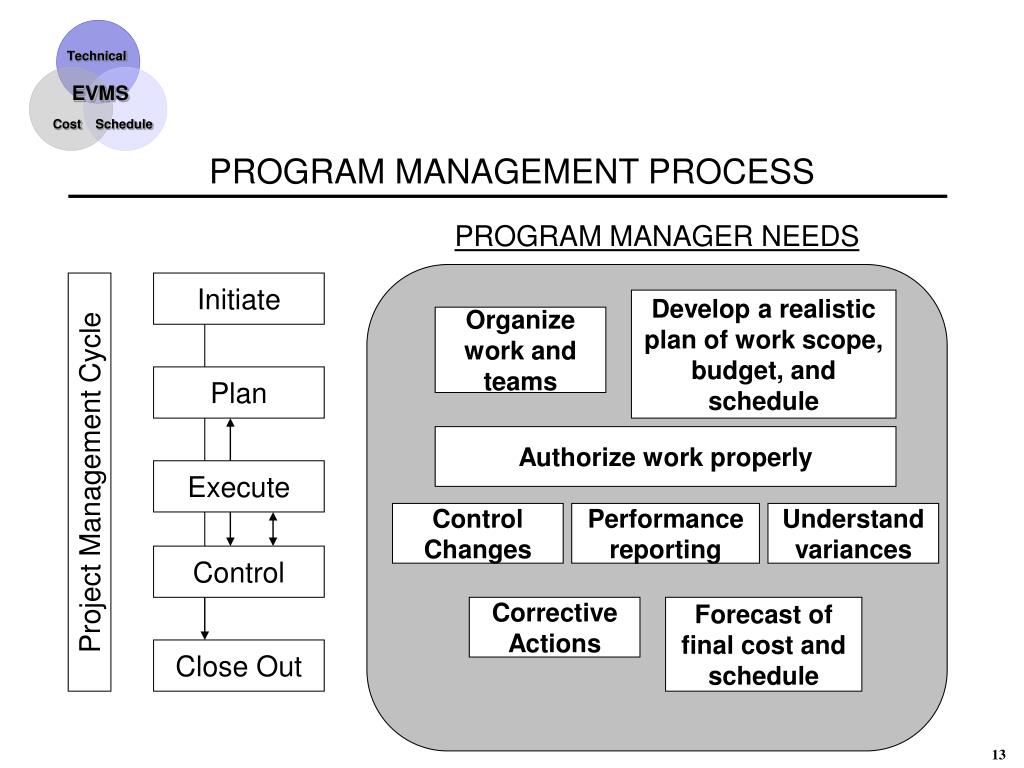

  13. PROGRAM MANAGEMENT PROCESS PROGRAM MANAGER NEEDS Initiate Develop a realistic plan of work scope, budget, and schedule Organize work and teams Plan Authorize work properly Project Management Cycle Execute Control Changes Performance reporting Understand variances Control Corrective Actions Forecast of final cost and schedule Close Out

  14. EARNED VALUE MANAGEMENT Organize Plan work scope – schedule and budget Authorize work Control changes Report performance Understand variances Corrective actions Forecast final cost and schedule PROGRAM MANAGEMENT PROCESS Initiate Plan Project Management Cycle Execute Control Close Out

  15. Earned Value Problems • & • Lessons Learned • over the Program Management • EVM Life Cycle

  16. Initiate Phase of ProgramProblems and Lessons Learned • Lessons Learned • Establish early baseline basis • Have contractor or internal personnel identified during negotiations • PMs must plan to execute program like it was proposed (Work per SOW) • Have Program Team (PMs, CAMs, EVM and Customer) trained together • Establish specific contract SOW app. for EVM and for Integrated Schedule • Keep CO and COTR (& PM) diligent on proper contracting practices • Develop clear walkdown of deltas in Scope and assumptions (document) • Variance Thresholds by % & $ off plan • Analysis must be to a specific level of WBS, contents identified & Corr. Action • Problems • Baseline is not stable • EVM Staffing Resources not in place at time of ATP • Program Management as not assigned responsibilities to CAMs • Program Team is not experienced or trained • IBR (Integrated Baseline Review) Deliverables not defined • Contracting Officer or COTR wants to deviate from SOW or Contract EVM direction w/o proper modifications • Different set of assumptions from the proposal submittal • Variance Thresholds are not defined • Variance Analysis Guidelines not agreed upon prior to start

  17. Planning Phase of ProgramProblems and Lessons Learned • Lessons Learned • Establish a EVM Implementation schedule and hold everyone to it • IPTs must complete earlier for IMS integration with other teams and tasks • Contractor should be able to walkdown Proposal as Submittal to IBR Baseline • Push to hold IBR schedule and work SOW, schedule or scope changes later (as formal changes / plan maintenance) • Must have established CCB with PM, Finance, Contracts, IPTs (Govt / Contr) • Undistributed Budget is not Reserve, if it is not needed convert to PM Reserve • Only Customer approved changes impact the Baseline (Establish a window for change approval and freeze the plan for near term changes) • Problems • No set deadline to freeze plan (Continuous Churn) • IPTs (Integrated Product Teams) are not working to same schedule • Baseline Changes are not controlled at the beginning (Loss of string from Prop to Baseline-Rates, Sch, Scope) • IBR (Integrated Baseline Review) delayed due to baseline flux or continued negotiations • No plan for Contract Changes (No CCB board and/or no COTR involved ) • Program Management Reserve and Undistributed Budget not well defined • Current Forecasts and recovery plans do not change the baseline planning

  18. Execution Phase of ProgramProblems and Lessons Learned • Lessons Learned • Establish a EVM Status and Reporting Business Rhythm • EVM Staffing Resources not in place at time of ATP • Must have EV method and completion criteria defined for tasks (agreed upon) • CAM/EV data reviews prior to release • Establish a ICD approach for Vendor and Subcontractor Accruals / Receipts • Have defined reconciliation process to validate EVM ACWP reported & deltas • Make EV data part of monthly review deliverables and status reviews • Report number of late IMS workpackage starts and completions by WBS • Risks that have not been realized should have MR allotted plus mitigation plans • Problems • Program seems to not meet the EVM reporting schedule • Status or Earned Performance inputs are not consistent with period cutoffs • No established Performance Criteria identified for tasks and completion • Errors or Inconsistent Reporting • Inconsistent Subcontractor or Procurement Status • No reconciliations of Ledger Actuals to EVM (Accrued Costs) • Program Management does not use or analyze the EVM information • PMs manage to the IMS or Schedule and EVM data must be incorrect • Program Plan Risks are not defined or PM Reserve is not earmarked

  19. Control Phase of ProgramProblems and Lessons Learned • Lessons Learned • CCB process should be defined and IPT provide estimates at CCB meetings • EVM and variance root cause analysis must be timely to be effective • IPT must be given labor reports by name to validate charges and resp. • Program should establish a over target or baseline replan to make plan valid • You must close incomplete tasks and replan them as new tasks with replan • Small unapproved changes and creep drive variances & impacts future work • Contractor should have proven and documented process to operate consistently • Establish a Joint Surveillance Plan • Problems • Contract Changes are too frequent and formal plan changes are not timely • Variance Analysis is too vague or is not determined in a timely manner • IPTs do not take ownership of their variances or mitigation plans • Program has a large cost and/or schedule variance that plan is relevant • Program does not properly close workpackages when replanned • Scope Creep and workscope/rate trades from well minded PMs and CO/COTRs • Inconsistent EVM performance and reporting over the life of the program • EVM process adherence is not objectively evaluated or tested

  20. Close Out Phase of Program (or task)Problems and Lessons Learned • Lessons Learned • Be sure contractor does not get sloppy w/ charging practices (>95%) • Be sure final EACs include remaining material commitments, labor suspense • Be sure all charge accounts closed, clear suspense & transfer bad charges • Understand contractor financial calendar and rate adjustment process • Have contractor complete a walk-down of the EVM ACWP and the ledger $s • Contractor should create a projection when all costs will be final and on the books of record • Problems • Last months of program, data appears to be incorrect • Final Estimates to Complete are off by a large amount • Costs continues to come into the workpackage after it is completed • Indirect rate impacts hit after the program or task is completed • Subcontract or Material Costs does not match Ledger • Final EVM Report does not match current Invoice Totals or Balances

  21. Closing Comments • With the problems on the FBI Virtual Case File Program, IT programs will continue to have additional OBM scrutiny and needs for oversight • If you are going to spend the money on EVM, use it (effectively!) • Manage the EVM process, do not let the process manage you • Do not just look at the big variances, drive for better analysis and corrective actions that are meaningful (remember you have a boss too!) • One little rule: If your TCPI is 1.06 after being more than 15%, • You will not recover to the original baseline! (LMC history)

  22. Questions and Answers • Comments or Questions??
