1 / 17

Hierarchically Structured Integrated Multi-scale Approach Hlynur Stefansson and Prof. Nilay Shah

Multi-scale Planning and Scheduling Under Uncertain and Varying Demand Conditions in the Pharmaceutical Industry. Hierarchically Structured Integrated Multi-scale Approach Hlynur Stefansson and Prof. Nilay Shah Centre for Process Systems Engineering Imperial College London. Overview.

dard
Télécharger la présentation

Hierarchically Structured Integrated Multi-scale Approach Hlynur Stefansson and Prof. Nilay Shah

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Multi-scale Planning and Scheduling Under Uncertain and Varying Demand Conditions in the Pharmaceutical Industry Hierarchically Structured Integrated Multi-scale Approach Hlynur Stefansson and Prof. Nilay Shah Centre for Process Systems Engineering Imperial College London

  2. Overview • Introduction • Project objectives • Case study • Proposed approach • Models • Solution procedure • Results • Conclusions

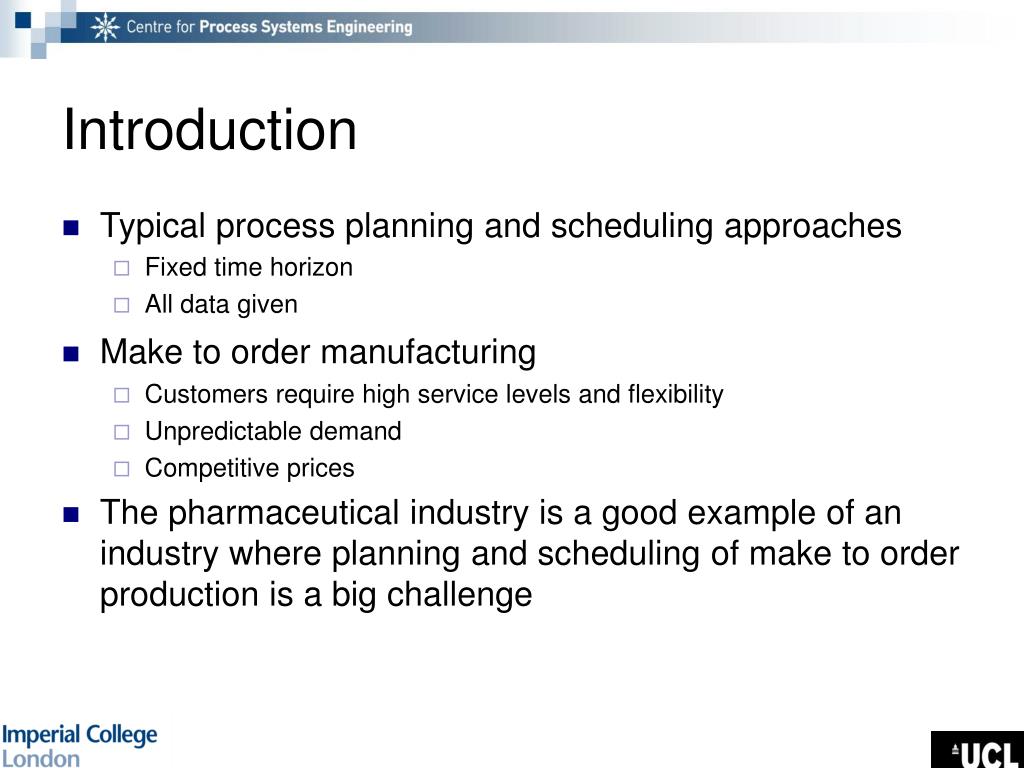

  3. Introduction • Typical process planning and scheduling approaches • Fixed time horizon • All data given • Make to order manufacturing • Customers require high service levels and flexibility • Unpredictable demand • Competitive prices • The pharmaceutical industry is a good example of an industry where planning and scheduling of make to order production is a big challenge

  4. Project Objectives • We propose an approach for a continuous and dynamic planning and scheduling process • Decisions have to be made before all data are available • Objectives • An effective approach • A combination of a proactive and reactive planning • Accurate and efficient optimisation models and solution procedures • Decision support for actual MTO planning and scheduling problems

  5. Case Study – Problem Description • Actavis is one of the five largest generic pharmaceutical companies in the world • Single plant planning and scheduling for a secondary pharmaceutical production plant • Production environment • Over 40 product families and 1000 stock keeping units • 4 production stages with a large number of multi-purpose production equipment • Campaign production operating in batch mode

  6. Case Study – Problem Description • Online and dynamic characteristics • A campaign plan made for long term planning • Each week the plant receives new customer orders with requested delivery date, feedback given to customers with confirmed delivery dates • Final detailed schedule made before production starts

  7. Integrated Multi-Scale Algorithm • Multi-scale modelling is emerging as an interesting scientific field in process systems engineering • The idea of multi-scale modelling is straightforward: • Compute information at a smaller (finer) scale and pass it to a model at a larger (coarser) scale by leaving out degrees of freedom as moving from finer to coarser scales

  8. Integrated Multi-Scale Algorithm • Integrated multi-scale approach based on a hierarchically structured framework • Optimisation models to provide support for the relevant decisions at each level • Levels are diverse regarding aggregation, time horizon and availability of information at the time applied

  9. campaigns with different product groups Model for level 1 • Objectives: Campaign planning to fulfil demand and minimize production cost • Input: Combination of sales forecasts and long-term orders, information regarding products, production process, performance and current status, • Output: Campaign plan, raw material procurement plans • Horizon: 12 months • Frequency: Every 3 months • Formulation: MILP - Discrete time and an iterative proced. to improve robustness

  10. Robustness criteria depends on the required service level Model for level 1 • Forcast errors analysed and a more robust plan obtained with an iterative MILP + LP procedure

  11. campaigns with different product groups specific orders Model for level 2 • Objectives: Simultaneous campaign planning and order scheduling, minimize delays and production cost • Input: Customer orders, information regarding products, production process, performance and current status • Output: Campaign plan, order allocation and confirmed delivery dates • Horizon: 3 months • Frequency: Every week • Formulation: MILP - Discrete time

  12. campaigns with different product groups production tasks within campaigns Model for level 3 • Objectives: Detailed production scheduling with exact timing of all setup, production and cleaning tasks, minimize delays and production cost • Input: Confirmed customer orders, information regarding products, production process, performance and current status • Output: Detailed production schedule with exact timing of all tasks • Horizon: 1 month • Frequency: Every day • Formulation: MILP - Continuous time

  13. Information is transferred between levels with: Hard constraints Bounds on variables Shaping methods Penalty functions Feasible solutions can still be obtained when the guidelines are violated although they become less optimal Integration of levels

  14. Formulation – Solution Procedure • The MIP models become very large in order to fulfil actual industrial requirements • Standard solution methods are insufficient • Decomposition heuristics with pre- and post-processing procedures Optimisation with decomposition heuristics Pre-processing Post-processing subtracts knowledge from data and makes optimisaiton models tractable improves the solutions

  15. Computational Results • Full scale test cases based on data collected in the production plant • An example of computational results:

  16. Conclusions • There is a need for designing and applying integrated multi-scale procedures for specific types of planning and scheduling problems in the process industry • Benefits: • Solutions of improved quality • More efficient planning and scheduling process within acceptable computational time • Improved customer service by faster response driven by optimisation models • Work remains on the robustness procedure at the top level and further testing of the MIA in the factory

  17. Multi-scale Planning and Scheduling Under Uncertain and Varying Demand Conditions in the Pharmaceutical Industry Hierarchically Structured Integrated Multi-scale Approach Hlynur Stefansson and Prof. Nilay Shah Centre for Process Systems Engineering Imperial College London
