1 / 27

Primal-Dual Algorithms for Connected Facility Location

Primal-Dual Algorithms for Connected Facility Location. Chaitanya Swamy Amit Kumar Cornell University. Connected Facility Location (ConFL). Graph G=(V,E) , costs {c e } on edges and a parameter M ≥ 1. F : set of facilities . D : set of clients ( demands ).

deion
Télécharger la présentation

Primal-Dual Algorithms for Connected Facility Location

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Primal-Dual Algorithms for Connected Facility Location Chaitanya Swamy Amit Kumar Cornell University

  2. Connected Facility Location (ConFL) Graph G=(V,E), costs {ce} on edges and a parameter M ≥ 1. F : set of facilities. D : set of clients(demands). Facility i has facility costfi. cij : distance between i and j in V. facility client node ALADDIN Workshop, 10/2002

  3. Pick a set A of facilities to open. • Assign each demand j to an open facility i(j). • Connect all open facilities by a Steiner treeT. open facility facility client Steiner tree We want to : Cost=iÎA fi+jÎD ci(j)j+M eÎT ce =facility opening cost+ client assignment cost +cost of connecting facilities. ALADDIN Workshop, 10/2002

  4. Previous Work • Ravi & Selman : Look at related problem - connect facilities by a tour. Round optimal solution of an exponential size LP. • Karger & Minkoff : Combinatorial algorithm with ‘large’ constant approx. ratio. • Gupta, Kleinberg, Kumar, Rastogi & Yener : Also use LP rounding. Get a 9.001-approx. if F =V, fi = 0 for all i, a 10.66-approx. in the general case. • Guha, Meyerson & Munagala; Talwar : Gave a constant approx. for the single-sink buy-at-bulk problem. ALADDIN Workshop, 10/2002

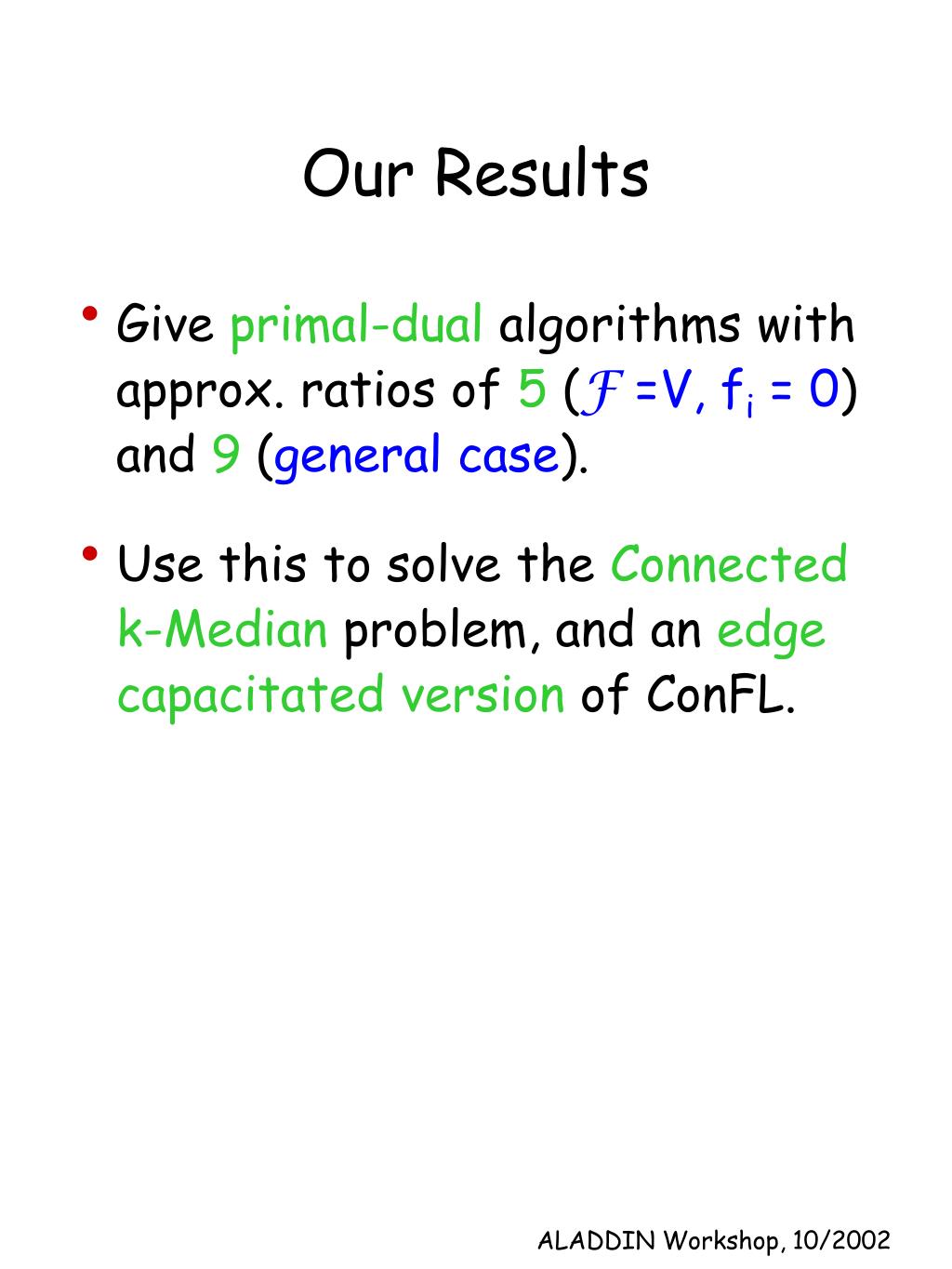

  5. Our Results • Give primal-dual algorithms with approx. ratios of 5 (F =V, fi = 0) and 9 (general case). • Use this to solve the Connected k-Median problem, and an edge capacitated version of ConFL. ALADDIN Workshop, 10/2002

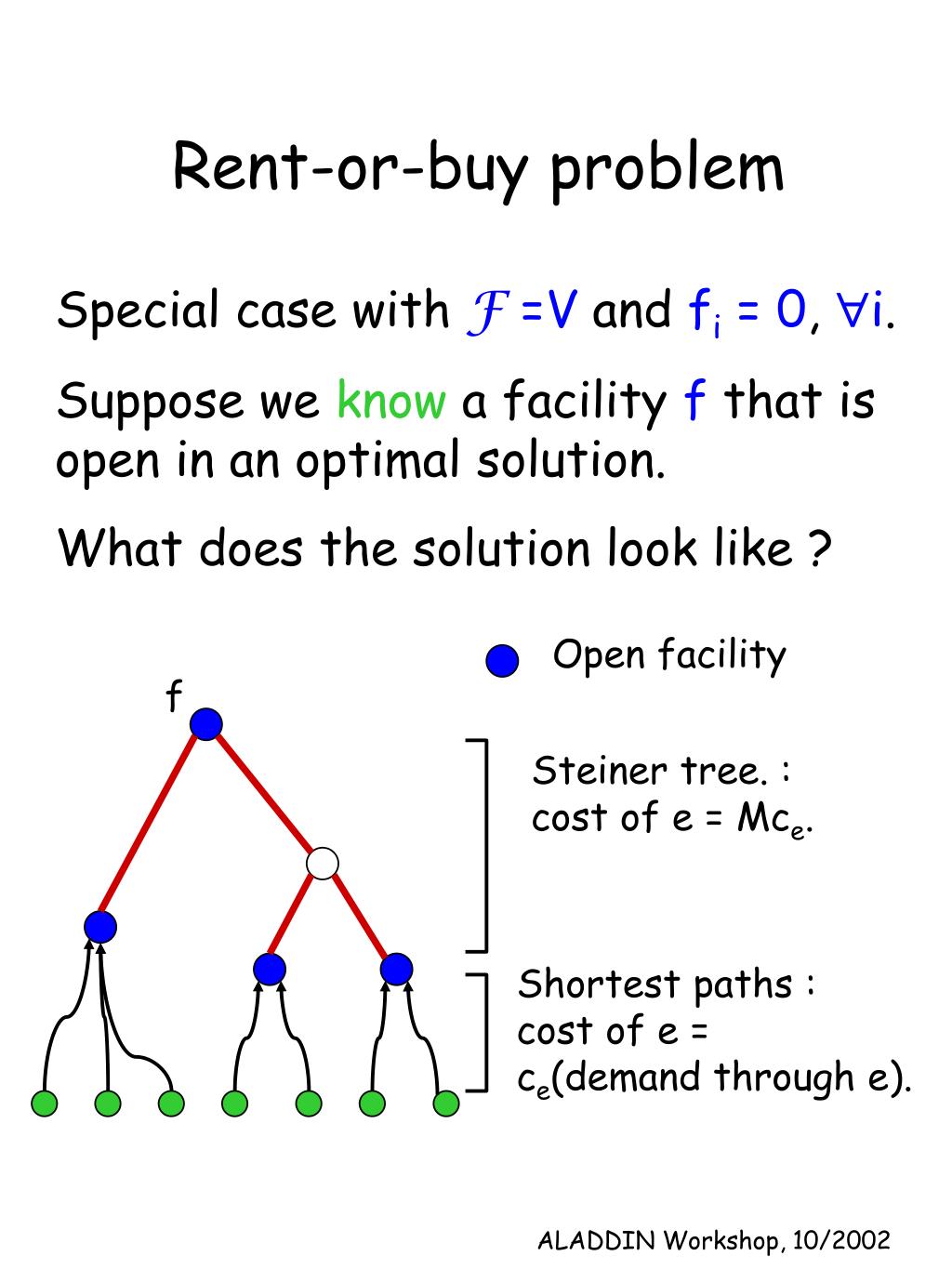

  6. Rent-or-buy problem Special case with F =V and fi = 0,"i. Suppose we know a facility f that is open in an optimal solution. What does the solution look like ? Open facility f Steiner tree. : cost of e = Mce. Shortest paths : cost of e = ce(demand through e). ALADDIN Workshop, 10/2002

  7. Equivalently, Want to route traffic from clients to f by installing capacity on edges. 2 choices : I : Rent Capacity cost µrented capacity (Shortest Paths) II : Buy Capacity fixed cost, ∞ capacity (Steiner Tree) cost cost M capacity capacity ConFLºsingle-sink buy-at-bulk problem with 2 cable types and sinkf. ALADDIN Workshop, 10/2002

  8. C*, S* : assignment, Steiner cost of OPT. OPT S* Total cost of adding edges ≤C*+C. C* Opt. Steiner tree on ≤S*+C*+C. ÞS ≤ 2(S*+C*+C) Þget an O(1)-approx. Design Guideline Cluster enough demandat a facility before opening it. Suppose we run a g-approx. algorithm for FL, and each open facility serves ≥ M clients. C ≥ M ALADDIN Workshop, 10/2002

  9. f S j An Integer Program xij = 1if demandjis assigned toi. ze = 1if edgeeis included in the Steiner tree. • Min.j,i cijxij + Me ceze(primal) • s.t. • i xij≥ 1 j • iÎS xij ≤ eÎ(S)ze • S ÍV : fÏS, j • xij, ze Î {0, 1} (1) Relax (1) to xij, ze≥ 0 to get an LP. ALADDIN Workshop, 10/2002

  10. f S:eÎd(S),fÏS yS ≤ Mce cij Max. j vj j Any feasible dual solution is a lower bound on OPT–Weak Duality. What is the dual? vjº amount j is willing to ‘pay’ to route its demand to f. Let yS = j yS,j. {yS }º moat packing around facilities. vj ≤ cij + S:iÎS,fÏS yS,j ALADDIN Workshop, 10/2002

  11. The Algorithm • Decide which facilities to open, cluster demands around open facilities. Construct a primal soln. and dual soln. (v,y) simultaneously. • Build a Steiner tree on open facilities. • The following will hold after 1) : • (v,y) is a feasible dual solution. • j is assigned to i(j) s.t. ci(j)j ≤ 3vj. • Each open facility i has ≥ M clients, {j}, assigned to it s.t. cij ≤ vj. ALADDIN Workshop, 10/2002

  12. can amortize thecost against demands in Di. Di ≥ M i So, S ≤ 2(S*+ C*+ jÎD1 vj). Analysis Suppose the 3 properties hold. Let A be the set of facilities opened, Di= {j assigned to i : cij ≤ vj } for iÎA. Then, |Di| ≥ M. Let D1= UiÎA Di. C ≤ jÎD1 vj + jÏD1 3vj. ALADDIN Workshop, 10/2002

  13. C*, S* : assignment, Steiner cost of OPT. OPT S* Total cost of adding edges ≤C*+C. C* Opt. Steiner tree on ≤S*+C*+C. ÞS ≤ 2(S*+C*+C) Þget an O(1)-approx. Design Guideline Cluster enough demandat a facility before opening it. Suppose we run a g-approx. algorithm for FL, and each open facility serves ≥ M clients. C ≥ M ALADDIN Workshop, 10/2002

  14. can amortize thecost against demands in Di. Di ≥ M i So, S ≤ 2(S*+ C*+ jÎD1 vj). Total cost ≤2(S*+ C*) + 3 jÎD vj ≤ 5 OPT. Analysis Suppose the 3 properties hold. Let A be the set of facilities opened, Di= {j assigned to i : cij ≤ vj } for iÎA. Then, |Di| ≥ M. Let D1= UiÎA Di. C ≤ jÎD1 vj + jÏD1 3vj. ALADDIN Workshop, 10/2002

  15. Phase 1 Simplifying assumption – can open a facility anywhere along an edge. locations Notion of time, t. Start at t=0. Initially vj = 0, j. f is tentatively open, all other locations are closed. Say j is tight with i (has reached i) if vj ≥ cij. Sj is set of vertices j is tight with. ALADDIN Workshop, 10/2002

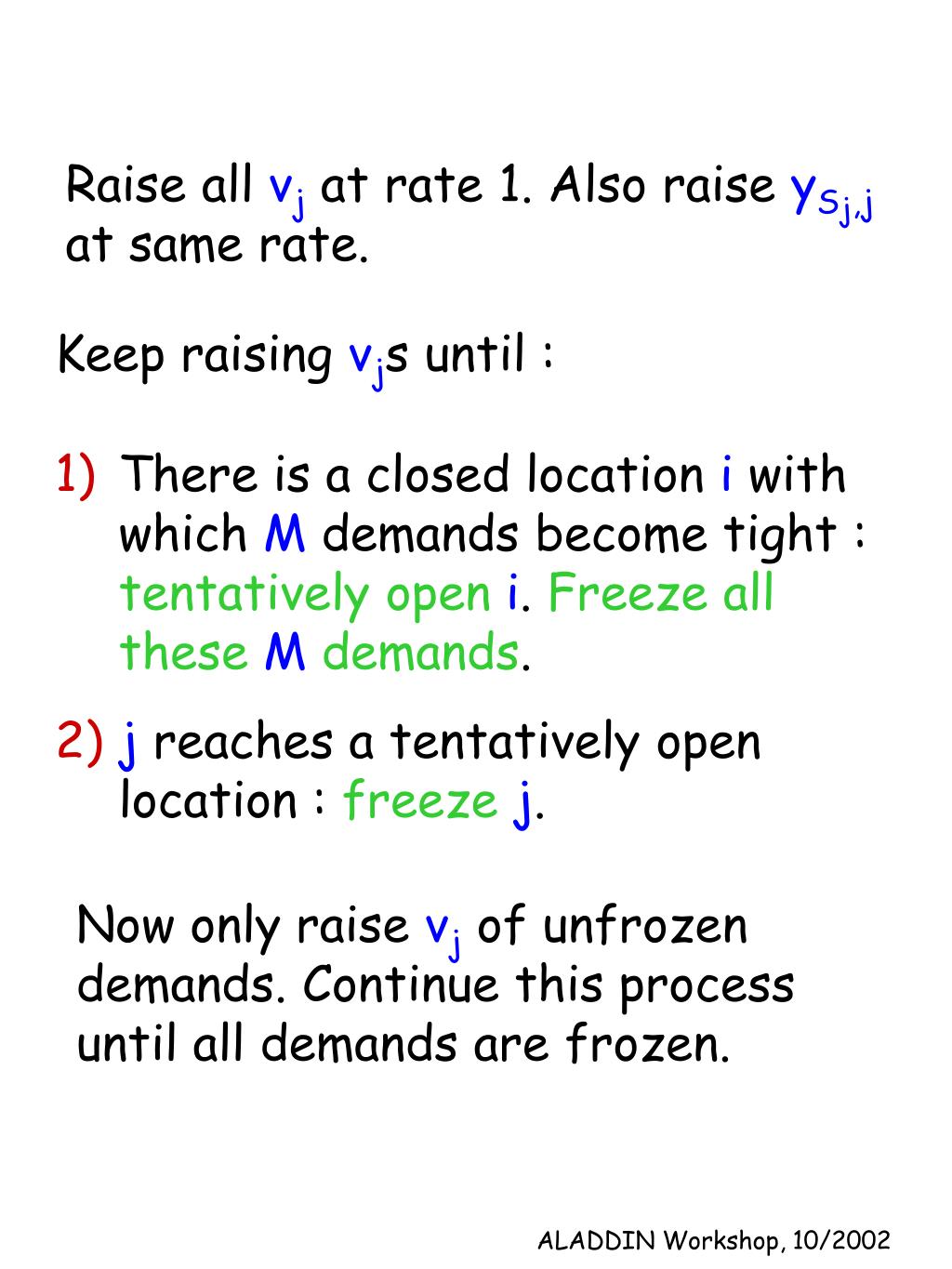

  16. Raise all vj at rate 1. Also raise ySj,j at same rate. • Keep raising vjs until : • There is a closed location i with which M demands become tight : tentatively openi. Freeze all these M demands. • j reaches a tentatively open location : freezej. Now only raise vj of unfrozen demands. Continue this process until all demands are frozen. ALADDIN Workshop, 10/2002

  17. M=2, time t=1 tentatively open location not open location unfrozen demand Execution of the algorithm M=2, time t=0 f ALADDIN Workshop, 10/2002

  18. frozen demand Execution of the algorithm M=2, time t=2 f tentatively open location not open location unfrozen demand ALADDIN Workshop, 10/2002

  19. tentatively open location not open location unfrozen demand frozen demand Execution of the algorithm M=2, time t=3 f vj=t=3 j ALADDIN Workshop, 10/2002

  20. Say i, l are dependent if Di Ç Dl¹ f. Pick an indepdt. set of locations, A ÍA’ and open these. Initially A =f. Consider locations in order of ­ti. If A U {i} is independent add i to A. Here order is 0,1,2,3,4 so A={0,1,3}. Opening locations • Let i be tentatively open. • Di= {j : j is tight with i }. • ti= time when i was tent’vely opened. • Note, |Di|≥M. But the Dis may not be disjoint. 2 f 0 1 3 4 ALADDIN Workshop, 10/2002

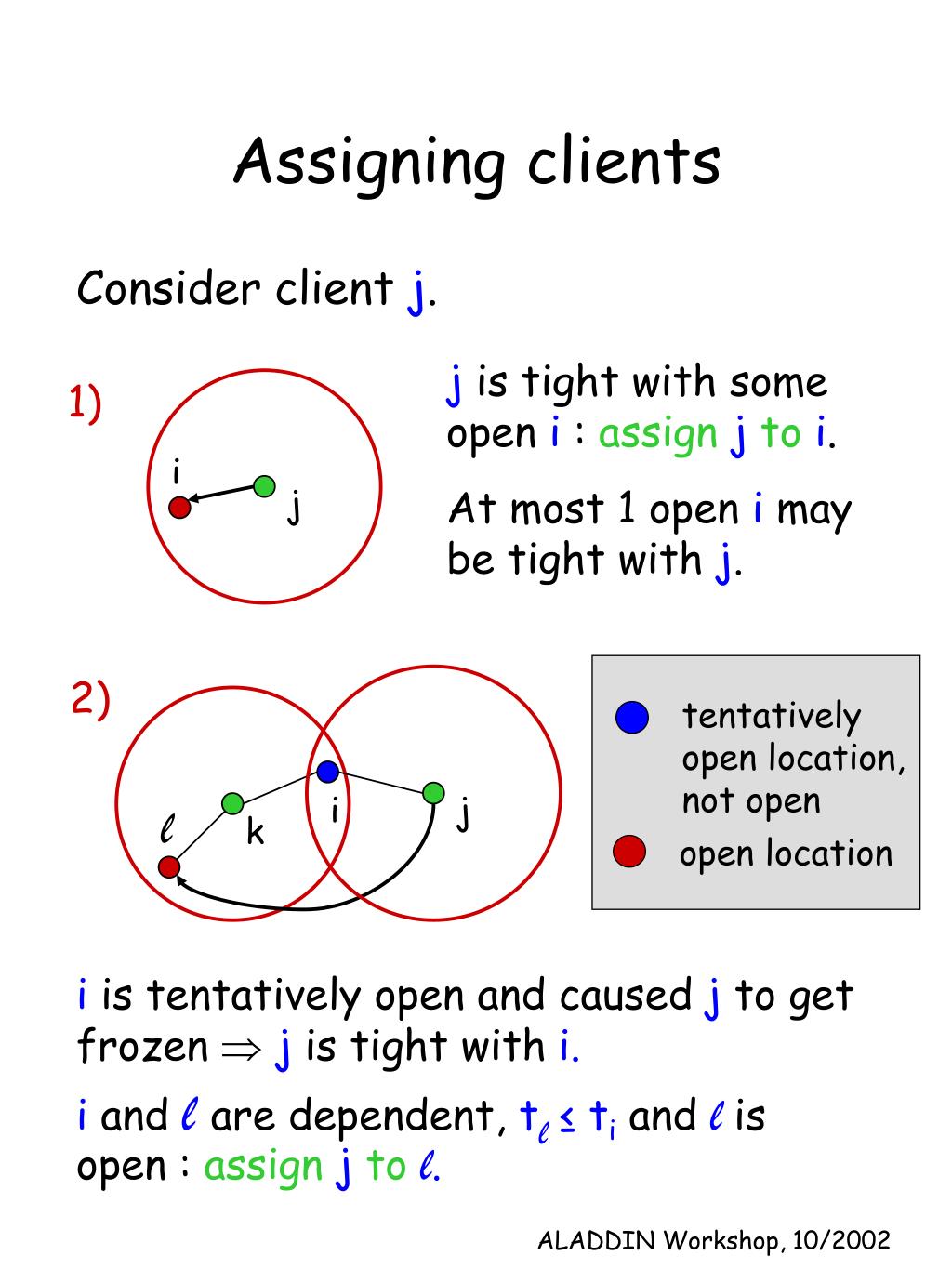

  21. j is tight with some open i : assign j to i. At most 1 open i may be tight with j. 1) i j 2) tentatively open location, not open i j l k open location i is tentatively open and caused j to get frozen Þ j is tight with i. i and l are dependent, tl ≤ ti and l is open : assign j to l. Assigning clients Consider client j. ALADDIN Workshop, 10/2002

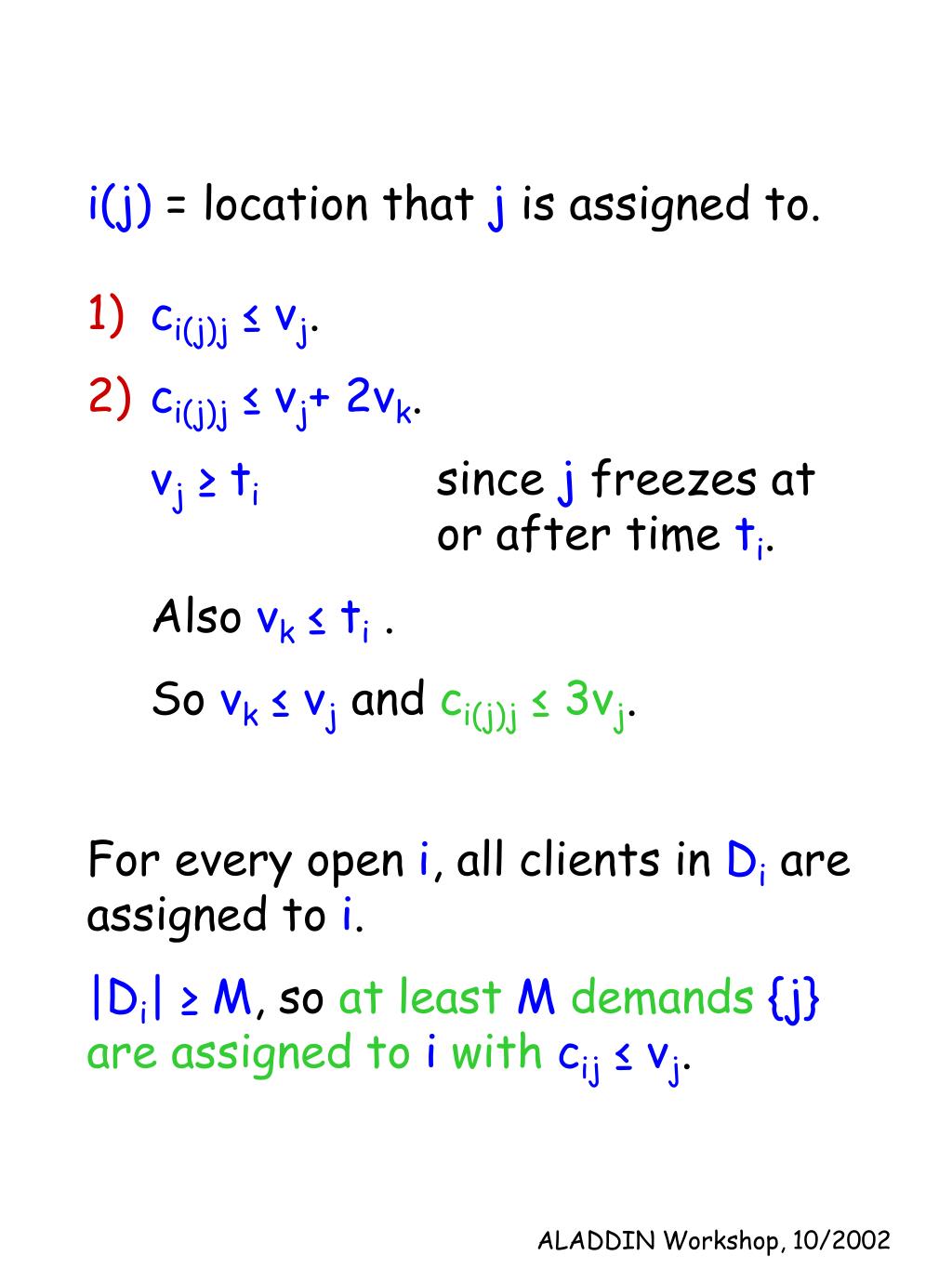

  22. i(j) = location that j is assigned to. • ci(j)j ≤ vj. • ci(j)j ≤ vj+ 2vk. • vj ≥ ti since j freezes at or after time ti. • Also vk ≤ ti. • So vk ≤ vj and ci(j)j ≤ 3vj. For every open i, all clients in Di are assigned to i. |Di| ≥ M, so at leastMdemands{j}are assigned toiwithcij ≤ vj. ALADDIN Workshop, 10/2002

  23. vj ≤ cij + S:iÎS,fÏS yS,j Once j reaches i, set Sjincludes i and ySj,j is increasing at same rate as vj. vj j cij i Sj j S:eÎd(S),fÏS yS,j ≤ Mce M=3 j(S yS,j) = pÎe(#of across p) ≤ pÎe M = Mce. e ≤ M at any location Putting it together Need to show that (v,y) is feasible. ALADDIN Workshop, 10/2002

  24. Done? Almost… Could have opened non-vertex locations. Fix : Move all such locations to vertices. Cost only decreases ! e.g., ≥ M Theorem : The above algorithm is a 5-approx. for rent-or-buy. ALADDIN Workshop, 10/2002

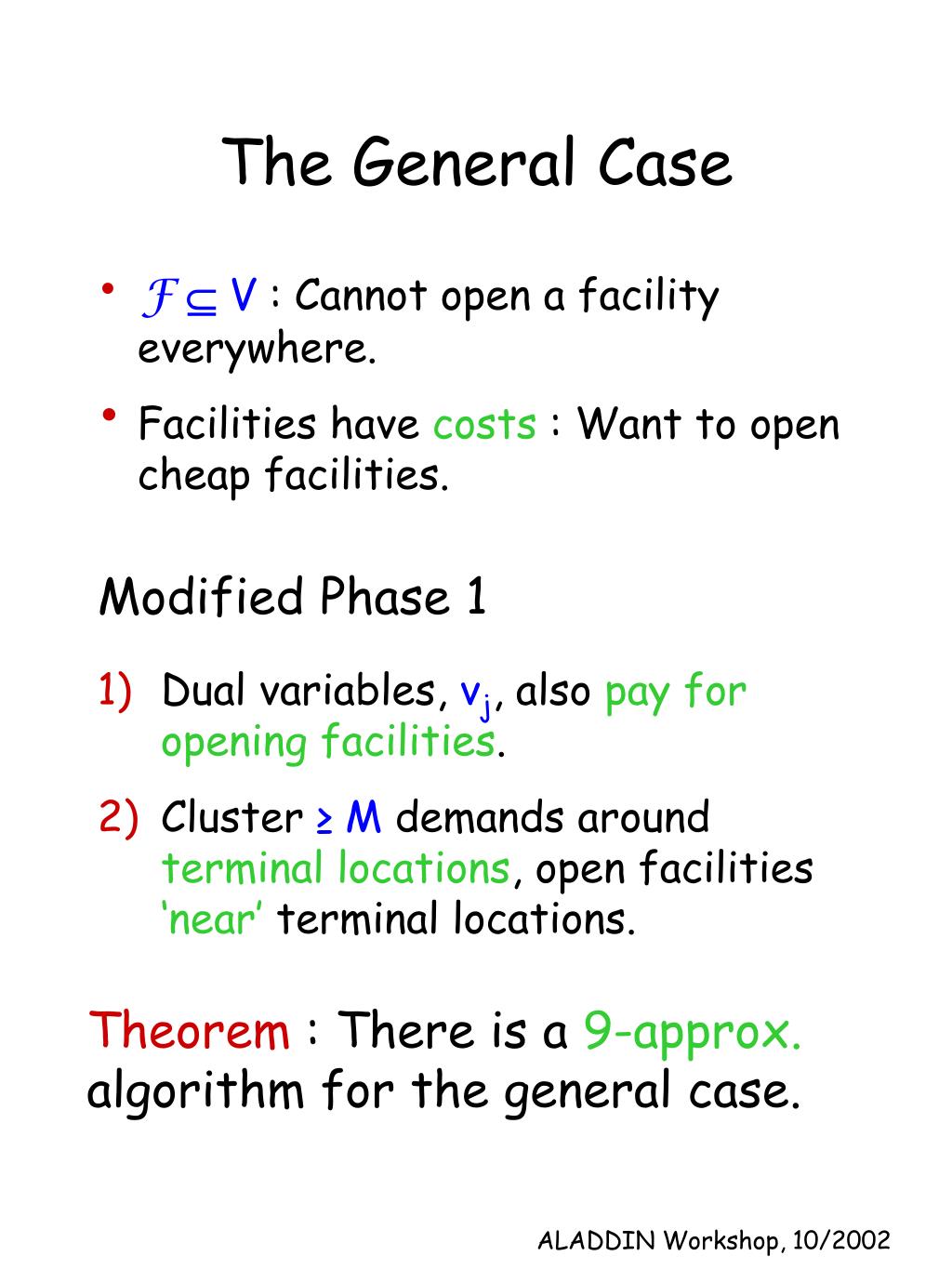

  25. The General Case • FÍ V : Cannot open a facility everywhere. • Facilities have costs : Want to open cheap facilities. • Modified Phase 1 • Dual variables, vj, also pay for opening facilities. • Cluster ≥M demands around terminal locations, open facilities ‘near’ terminal locations. Theorem : There is a 9-approx. algorithm for the general case. ALADDIN Workshop, 10/2002

  26. open facility 2(S*+ C*+ jÎD1 vj). Total cost ≤2(S*+ C*) + 7 jÎD vj ≤ 9 OPT. Let A be the set of terminal locations, Di= {j : cij ≤ vj } for iÎA. We ensure |Di| ≥ M. Let D1= UiÎA Di. Can show, F + C ≤ jÎD1 3vj + jÏD1 7vj. ≤2 minjÎDi vj Di ≥ M i S ≤ jÎD1 2vj + ALADDIN Workshop, 10/2002

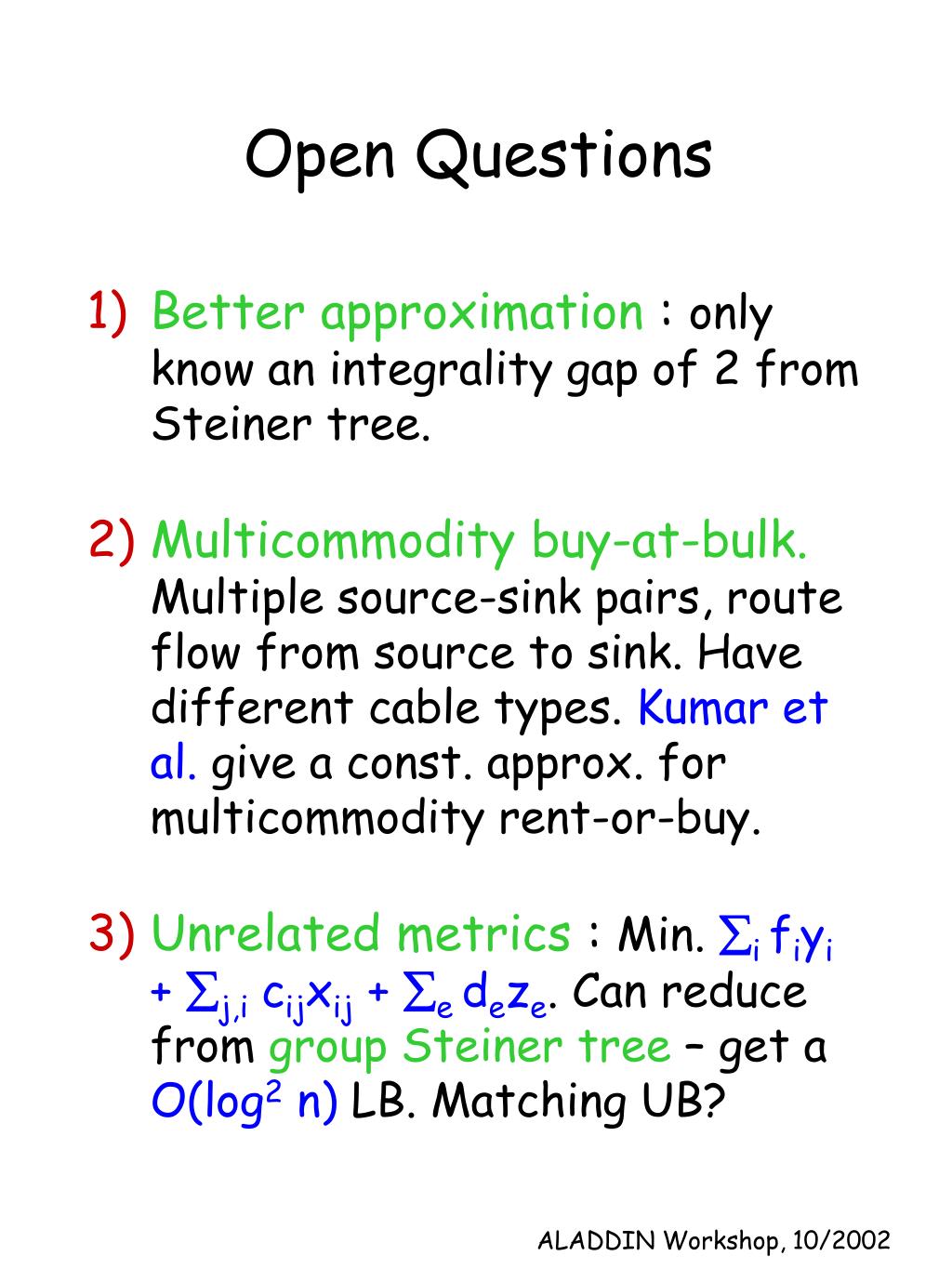

  27. Open Questions • Better approximation : only know an integrality gap of 2 from Steiner tree. • Multicommodity buy-at-bulk.Multiple source-sink pairs, route flow from source to sink. Have different cable types. Kumar et al. give a const. approx. for multicommodity rent-or-buy. • Unrelated metrics : Min.i fiyi + j,i cijxij + e deze. Can reduce from group Steiner tree – get a O(log2 n) LB. Matching UB? ALADDIN Workshop, 10/2002
