1 / 21

DVA-1 Reflector Development Timeline

DVA-1 Reflector Development Timeline. Gary Hovey NRC-HIA Dominion Radio Astrophysical Observaotry. Contents. Reflector Project Scope Project Phases and Milestones Key Objectives, Outcomes and Issues by Phase Conclusions. DVA-1 Reflector Project Scope.

dex
Télécharger la présentation

DVA-1 Reflector Development Timeline

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. DVA-1 ReflectorDevelopment Timeline Gary Hovey NRC-HIA Dominion Radio Astrophysical Observaotry

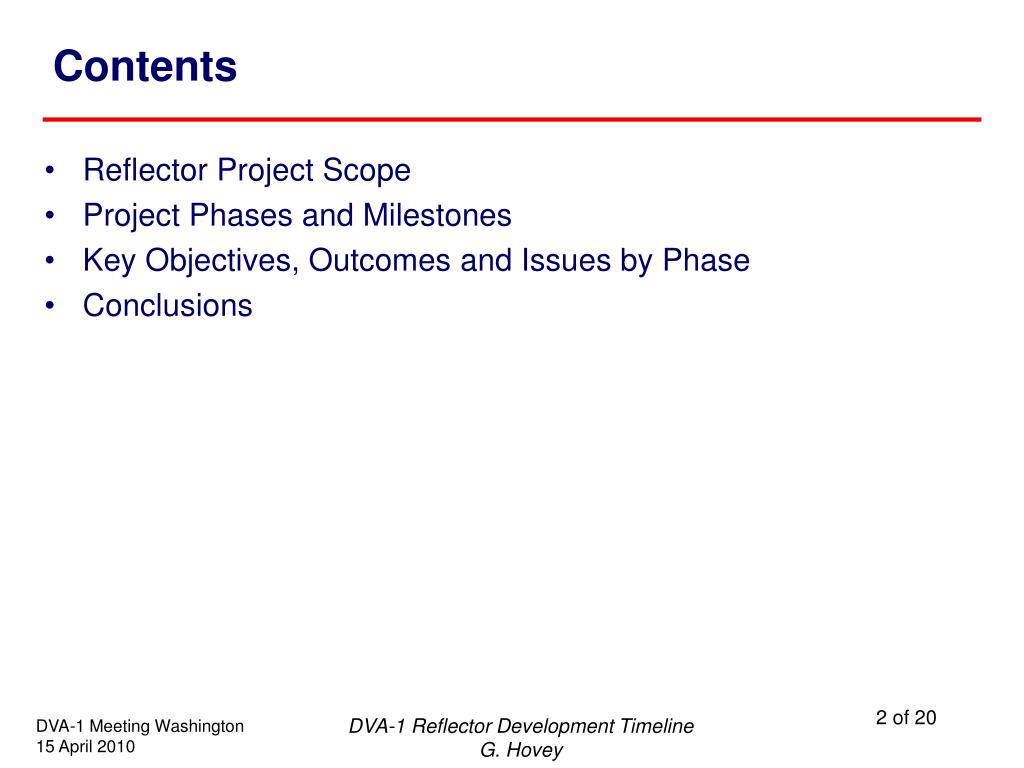

  2. Contents • Reflector Project Scope • Project Phases and Milestones • Key Objectives, Outcomes and Issues by Phase • Conclusions DVA-1 Reflector Development TimelineG. Hovey

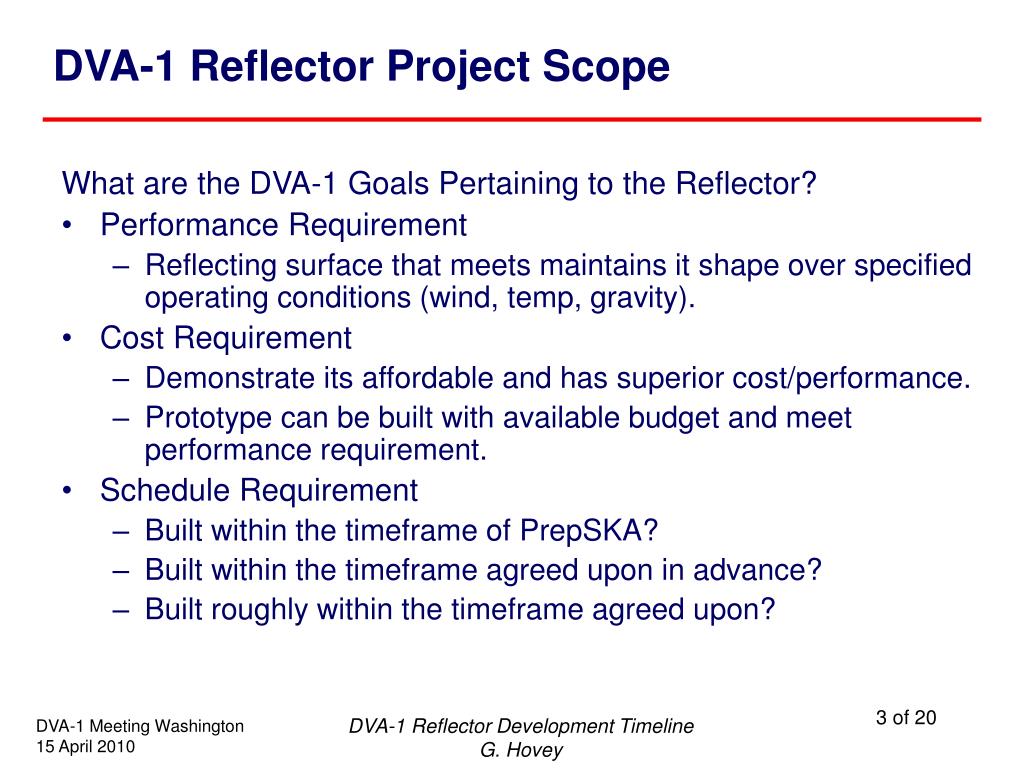

  3. DVA-1 Reflector Project Scope What are the DVA-1 Goals Pertaining to the Reflector? • Performance Requirement • Reflecting surface that meets maintains it shape over specified operating conditions (wind, temp, gravity). • Cost Requirement • Demonstrate its affordable and has superior cost/performance. • Prototype can be built with available budget and meet performance requirement. • Schedule Requirement • Built within the timeframe of PrepSKA? • Built within the timeframe agreed upon in advance? • Built roughly within the timeframe agreed upon? DVA-1 Reflector Development TimelineG. Hovey

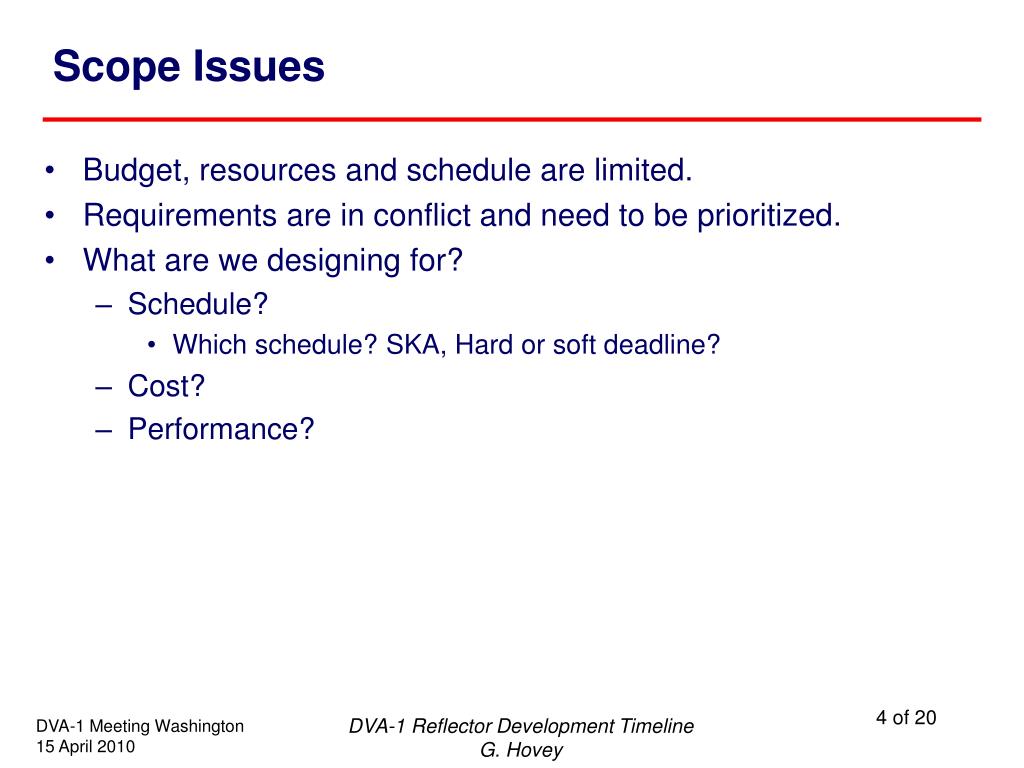

  4. Scope Issues • Budget, resources and schedule are limited. • Requirements are in conflict and need to be prioritized. • What are we designing for? • Schedule? • Which schedule? SKA, Hard or soft deadline? • Cost? • Performance? DVA-1 Reflector Development TimelineG. Hovey

  5. Proposed Reflector Scope Requirements Requirements in Priority • Performance: Must meet SKA performance specifications • Cost: Must be within DVA-1 budget and demonstrate SKA cost/performance • Schedule: Must be adapted to fit performance and cost requirements. DVA-1 Reflector Development TimelineG. Hovey

  6. Proposed Responsibilities and Tasks What does the reflector work include? • Reflector performance and cost key drivers. • Reflector performance and schedule dependent strongly (mainly/mostly) on back-up structure and feed. • Propose reflector consists of: Surface, backup structure, feed & sub-reflector support. These need to be considered together as an integrated whole. • Reflector Interfaces: indexer/receiver box, sub-reflector and turret frame. DVA-1 Reflector Development TimelineG. Hovey

  7. Key Reflector Requirements/Specifications • Performance • Reflector shape and feed/sub-reflector support specs • Dynamic tolerances specs as function wind, gravity and temperature. • Mount interface specs. • Cost • Available budget • Available infrastructure • Available resources and definition of project scope • Schedule • Clear goals and deliverables with achievable deadlines • These need clarity to make progress DVA-1 Reflector Development TimelineG. Hovey

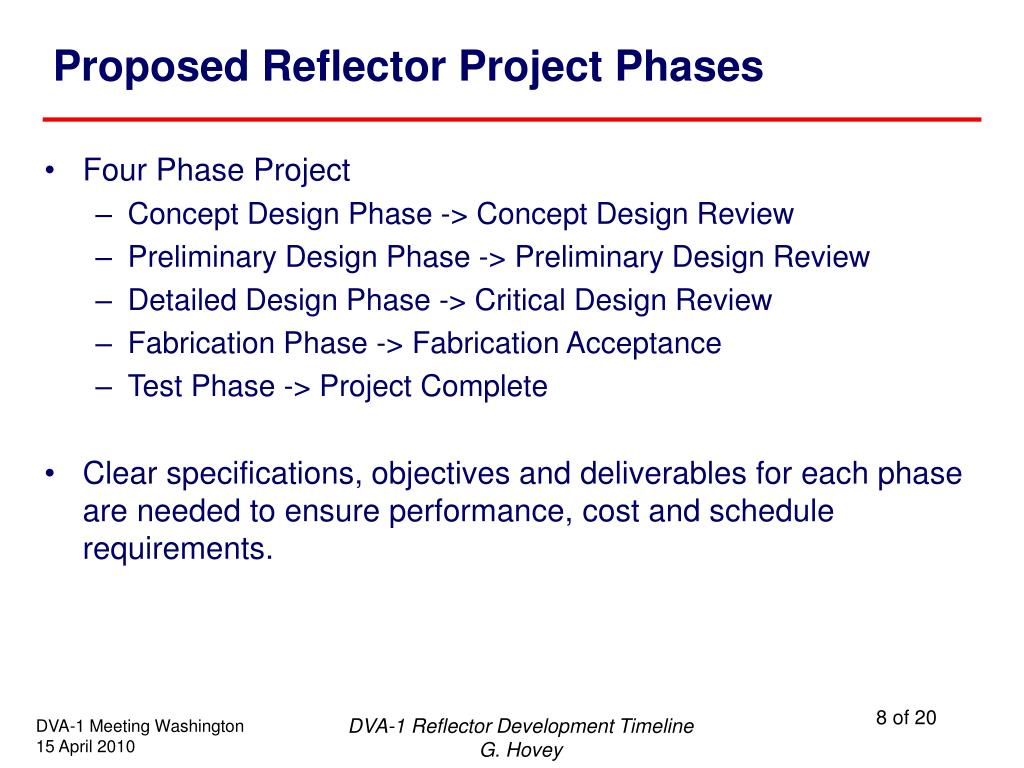

  8. Proposed Reflector Project Phases • Four Phase Project • Concept Design Phase -> Concept Design Review • Preliminary Design Phase -> Preliminary Design Review • Detailed Design Phase -> Critical Design Review • Fabrication Phase -> Fabrication Acceptance • Test Phase -> Project Complete • Clear specifications, objectives and deliverables for each phase are needed to ensure performance, cost and schedule requirements. DVA-1 Reflector Development TimelineG. Hovey

  9. Reflector Concept Design Phase • Objective: Define project based on feasible design concepts. • Duration: 2-3 months once requirements/specifications set. • Outcomes • Concept design • Based mainly on estimation, calculation and simulation • Feasible design that meets overall performance, cost and schedule requirements • Risk items identified • Baseline project plan including: • Initial WBS, costs and schedule • Risks: technical, cost, schedule • Plan to address risks DVA-1 Reflector Development TimelineG. Hovey

  10. Key Concept Design Issues • Need to define surface shape specifications • What diameter: 12m or 15m? At CoDR? Now?? • What antenna pattern? What is optimized? • Aeff • Aeff/Tsys • Near and far sidelobe response • Symmetry, stability, uniformity • Need to understand calibration, imaging and computing impact • Select or defer backup structure approach to prelim design? • To what extent are PAFs considered? • Need clarity on design goals: Performance, budget, schedule? • Need clarity on available budget and constraints. • CoDR can’t be done without these issues resolved. DVA-1 Reflector Development TimelineG. Hovey

  11. Reflector Preliminary Design Phase • Objectives • Sketched out design in non-risk areas • Detailed design/studies in riskier areas • Duration: 2-3 months once CoDR complete • Outcomes needed • Preliminary design • Materials selected and their performance known • Risk items addressed • Based on calculation, simulation and measurement • Technical risk low • Updated project plan • Schedule and cost risk quantified • Detailed design plan well defined • Fabrication and test plan well understood. DVA-1 Reflector Development TimelineG. Hovey

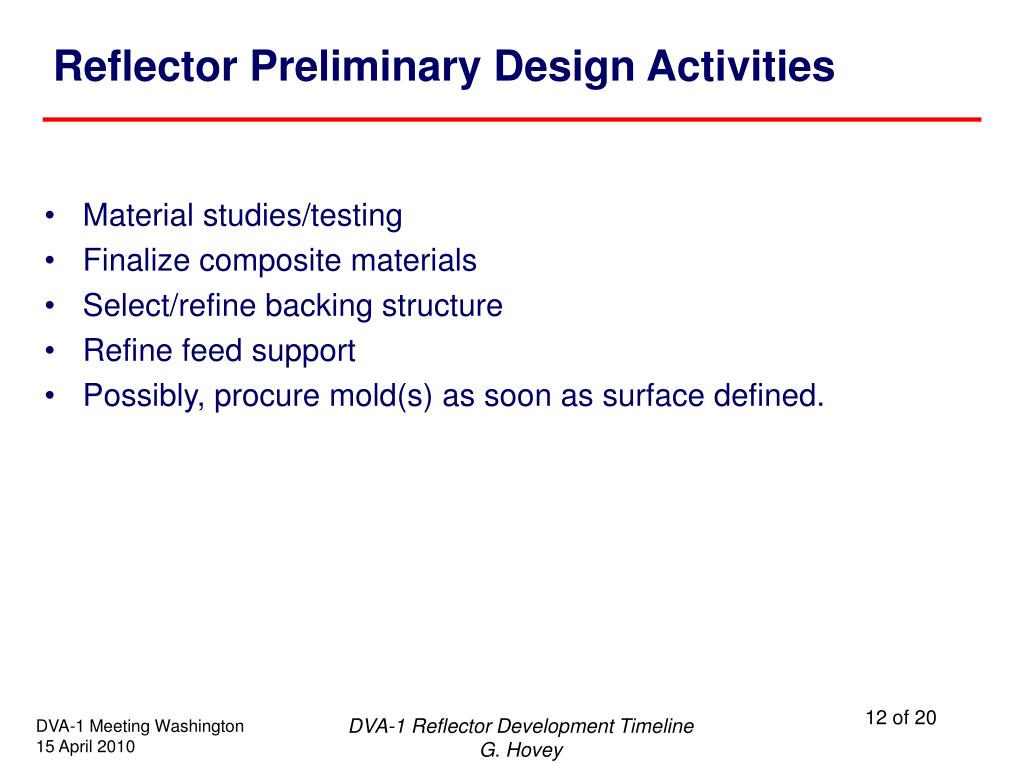

  12. Reflector Preliminary Design Activities • Material studies/testing • Finalize composite materials • Select/refine backing structure • Refine feed support • Possibly, procure mold(s) as soon as surface defined. DVA-1 Reflector Development TimelineG. Hovey

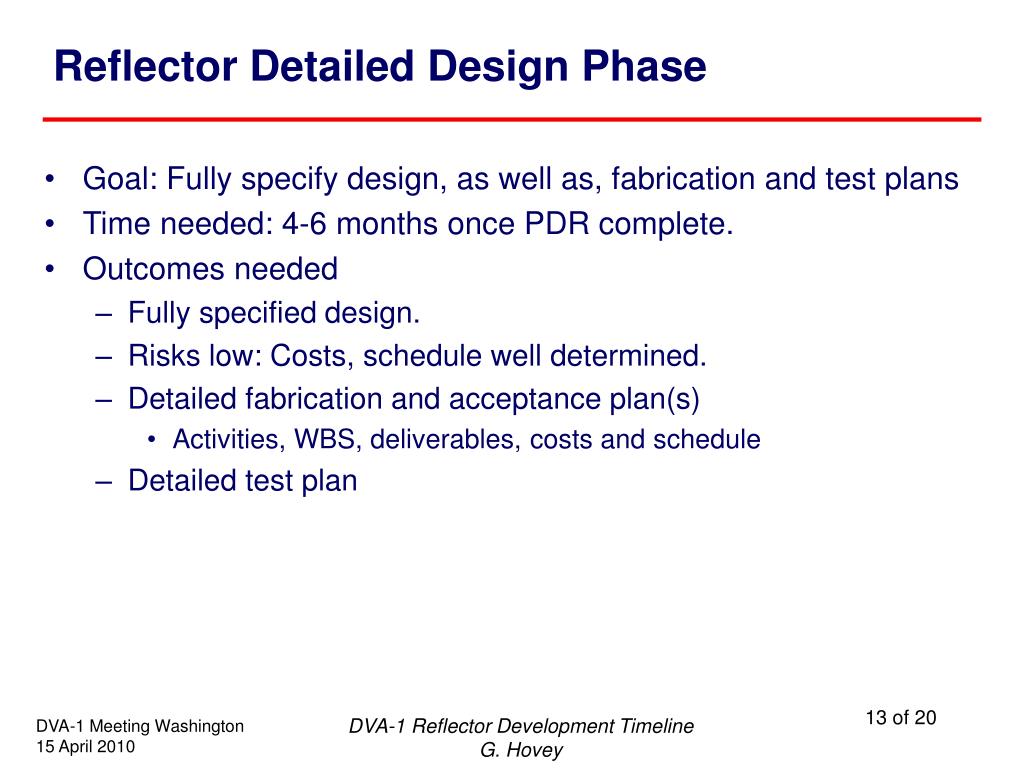

  13. Reflector Detailed Design Phase • Goal: Fully specify design, as well as, fabrication and test plans • Time needed: 4-6 months once PDR complete. • Outcomes needed • Fully specified design. • Risks low: Costs, schedule well determined. • Detailed fabrication and acceptance plan(s) • Activities, WBS, deliverables, costs and schedule • Detailed test plan DVA-1 Reflector Development TimelineG. Hovey

  14. Detailed Design Issues • This is mainly a fill in the blanks phase. • To what extend do we validate dynamics (wind, temp, resonance)? Schedule vs cost risk • How much design margin is carried? • Material cost vs performance and schedule risk • Can molds be ordered before CDR? Schedule vs cost risk DVA-1 Reflector Development TimelineG. Hovey

  15. Reflector Fabrication Phase • Objectives: fabricate/assemble reflector, back-up structure, feed/sub support. • Duration: 6-9 months (not including setup/procurement) • Outcomes • Sub-assembly fabrication and acceptance complete • Reflector surface • Backup structure • Feed/sub support • Assembly complete and ready for test on mount DVA-1 Reflector Development TimelineG. Hovey

  16. Fabrication Phase: Issues • Lead time for procurement of materials • Lead time for preparing site for fabrication • What facilities on-site can be used? • Site regulation and procedure issues • Schedule and cost overheads due to the location • Costs magnified if project delayed • Clean-up costs DVA-1 Reflector Development TimelineG. Hovey

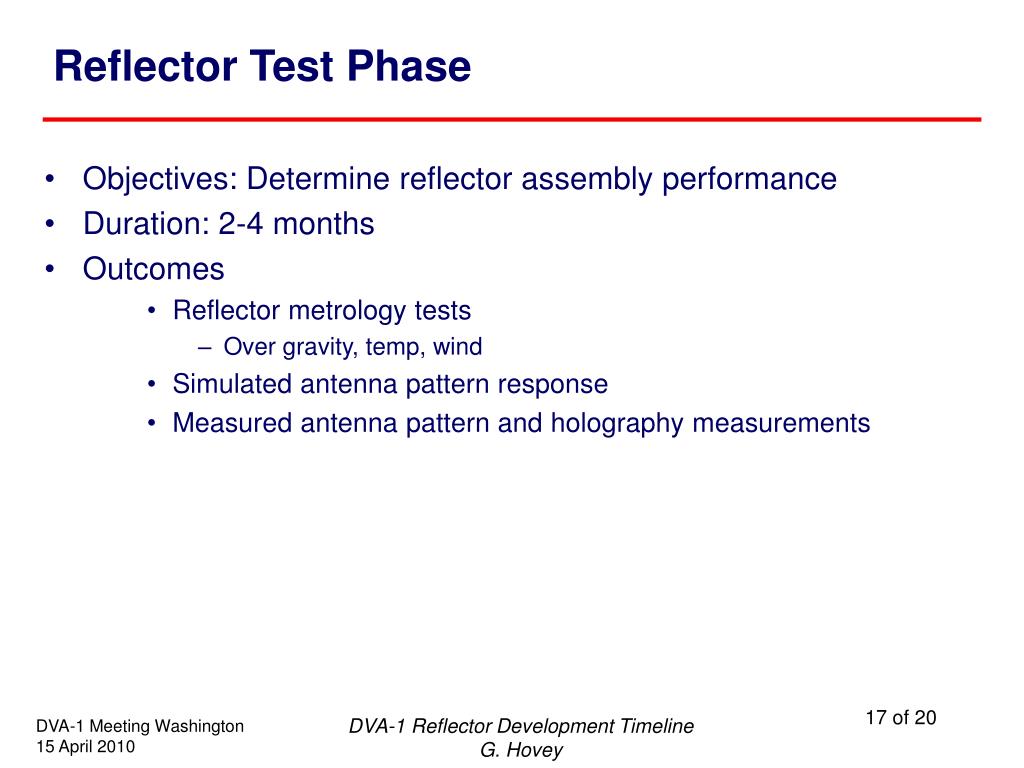

  17. Reflector Test Phase • Objectives: Determine reflector assembly performance • Duration: 2-4 months • Outcomes • Reflector metrology tests • Over gravity, temp, wind • Simulated antenna pattern response • Measured antenna pattern and holography measurements DVA-1 Reflector Development TimelineG. Hovey

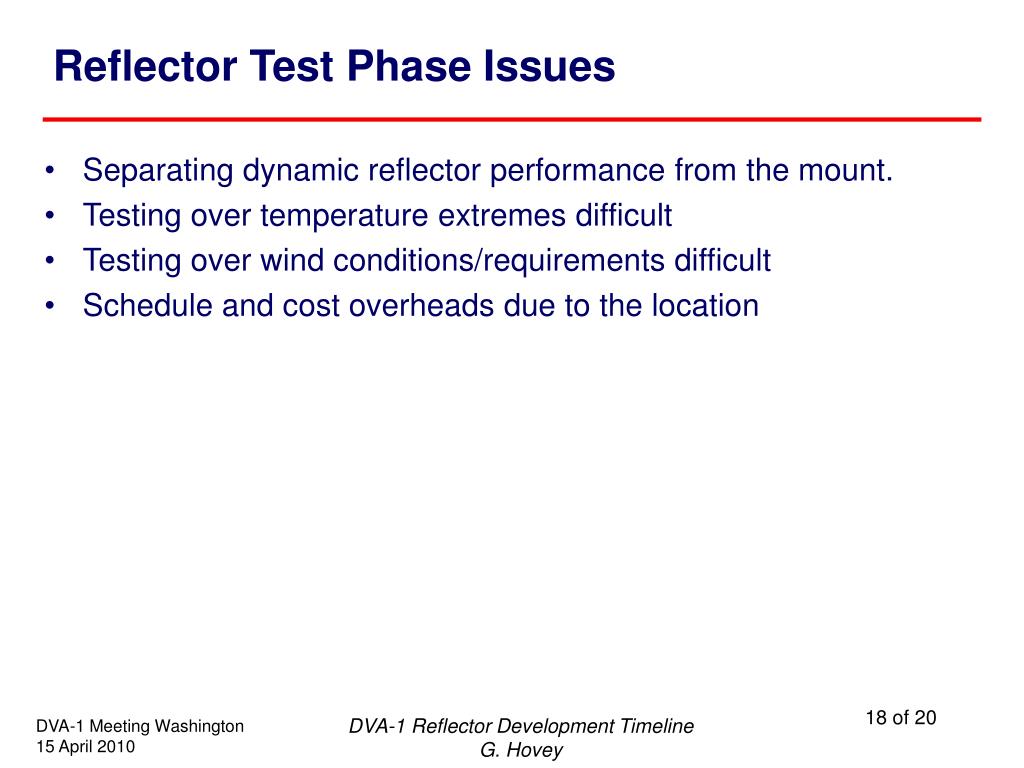

  18. Reflector Test Phase Issues • Separating dynamic reflector performance from the mount. • Testing over temperature extremes difficult • Testing over wind conditions/requirements difficult • Schedule and cost overheads due to the location DVA-1 Reflector Development TimelineG. Hovey

  19. Timeline 2010 2011 2012 Buy Molds DVA-1 Reflector Development TimelineG. Hovey

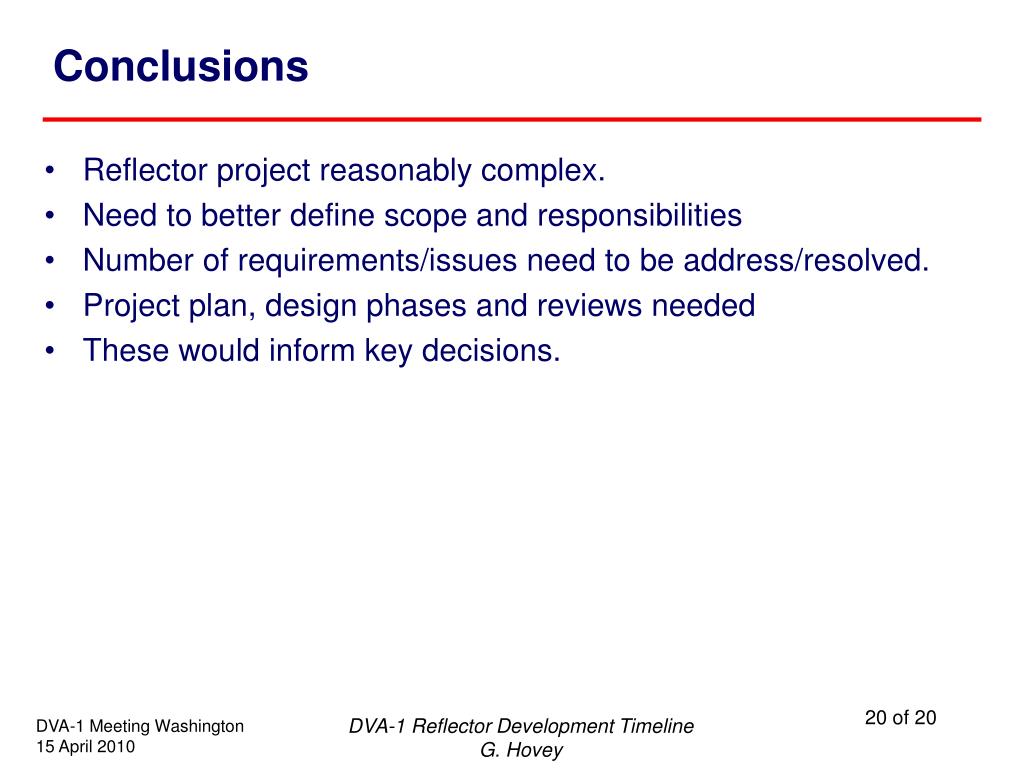

  20. Conclusions • Reflector project reasonably complex. • Need to better define scope and responsibilities • Number of requirements/issues need to be address/resolved. • Project plan, design phases and reviews needed • These would inform key decisions. DVA-1 Reflector Development TimelineG. Hovey

More Related
