AMERICAN SPORTS BUILDERS ASSOCIATION CRITICAL PATH METHOD SCHEDULING FOR SUCCESS. December 6-8, 2008 New Orleans, Louisiana Presented By: Bill Pronevitch. SCHEDULING- Is It Necessary?. Effective Project Management involves coordinating activities such as: Planning Organizing
E N D
AMERICAN SPORTS BUILDERS ASSOCIATIONCRITICAL PATH METHODSCHEDULING FOR SUCCESS December 6-8, 2008 New Orleans, Louisiana Presented By: Bill Pronevitch
SCHEDULING- Is It Necessary? • Effective Project Management involves coordinating activities such as: • Planning • Organizing • Controlling Time (scheduling) • Cost • The “Scheduling” process forces people to: • Quantify their effort in discrete terms • Place tasks in proper relationships

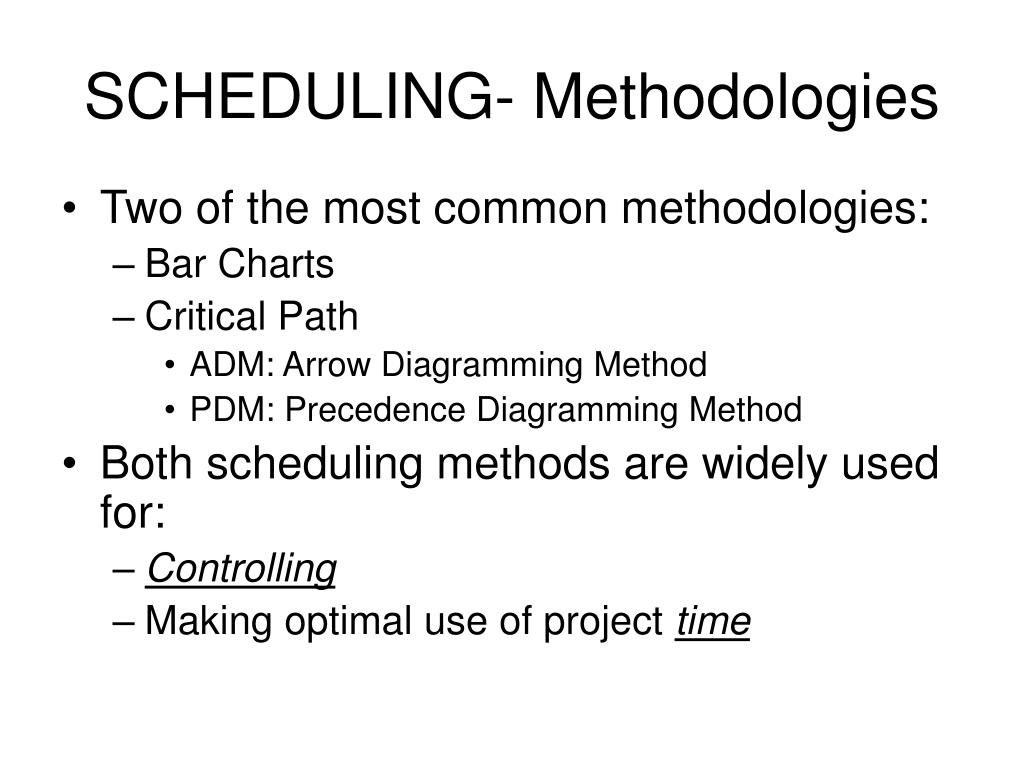

SCHEDULING- Methodologies • Two of the most common methodologies: • Bar Charts • Critical Path • ADM: Arrow Diagramming Method • PDM: Precedence Diagramming Method • Both scheduling methods are widely used for: • Controlling • Making optimal use of project time
SCHEDULING- Bar Charts • Bar Charts (also called “Gantt Charts”) are primarily for controlling Time elements: • Analyze/ specify the basic approach to be used • Segment the work into a reasonable number of activities that can be scheduled • Estimate the time required to perform each activity (i.e.- activity duration) • Place activities in “time-order” (logic) • Adjust the chart until the specified completion date, if one exists, is satisfied.
SCHEDULING- Bar Chart A B C D E F • Gantt Chart (Bar Chart) shows: • All Activities and Status on a Single Chart Activities 0 1 2 3 4 5 6 7 8 9 10 11 12 Time in Weeks
SCHEDULING- Bar Charts • Benefits: • Plan, Schedule, and Progress on a single chart • A simple, understandable way to schedule small projects or undertakings • Disadvantages: • Activity-limited, can’t handle complex projects • Doesn’t show logic ties (activity relationships) • Insufficient detail to enable timely detection of schedule slippages on long duration activities
SCHEDULING: Critical Path • The Critical Path Method (CPM) was designed for and is useful on projects where the duration of each activity can be with reasonable certainty - it predicts project overall completion - it identifies the (critical) activities that control the overall length of the project • CPM is widely used in: process industries construction and plant outages/ shutdowns. estimated
SCHEDULING: Critical Path • Benefits: • Determines shortest project completion time • Identifies “critical” activities – that can not be slipped or delayed (i.e.- “TOTAL FLOAT”) • Shows allowable slippage for “non-critical” activities (i.e.- “FREE FLOAT”) • Disadvantages: • Large number of activities required • Difficult to read, understand, and maintain.
SCHEDULING: CPM/ADM • ADM (Arrow Diagramming Method): • Arrow (line): represents an Activity • Tail (of arrow): shows an Activity’s start • Head (of arrow): shows an Activity’s finish • Node (or event): shown at each end • The “Activity Number” consists of Head and Tail numbers, commonly referred to as I-J nodes (i.e.- “I-J Method” of CPM)
SCHEDULING: CPM/ADM ADM: Arrow Diagramming Method Process Work Order Requisition Material Install Pump 1 4 5 2 Assign Crew (Dummy Activity – shows relationship, zero duration) 3
SCHEDULING: CPM/ADM • Benefits: • Allows use of “Dummy Activities” which: • Have a “ZERO” time duration • Can be used to show additional relationships • Disadvantages: • An Activity’s “Predecessor” must be complete before the Activity can start! • Neither the Activity’s “arrow length” or “arrow direction” have any meaning
SCHEDULING: CPM/PDM • PDM (Precedence Diagramming Method): • Box/ Node: represents an Activity • Line/ Arrow: represents a Precedence – with time and direction properties • Precedence consist of two parts: • “Relationship”: a Predecessor or Successor • “Lag”: the (positive or negative) number of work periods by which a specified Activity will be delayed (assumed to be “0” if not specified)
SCHEDULING: CPM/PDM PDM: Precedence Diagramming Method Process Work Order Requisition Material Install Pump A B C Assign Crew D Pump Installation Completed E
SCHEDULING: CPM/PDM • Types of Relationships, Lags (aa,n): • FS, 0: Finish-to-Start, With “0 units” of delay • FF, 7: Finish-to-Finish, with “7 units” of delay • SS, 5: Start-to-Start, with “5 units” of delay • SF, 0: Start-to-Finish, with “0 units” of delay
SCHEDULING – PDM/ LOGIC Relationships (Logic Ties, Lags Finish -to- Finish Finish –to- Start (FF,5) A A B (FS,0) B Start –to- Start Start –to- Finish A B B A (SS,4) (SF,0)
SCHEDULING: CPM/PDM • “6” Major Types of Constraints • Start On: a mandatory date • Start No Earlier Than*: can start “later” • Start No Later Than*: can start “earlier” • Finish On: a mandatory date • Finish No Earlier Than*: can finish “later” • Finish No Later Than*: can finish “earlier” * NOTE: Schedule logic drives “earlier” and “later” start and finish dates
SCHEDULING- PDM/ OTHER • Hammock Activity • Spans many activities to show an “overall” performance period (i.e.- a summary activity) • Logic Loop • One of the most common “scheduling errors” • Occurs when a set of activities precede each other in a “circular” fashion, (a group of activities can never begin nor end) • Must be eliminated prior to calculating the schedule (i.e.- running a time analysis)
SCHEDULING- Hammock PDM: Hammock (Summary) Activity A B C D E

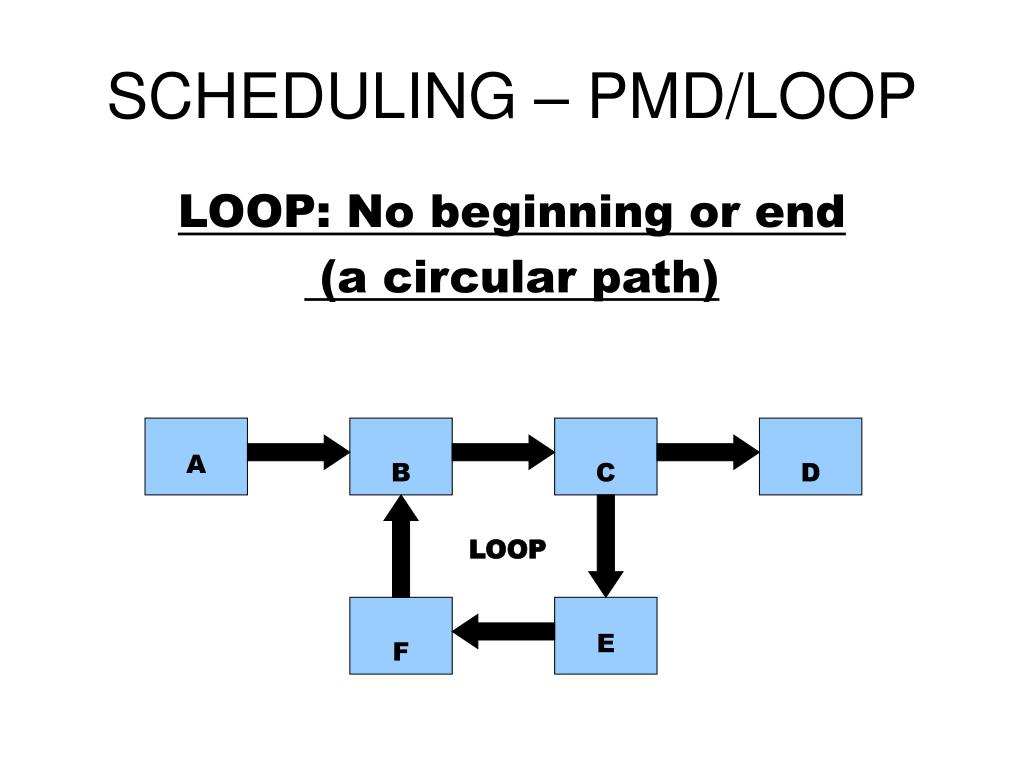

SCHEDULING – PMD/LOOP LOOP: No beginning or end (a circular path) A B C D LOOP E F
SCHEDULING – PDM/ CALC’S • Once a network has been created and the durations estimated for each activity, both the “Total Time” to reach project completion and each activity’s “individual” start and finish times, can be calculated • Manual computation is easy and logical (but tedious & time-consuming on large projects) • Forward Pass: calculates early start/finish, (ES/EF) • Backward Pass: calculates late start/finish, (LS/LF)
SCHEDULING – CALC’S • FORWARD PASS: • Calculates “Earliest Start” and “Earliest Finish” times, observing the following rules: • Assign an “ES” time to the first activity • Other activities start as soon as their “predecessor” relationships have been satisfied • Equations: • ES = EF (Pred.) + 1 • EF = ES + Duration - 1
SCHEDULING – CALC’S • BACKWARD PASS: • Calculates “Latest Start” and “Latest Finish” times, observing the following rules: • Assign an “EF” time to the last activity. • All activities finish as soon as their “Successor” relationships have been satisfied. • Equations: • LF = LS (Succ.) – 1 • LS = LF – Duration + 1
SCHEDULING – CALC’S • PDM ACTIVITY NOTATION: • Activity Number: unique number to an activity • Duration: number of “work periods” assigned • ES & EF: calculated in Forward Pass • LS & LF: calculated in Backward Pass ACTIVITY NUMBER ES EF LS LF DURATION
FORWARD & BACKWARD PASS START FINISH
FORWARD & BACKWARD PASS 1 5 6 19 6 9 10 13 20 24 START 5 9 24 Early Dates: ESs = EFp + 1 EFs = ESs + Ds - 1 FINISH
FORWARD & BACKWARD PASS 1 5 6 19 12 15 16 19 20 24 START 11 15 24 Late Dates: LFp = LSs -1 LSp = LFp – D +1 FINISH
FORWARD & BACKWARD PASS 1 5 6 19 12 15 16 19 20 24 START 24 11 15 24 Late Dates: LFp = LSs -1 LSp = LFp – D +1 FINISH
What is the Scheduling Process? Report/ Status Scheduling Planning
IDENTIFY MILESTONES • Project Start • Project Phase Start and Finishes • Equipment and/ or Long Lead Item Delivery • Project Finish
Select Lot Clear and Grub Lot Install Utilities Construct House Select Contractors Arrange Financing Close Financing Landscape Purchase Appliance and Lighting Fixtures Install Flooring Paint DEVELOP ACTIVITY LIST(EXAMPLE: HOUSE CONSTURCTION)
ASSIGN DURATION TO ACTIVITES(EXAMPLE: HOUSE CONSTRUCTION) • Select Lot 3 days • Clear and Grub Lot 10 days • Install Utilities 3 days • Construct House 60 days • Select Contractors 5 days • Arrange Financing 5 days • Close Financing 1 day • Landscape 5 days • Purchase Appliance/Lighting Fixtures 1 day • Install Flooring 5 days • Paint 5 days
SEQUENCE ACTIVITIES ASK THREE QUESTIONS! • What activity must come before this one? • What activity must come after this one? • What activities can I perform at the same time?
REVIEW AND FINALIZE • Review Relationships • Review and Finalize Durations • Review Resource Usage • Review and Finalize Project End Date • Does this achieve the desired date? • If it does not…. What is the plan NOW?!?
SCHEDULING- CONCLUSION • Planning and scheduling functions are usually performed iteratively in order to provide for accomplishing all required tasks within the specified time frames • Both Critical Path Methods (ADM & PDM) create networks showing activity durations and total time for project completion • “Failing to Plan is Planning to Fail”, hence “Plan the Work, Work the Plan”
