IEEE Southeastern Conference 2013 Robotics Competition Kyle Desrosier, Project Manager
Conference Overview • IEEE Southeastern Conference 2013 • Region 3 (SE USA) • Technical Conference • Professionals and Students • Student Competitions (Hardware, Software, Paper, Ethics) • To go you must be an active member of FIT-IEEE • Jacksonville, FL • April 4 – 7, 2013 • Conference Homepage
Competition Overview • Student Hardware Competition • Robotics competition • Must sort cargo based off length and color • Length → zone, color → spot in zone • Cargo has 6 colors and 3 lengths • Simulates autonomy at a logistics port

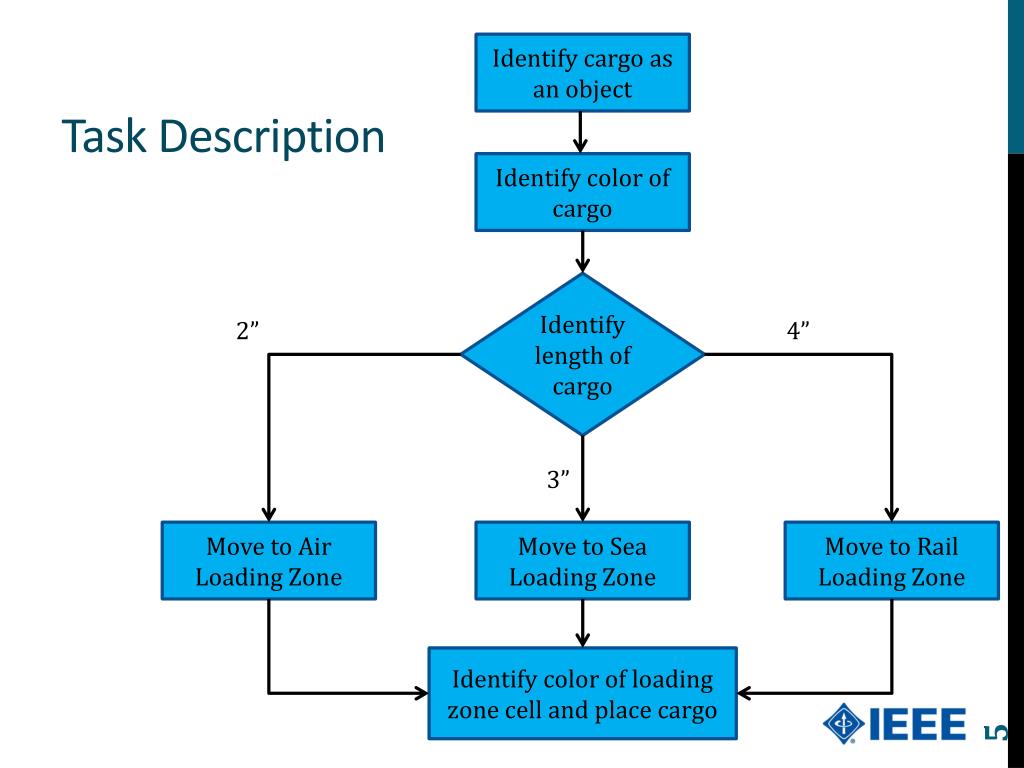

Task Description Identify cargo as an object Identify color of cargo Identify length of cargo 2” 4” 3” Move to Air Loading Zone Move to Sea Loading Zone Move to Rail Loading Zone Identify color of loading zone cell and place cargo

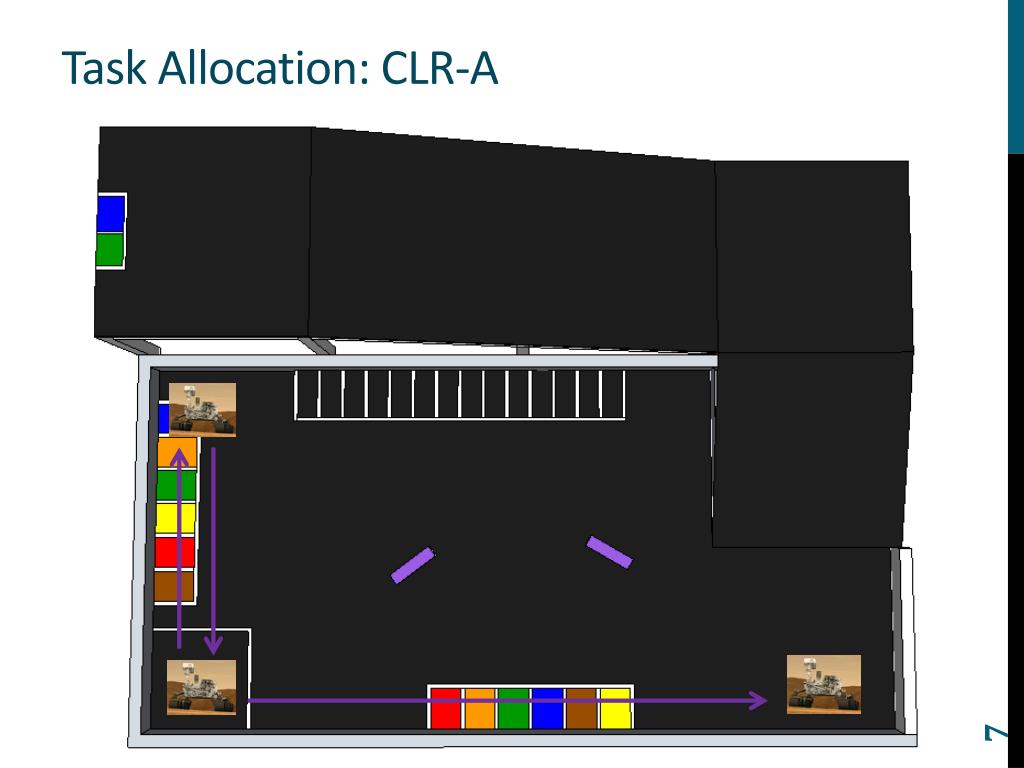

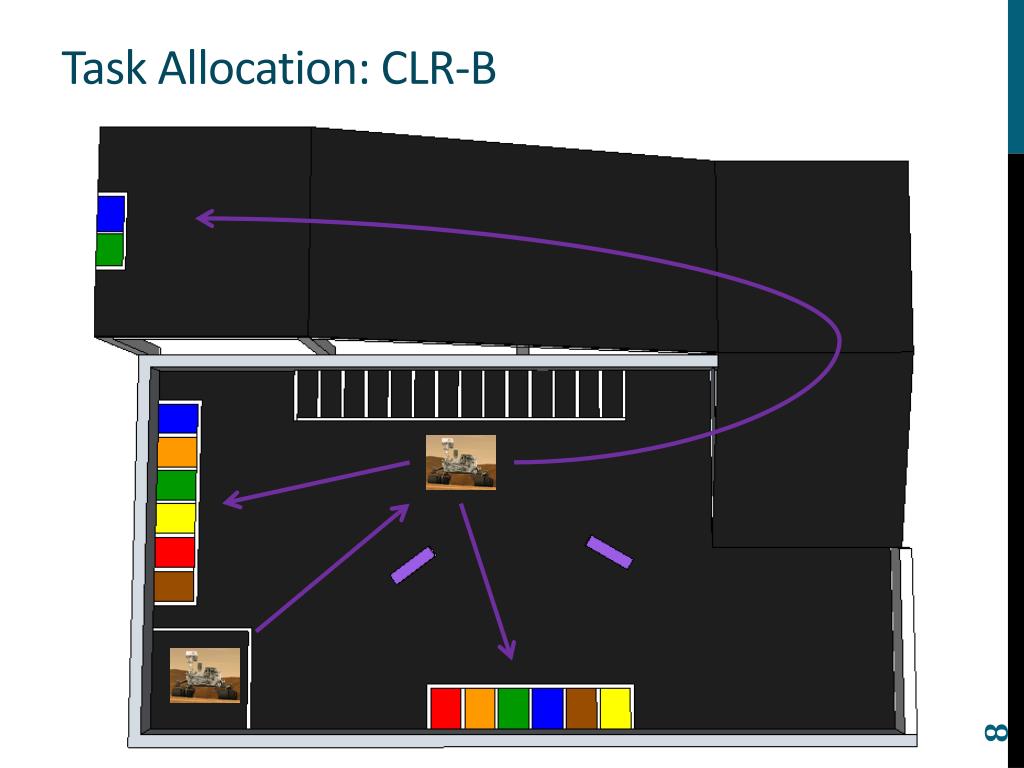

Task Allocation • Utilize teamwork to maximize efficiency • Cooperative Logistics Robots (CLR) • CLR-A: • Record cell colors of sea and rail loading zones • CLR-B: • ID cargo as objects, record their colors and sizes, move to loading zones

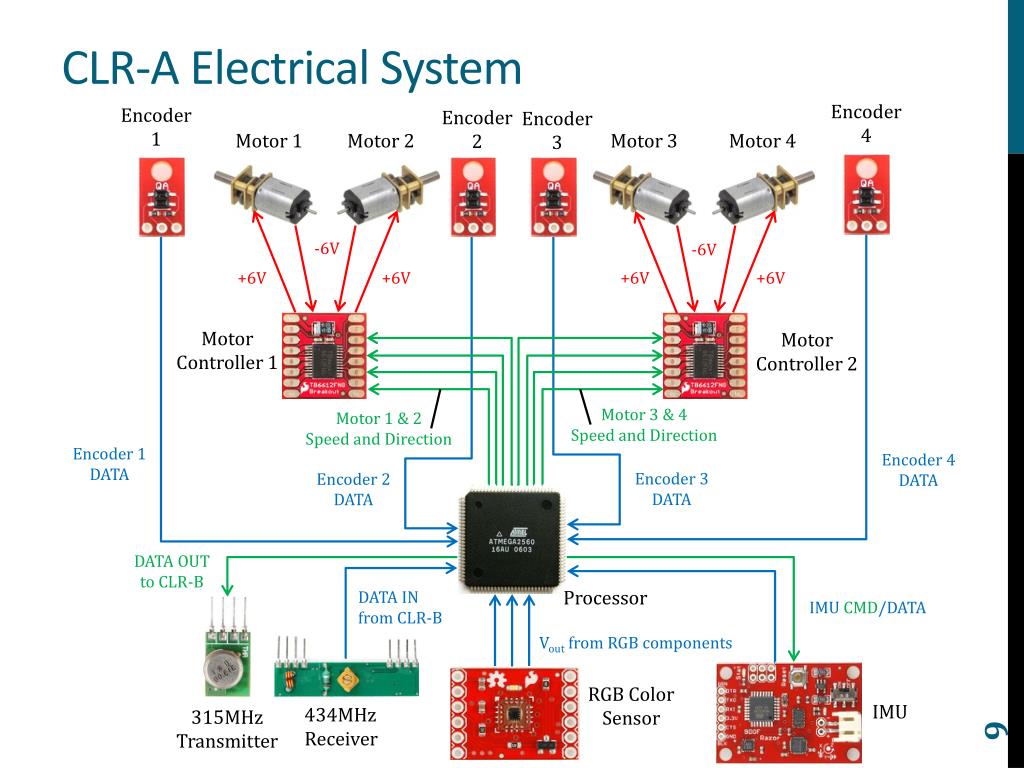

CLR-A Electrical System Encoder4 Encoder1 Encoder2 Encoder3 Motor 4 Motor 2 Motor 1 Motor 3 -6V -6V +6V +6V +6V +6V MotorController 1 MotorController 2 Motor 3 & 4Speed and Direction Motor 1 & 2Speed and Direction Encoder 1DATA Encoder 4DATA Encoder 3DATA Encoder 2DATA DATA OUTto CLR-B Processor DATA INfrom CLR-B IMU CMD/DATA Vout from RGB components RGB ColorSensor IMU 434MHz Receiver 315MHzTransmitter

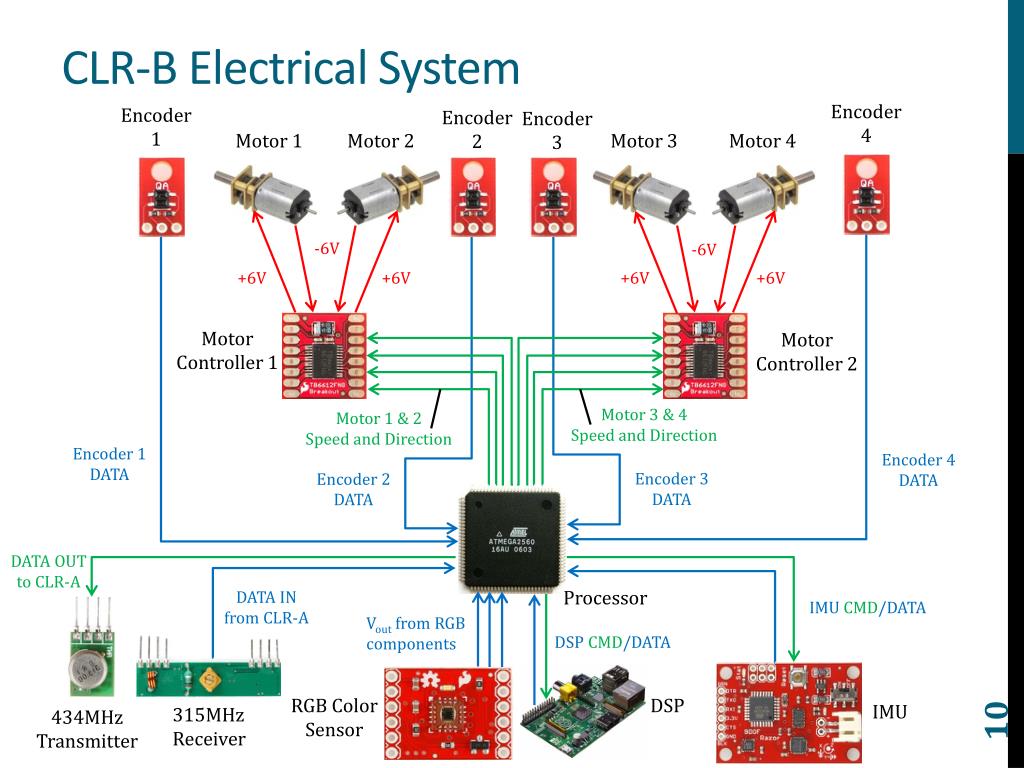

CLR-B Electrical System Encoder4 Encoder1 Encoder2 Encoder3 Motor 4 Motor 2 Motor 1 Motor 3 -6V -6V +6V +6V +6V +6V MotorController 1 MotorController 2 Motor 3 & 4Speed and Direction Motor 1 & 2Speed and Direction Encoder 1DATA Encoder 4DATA Encoder 3DATA Encoder 2DATA DATA OUTto CLR-A Processor DATA INfrom CLR-A IMU CMD/DATA Vout from RGBcomponents DSP CMD/DATA DSP RGB ColorSensor IMU 315MHz Receiver 434MHzTransmitter
Project Schedule • Summer 2012: Systems Engineering • Requirements, interfaces, modeling, pinout assignments • Aug 20 – Aug 26: Preliminary Design Review (PDR) • Aug 27 – Sep 30: Code design • Creating command and telemetry functions for each device • Data processing functions
Project Schedule • Oct 1 – Nov 4: Physical Design and Software Design • Structural and cabling design • Overhead algorithm design: navigation, data processing, and communication • Nov 5 – Nov 11: Critical Design Review (CDR) • Nov 12 – Dec 10: Integration/construction
Budget • CLR-A: • Electronics/Components: $372.65 • Mechanical components: $98.39 • CLR-B: • Electronics/Components: $393.10 • Mechanical components: $98.39 • Practice Field: $139.59 • Total: $1102.12 • Not included: DSP, Camera, mechanism to carry cargo • Estimated Grand Total: $1500
Task Allocation • Senior Design Project for Kyle Desrosier, Eric Santos, Denis Richard, and David Alvarado • Senior Design Group • Navigation algorithm • Object and color identification • Determination of loading zone cell colors
Task Allocation • IEEE Student Chapter • Instrumentation Team • Redundant navigation • Wireless communications • Cargo length determination • Payload Team • Cargo movement • Design Team • Structural and cabling design • System integration • Practice field construction

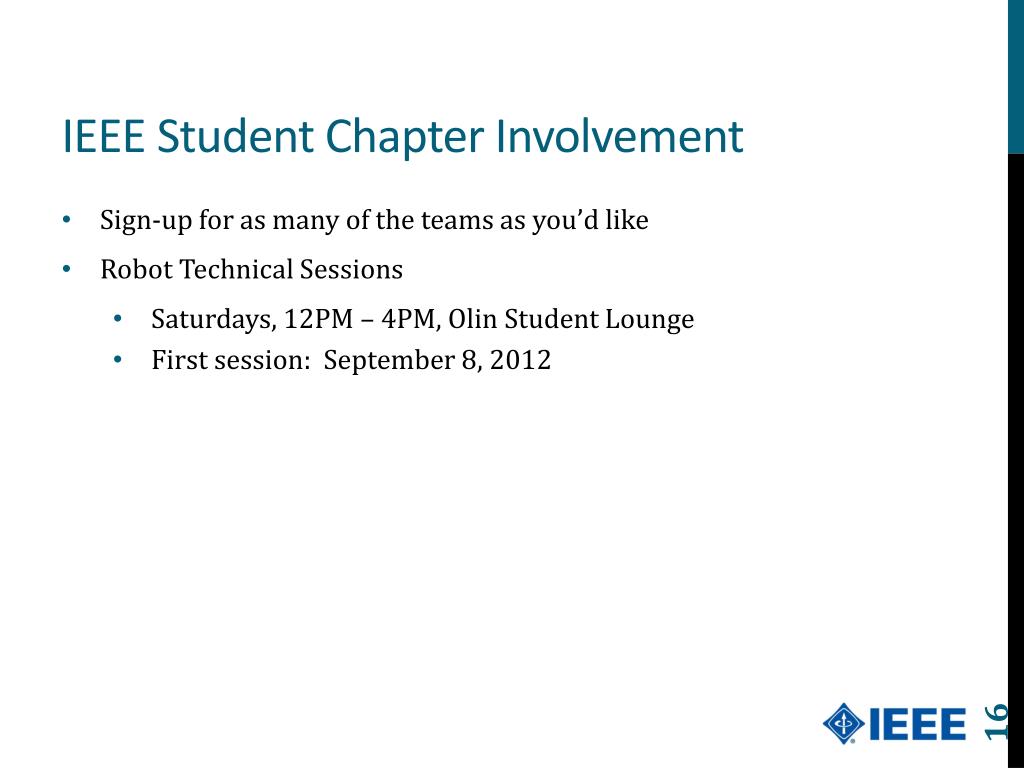

IEEE Student Chapter Involvement • Sign-up for as many of the teams as you’d like • Robot Technical Sessions • Saturdays, 12PM – 4PM, Olin Student Lounge • First session: September 8, 2012
