  1. Delmar Addition/Glenn Avenue Sewer Improvement Area Informational Meeting March 5, 2003 Perry Township Administration Building

  2. Overview of Tonight’s Meeting I. Review Meeting Objective. II. Review the History of the Project. III. Review Administrative Procedures. IV. Review Proposed Sewer Layout. V. Review Design and Construction Cost. VI. Review Project Funding. VII. Review Property Owner Cost. VIII. Review Tentative Schedule IX. Questions and Answers.

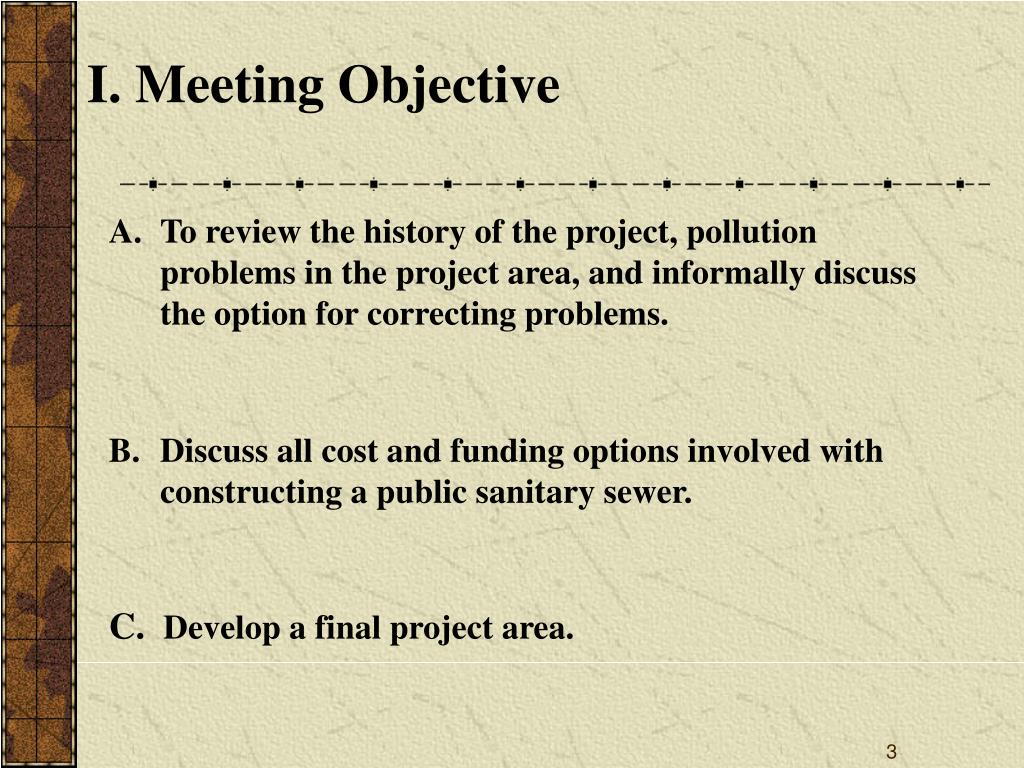

  3. I. Meeting Objective • To review the history of the project, pollution problems in the project area, and informally discuss the option for correcting problems. • Discuss all cost and funding options involved with • constructing a public sanitary sewer. C. Develop a final project area.

  4. II. Project History March 29, 1979 OEPA conducted a field survey of the St. John’s Sewer Improvement Area (St. John’s Road, Glenn Avenue, and Delmar Addition) June 6, 1979 Board of County Commissioners entered into contract with Kohli & Kaliher Associates, Ltd. to gather data and complete funding applications. March 5, 1981 Board of County Commissioners made applications to Farmers Home Administration, Community Development, and USEPA for funding.

  5. II. Project History (continued) July 30, 1981Board of County Commissioners entered into contract with Kohli & Kaliher Associates, Ltd. for final design of the St. John’s Sewer Improvement Area. October 23, 1981 Funding for the project was declined. 1990 The City of Lima, and County constructed the St. John’s Trunk Sewer project. 1990 to 1997 The Board of County Commissioners constructed six phases of the St. John’s Sewer Improvement project using CDBG Formula money.

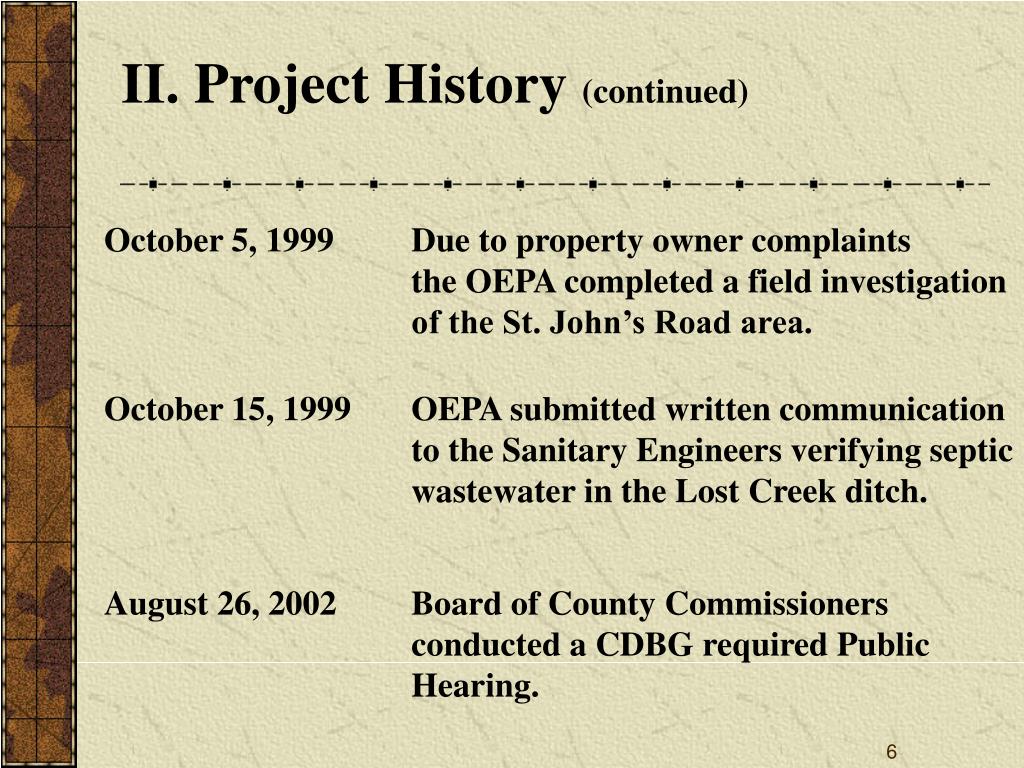

  6. II. Project History (continued) October 5, 1999 Due to property owner complaints the OEPA completed a field investigation of the St. John’s Road area. October 15, 1999 OEPA submitted written communication to the Sanitary Engineers verifying septic wastewater in the Lost Creek ditch. August 26, 2002 Board of County Commissioners conducted a CDBG required Public Hearing.

  7. II. Project History (continued) August 30, 2002 Board of County Commissioners made application to the State of Ohio for $600,000.00 of Department of Development Competitive Water and Sewer Grant money. January 2003 Board of County Commissioners received notice from the State of Ohio they would receive $523,000.00 grant for the Delmar Addition/Glenn Avenue Sewer Improvement project. March 5, 2003 Property owner informational meeting.

  8. III. Administrative Procedures(non-assessment) A. Conduct Public Hearing (CDBG requirement). B. Make application to State of Ohio for CDBG. C. Conduct first Informational Meeting. D. Begin final design of project. E. Bid construction of project. F. Begin construction of project. G. Complete construction of project. H. Notification to property owners for connection to project.

  9. IV PROPOSED SEWER N Charledon Ave. Kingston Ave. Existing Sewer Pump Station 8th Clyde Ave. Force Main Lennox Ave. 9th S.R. 65 10th Delmar Addition

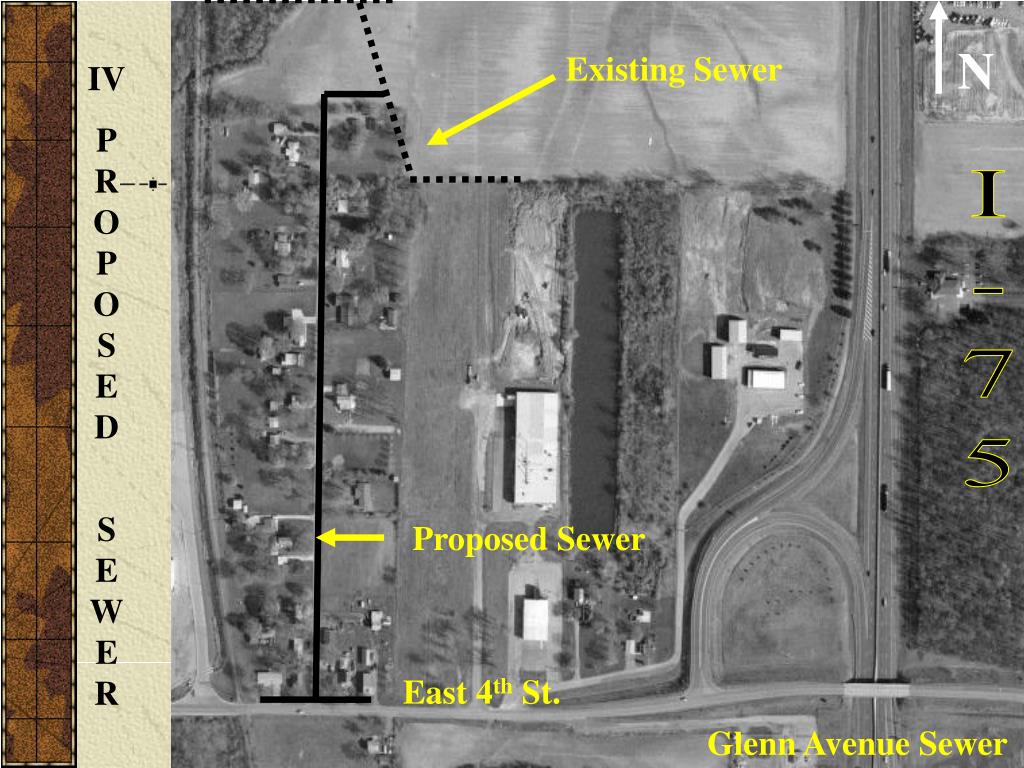

  10. Existing Sewer N IV PROPOSED SEWER I-75 Proposed Sewer East 4th St. Glenn Avenue Sewer

  11. V. Design and Construction Cost Engineering Design $52,000 Construction Cost 820,500 Construction Engineering 80,000 Miscellaneous 21,000 Contingency ____ 82,500 Total Project Cost $1,056,000 .

  12. VI. Project Funding • Funding Assistance • The Ohio Department of Development through CDBG Competitive Water Sewer Program will provide $423,000.00 for construction of the project, and $100,000.00 sewer tapping connection assistance. • Allen County Commissioners will provide $100,000.00 CDBG Formula funds and $66,000.00 Revolving Loan Fund money ($47,800.00 construction, $18,200.00 connection assistance). • Allen County Sanitary Engineering Department will provide $75,000.00. • Perry Township will provide $75,000.00.

  13. VII. Property Owner Cost • Project Debt Service • This is a monthly cost to the property owners to be placed on sewer billings to pay for the balance of the project that is not covered by funding assistance. • Project Cost $ 1,056,000.00 • Less State CDBG Funding - 423,000.00 • Less County Funds - 222,800.00 • Less Township Funds - 75,000.00 • Principal Amount To Be Financed Monthly $ 335,200.00

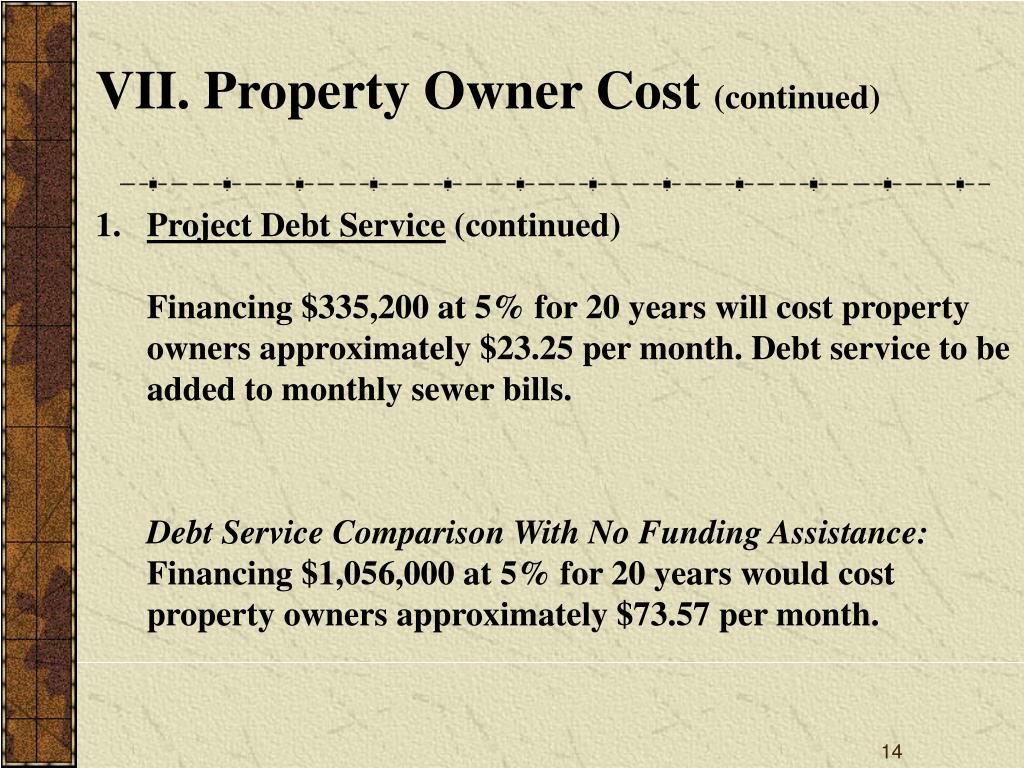

  14. VII. Property Owner Cost (continued) • Project Debt Service (continued) Financing $335,200 at 5% for 20 years will cost property owners approximately $23.25 per month. Debt service to be added to monthly sewer bills. • Debt Service Comparison With No Funding Assistance:Financing $1,056,000 at 5% for 20 years would cost property owners approximately $73.57 per month.

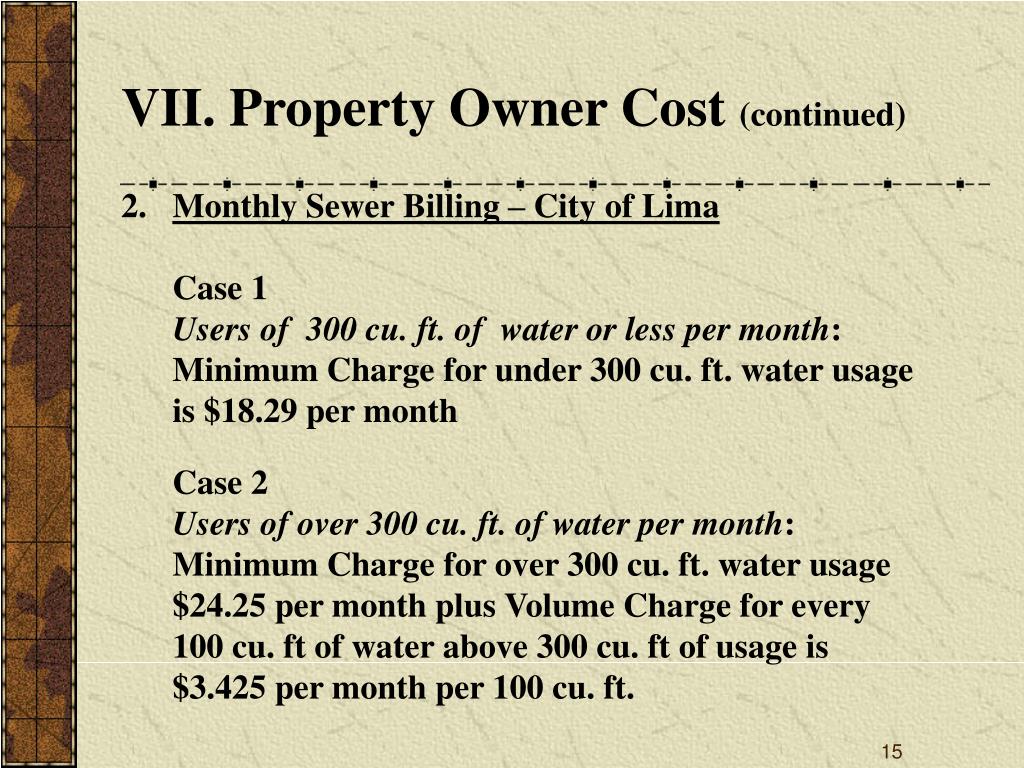

  15. VII. Property Owner Cost (continued) • Monthly Sewer Billing – City of LimaCase 1Users of 300 cu. ft. of water or less per month: • Minimum Charge for under 300 cu. ft. water usage is $18.29 per month • Case 2Users of over 300 cu. ft. of water per month: • Minimum Charge for over 300 cu. ft. water usage $24.25 per month plus Volume Charge for every 100 cu. ft of water above 300 cu. ft of usage is $3.425 per month per 100 cu. ft.

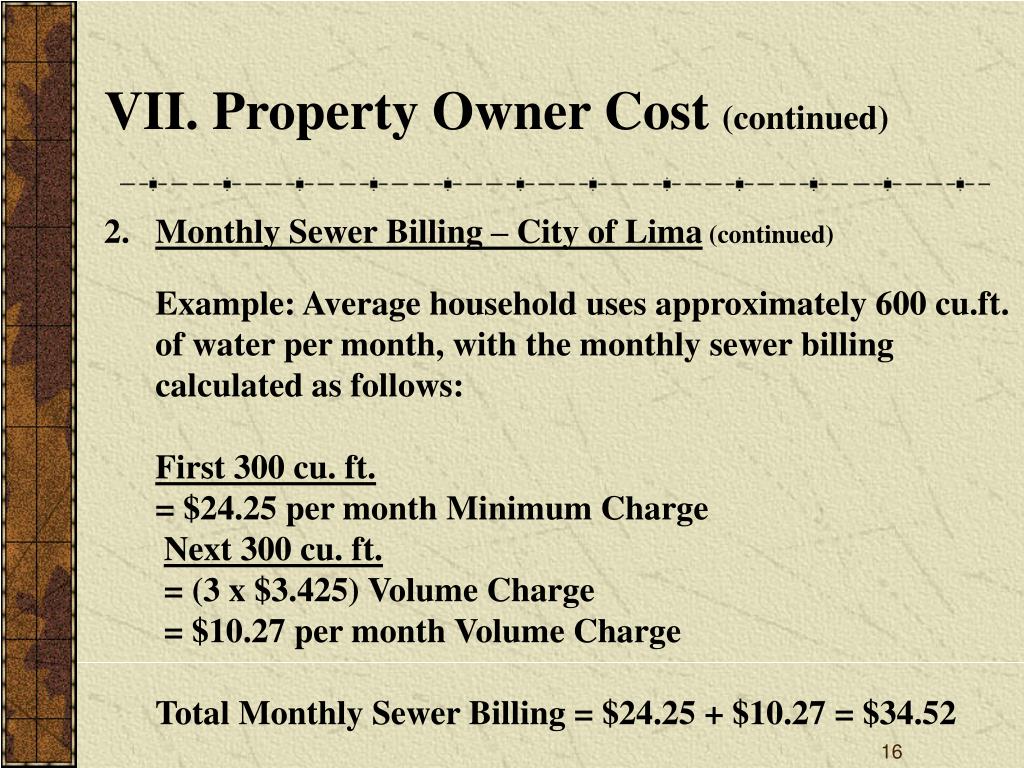

  16. VII. Property Owner Cost (continued) • Monthly Sewer Billing – City of Lima(continued)Example: Average household uses approximately 600 cu.ft. of water per month, with the monthly sewer billing calculated as follows:First 300 cu. ft. • = $24.25 per month Minimum Charge Next 300 cu. ft. = (3 x $3.425) Volume Charge = $10.27 per month Volume ChargeTotal Monthly Sewer Billing = $24.25 + $10.27 = $34.52

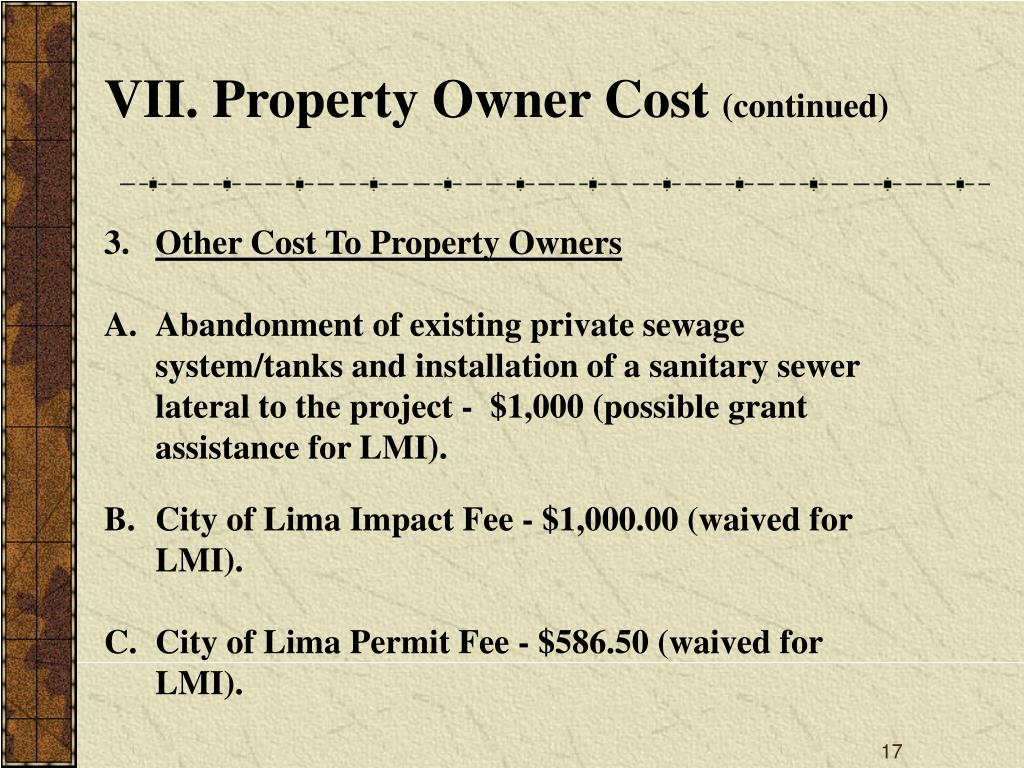

  17. VII. Property Owner Cost (continued) • Other Cost To Property Owners • Abandonment of existing private sewage system/tanks and installation of a sanitary sewer lateral to the project - $1,000 (possible grant assistance for LMI). • City of Lima Impact Fee - $1,000.00 (waived for LMI). • City of Lima Permit Fee - $586.50 (waived for LMI).

  18. VII. Property Owner Cost (continued) Summary • Monthly Debt Service - $23.25 per month (approximate) • Monthly Sewer Billing - $34.52 per month, 600 cu. ft. water • Other Cost To Property Owners:Abandonment of septic and connection - $1,000.00 (approx.)City of Lima Impact Fee - $1,000.00 (waived for LMI)City of Lima Permit Fee - $586.50 (waived for LMI)

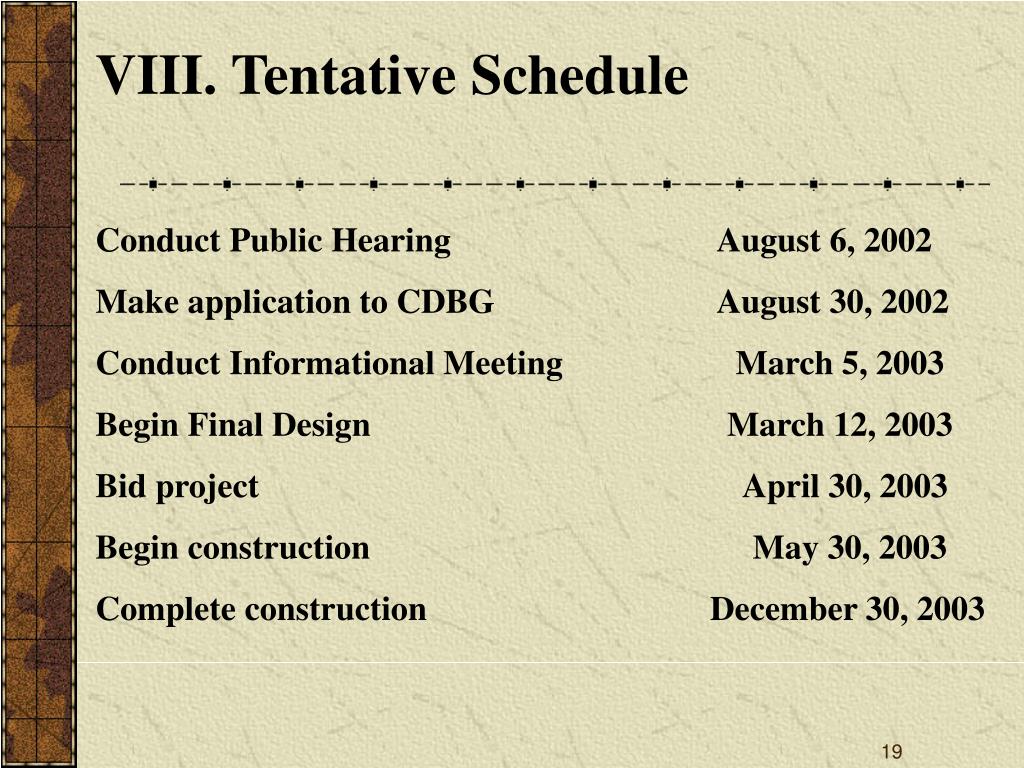

  19. VIII. Tentative Schedule Conduct Public Hearing August 6, 2002 Make application to CDBG August 30, 2002 Conduct Informational Meeting March 5, 2003 Begin Final Design March 12, 2003 Bid project April 30, 2003 Begin construction May 30, 2003 Complete construction December 30, 2003

  20. IX. Questions & Answers ?
