1 / 12

Operational risk evaluation and control plan design

Operational risk evaluation and control plan design. Belgacem BETTAYEB PhD Candidate P. Vialletelle*, S. Bassetto, M. Tollenaere G-SCOP Laboratory - Grenoble Institute Of Technology, France * ST microelectronics Crolles, France Belgacem.bettayeb@grenoble-inp.fr. Agenda. Problem statement

eloise
Télécharger la présentation

Operational risk evaluation and control plan design

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Operational risk evaluation and control plan design Belgacem BETTAYEB PhD Candidate P. Vialletelle*, S. Bassetto, M. Tollenaere G-SCOP Laboratory - Grenoble Institute Of Technology, France * ST microelectronics Crolles, France Belgacem.bettayeb@grenoble-inp.fr

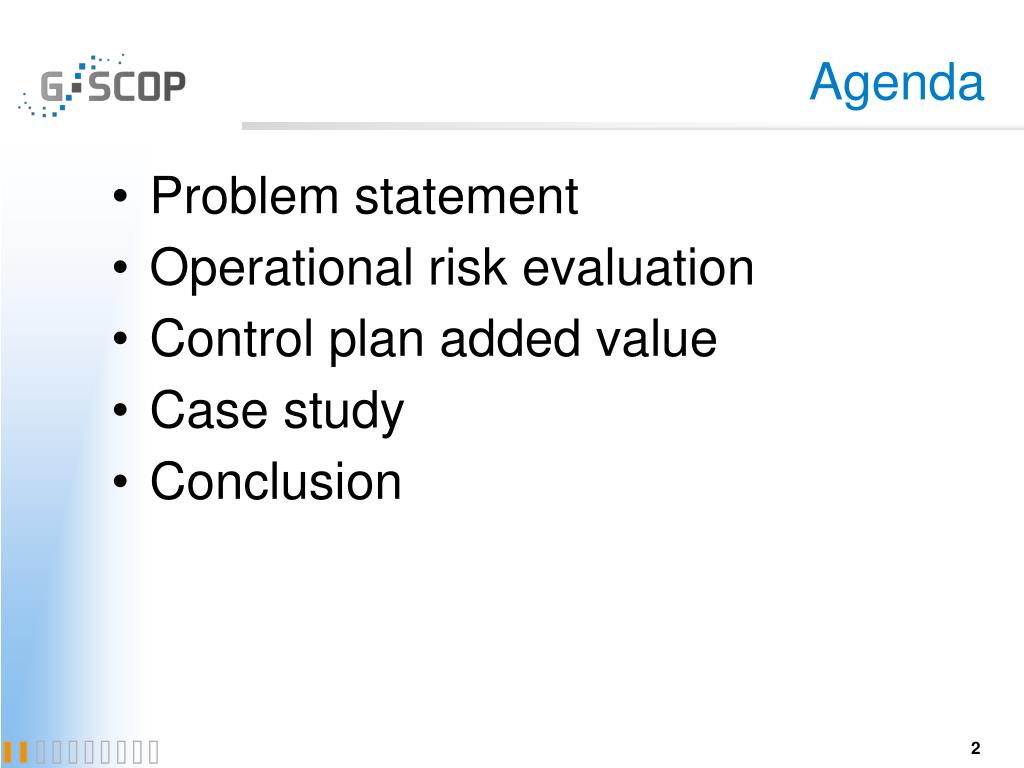

  2. Agenda Problem statement Operational risk evaluation Control plan added value Case study Conclusion

  3. Problem statement (1/2) Quality control and production control policies are usually designed and managed separately Tools and processes may remain uncontrolled over a long production period  grow up of the uncertainty about products quality Late releasing of uncertainty may lead to a major scrap (thousands of defective products) uncertainty Process Tool Control Tool

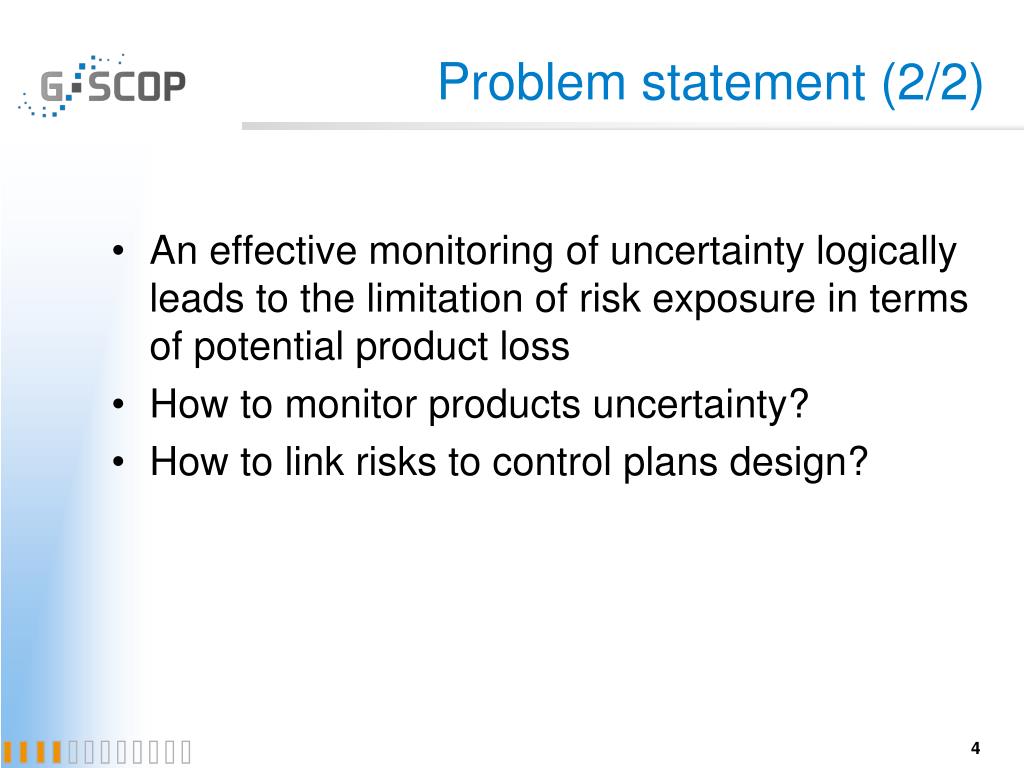

  4. Problem statement (2/2) An effective monitoring of uncertainty logically leads to the limitation of risk exposure in terms of potential product loss How to monitor products uncertainty? How to link risks to control plans design?

  5. Potential Loss Potential Loss PLiX(i)=1 PLi0(.) PL1X(i)=i PL10(.) i i 1 1 # run 1 i H # run 1 i H Uncertainty monitoring • Assumption: once the NDE1 occurs it impacts production until being fixed • Uncertainty number of products potentially lost PL = With one control at the ith run Without Control plan • If the measure at ith run is “OK”  no need to consider PL that corresponds to a NDE occurrence previous to the measurement instant • If the measure is “not OK”, an action is imminent which will “reinitialize or modify” the Probability of the NDE and the Potential Loss becomes “Probable Loss” or “Proven Loss” PL evolution ifthe NDE occurs at the (i+1)th run and a control is planned at the the ith run

  6. Operational risks evaluation (1/3) • Notations • R0(.): risk evolution during a considered horizon (H) without any control • RX(.): risk evolution during the considered horizon (H) with control plan X • PLjX(.): Potential Loss evolution with control plan X if the NDE occurs in the jth run • Prj: probability of occurrence of the NDE at jth run • AVX = f(R0(.), RX(.)) : added value of control plan X • Example: AVX=Max R0(.) – Max RX(.)

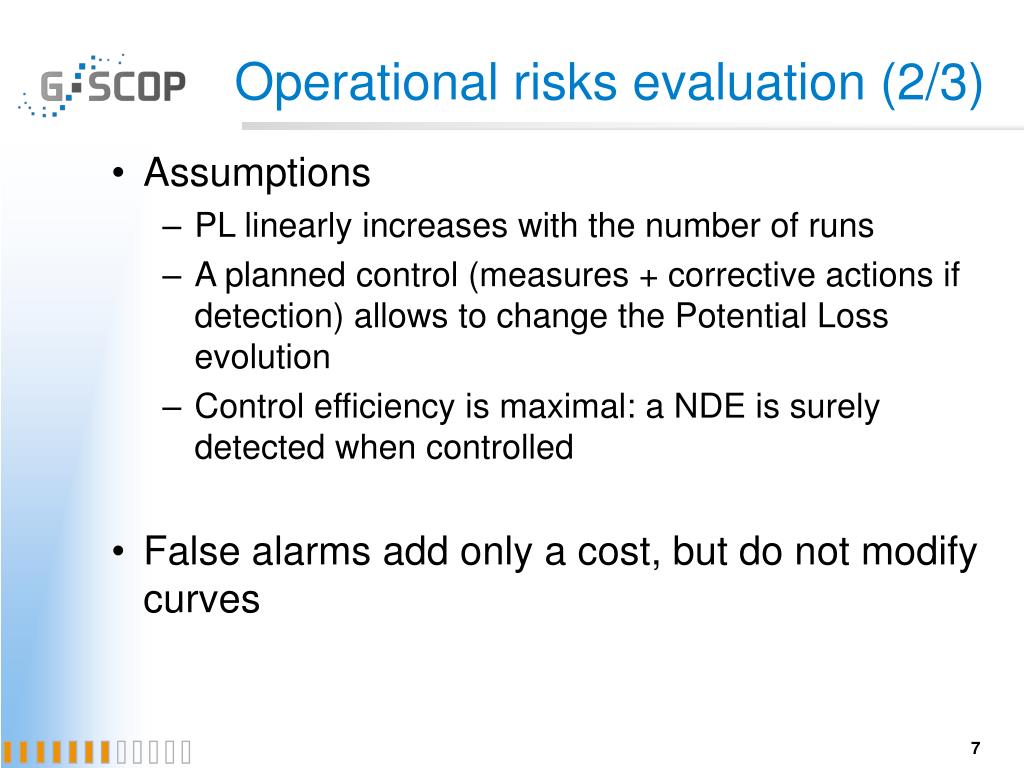

  7. Operational risks evaluation (2/3) • Assumptions • PL linearly increases with the number of runs • A planned control (measures + corrective actions if detection) allows to change the Potential Loss evolution • Control efficiency is maximal: a NDE is surely detected when controlled • False alarms add only a cost, but do not modify curves

  8. PLX PLiX(i)=1 PL1X(i)=i i 1 # run 1 i H Pr (NDE) 1 Pri 1 i H # run Operational risks evaluation (3/3) • From uncertainty monitoring to Risk evaluation RX RX(i) 1 # run 1 H i

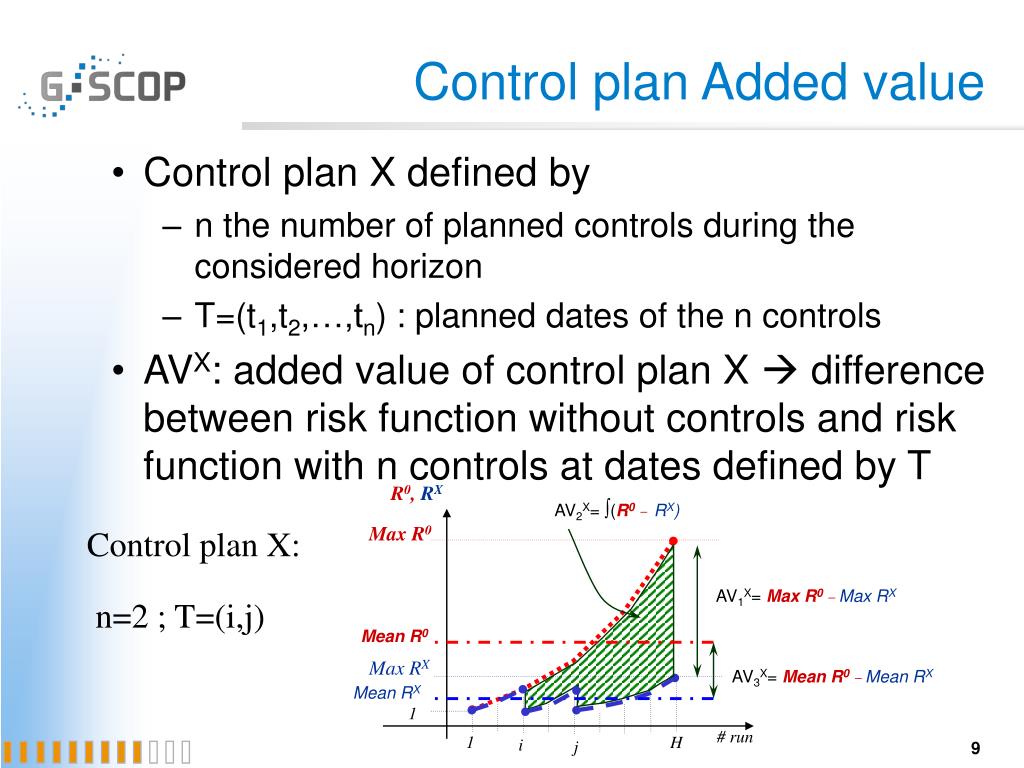

  9. Control plan Added value • Control plan X defined by • n the number of planned controls during the considered horizon • T=(t1,t2,…,tn) : planned dates of the n controls • AVX: added value of control plan X  difference between risk function without controls and risk function with n controls at dates defined by T R0, RX AV2X= ∫(R0 _ RX) Control plan X: n=2 ; T=(i,j) Max R0 AV1X= Max R0 _ Max RX Mean R0 Max RX AV3X= Mean R0 _ Mean RX Mean RX 1 # run 1 H i j

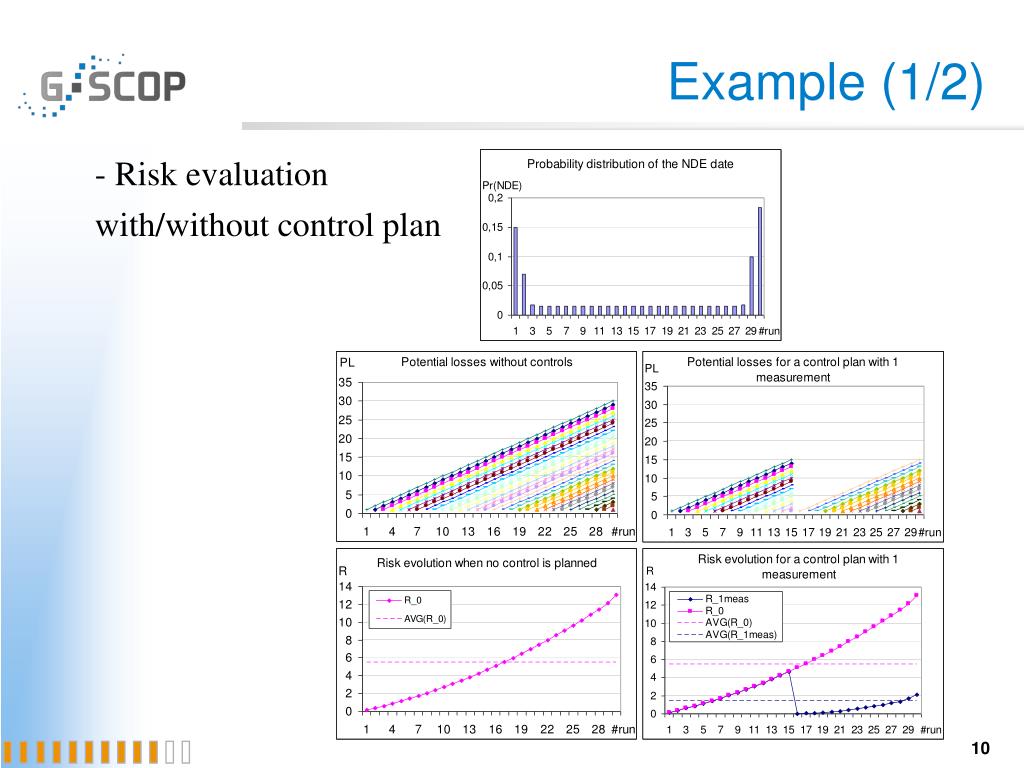

  10. Example (1/2) • Risk evaluation with/without control plan

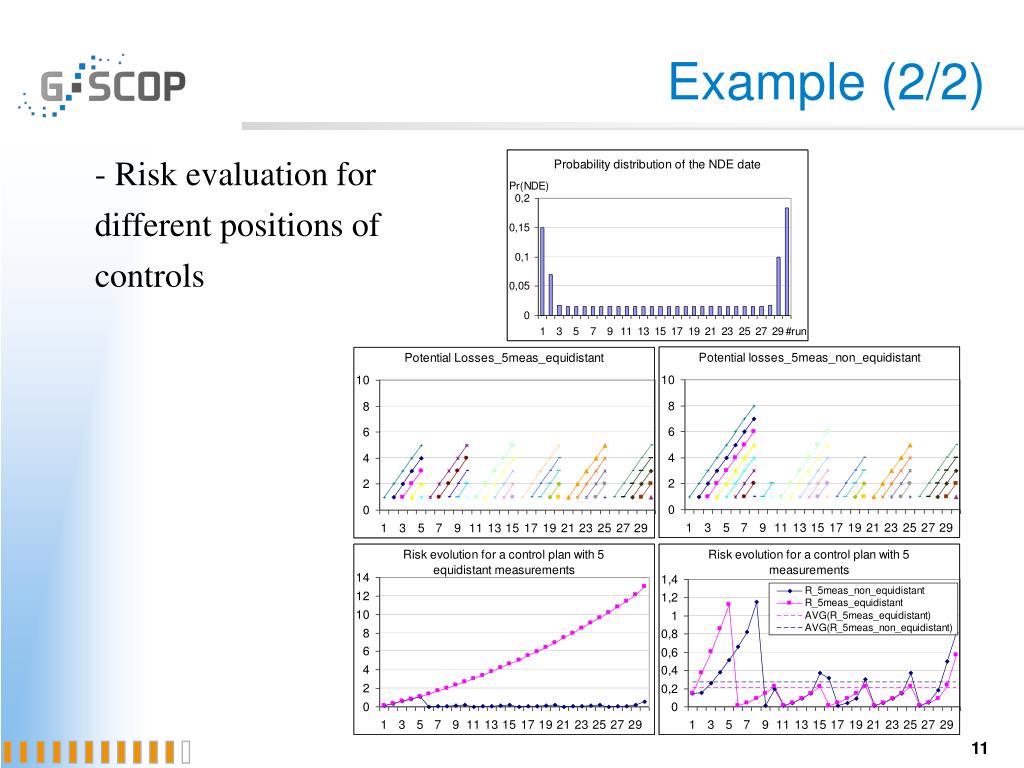

  11. Example (2/2) • Risk evaluation for different positions of controls

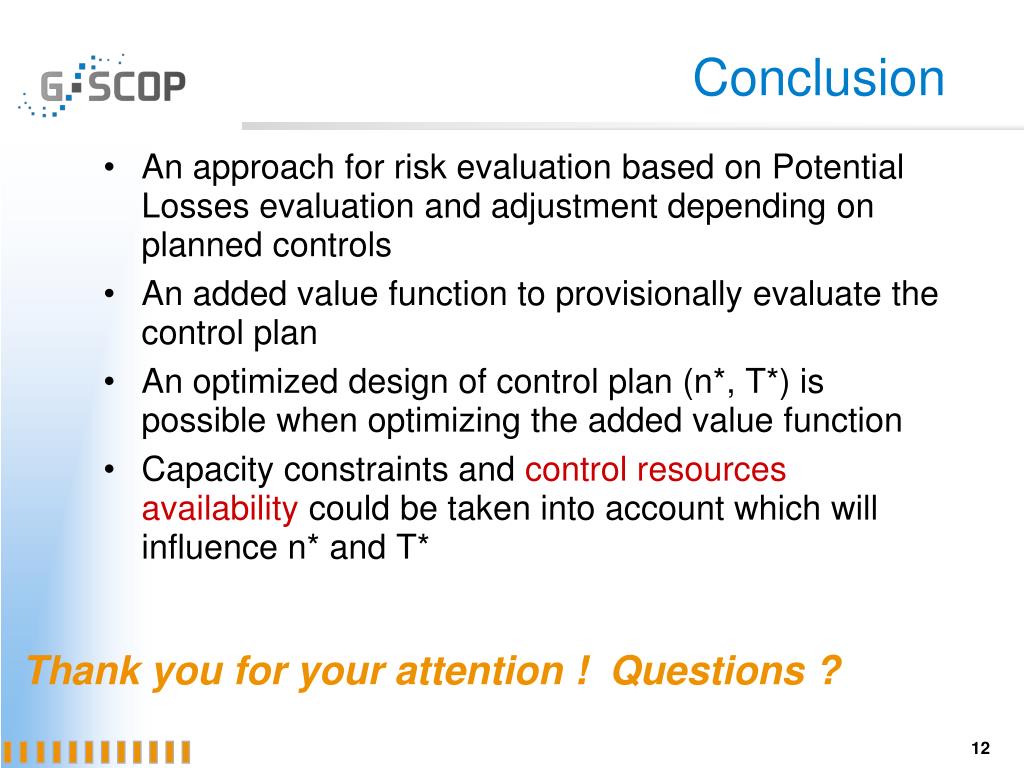

  12. Conclusion An approach for risk evaluation based on Potential Losses evaluation and adjustment depending on planned controls An added value function to provisionally evaluate the control plan An optimized design of control plan (n*, T*) is possible when optimizing the added value function Capacity constraints and control resources availability could be taken into account which will influence n* and T* Thank you for your attention ! Questions ?

More Related
