1 / 26

The CLEARVIEW Program Core Team Meeting March 7, 2012

The CLEARVIEW Program Core Team Meeting March 7, 2012. Agenda. Action Items Phase I: SAP Phase I: Contract Schedule Readiness Phase I: SP / WI Status Phase I: SDLC Phase II: PMO Phase II: Project Schedule Phase II: Sneak Preview/CRP Phase II: SDLC Service & Repair Quality

faolan
Télécharger la présentation

The CLEARVIEW Program Core Team Meeting March 7, 2012

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. The CLEARVIEW Program Core Team Meeting March 7, 2012

  2. Agenda • Action Items • Phase I: SAP • Phase I: Contract Schedule Readiness • Phase I: SP / WI Status • Phase I: SDLC • Phase II: PMO • Phase II: Project Schedule • Phase II: Sneak Preview/CRP • Phase II: SDLC • Service & Repair • Quality • Business Intelligence

  3. Agenda Items • URS Requirements • Phase II: UAT Testing, Process, Timeline • Phase II:UAT User Acceptance • Phase II: Procedures and Work Instructions footer goes here

  4. Action Items

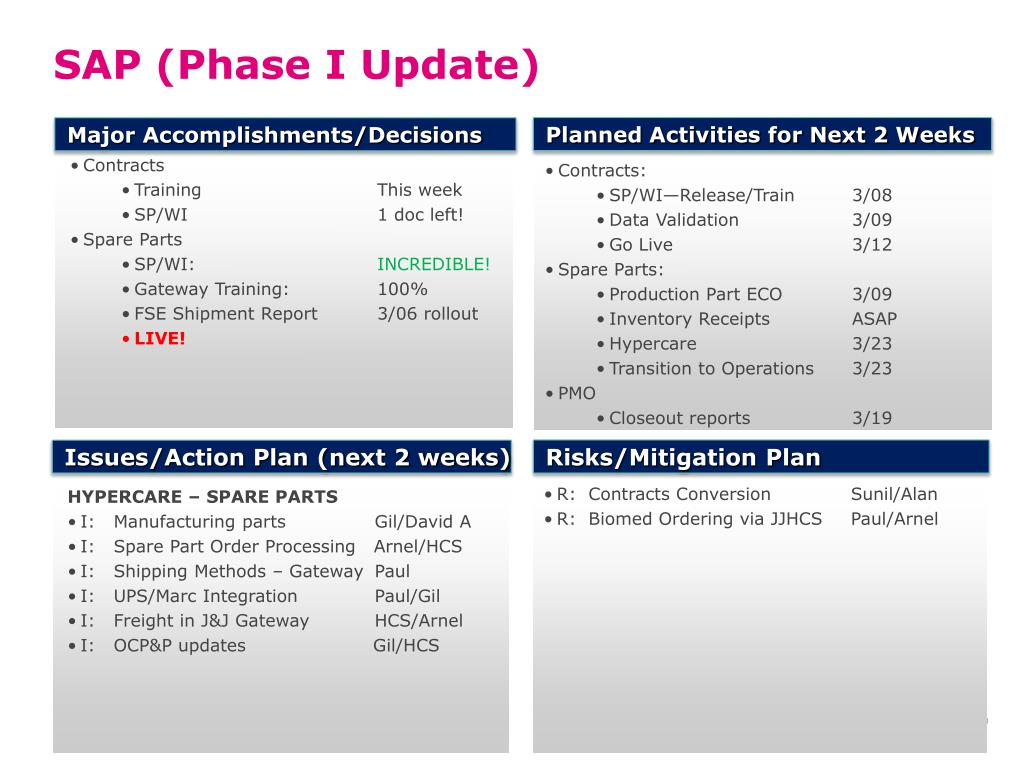

  5. SAP (Phase I Update) Planned Activities for Next 2 Weeks Major Accomplishments/Decisions • Contracts • Training This week • SP/WI 1 doc left! • Spare Parts • SP/WI: INCREDIBLE! • Gateway Training: 100% • FSE Shipment Report 3/06 rollout • LIVE! • Contracts: • SP/WI—Release/Train 3/08 • Data Validation 3/09 • Go Live 3/12 • Spare Parts: • Production Part ECO 3/09 • Inventory Receipts ASAP • Hypercare 3/23 • Transition to Operations 3/23 • PMO • Closeout reports 3/19 Risks/Mitigation Plan Issues/Action Plan (next 2 weeks) • R: Contracts Conversion Sunil/Alan • R: Biomed Ordering via JJHCS Paul/Arnel • HYPERCARE – SPARE PARTS • I: Manufacturing parts Gil/David A • I: Spare Part Order Processing Arnel/HCS • I: Shipping Methods – Gateway Paul • I: UPS/Marc Integration Paul/Gil • I: Freight in J&J Gateway HCS/Arnel • I: OCP&P updates Gil/HCS

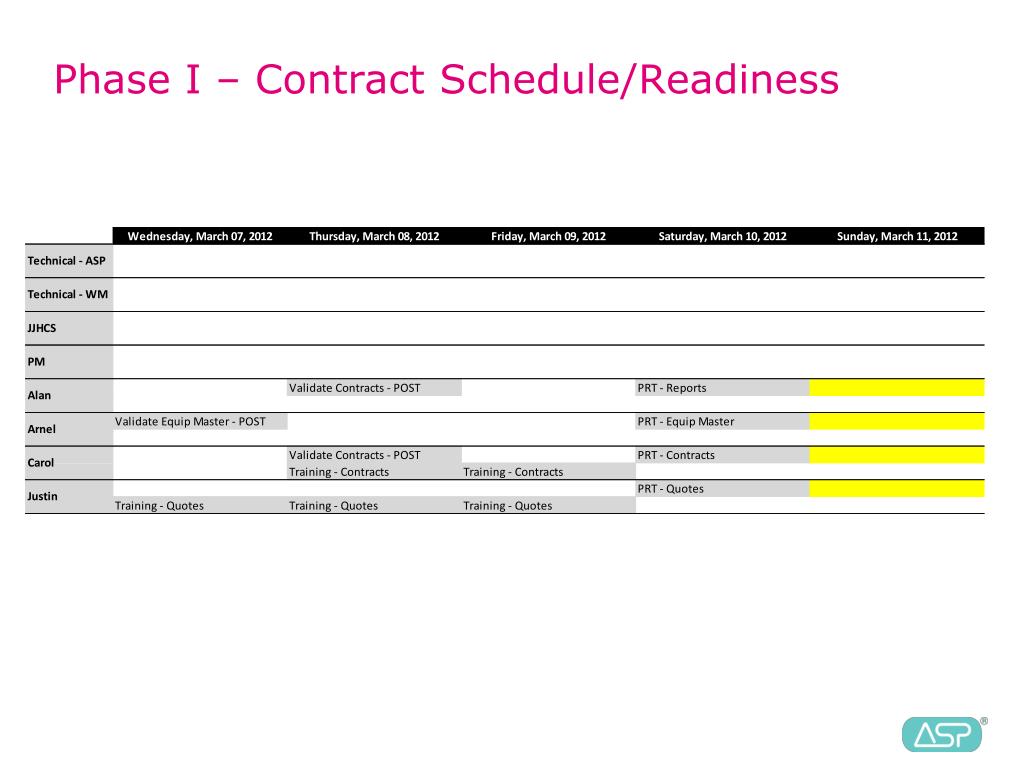

  6. Phase I – Contract Schedule/Readiness

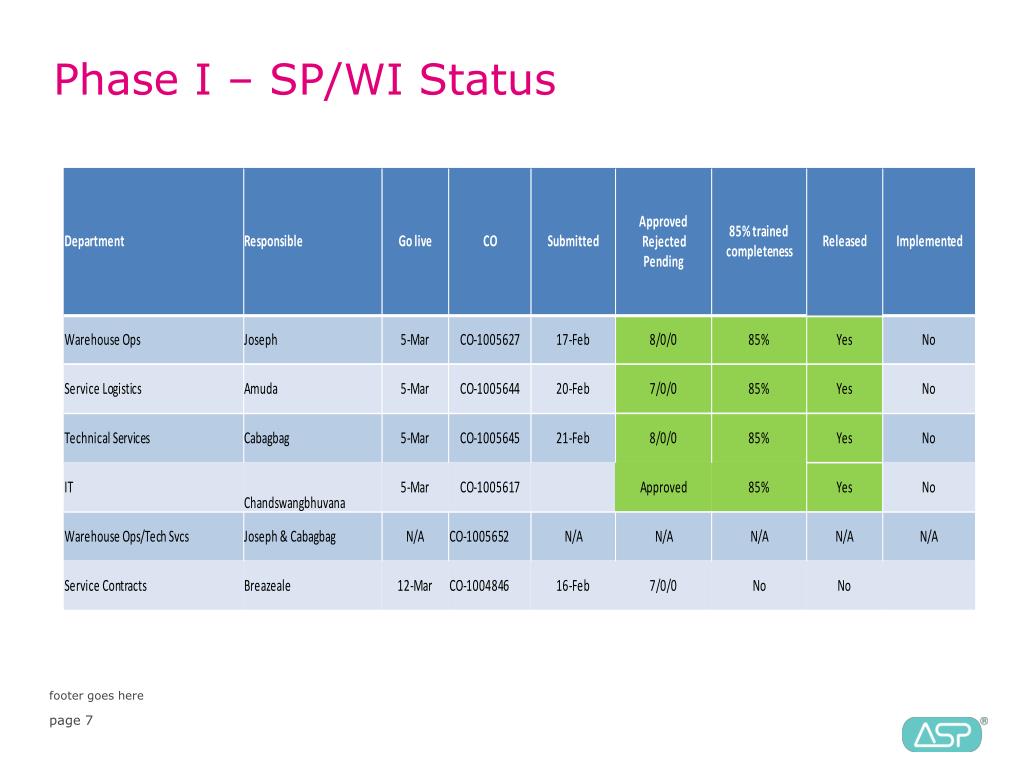

  7. Phase I – SP/WI Status footer goes here

  8. Phase I – SDLC Document Status

  9. Phase II: PMO Planned Activities for Next 2 Weeks Major Accomplishments/Decisions • Finalization of Global Services SOW • UAT Plan complete and script creation begun • CRP (n.b. reschedule due to Kaizen meetings) • Onboard training / communication resource • Supplemental CAR Approved! • 70% of build completion overall all streams • 70% SIT test scripts prep/review completed • UAT Approach 90% complete • Sneak previews in process Risks/Mitigation Plan Issues/Action Plan • SOX Certification for SouthStar platform • Delay in testing completion • Aggressive timeline • Competing priorities for the business team

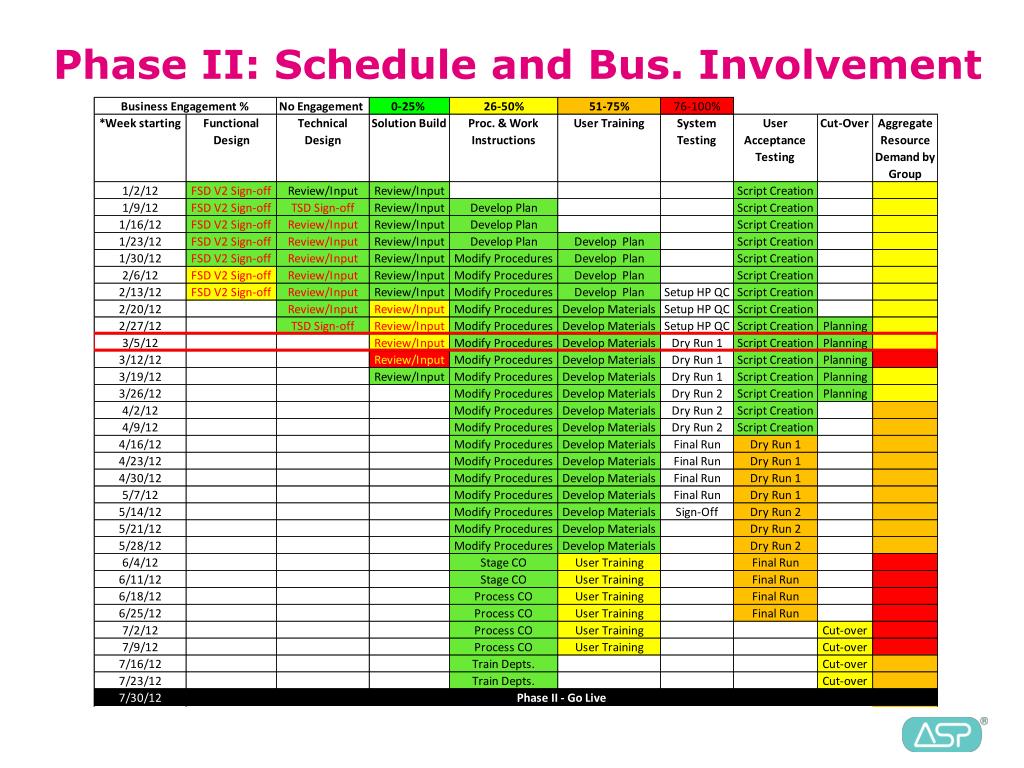

  10. Phase II: Schedule and Bus. Involvement

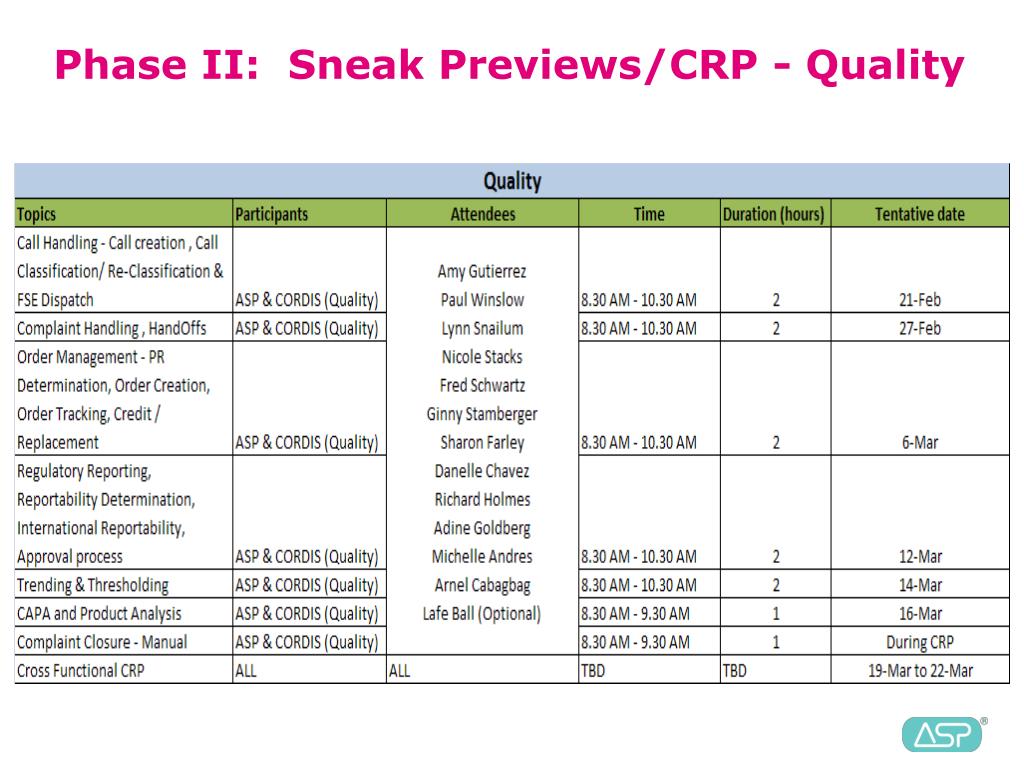

  11. Phase II: Sneak Previews/CRP - Quality

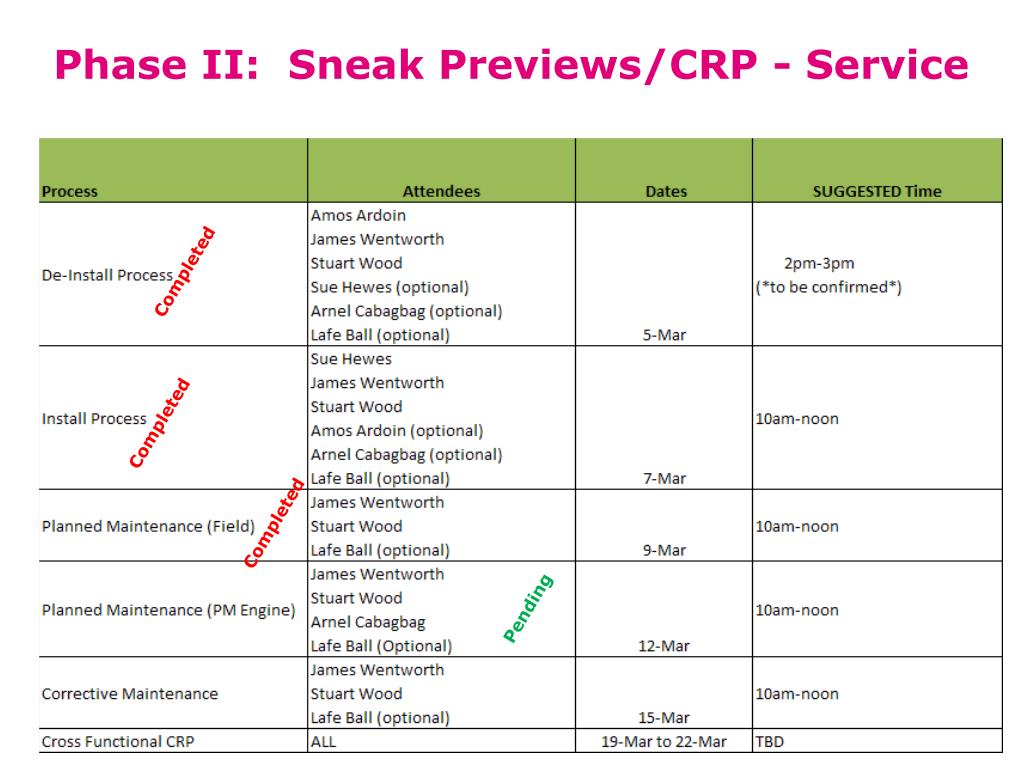

  12. Phase II: Sneak Previews/CRP - Service Completed Completed Completed Pending

  13. Phase II – SDLC Document Status

  14. Service & Repair Planned Activities for Next 2 Weeks Major Accomplishments/Decisions • Cross-functional sessions (week of 3/19). • Test Plans – identify & document. • Formalize FSE time track & reporting functions. • Master data. • De-install email templates completed. • De-install activity plans completed. • Install email Templates completed. • Install email templates completed. • Sneak-preview sessions completed. Risks/Mitigation Plan Issues/Action Plan • Bill-order only process. • Credit-card billing process. • Credit/Replacement process. • Support required from SMEs will increase significantly over the next weeks & months.

  15. Quality Planned Activities for Next 2 Weeks Major Accomplishments/Decisions • SmartScripts • Complete SmartScript development • Sneak Preview Sessions • Final 3 sessions to be held from 3/12 – 3/16/12 follow up meetings scheduled for feedback • Product Malfunction Codes • Complete the review and alignment of PMCs • Other • Resolution of last 2 remaining parking lot items • Initiate the review/updating of SOPs/WIs • SmartScripts • All scripts have been approved • 10 of the 12 scripts have been developed currently on schedule • Sneak Preview Sessions • 3 of the 6 sessions have been held • Product Malfunction Codes • 6 work sessions held and initial review of PMCs reviewed with SMEs Issues/Action Plan Risks/Mitigation Plan • Scalable solution for the reporting of product analysis fields on a complaint • No significant risks in place

  16. Business Intelligence Planned Activities for Next 2 Weeks Major Accomplishments/Decisions • Phase II • Ongoing Build and Unit Testing of BI • Change Management – “Where is my data” • Astea on SA and D1 Decommission project • Kickoff - SA and D1 Decommission project • Phase II • Started BI Road Show, running until 03/19 • Ongoing Build and Unit Testing of BI • 90% completed for Analytics • 70% completed for BIP Issues/Action Plan Risks/Mitigation Plan • PII: Late business Change Requests for creating new reports and changes to already built reports – have added new requests to CR Log • None to report

  17. Service Alliance & Dispatch 1 Decommission • Service data for installed customer assets resides on Service Alliance and Dispatch 1 (no longer in production), these applications and their respective databases are scheduled to be decommissioned • Business requires reporting capabilities on the Service Alliance and Dispatch 1 data post decommission of these applications for: • Legacy service data reporting • Compliance and audit purposes • Retirement of the Service Alliance application is scheduled: • March 2012: Quote to Contract and Spare Parts Sales moved to HCS SAP • Q3/2012: Technical Service functions will move to SouthStar (Siebel) joining ASP’s Quality and Complaint management footer goes here

  18. Service Alliance & Dispatch 1 Change Management Reporting Legacy Service Data Solution Definition Legacy Service Data Solution Build &Test Legacy Service Data Solution in Production Service Alliance in Production Service Alliance in Fallback & RO Mode Service Alliance Shutdown SouthStar in Production footer goes here

  19. Service Alliance & Dispatch 1 - RACI footer goes here

  20. URS Requirements By Category footer goes here

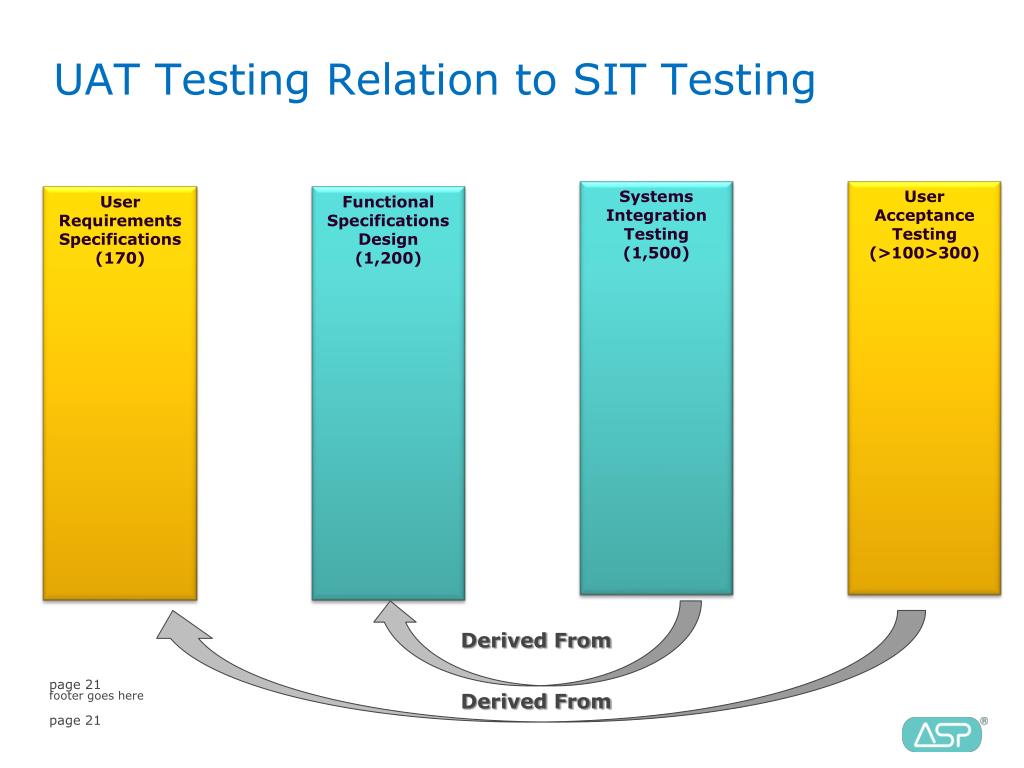

  21. UAT Testing Relation to SIT Testing Systems Integration Testing (1,500) User Acceptance Testing (>100>300) User Requirements Specifications (170) Functional Specifications Design (1,200) Derived From page 21 Derived From footer goes here

  22. UAT Process Map User Requirements SouthStar Implements Corrections Derived From Defects ID’d • UAT Test Script(s) footer goes here

  23. UAT Timeline Go/No-Go 3/13 UAT Script Inventory Go/No-Go 4/10 UAT Test Scripts 300>n>100 • UAT Preparation Phase • 3-5 thru 4-16 • (6 Weeks) UAT Dry Run 1 4-16 thru 5-14 (4 Weeks) UAT Dry Run 2 5-14 thru 6-4 (3 Weeks) Final UAT Run 6-4 thru 7-1 (4 Weeks) 3/5 3/12 3/19 3/26 4/2 4/9 4/16 4/23 4/30 5/7 5/14 5/21 5/28 6/4 6/11 6/18 6/25 footer goes here

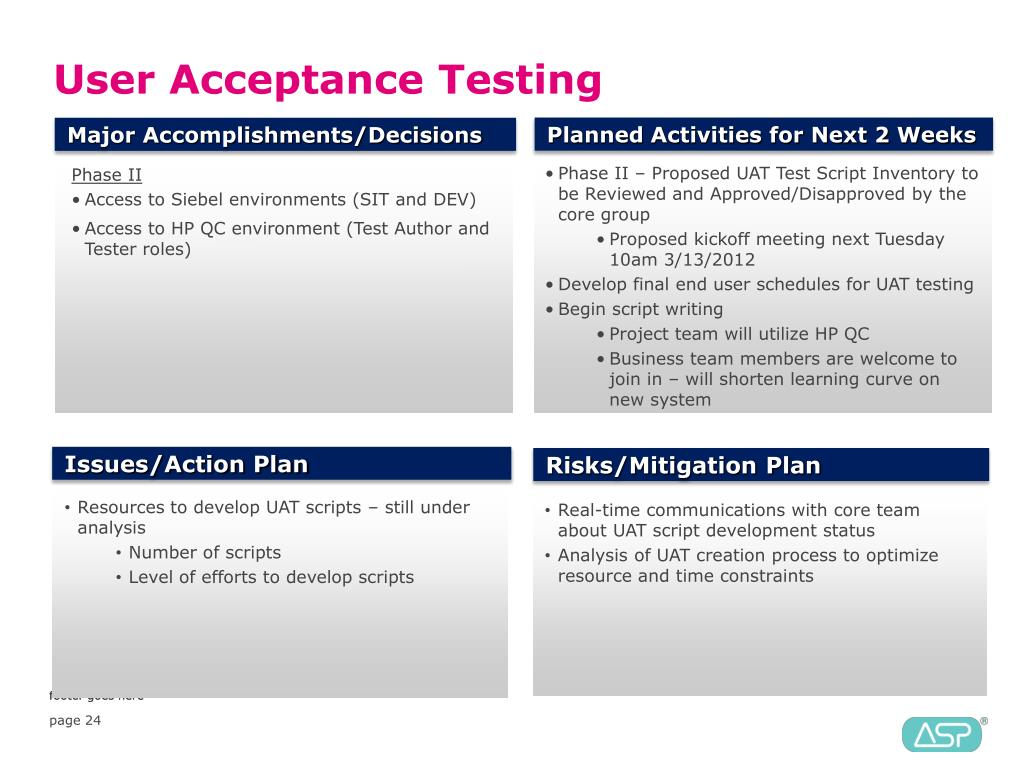

  24. User Acceptance Testing Planned Activities for Next 2 Weeks Major Accomplishments/Decisions • Phase II – Proposed UAT Test Script Inventory to be Reviewed and Approved/Disapproved by the core group • Proposed kickoff meeting next Tuesday 10am 3/13/2012 • Develop final end user schedules for UAT testing • Begin script writing • Project team will utilize HP QC • Business team members are welcome to join in – will shorten learning curve on new system • Phase II • Access to Siebel environments (SIT and DEV) • Access to HP QC environment (Test Author and Tester roles) Issues/Action Plan Risks/Mitigation Plan • Resources to develop UAT scripts – still under analysis • Number of scripts • Level of efforts to develop scripts • Real-time communications with core team about UAT script development status • Analysis of UAT creation process to optimize resource and time constraints footer goes here footer goes here

  25. Procedures And Work Instructions Planned Activities for Next 2 Weeks Major Accomplishments/Decisions • Complete document analysis • Divide by department • Provide analysis of document update needs to each department • Develop approval matrix for documents • Develop project plan for document update process • Begin document updates • Phase II • Retrieved and Conducted Preliminary Analysis of over 100 Phase II related Documents (WI, SP, etc) • ~50% appeared to not require update • ~40% seem to only require minor update • ~10% will require complete or new documentation will need to be created Issues/Action Plan Risks/Mitigation Plan • Resources to do document work – still under analysis • Number of documents • Level of efforts to develop documents • Rewrite and/or new document creation

  26. Protecting Lives Against Infection
