  1. Project Management in Practice Allocating Resources to the Project

  2. Outline: • Expediting or Crashing a project • Resource Loading • Resource Leveling Homework: 20 (omit e) using MSP 21 (an AOA diagram may help!) by hand and Excel

  3. Expediting A Project: Table 6-1, Example Project completion time = 21 days, cost $400, critical path = a-c-f

  4. Table 6-1, Example (21 days, baseline) 6 or 4 days only 0 6 6 12 12 21 c6 f9 a6 5 7 12 21 0 6 6 13 d7 13 20 g7 7 14 0 7 7 12 14 21 b7 e5 2 9 9 14

  5. Table 6-1, Example (20 days) 6 or 4 days only 0 5 5 11 11 20 c6 f9 a5 5 7 11 20 0 5 5 12 d7 12 19 g7 6 13 0 7 7 12 13 20 b7 e5 1 8 8 13

  6. Table 6-1, Example (19 days) 6 or 4 days only 0 6 6 12 12 21 c6 f9 a6 5 7 12 21 0 6 6 13 d7 13 20 g7 7 14 0 7 7 12 14 21 b7 e5 2 9 9 14

  7. Table 6-1, Example (19 days) 6 or 4 days only 0 5 5 11 11 19 c6 f8 a5 5 7 11 19 0 5 5 12 d7 12 19 g7 5 12 0 7 7 12 12 19 b7 e5 7 12 0 7

  8. Table 6-1, Example (18 days) 6 or 4 days only c4 f9 a5 c (-2) a (-1) d7 g6 b7 e5 g (-1)

  9. Table 6-1, Example (max) Fully crashed. Fully crashed. Crashed by 1. c4 f9 a5 d7 g6 b7 e5

  10. Table 6-1, Example (max=16) Fully crashed. Fully crashed. Crashed by 1. c4 f9 a5 f7 d7 g6 g4 b7 e5

  11. Project Cost versus Project Duration Example Table 6.1 $750 $650 $550 $470 $430 $400

  12. Table 6-1, Example (21 days, baseline) AOA May be crashed 1 day at a time c6 2 4 a6 f9 1 d7 6 b7 3 5 g7 e5

  13. Table 6-1, Example (21 days, baseline) AOA May be crashed 1 day at a time c6 2 4 a6 f9 1 d7 6 b7 3 5 g7 e5

  14. Resource Loading • Amount of specific resources that are scheduled for use on specific activities or projects at specific times. • Usually a list or table.

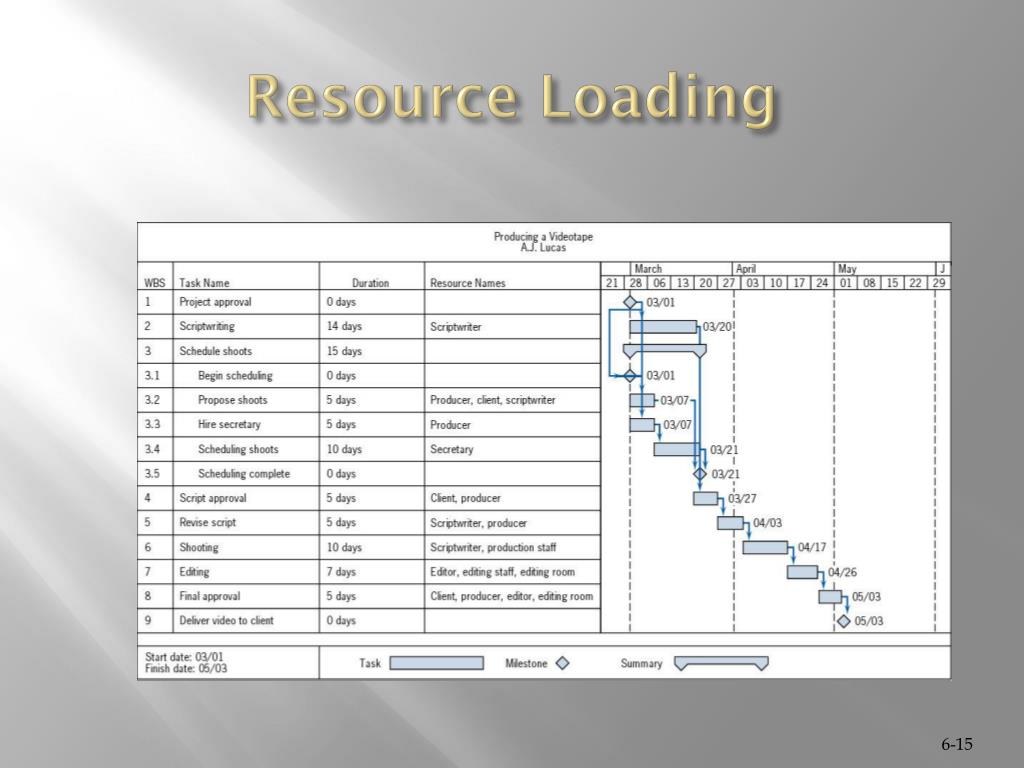

  15. Resource Loading

  16. Resource Loading

  17. No Resource Loading 7 Day Work Week Format Gantt Chart Wizard Resource LevelingUnloaded d,e 5 7 7 13 e2 f6 0 5 5 7 a5 7 13 0 3 3 8 0 5 b3 c5 9 11 g2 3 6 6 11 11 13 5 9 d4 7 11

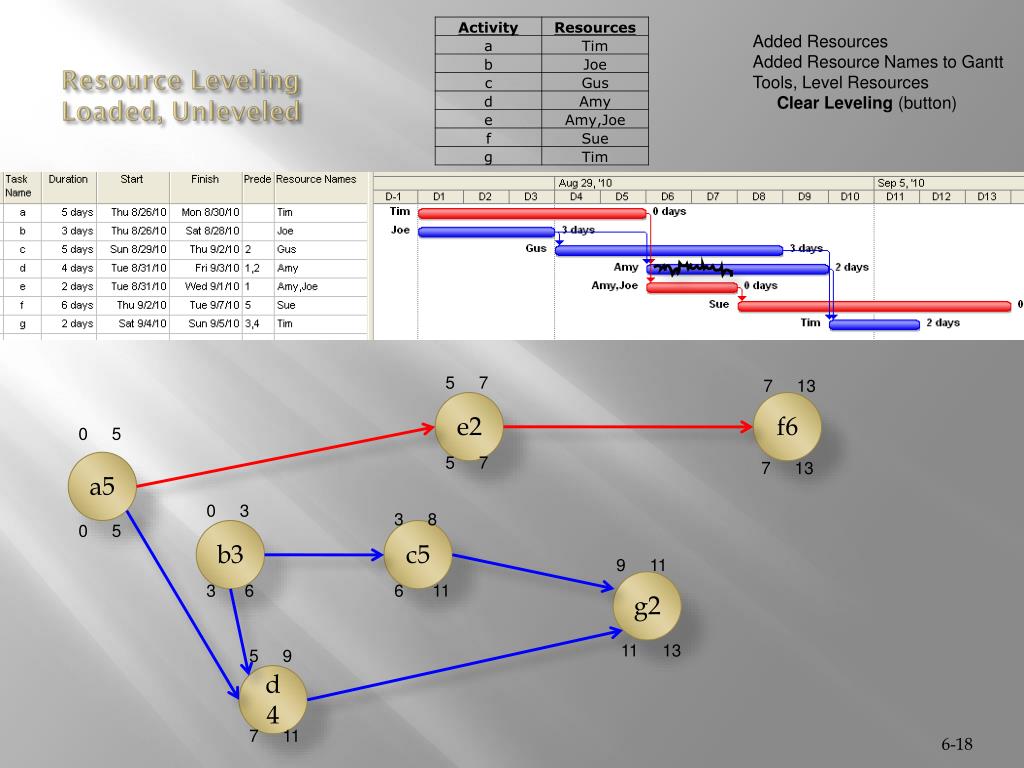

  18. Added Resources Added Resource Names to Gantt Tools, Level Resources Clear Leveling (button) Resource LevelingLoaded, Unleveled 5 7 7 13 e2 f6 0 5 5 7 a5 7 13 0 3 3 8 0 5 b3 c5 9 11 g2 3 6 6 11 11 13 5 9 d4 7 11

  19. View Resource Usage View Resource Graph Resource LevelingLoaded. Unleveled

  20. Tools, Level Resources Level Now (button) Used d’s (LS/LF) slack to avoid overloading of Amy Resource LevelingLoaded, Leveled 5 7 7 13 e2 f6 0 5 5 7 a5 7 13 0 3 3 8 0 5 b3 c5 11 13 g2 3 6 6 11 11 13 7 11 d4 7 11

  21. View Resource Usage Resource LevelingLoaded, Leveled

  22. Unleveled Resource LevelingSuppose activity c needed Sue instead of Gus?

  23. Leveled e finishes at 7, but f cannot start Sue is still busy on c Resource LevelingSuppose activity c needed Sue instead of Gus? 8 14 5 7 e2 f6 0 5 5 7 a5 7 13 8 14 0 3 3 8 0 5 b3 c5 11 13 g2 3 6 7 12 b cannot LF at time 7 because Joe is needed on e at time 6 12 14 7 11 d4 e cannot start at time 6 and finish at 8 because Amy is needed on task d at time 7 d cannot start until time 7 because Amy is not free 8 12

  24. Leveled Resource LevelingSuppose activity c needed Sue instead of Gus?
